Article

What Enables a High-Risk Project to Yield High Return from a Construction Contractor’s Perspective?

1
Department of Civil and Environmental Engineering, Yonsei University, Seoul 03722, Korea
2
Department of Nuclear Power Plant Engineering, KEPCO International Nuclear Graduate School, Ulsan 45014, Korea
3
Department of Civil and Environmental Engineering, Yeungnam University, Gyeongsan 38541, Korea
4
Department of Civil Engineering, Seoul National University of Science and Technology, Seoul 0181, Korea
*
Author to whom correspondence should be addressed.
Sustainability 2019, 11(21), 5971; https://doi.org/10.3390/su11215971
Submission received: 16 September 2019 / Revised: 20 October 2019 / Accepted: 25 October 2019 / Published: 27 October 2019
(This article belongs to the Special Issue Sustainability and Risks in Construction Management)

Abstract

:
“High risk high return” is a general rule in the overall industry; however, high-risk projects in the construction industry frequently fail to yield a high return. In order to achieve a sustainable business in the international construction market, contractors require an average to high return yield under high-risk conditions. This study aims to reveal what risk factors and risk management performance enables high-risk projects to yield high returns. The study investigated 124 international construction projects by Korean contractors and classified them into four groups: high-risk high-return (HH), high-risk low-return (HL), low-risk high-return (LH), and low-risk low-return (LL). The study found that risk assessment accuracy was the most important trigger in discriminating between high return projects (HH, LH) and low return projects (HL, LL), whereas risk mitigation performance showed little difference between high return and low return projects. In addition, the contingency amount did not significantly affect project return in HL, LH, and LL projects, but HH projects showed a positive relation between contingency and predicted risk amount. This article contributes to recognizing the differences between high return and low return projects and provides insights for practitioners into the relation between risk management performance and high returns in different risk conditions.

1. Introduction

The principle of “high risk high return” is popularly used in many fields, including financial investment [1,2]. According to this principle, a person invests in a high-risk product because the product is expected to yield high return because of the possibility of loss. The investment risk–return tradeoff is valid when a high-risk product averages a yield high return even though the return severely fluctuates.
Interestingly, the construction field maintains two contradictory opinions regarding the risk–return tradeoff. First, high-risk projects are expected to gain high profitability [3,4]; and second, high risk yields a low return because the bid competition cannot allow the bidder to allocate sufficient profit according to the risk amount [5,6]. These two arguments would be adjusted depending on the owner and contractor perspectives. From the contractors’ perspective, many researchers support the latter opinion when showing that high-risk projects are likely to incur cost overruns and schedule delays, which can cause project failure [7,8,9]. Due to limitations or stagnation in the domestic construction industry, many construction contractors enter the international market [10]. The international market, while huge and constantly growing, is quite risky, with multidimensional uncertainties such as political, economic, infra and social, and cultural risks that are less familiar than in the domestic market [11]. In order to survive in the international construction market, construction contractors must bid on risky projects and earn profit. Thus, construction contractors must be able to select potentially high-return projects among the high-risk projects, and to mitigate the high risk to achieve sustainable revenue and profitability.
Many researchers have studied project selection based on risk amount, suggesting analyses and models to identify the risk factors and to develop risk assessments to screen unsuccessful projects [12,13,14]. Their results are useful and effective given that users can accurately evaluate risk: if the user assesses the risk as high, the model presents negative results. However, in real construction industry situations evaluating risk is somewhat different. International contractors are difficult to evaluate risk accurately because they frequently over-assess or under-assess the risk.
This study aims, therefore, to show what enables projects to yield high return or low return even if the project risk is assessed as high, and what causes projects to yield a high or low return even if the project risk is assessed as low. This study limits the research questions whether or not risk management performance, depending on high and low-risk situations, affects project returns from the three perspectives: (1) risk assessment performance; (2) contingency amount; and (3) risk mitigation performance. Our study proceeds by first explaining the risk–return tradeoff related backgrounds from the perspectives of risk assessment accuracy, contingency, and risk mitigation performance. Second, this study presents the questionnaire, samples, and analysis method. Then, we show what enables high or low risk projects to become high return projects based on the results of a Mann Whitney U test. Finally, this study discusses its contributions, limitations, and suggestions for future research.

2. Research Background

2.1. Risk–Return Tradeoff in Financial Investment and Construction

The risk–return tradeoff has been studied much in the financial industry [1,2,15,16,17,18,19,20] The risk is defined as the degree of exposure to the uncertainty that can have a positive or a negative effect on outcome [21,22]. In the financial investment, the risk is usually divided into interest rate risk, market risk, credit risk, sovereign risk, and operating risk [2,23]. Depending on the researcher, the risk is differently grouped into external risk such as interest rate risk country risk and market risk, and the internal risk such as strategical risk, credit risk, and operational risk [24]. In the construction industry, many researchers also suggested the various risk groups: (1) country, market, and project group [8]; (2) country, inter-country, project team, construction, and contractual group [25]; (3) macro, market, and project group [26]; and (4) country, project, and corporate group [27]. The return is generally defined as the expected return. The expected average returns should converge the actual average returns when many investments are conducted over a long period [28]. Therefore, the expected average return can be measured as actual average return.
In financial investment, high levels of risk have high volatility of profits, but requires high average expected profits [1,2]. Many researchers insist that there is a positive relationship between risk and return [15,16,17]. Moreover, many empirical studies prove the principle of “high-risk high-return” and many models such as risk premium and portfolio have been developed based on this principle [18,19,20]. This principle is taken for granted in most industries.
In the construction business, the risk–return relationship depended on the perspectives of the project owners and contractors. From the perspective of the project owners who invest assets directly into construction projects, project owners can choose projects that meet their expected returns that they wanted so that the principle of “high risk high return” can be applied. On the other hand, contractors have relatively less opportunity to choose the projects that meet expected returns that they wanted. In addition, regularly, they cannot fully reflect their profits on project returns in order to award the projects. From the contractors’ perspective, therefore, two contrary opinions on risk–return tradeoff exist. One is that the high-risk projects lead to obtaining high profitability. Connolly [3] stated that profitability increases when the risk is high. Chiara [4] argued that if project risk can be well managed, high returns could be expected from high-risk projects. The other opinion is that potential returns decrease with an increase in risk since contractors cannot fully reflect their profits on project returns. Generally, researchers in the field of international construction support the second opinion. Qazi et al. [7] stated that project complexity increases uncertainties within the project, which pose cost and time overruns. Smitha and Bohn [5] and Laryea and Hughes [6] asserted that contractors could not fully reflect risk in bid prices so that as risk increases, profit should decrease. The author’s previous conference paper [29] showed that international construction projects slightly tend to follow the principles of “high-risk low-return.” These studies lack in-depth analysis of what enables the project’s profit or loss depending on risk. Therefore, this study compares high return and low return projects under high risk and the conditions to determine what makes a project high return.

2.2. Relation between Risk Assessment and Return

Risk assessment is an important process for contractors to achieve sustainable revenue and profitability in the international market. Contractors make critical decisions such as internationalization, market selection, project selection, and mark-up selection based on risk assessment results [30,31]. In addition, accurately assessing and identifying problems in the early stages of construction is a critical success factor because the most appropriate solution will be found and implemented [32].
Many studies advance project risk assessment models based on quantitative methods such as the probability impact (PI) method [12,33], Monte-Carlo simulation method [34,35], analytic hierarchy process (AHP), and fuzzy sets [25,36]. In these models, if users evaluate the risk as high, the results are negative. In practice, although the principle of “high risk high return” is not correctly applied in international construction, not all projects evaluated as high risk yield negative results, nor do all projects evaluated as low risk yield positive results. Further, since contractors frequently tend to under evaluate project risk when they prepare project bids [31,37], they cannot be sure that the relation of risk assessment to return is negative.
Therefore, this study investigates the relation between risk assessment performance and return based on a comparative analysis between high and low return projects under high and low risk conditions. This study also investigates which risk is well predicted under different risk–return conditions. The results provide insights for the practitioner into the importance of risk assessment in risk–return tradeoff.

2.3. Relation between Contingency and Return

Risk money is well known as the risk premium in financial investment. The risk premium is a form of compensation for tolerating extra risk and is compared with the return of a risk-free asset [38]. Risk premium is defined as the difference between the return of risk-free assets when the risk is close to zero and the return of a risky asset. The return of a risky asset is higher than the return of a risk-free asset because of the risk premium. Therefore, the principle of “high risk high return” can be applied in financial investments. However, in the construction industry the concept of risk money has a slightly different meaning. In a construction project, risk money is known as the contingency and allowance. In general, since the information for an allowance in estimation is difficult to obtain, many studies represent contingency as the risk money. The contingency is defined as the budget to deal with uncertainties during construction [39] or the budget needed to reduce the risk that leads to overruns [21]. The difference is that the risk premium is a concept of reward for risk, while the contingency is a concept for the reserve amount to manage the risk.
Many studies seek to estimate contingency in construction. Panthi et al. [40] suggested a contingency estimation method through the relation between project risk and bill of quantity (BOQ) items. Elbarkouky et al. [41] developed a contingency estimate model based on project risk with fuzzy arithmetic analysis. Sonmez et al. [42] presented four factors—country risk, type of contract, advance payment amount, and availability of construction materials in the host country—that affect the variations of contingency. These studies suggest that contingency should be estimated in consideration of expected risks.
In practice, however, risk is not well reflected in estimating contingency for a number of reasons. First, it is difficult to estimate contingency based on assessing uncertainty accurately; second, contractors intentionally reduce the contingency for maximizing competitive bidding; and finally, overhead cost, profit, and contingency are sometimes customarily determined by each contractor without regard to project risk. Some studies show that contingency is not significantly proportional to risk amount [43,44]. The risk amount that is not fully reflected in contingency has a direct impact on cost overruns and ultimately on project return.
This study investigates whether the contingency is a significant factor for enabling high-risk projects to yield high return. The results provide practitioners with important information about contingency and return under different risk conditions.

2.4. Relation between Risk Mitigation and Return

Risk mitigation is one of the risk response strategies to reduce the probability and negative impact of an adverse risk event. Unmanaged or unmitigated risk is one of the primary causes of project failure [45], and early action to reduce the probability or impact of risk is more effective than trying to deal with it after it has occurred [46]. An appropriate mitigation strategy leads to project success, and the more that risk mitigation is managed, the more effective it is. Effective mitigation strategies can reduce the impact of external and internal risk on return, directly or indirectly [47]. Due to its importance, risk mitigation has been well studied, especially in identifying the manageable risk and in suggesting mitigation strategies according to manageable risk [32,48,49,50]. However, research on mitigation performance by risk type or level of risk is lacking.
Therefore, this study attempts to examine whether risk mitigation performance is a significant factor that enables high-risk or low-risk projects to yield high return and to investigate which risk is better mitigated under different risk conditions.

3. Research Methodology

3.1. Research Process

This study aimed to determine the risk management difference between high return projects and low return projects under both high and low risk conditions. Figure 1 presents the research process. First, a structured questionnaire was designed to measure predicted risk, actual risk, and residual risk. Second, international construction projects were surveyed. Third, the predicted risk and profitability of each individual project were calculated and classified into four project groups: high-risk high-return (HH), high-risk low-return (HL), low-risk high-return (LH), and low-risk low-return (LL). Fourth, the differences between HH–HL projects and LH–LL projects were analyzed from the perspective of risk assessment performance. Fifth, the differences were analyzed from the perspective of contingency. Finally, the differences were analyzed from the perspective of risk mitigation performance. To analyze the difference, a Mann Whitney U test was conducted.

3.2. Questionnaire Design

3.2.1. Risk Factor

This study used the 54 risk factors from the previous study [50]. The 54 risks were grouped into country risk (12 risk factors), project risk (22 risk factors), and capability risk (20 risk factors), each of which consists of a subcategory risk: country risk consisted of political risk, economic risk, and infra and social risk; project risk consisted of owner risk, contract risk, and site risk; and capability risk consisted of management risk, technical risk, and partner risk. Table 1 shows the 54 risks factors and risk structure.

3.2.2. Questionnaire and Survey

The data used in this study were the same as in a previous study [50]. The survey method is as follows. The researchers conducted a structured-questionnaire survey to investigate 54 risk factors. All risk factors were investigated using the three types of questions: (1) how much was the predicted risk before bid?; (2) how much was the actual risk after award?; and (3) how much was the residual risk after mitigation? Risk values were collected by a Likert scale to align the measurement scale so that these risk values could be compared easily. In addition, since risk has a two-sided nature, positive and negative [41,48], this study considered risk’s positive and negative effects. However, especially, positive risk cases in construction projects are rare, so this study used a skewed scale (−2, −1, 0, 1, 2, 3, and 4) as is seen in Figure 2.
The questionnaires were distributed by e-mail to 400 international construction projects conducted by 28 Korean companies. The list of 400 projects was obtained from the International Contractors Association of Korea (ICAK), who manages the international construction project conducted by Korea contractor on the basis of national law. Among the 400 projects, 153 responded. Afterward, 29 projects with poor and inconsistent answers or without profitability information were accepted. Finally, the 124 projects conducted by 23 Korean companies were classified into four project groups.

3.3. Sample Profiles and Classification

The 124 projects were classified into four project groups based on their predicted risk and profitability value as can be seen in Figure 3. The criteria for distinguishing between high risk and low risk and high return and low return was relative value based on the median of predicted risk and profitability derived from the 124 projects. In this study, profitability as the difference between contract amount and actual execution cost excluding headquarter overhead cost. These cost data were collected by investigating project manager or cost manager. In order to increase the accuracy, we double-checked our survey data with the registered project data reported to the ICAK. In Korea, construction companies must biannually report the detail information on the award international construction projects to the ICAK. This information includes contract type, contract amount, execution cost, construction duration, and so on. The median value of the predicted risk was 0.23 and the median value of profitability was 5%.
  • High risk–high return projects (HH projects): projects that the predicted risk is higher than the median value of predicted risk and the profitability is higher than the median profitability;
  • High risk–low return projects (HL projects): projects that the predicted risk is higher than the median value of predicted risk and the profitability is lower than the median profitability;
  • Low risk–high return projects (LH projects): projects that the predicted risk is lower than the median value of predicted risk and the profitability is higher than the median profitability;
  • Low risk–low return projects (LL projects): projects that the predicted risk is lower than the median value of predicted risk and the profitability is lower than the median profitability.
Table 2 shows the profiles of the four project groups.

3.4. Risk Performance Indicators

This study compared the four project groups from three perspectives: (1) risk assessment performance, (2) contingency, and (3) risk mitigation performance. Risk assessment accuracy (RAA) and risk mitigation effect (RME) are used as variables to analyze risk assessment performance and risk mitigation performance. Both variables are calculated by combining the three types of risk investigated by the survey-questionnaire: predicted risk, actual risk, and residual risk. These risk values are calculated as the average value of risk factor. Individual risk factors at level 3 are calculated as the average of the risk values evaluated in 124 projects. The risk values at overall, level-1, and level-2 risk factors are calculated as the average of the risk values in the subcategory.
Risk assessment accuracy is calculated as the difference between predicted risk and actual risk as in Equation (1). Positive value means underestimation and negative value means overestimation. The higher the magnitude of the absolute value means the lower accuracy of the prediction.
R A A g = i = 1 n j g m g x i j g A x i j g p n ( m g j g + 1 ) ,
where R A A g = risk assessment accuracy of g group, g = risk group = {overall risk, country risk, project risk, capability risk, political risk, economic risk, infra and social risk, owner risk, contract risk, site risk, management risk, technical risk, partner risk}, i = project number, n = the number of sample project,   j g = initial risk factor belonging to g group, n g = last risk factor belonging to g group, x i j g p is the predicted risk value for risk factor j g of project I, and x i j g A is the actual risk value for risk factor j g of project i.
Risk mitigation effect is calculated as the difference between actual risk and residual risk as in Equation (2). The higher value means the better mitigation performance.
R M E g = i = 1 n j g m g x i j g A x i j g R n ( m g j g + 1 ) ,
where R M E g = risk mitigation effect of g group and x i j g R is the residual risk value for risk factor j g of project i.
Contingency is divided into project contingency and headquarter contingency. In this study, however, the sum of two types of contingency was used and the allowances in the estimate are not included. Contingency was investigated as a percentage of contract amount by a survey-questionnaire.

3.5. Analysis Method

In order to test normality, the Shapiro–Wilk test was conducted on 52 compared groups (HH–HL and LH–LL) and the result shows that only four compared groups satisfy normality distribution at significance level 0.05. Therefore, this study uses the U-test not the T-test. The Mann Whitney U test compares the HH–HL projects and the LH–LL projects in terms of risk assessment performance, contingency, and risk mitigation performance. The Mann Whitney U test is non-parametric statistical analysis that tests for the difference between two sample groups with no normal distribution [51]. If the test results are satisfied at the significance level, a statistical difference exists between the two compared samples.

4. Results

4.1. Risk Assessment Performance

Table 3 shows the risk assessment performance of the HH and HL projects. The Mann Whitney U test result indicates that the RAA in overall risk was significantly different between the HH projects and HL projects (p-value = 0.001). HH projects performed −0.040 RAA, whereas HL projects resulted in 0.293 RAA. In addition, all level-1 risks such as country, project, and capability risk were significantly different between the HH projects and HL projects (p-value = 0.005, p-value = 0.006, p-value = 0.006 in order). These results mean that the risk assessment performance was one of the important triggers distinguishing between high return and low return.
Level-2 risks show three interesting results. First, the RAA of infra and social risk, technical risk, and contract risk were very significantly different between the HH projects and HL projects (p-value = 0.001, p-value = 0.002, p-value = 0.003 in order). Particularly, HH projects estimated technical risk quite well (RAA = −0.043, Rank 1), whereas HL projects severely underestimated technical risk (RAA = 0.383, Rank 6). HH projects also estimated contract risk quite well (RAA = 0.051, Rank 2), whereas HL projects severely underestimated contract risk (RAA = 0.392, Rank 8). These results imply that when the contractors met high-risk projects, if they were confident in assessing technical and contract risk, these contractors were likely to earn high return. Second, the RAA of political risk, owner risk, and partner risk were not significantly different between the HH projects and HL projects (p-value = 0.076, p-value = 0.077, p-value = 0.215 in order). These results imply that when the contractors met high-risk projects, if they were confident in assessing political risk, owner risk, and partner risk, that confidence did not guarantee high return. Last, both HH and HL projects severely underestimated partner risk (HH: RAA= 0.264; Rank 9, HL: RAA = 0.461; Rank 9). International contractors tend to collaborate with international JV partners and local subcontractors because they are not accustomed to doing business in the host country [52,53]. However, these strategies did not work well in both HH and HL projects.
Table 4 shows the risk assessment performance in the LH and LL projects. The Mann Whitney U test result indicates that the RAA in overall risk was significantly different between the LH projects and the LL projects (p-value = 0.006). LH projects performed 0.047 RAA, whereas LL projects resulted in 0.266 RAA. This result means that risk assessment performance was one of the important triggers distinguishing between high return or low return like high-risk projects.
In risk level-1, country and project risk were significantly different between the LH projects and LL projects (p-value = 0.000), whereas capability risk was not significantly different between the LH projects and LL projects (p-value = 0.703). These results imply that even LH projects did not estimate well the capability risk when compared to LL projects.
In risk level-2, Table 4 shows three interesting results. First, the RAA of contract risk, infra and social risk, and site risk was significantly different between the LH projects and LL projects (p-value = 0.001, p-value = 0.011, p-value = 0.012 in order). Particularly, LH projects overestimated infra and social risk (RAA = −0.348, Rank 8) and site risk (RAA = −0.296, Rank 6), whereas LL projects underestimated infra and social risk (RAA = 0.158, Rank 3) and site risk (RAA = 0.108, Rank 1). This result implies that the risk avoider of infra and social risk and site risk was more likely to yield LH projects. Second, LH projects estimated contract risk quiet well (RAA = −0.010, Rank 2), whereas LL projects underestimated contract risk (RAA = 0.242, Rank 6). This result means that the accuracy of contract risk assessment was the most important criteria to discriminate LH from LL projects. Third, the RAA of management risk, technical risk, and partner risk was not much different between LH and LL projects. Especially, this result implies that accurately assessing capability risk did not guarantee high returns in low-risk projects.

4.2. Contingency

Table 5 shows the contingency in the four project groups. The Mann Whitney U test result indicates that the contingency was not significantly different between the HH projects and HL projects (p-value = 0.874) and the LH projects and LL projects (p-value = 0.360). However, a different result was derived in terms of the relation between predicted risk and contingency.
Table 6 shows the predicted risk of the high contingency group and the low contingency group in HH projects and HL projects. The contingency group was divided into relative values through the median values of the contingency size in the same way as the risk and return criteria. The Mann Whitney U test result shows that the overall predicted risk was significantly different between the high contingency group and low contingency group in HH projects (p-value = 0.049), whereas the overall predicted risk was not significantly different in HL projects (p-value = 0.256). In HH projects, the predicted risk of low contingency was 0.524, while the predicted risk of high contingency was 0.709. This result implies that the HH projects had a positive relation between risk and contingency so that estimating contingency based on predicted risk had a positive effect on project performance when the risk was evaluated at a high level.
Table 7 shows the predicted risk of the high contingency group and low contingency group in the LH projects and the LL projects. The Mann Whitney U test result indicates that the overall predicted risk was not significantly different between the high contingency group and low contingency group in both the LH projects (p-value = 0.845) and LL projects (p-value = 0.146). Contingency is the budget to deal with uncertainties or to reduce the risk that leads to overruns [39,40,41]. Therefore, the smaller the impact of risk on project returns, the lesser the effect of contingency on risk management.

4.3. Risk Mitigation Performance

Table 8 shows the risk mitigation performance of HH and HL projects. The Mann Whitney U test result indicates that the RME in overall risk was not significantly different between the HH projects and HL projects (p-value = 0.322). Although both HH (RME = 0.266) and HL projects (RME = 0.220) reduced the overall risk amounts, the amounts of each of the HH and HL projects were not significantly different.
Table 9 shows the risk mitigation performance of the LH and LL projects. The Mann Whitney U test result indicates that the MAE in overall risk was not significantly different between the LH projects and the LL projects (p-value = 0.091). In both projects, the actual risks were very small and sufficiently manageable so that mitigation performance had no significant impact on project profitability.

5. Discussion

In the construction industry, it is difficult for a high-risk project to become a high return project: high-risk projects have been known to be a challenge for yielding a high return. However, even though a construction project looks high risk, a contractor frequently should bid on the project to win the award and gain some profits for business sustainability. Thus, if a contractor can earn a profit on a high-risk project, it means that the contractor has strong market competitiveness.
First, if contractors meet high-risk projects, the accuracy of the risk assessment is the most important factor in yielding a high return. This study showed that the overall RAA was significantly different between HH and HL projects. Particularly, an HH project accurately assessed the technical risk and contract risk rather than an HL project, which could be a key indicator for predicting HH and HL projects. For example, technical risks such as insufficient design management capability and estimation capability could be accurately evaluated based on an understanding of the contractors’ own technical capabilities. Thus contractors must consider assessing their own technical capabilities objectively in order to produce high returns when they meet high-risk projects. On the other hand, both HH and HL projects had the lowest assessment accuracy of partner risk. Partner risk such as the nominated subcontractor’s insufficient capability was difficult to be exactly evaluated before the contract award. Besides, this study revealed that the overall RME was not significantly different between HH and HL projects, unlike the overall RAA. Even if both HH and HL projects succeeded in reducing the risk amounts, the amounts for each HH and HL project were not significantly different. Thus, from the high-risk high return perspective, better risk assessment was more crucial than better risk mitigation.
Second, if contractors met low-risk projects, the accuracy of risk assessment was also important for gaining a high return. This study showed that the overall RAA was significantly different between LH and LL projects. Particularly, an LH project accurately assessed the country and project risk rather than LL projects, whereas an LH project and LL project did show the significant difference in capability risk. Unlike HH and HL projects, the capability risk assessment was not very important to distinguish high return and low return. In level 2 risk, an LH project accurately assessed the contract risk rather than an LL project. This was the same result as in high-risk projects. For example, contract risk such as unfavorable tax and tariff treaty and retained earning transfer was directly affecting to contractors’ profitability. Therefore, contractors should improve their contract risk assessment capabilities and then establish effective risk response plans based on accurate contract risk assessment in order to achieve high returns regardless of the level of risk. On the other hand, interestingly, the RAA of management risk and technical risk were not very different between LH and LL projects unlike in high-risk projects. This study also presented that the overall RME was not significantly different between LH and LL projects. Even if both LH and LL projects successfully reduced the risk amounts, the amounts were similar. From the low-risk low return perspective, then, better risk assessment was also more critical than better risk mitigation.
Last, this study showed that contingency was not significantly different between high-risk projects and low-risk projects. Nevertheless, only the HH projects had a positive relation between contingency and predicted risk. This result implies that more contingency could be effective in yielding high returns. Unfortunately, in practice, it is difficult to apply enough high contingency to an international construction bid.

6. Conclusions

This study sought to increase our knowledge of the kinds of risk factors and management performances that can enable a project to yield a high return. This study classified the 124 projects into four project groups (HH, HL, LH, and LL projects) and compared them in three perspectives: risk assessment performance, contingency, and risk mitigation performance. First, risk assessment performance was the most important factor in causing a project to produce high returns in both high risk and low-risk projects. Especially, the study shows that the accuracy of assessing contract risk was the key indicator in distinguishing high and low return projects regardless of high and low-risk projects. The study also provided that the risk assessment accuracy of the capability was a crucial performance indicator in high-risk projects. Second, contingency was not significantly different in both high risk and low-risk projects. However, only the HH project showed a positive relation between contingency and predicted risk. Last, risk mitigation performance did not significantly affect project return in high both high risk and low-risk projects. Overall, the results show that better risk assessment was more critical than better risk mitigation. This study contributes to furthering our understanding of the difference between high return and low return projects from the perspectives of risk assessment, contingency, and risk mitigation. In so doing, practitioners can be helped in establishing risk management strategies for achieving sustainable profitability when they meet high-risk projects or low-risk projects. Despite these contributions, this study had several limitations. First, a project’s risk–return relationship can differ depending on the owner’s or the contractor’s perspective. However, this study focused on only the contractors’ perspective. Second, this study only investigated and analyzed international construction projects conducted by Korean contractors. Thus, the results could not be completely generalized: when applied to other countries, practitioners should consider different risk attitudes and market situations. Third, this study did not give in-depth management practice information because this study was not conducted by in-depth interviews and case studies but by questionnaire survey. Last, this study could not consider all factors that impact project return. If the market average profit, bidder number, competitiveness, and risk attitude are considered, the findings would be more practical and reliable. Therefore, future studies will deal with these limitations to provide more valuable information and knowledge for sustainable international construction businesses.

Author Contributions

J.W.W., W.J. and S.H.H. conceived and conceptualized. W.J. and S.H.H. developed the questionnaire, surveyed and collected data. J.W.W. analyze the data and wrote the manuscript. J.W.W., W.J., S.Y. and B.K. validated results. W.J., S.H.H., S.Y. and B.K. revised the manuscript. All authors have read and approved the final manuscript.

Funding

This work was supported by a grant funded by Ministry of Land, Infrastructure and Transport of Korean government (19SCIP-C079445-06).

Conflicts of Interest

The authors declare no conflict of interest.

References

  1. Merton, R.C. On estimating the expected return on the market: An exploratory investigation. J. Financ. Econ. 1980, 8, 323–361. [Google Scholar] [CrossRef]
  2. Cornett, M.M.; Saunders, A. Financial Institutions Management: A Risk Management Approach, 6th ed.; McGraw-Hill/Irwin: New York, NY, USA, 2003; pp. 168–188. [Google Scholar]
  3. Connolly, J.P. Discussion of “Modeling a Contractor’s Markup Estimation” by Min Liu and Yean Yng Ling. J. Constr. Eng. Manag. 2006, 132, 657–658. [Google Scholar] [CrossRef]
  4. Chiara, N. Infrastructure Risk Management in Renewable Energy Projects Using Risk Flexibility Theory. Building a Sustainable Future. In Proceedings of the Construction Research Congress, Seattle, WA, USA, 5–7 April 2009. [Google Scholar]
  5. Smith, G.R.; Bohn, C.M. Small to medium contractor contingency and assumption of risk. J. Constr. Eng. Manag. 1999, 125, 101–108. [Google Scholar] [CrossRef]
  6. Laryea, S.; Hughes, W. How contractors price risk in bids: Theory and practice. Constr. Manag. Econ. 2008, 26, 911–924. [Google Scholar] [CrossRef]
  7. Qazi, A.; Quigley, J.; Dickson, A.; Kirytopoulos, K. Project Complexity and Risk Management (ProCRiM): Towards modelling project complexity driven risk paths in construction projects. Int. J. Proj. Manag. 2016, 34, 1183–1198. [Google Scholar] [CrossRef] [Green Version]
  8. Han, S.H.; Kim, D.Y.; Kim, H. Predicting profit performance for selecting candidate international construction projects. J. Constr. Eng. Manag. 2007, 133, 425–436. [Google Scholar] [CrossRef]
  9. Liu, J.; Zhao, X.; Yan, P. Risk paths in international construction projects: Case study from Chinese contractors. J. Constr. Eng. Manag. 2016, 142, 05016002. [Google Scholar] [CrossRef]
  10. Lee, K.W.; Jung, W.; Han, S. Country selection model for sustainable construction businesses using hybrid of objective and subjective information. Sustainability 2017, 9, 800. [Google Scholar] [CrossRef]
  11. Construction Industry Institute (CII). Integrated Project Risk Assessment; CII: Austin, TX, USA, 2013. [Google Scholar]
  12. Han, S.H.; Kim, D.Y.; Kim, H.; Jang, W.S. A web-based integrated system for international project risk management. Autom. Constr. 2008, 17, 342–356. [Google Scholar] [CrossRef]
  13. Wang, J.; Xu, Y.; Li, Z. Research on project selection system of pre-evaluation of engineering design project bidding. Int. J. Proj. Manag. 2009, 27, 584–599. [Google Scholar] [CrossRef]
  14. Taylan, O.; Bafail, A.O.; Abdulaal, R.M.; Kabli, M.R. Construction projects selection and risk assessment by fuzzy AHP and fuzzy TOPSIS methodologies. Appl. Soft Comput. 2014, 17, 105–116. [Google Scholar] [CrossRef]
  15. Lundblad, C. The risk return tradeoff in the long run: 1836–2003. J. Financ. Econ. 2007, 85, 123–150. [Google Scholar] [CrossRef]
  16. Bodie, Z.; Shoven, J.B. (Eds.) Financial Aspects of the United States Pension System; University of Chicago Press: Chicago, IL, USA, 2008; pp. 91–152. [Google Scholar]
  17. Bruni, R.; Cesarone, F.; Scozzari, A.; Tardella, F. A linear risk–return model for enhanced indexation in portfolio optimization. OR Spectr. 2015, 37, 735–759. [Google Scholar] [CrossRef]
  18. Dewan, S.; Shi, C.; Gurbaxani, V. Investigating the risk–return relationship of information technology investment: Firm-level empirical analysis. Manag. Sci. 2007, 53, 1829–1842. [Google Scholar] [CrossRef]
  19. Müller, G.; Durand, R.B.; Maller, R.A. The risk–return tradeoff: A COGARCH analysis of Merton’s hypothesis. J. Empir. Financ. 2011, 18, 306–320. [Google Scholar] [CrossRef]
  20. Salvador, E. The risk–return trade-off in emerging markets. Emerg. Mark. Financ. Trade 2012, 48, 106–128. [Google Scholar] [CrossRef]
  21. Project Management Institute (PMI). A Guide to the Project Management Body of Knowledge, 5th ed.; PMI: Newtown Square, PA, USA, 2012. [Google Scholar]
  22. Kumar, M.; Gregory, M. An exploration of risk management in global industrial investment. Risk Manag. 2013, 15, 272–300. [Google Scholar] [CrossRef]
  23. Teall, J.; Hasan, I. Quantitative Methods for Finance and Investments, 1st ed.; John Wiley & Sons: Hoboken, NJ, USA, 2009; p. 88. [Google Scholar]
  24. Cowell, F. Risk-Based Investment Management in Practice, 2nd ed.; Palgrave Macmillan: London, UK, 2013; pp. 47–64. [Google Scholar]
  25. Bu-Qammaz, A.S.; Dikmen, I.; Birgonul, M.T. Risk assessment of international construction projects using the analytic network process. Can. J. Civ. Eng. 2009, 36, 1170–1181. [Google Scholar] [CrossRef]
  26. Hastak, M.; Shaked, A. ICRAM-1: Model for international construction risk assessment. J. Manag. Eng. 2000, 16, 59–69. [Google Scholar] [CrossRef]
  27. Lee, J.K.; Han, S.H.; Jang, W.; Jung, W. “Win-win strategy” for sustainable relationship between general contractors and subcontractors in international construction projects. KSCE J. Civ. Eng. 2018, 22, 428–439. [Google Scholar] [CrossRef]
  28. Ilmanen, A. Expected Returns: An Investor’s Guide to Harvesting Market Rewards, 1st ed.; John Wiley & Sons: Hoboken, NJ, USA, 2011. [Google Scholar]
  29. Jung, W.; Han, S.H.; Kim, Y.W.; Choi, J. Is it true that high risk yields high returns in international construction projects? Modern Methods and Advances in Structural Engineering and Construction. In Proceedings of the 6th International Structural Engineering and Construction Conference, Zurich, Switzerland, 21–26 June 2011. [Google Scholar]
  30. Gunhan, S.; Arditi, D. International expansion decision for construction companies. J. Constr. Eng. Manag. 2005, 131, 928–937. [Google Scholar] [CrossRef]
  31. Dikmen, I.; Birgonul, M.T.; Han, S. Using fuzzy risk assessment to rate cost overrun risk in international construction projects. Int. J. Proj. Manag. 2007, 25, 494–505. [Google Scholar] [CrossRef]
  32. Abdul-Rahman, H.; Berawi, M.; Berawi, A.; Mohamed, O.; Othman, M.; Yahya, I. Delay mitigation in the Malaysian construction industry. J. Constr. Eng. Manag. 2006, 132, 125–133. [Google Scholar] [CrossRef]
  33. Taroun, A. Towards a better modelling and assessment of construction risk: Insights from a literature review. Int. J. Proj. Manag. 2004, 32, 101–115. [Google Scholar] [CrossRef]
  34. Sadeghi, N.; Fayek, A.R.; Pedrycz, W. Fuzzy Monte Carlo simulation and risk assessment in construction. Comput. Aided Civ. Infrastruct. Eng. 2010, 25, 238–252. [Google Scholar] [CrossRef]
  35. Kwak, Y.H.; Ingall, L. Exploring Monte Carlo simulation applications for project management. Risk Manag. 2007, 9, 44–57. [Google Scholar] [CrossRef]
  36. Doskočil, R.; Lacko, B. Risk management and knowledge management as critical success factors of sustainability projects. Sustainability 2018, 10, 1438. [Google Scholar] [CrossRef]
  37. Han, S.; Diekmann, J.; Ock, J. Contractor’s risk attitudes in the selection of international construction projects. J. Constr. Eng. Manag. 2005, 3, 283–292. [Google Scholar] [CrossRef]
  38. Rietz, T.A. The equity risk premium a solution. J. Monet. Econ. 1988, 22, 117–131. [Google Scholar] [CrossRef]
  39. Touran, A. Calculation of contingency in construction projects. IEEE Trans. Eng. Manag. 2003, 50, 135–140. [Google Scholar] [CrossRef]
  40. Panthi, K.; Ahmed, S.M.; Ogunlana, S.O. Contingency estimation for construction projects through risk analysis. Int. J. Constr. Educ. Res. 2009, 5, 79–94. [Google Scholar] [CrossRef]
  41. Elbarkouky, M.M.; Fayek, A.R.; Siraj, N.B.; Sadeghi, N. Fuzzy arithmetic risk analysis approach to determine construction project contingency. J. Constr. Eng. Manag. 2016, 142, 04016070. [Google Scholar] [CrossRef]
  42. Sonmez, R.; Ergin, A.; Birgonul, M.T. Quantiative methodology for determination of cost contingency in international projects. J. Manag. Eng. 2007, 23, 35–39. [Google Scholar] [CrossRef]
  43. Construction Industry Institute (CII). Probabilistic Risk Management in Design and Construction Projects; CII: Austin, TX, USA, 2012; p. 15. [Google Scholar]
  44. Winch, G.M. Industrial Megaprojects: Concepts, Strategies and Practices for Success, 1st ed.; John Wiley & Sons, Inc: Hoboken, NJ, USA, 2012; pp. 325–328. [Google Scholar]
  45. Royer, P.S. Risk management: The undiscovered dimension of project management. Proj. Manag. J. 2000, 31, 6–13. [Google Scholar] [CrossRef]
  46. Ward, S.; Chapman, C. Transforming project risk management into project uncertainty management. Int. J. Proj. Manag. 2003, 21, 97–105. [Google Scholar] [CrossRef]
  47. Wang, S.Q.; Dulaimi, M.F.; Aguria, M.Y. Risk management framework for construction projects in developing countries. Constr. Manag. Econ. 2004, 22, 237–252. [Google Scholar] [CrossRef]
  48. Hallowell, M.; Gambatese, J.A. Construction safety risk mitigation. J. Constr. Eng. Manag. 2009, 135, 1316–1323. [Google Scholar] [CrossRef]
  49. Olawale, Y.A.; Sun, M. Cost and time control of construction projects: Inhibiting factors and mitigating measures in practice. Constr. Manag. Econ. 2010, 28, 509–526. [Google Scholar] [CrossRef]
  50. Jung, W.; Han, S.H. Which risk management is most crucial for controlling project cost? J. Manag. Eng. 2017, 33, 04017029. [Google Scholar] [CrossRef]
  51. Weiner, I.B.; Craighead, W.E. Corsini Encyclopedia of Psychology, 4th ed.; John Wiley & Sons, Inc: Hoboken, NJ, USA, 2010; pp. 960–961. [Google Scholar]
  52. Hitt, M.A.; Ahlstrom, D.; Dacin, M.T.; Levitas, E.; Svobodina, L. The institutional effects on strategic alliance partner selection in transition economies: China vs. Russia. Organ. Sci. 2004, 15, 173–185. [Google Scholar] [CrossRef]
  53. Roy, J.P.; Oliver, C. International joint venture partner selection: The role of the host-country legal environment. J. Int. Bus. Stud. 2009, 40, 779–801. [Google Scholar] [CrossRef]

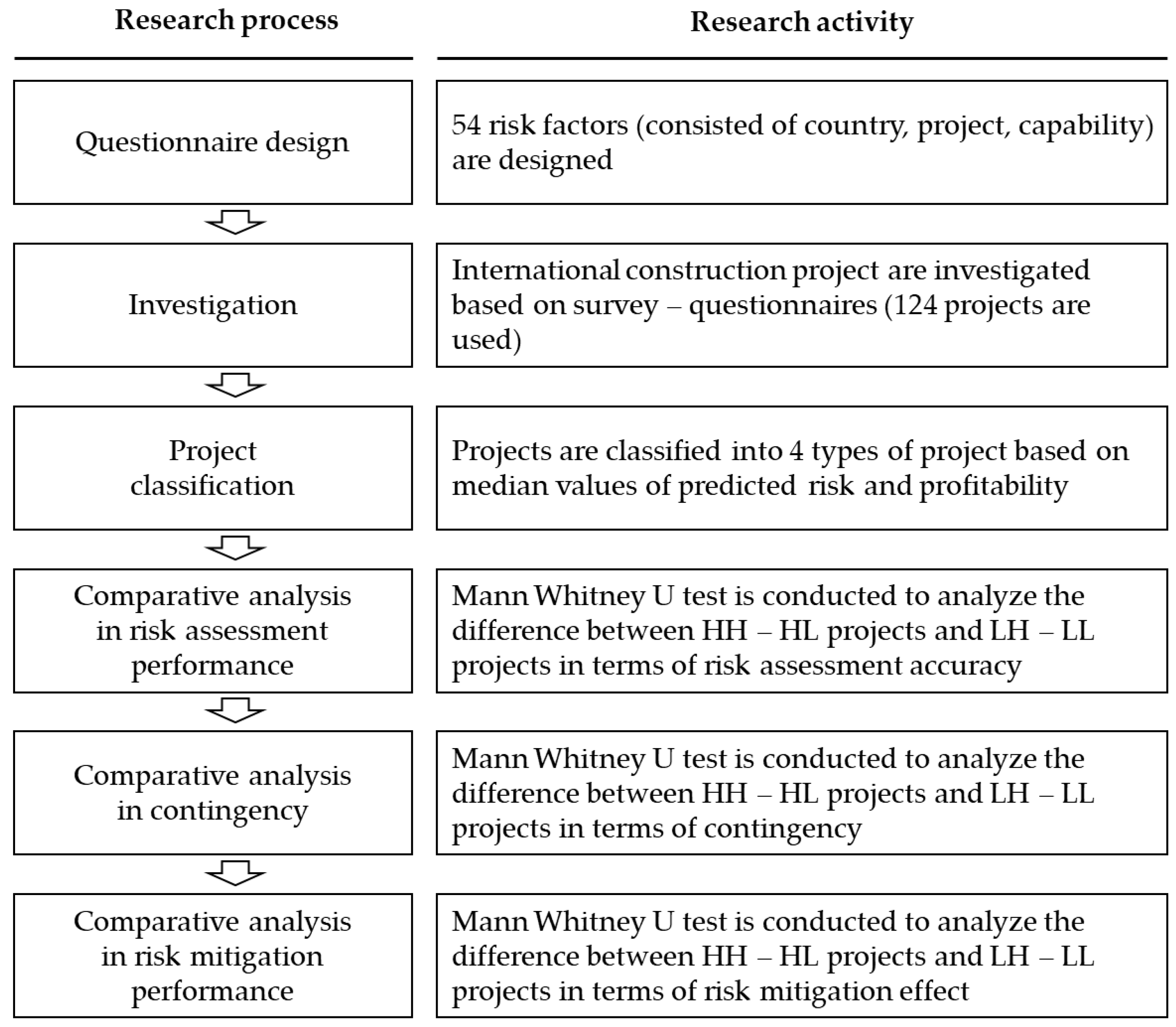

Figure 1. Research process and activity.
Figure 1. Research process and activity.
Sustainability 11 05971 g001

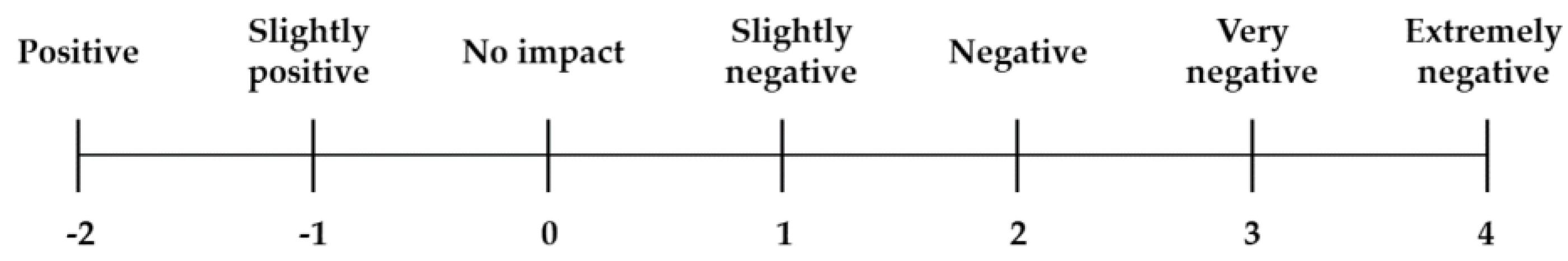

Figure 2. Risk measurement scale.
Figure 2. Risk measurement scale.
Sustainability 11 05971 g002

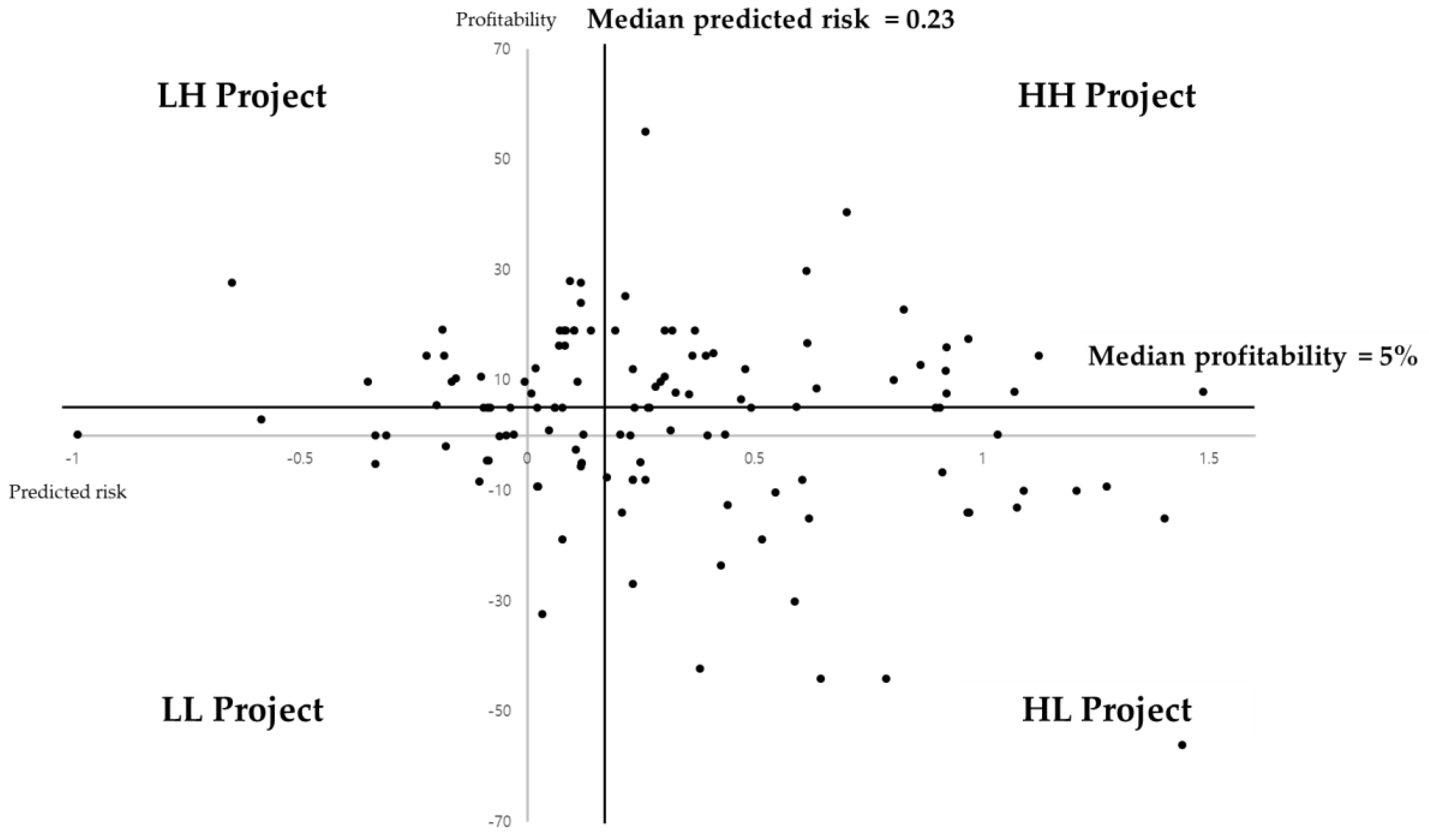

Figure 3. Four project groups.
Figure 3. Four project groups.
Sustainability 11 05971 g003
Table 1. Risk factor and risk structure (Jung and Han, 2017).
Table 1. Risk factor and risk structure (Jung and Han, 2017).
Level 1Level 2NumLevel 3
Country riskPolitical risk 1Political instability such as civil war and regime change
2Corruption, collusion, and underground deal practice
3Imperfect institution related to construction
Economic risk4Uncertainty of interest rate
5Uncertainty of inflation rate
6Uncertainty of local currency
Infra and Social risk7Difference in culture, customs, and routines
8Poor infra and logistics condition
9Staff supply difficulties in host country
10Material supply difficulties in host country
11Equipment supply difficulties in host country
12Subcontractor supply difficulties in host country
Project riskOwner risk13Insufficient project management capability of owner
14Unstable financing resources of owner
15Administrative approval and licensing delays
16Insufficient social consensus for project necessity
17Informal request by owner
Contract risk18Insufficient time for bid preparation
19Insufficient period for construction completion
20Design accuracy provided by owner
21Insufficient specification provided by owner
22Unrewarded change of law
23Unfavorable payment condition clause
24Unfavorable payment currency agreement
25Unfavorable security clause
26Unfavorable tax and tariff treaty
27Unfavorable retained earning transfer
28Unfavorable liquidated damage agreement
29Unreasonable requirements for local contents
30Unfavorable claim and arbitration agreement
Site risk31Unfavorable geographical accessibility
32Geological uncertainty
33Weather and climate uncertainty
34Poor living environment condition
Capability riskManagement risk35Insufficient cost management capability
36Insufficient schedule management capability
37Insufficient quality management capability
38Insufficient organizational management capability
39Insufficient resource management capability
40Insufficient headquarters’ support level
41Insufficient localization
42Insufficient language communication capability
43Insufficient information acquisition capability
44Insufficient contract management capability
45Insufficient claim management capability
46Insufficient labor training capability
Technical risk47Insufficient design management capability
48Insufficient estimation capability
49Overall construction method difficulties
50New construction technology difficulties
51IT based project management difficulties
Partner risk52JV’s insufficient construction capability
53Nominated subcontractor’s insufficient capability
54Ordinary subcontractor’s insufficient capability
Table 2. Sample profiles.
Table 2. Sample profiles.
HH ProjectHL ProjectLH ProjectLL Project
Number29312737
Predicted risk0.6200.698−0.015−0.026
Actual risk0.5800.9910.1620.395
Residual risk0.3130.7710.0010.192
Profitability15.5 %−12.2%16.4%−3.6%
Table 3. Risk assessment accuracy of high-risk high-return (HH) and high-risk low-return (HL) projects.
Table 3. Risk assessment accuracy of high-risk high-return (HH) and high-risk low-return (HL) projects.
Risk FactorsHH ProjectsHL Projectsp-Value
RAARankRAARank
Overall risk−0.0400.2930.001 **
Country risk−0.2510.1940.005 **
Political risk−0.25380.21530.076
Economic risk−0.24760.12920.024 *
Infra and social risk−0.25370.23840.001 **
Project risk0.0180.2820.006 **
Owner risk0.11450.33550.077
Contract risk0.05120.39280.003 **
Site risk−0.10940.11810.110
Capability risk0.1120.4020.006 **
Management risk0.10630.38970.024 *
Technical risk−0.04310.38360.002 **
Partner risk0.26490.46190.215
*: Reject null hypothesis at 5% significance level; **: reject null hypothesis at 1% significance level.
Table 4. Risk assessment accuracy of low-risk high-return (LH) and low-risk low-return (LL) projects.
Table 4. Risk assessment accuracy of low-risk high-return (LH) and low-risk low-return (LL) projects.
Risk FactorsLH ProjectsLL Projectsp-Value
ValueRankValueRank
Overall risk0.0470.2660.006 **
Country risk−0.1100.1830.004 **
Political risk0.02530.15320.764
Economic risk−0.00610.23950.219
Infra and social risk−0.34880.15830.011 *
Project risk−0.0270.2770.008 **
Owner risk0.22450.48180.122
Contract risk−0.01020.24260.001 **
Site risk−0.29660.10810.012 *
Capability risk0.2790.3360.703
Management risk0.29870.22240.343
Technical risk0.10740.28770.247
Partner risk0.43290.50090.479
*: Reject null hypothesis at 5% significance level; **: reject null hypothesis at 1% significance level.
Table 5. Contingency of HH–HL projects and LH–LL projects.
Table 5. Contingency of HH–HL projects and LH–LL projects.
HH projectsHL projectsp-value
Contingency2.30%2.10%0.874
LH projectsLL projectsp-value
Contingency1.88%2.04%0.360
Table 6. Predicted risk of HH and HL projects in terms of the contingency group.
Table 6. Predicted risk of HH and HL projects in terms of the contingency group.
Risk FactorsHH ProjectsHL Projects
Contingencyp-ValueContingencyp-Value
LowHighLowHigh
Overall risk0.5240.7090.049 *0.6140.7510.256
Country risk0.8251.0960.3030.9600.9820.887
Political risk1.0951.4220.3901.2781.0180.232
Economic risk0.5240.5000.5630.4030.6930.176
Infra and social risk0.8571.3670.046 *1.2001.2370.791
Project risk0.6560.7960.5410.8750.9170.490
Owner risk0.2710.5330.2250.4960.6370.192
Contract risk0.5010.5380.9650.6290.6801.000
Site risk1.1961.3170.7581.5001.4340.668
Capability risk0.0920.2350.1620.0060.3540.068
Management risk0.0760.1430.930−0.0830.2350.148
Technical risk0.6180.5390.9450.2210.4760.237
Partner risk−0.3570.0220.097−0.2270.3510.045 *
*: Reject null hypothesis at 5% significance level
Table 7. Predicted risk of LH and LL projects in terms of the contingency group.
Table 7. Predicted risk of LH and LL projects in terms of the contingency group.
Risk FactorsLH ProjectsLL Projects
Contingencyp-ValueContingencyp-Value
LowHighLowHigh
Overall risk−0.007−0.0250.845−0.0460.0050.146
Country risk0.3150.2180.4320.1770.2630.221
Political risk0.1330.0560.9200.3330.4000.424
Economic risk0.1440.4170.7390.0450.2220.187
Infra and social risk0.6670.1810.0560.1520.1670.913
Project risk0.2450.0240.130−0.0030.1520.146
Owner risk−0.187−0.1670.881−0.318−0.0330.078
Contract risk0.1560.1150.4040.0920.2060.341
Site risk0.7670.1250.0620.2160.2830.475
Capability risk−0.580−0.3160.078−0.312−0.4010.710
Management risk−0.678−0.3110.099−0.263−0.3850.779
Technical risk0.027−0.2210.385−0.126−0.2410.242
Partner risk−1.089−0.4170.055−0.545−0.5780.691
Table 8. Risk mitigation effect of the HH and HL projects.
Table 8. Risk mitigation effect of the HH and HL projects.
Risk FactorsHH ProjectsHL Projectsp-Value
ValueRankValueRank
Overall risk0.2660.2200.322
Country risk0.3980.2620.129
Political risk0.64210.31230.257
Economic risk0.20160.16170.968
Infra and social risk0.37930.31420.731
Project risk0.2650.2160.506
Owner risk0.08880.13280.889
Contract risk0.21850.20360.219
Site risk0.48920.31510.344
Capability risk0.1370.1810.692
Management risk0.12070.23640.896
Technical risk0.27740.10990.087
Partner risk0.02390.21150.290
Table 9. Risk mitigation effect of the LH and LL projects.
Table 9. Risk mitigation effect of the LH and LL projects.
Risk FactorsLH ProjectsLL Projectsp-Value
ValueRankValueRank
Overall risk0.0210.0480.091
Country risk0.0650.0780.434
Political risk0.13610.16210.330
Economic risk0.02550.03650.952
Infra and social risk0.03340.03660.445
Project risk0.0170.0640.041 *
Owner risk0.01560.06130.256
Contract risk0.03530.03840.759
Site risk0.00070.09520.056
Capability risk−0.0180.0030.670
Management risk−0.0518−0.00490.463
Technical risk0.12020.00480.092
Partner risk−0.12390.00970.119
*: Reject null hypothesis at 5% significance level

Share and Cite

MDPI and ACS Style

Won, J.W.; Jung, W.; Han, S.H.; Yun, S.; Koo, B. What Enables a High-Risk Project to Yield High Return from a Construction Contractor’s Perspective? Sustainability 2019, 11, 5971. https://doi.org/10.3390/su11215971

AMA Style

Won JW, Jung W, Han SH, Yun S, Koo B. What Enables a High-Risk Project to Yield High Return from a Construction Contractor’s Perspective? Sustainability. 2019; 11(21):5971. https://doi.org/10.3390/su11215971

Chicago/Turabian Style

Won, Jin Woo, Wooyong Jung, Seung Heon Han, Sungmin Yun, and Bonsang Koo. 2019. "What Enables a High-Risk Project to Yield High Return from a Construction Contractor’s Perspective?" Sustainability 11, no. 21: 5971. https://doi.org/10.3390/su11215971

Note that from the first issue of 2016, this journal uses article numbers instead of page numbers. See further details here.

Article Metrics

Back to TopTop
