Accelerating the Energy Transition through Power Purchase Agreement Design: A Philippines Off-Grid Case Study
Abstract
:1. Introduction

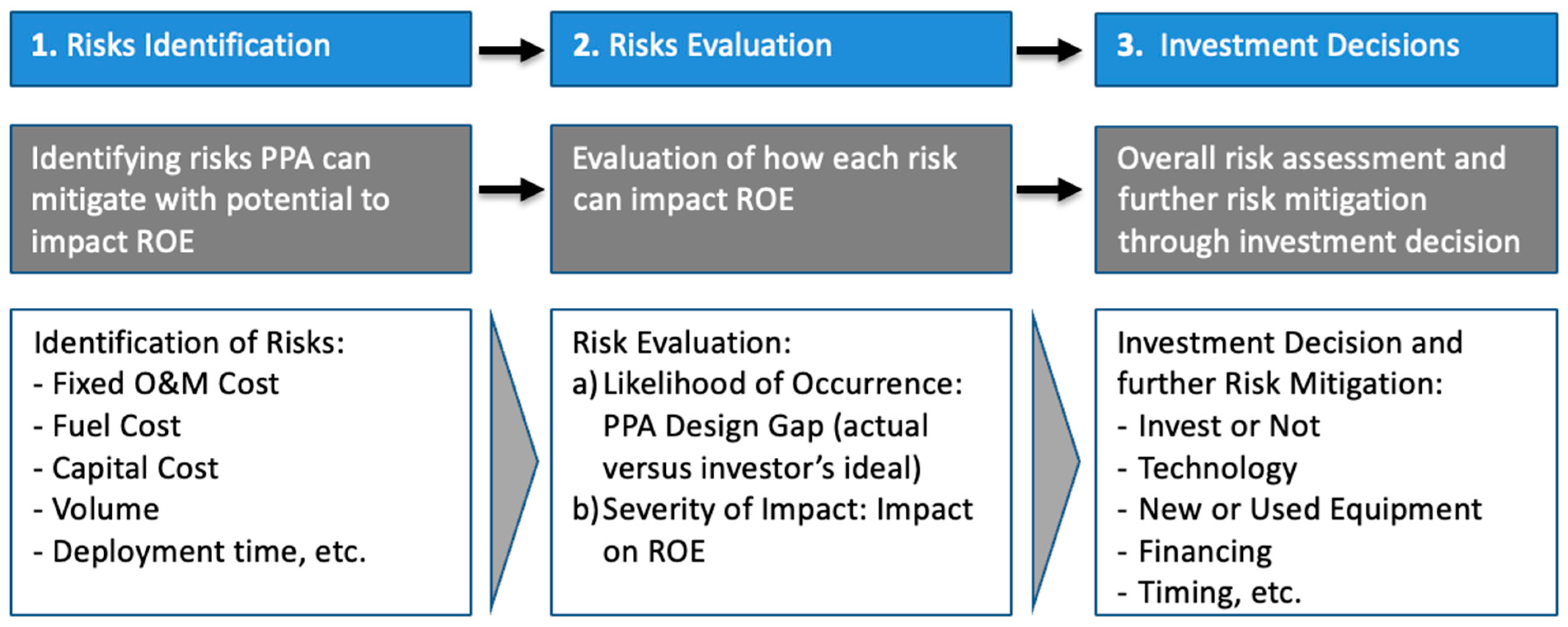

2. Background
3. Investment Drivers and Investors’ Decisions

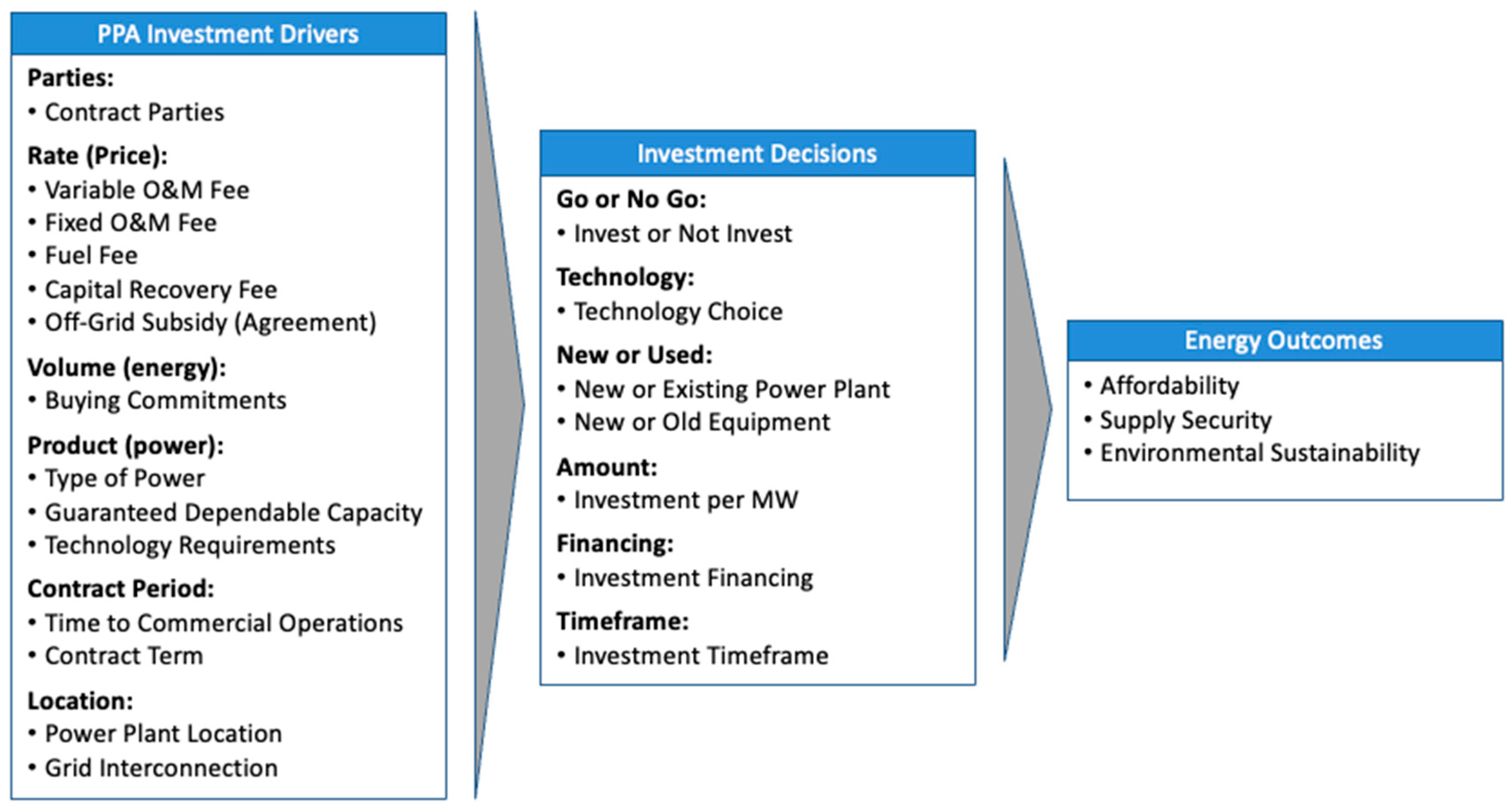

3.1. PPA Investment Drivers
3.2. Investment Decisions
4. Materials and Methods
4.1. Data
4.2. Methodology

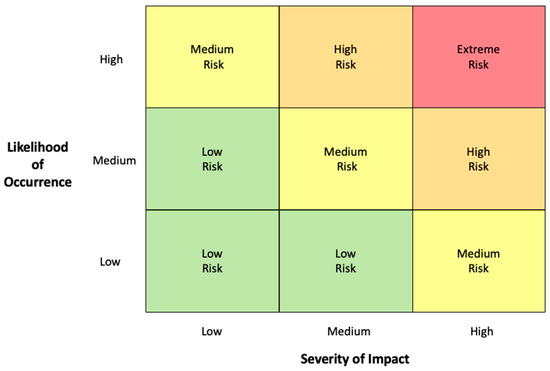

4.2.1. Identification of Risk PPA Mitigates (PPA Risks)
4.2.2. Risk Likelihood Evaluation Methodology
4.2.3. Risk Severity of Impact Evaluation Methodology
- Actual annual capital recovery = actual revenues − actual operating costs
- 2.
- Actual investment = civil works + electromechanics + project development + installation + construction insurance + interests during construction + others
- 3.
- Actual capital return pre-tax (%) = RATE (investment useful life (years), − actual investment (Php), actual annual capital recovery (Php))
- 4.
- The actual ROE is calculated by default, given the capital structure and cost, using the following formula:
4.2.4. Investment Decisions
5. Results

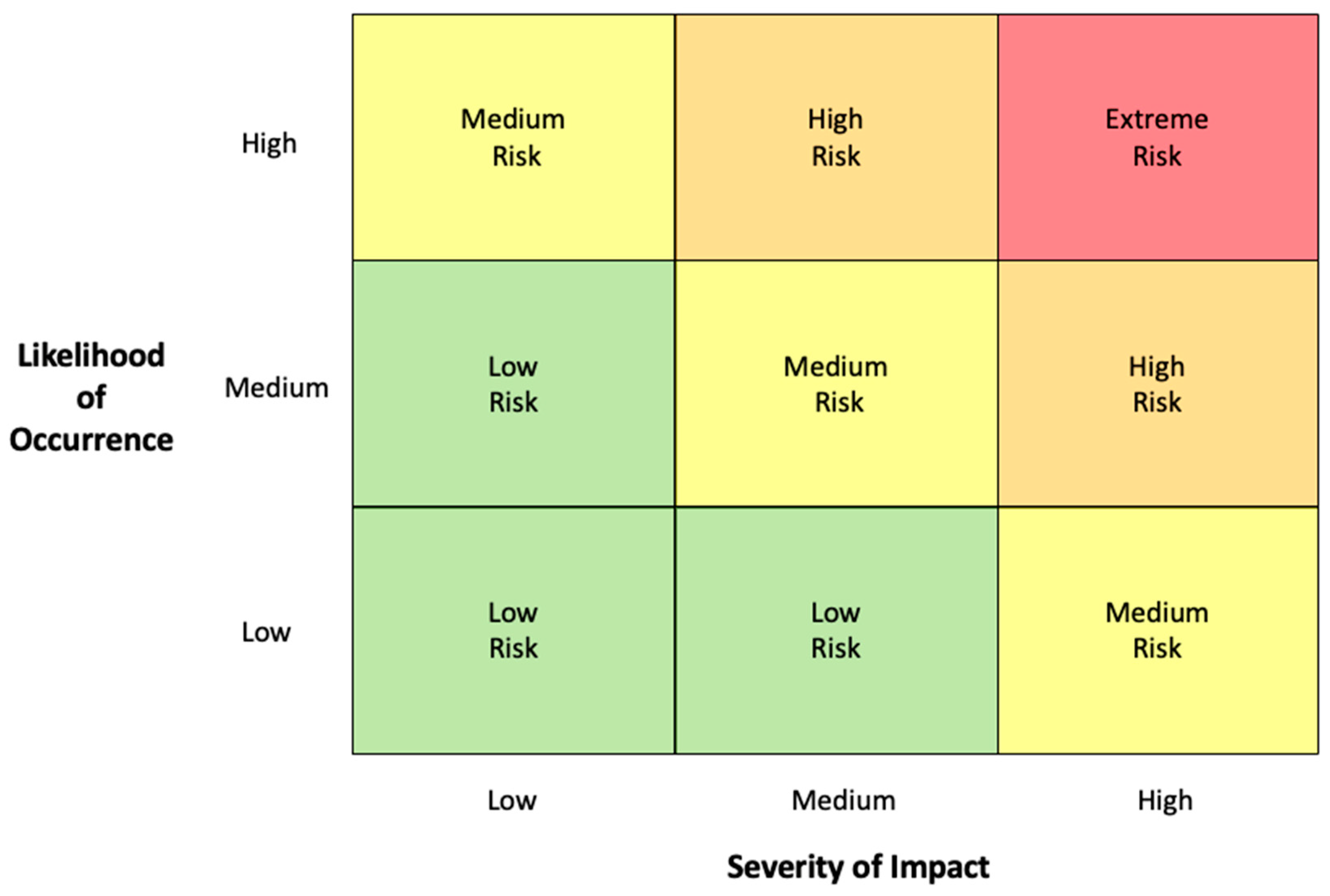

5.1. Evaluation of Risks’ Likelihood of Occurrence
5.2. Evaluation of Risks’ Severity of Impact
5.3. Investment Decisions
5.4. Energy Outcomes
6. Discussion
7. Conclusions
8. Policy Recommendations
Supplementary Materials
Author Contributions
Funding
Data Availability Statement
Conflicts of Interest
Abbreviations
AS | Ancillary services |
C | Coal |
CF | Corporate finance |
COC | Cost of capital |
COD | Commercial operations date |
COE | Cost of equity |
CRF | Capital recovery fee |
CRR | Capital recovery rate |
CSP | Competitive selection process |
D | Diesel |
DOE | Department of Energy |
DPC | DMCI Power Corporation |
DPI | Delta P, Inc |
DU | Distribution utility |
EC | Electric cooperative |
ECC | Environmental compliance certificate |
ERC | Energy regulatory commission |
FOM | Fixed operations and maintenance |
GDC | Guaranteed dependable capacity |
GHG | Greenhouse gas |
GW | Gigawatt (a unit of power) |
HFO | Heavy fuel oil |
IRR | Internal rate of return |
HV | High voltage |
KM | Kilometer |
kW | Kilowatt (a unit of power) |
kWh | Kilowatt-hour (a unit of energy) |
LGU | Local government unit |
LPC | Langogan Power Corp. |
LT | Long-term |
LV | Low voltage |
M | Million |
MO | Month |
MW | Megawatt (1000 kilowatt), a unit of power |
MWh | Megawatt-hour (1000 kilowatt-hours), a unit of energy |
NEA | National Electrification Administration |
NGO | Non-governmental organizations |
NPC | National Power Corporation |
OEM | Original equipment manufacturer |
O&M | Operations and maintenance |
Paleco | Palawan Electric Cooperative |
PEP | Philippines Energy Plan |
PF | Project finance |
PHP | Philippines peso |
PIRR | Project internal rate of return |
PPA | Power purchase agreement; other names for PPA are PSA (power supply agreement) or ESA (electricity supply agreement) or offtake agreement. |
PPGI | Palawan Power Generation Inc. |
RE | Renewable energy |
ROE | Return on equity |
RPS | Renewable portfolio standard |
SA | Subsidy agreement |
SAGR | Subsidized approved generation rate |
SO | System operator |
ST | Short-term |
TCGR | True cost generation rate |
USD | United States dollars |
VAT | Value-added tax |
VOM | Variable operations and maintenance |
VRE | Variable renewable energy |
WACC | Weighted average cost of capital |
Appendix A
Financial Variable | Units | HFO | Diesel | Coal | Solar | Hydro |
---|---|---|---|---|---|---|
Energy: | ||||||
Capacity | MW | 20 | 10 | 25 | 25 | 20 |
Capacity factor | % | 60% | 40% | 70% | 20% | 50% |
Guaranteed dependable capacity | Yes/No | Yes | Yes | Yes | No | No |
Reaches commercial operations | Yes/No | Yes | Yes | Yes | Yes | Yes |
Investment: | ||||||
Investment | USD M/MW | 1.078 | 0.500 | 2.844 | 1.359 | 4.932 |
Power plant useful life | Years | 15 | 10 | 20 | 25 | 25 |
Construction delay | Years | 0 | 0 | 0 | 0 | 0 |
Terminal value/investment | % | 5% | 5% | 5% | 5% | 5% |
Working capital (weeks of fuel) | Weeks | 2 | 2 | 2 | 0 | 0 |
Power plant location | Area Type | City | City | Suburb | Rural | Rural |
Land area | Hectares/MW | 0.09 | 0.09 | 0.37 | 1.00 | 5.00 |
Percentage of land acquired | % | 0% | 0% | 100% | 100% | 5% |
Land price in Palawan | USD/Sqm | 50.2 | 50.2 | 13.1 | 13.1 | 1.8 |
Switchyard and transformer | USD K/MW | 75.8 | 75.8 | 75.8 | 75.8 | 75.8 |
Transmission line cost | USD K/Km | 69.8 | 23.2 | 69.8 | 69.8 | 69.8 |
Transmission line length | Km | 0 | 0 | 5 | 15 | 40.5 |
Access road | USD k/Km | 20 | 20 | 20 | 20 | 50 |
Access road length | Km | 0 | 0 | 5 | 9 | 24.3 |
Fuel Cost: | ||||||
LFO consumption rate | Liters/kWh | 0.01 | 0.28 | 0.00 | 0.00 | 0.00 |
HFO consumption rate | Liters/kWh | 0.24 | 0.00 | 0.00 | 0.00 | 0.00 |
Coal consumption rate | Kilos/kWh | 0.00 | 0.00 | 0.84 | 0.00 | 0.00 |
Light fuel oil price (ex-Vat) | USD/L | 0.55 | 0.55 | 0.0 | 0.0 | 0.0 |
Heavy fuel oil price (ex-Vat) | USD/L | 0.37 | 0.37 | 0.0 | 0.0 | 0.0 |
Coal price (ex-Vat) | USD/kilo | 0.0 | 0.0 | 0.09 | 0.0 | 0.0 |
Operations and Maintenance Cost: | ||||||
O&M fixed rate | USD Cent/kWh | 1.48 | 2.40 | 2.60 | 1.88 | 1.52 |
O&M fixed rate (equivalent) | USD/mo./KW | 6.52 | 7.03 | 13.25 | 2.74 | 5.56 |
O&M variable rate | USD Cent/kWh | 1.92 | 2.38 | 1.22 | 0.20 | 0.28 |
Cost of Capital: | ||||||
Interest rate (cost of debt) | % | 8.0% | 8.0% | 8.0% | 8.0% | 8.0% |
Debt/investment | % | 0% | 0% | 70% | 70% | 70% |
Income tax rate | % | 30% | 30% | 30% | 10% | 10% |
Cost of equity | % | 12.2% | 12.2% | 12.2% | 12.2% | 12.2% |
Equity/investment | % | 100% | 100% | 30% | 30% | 30% |

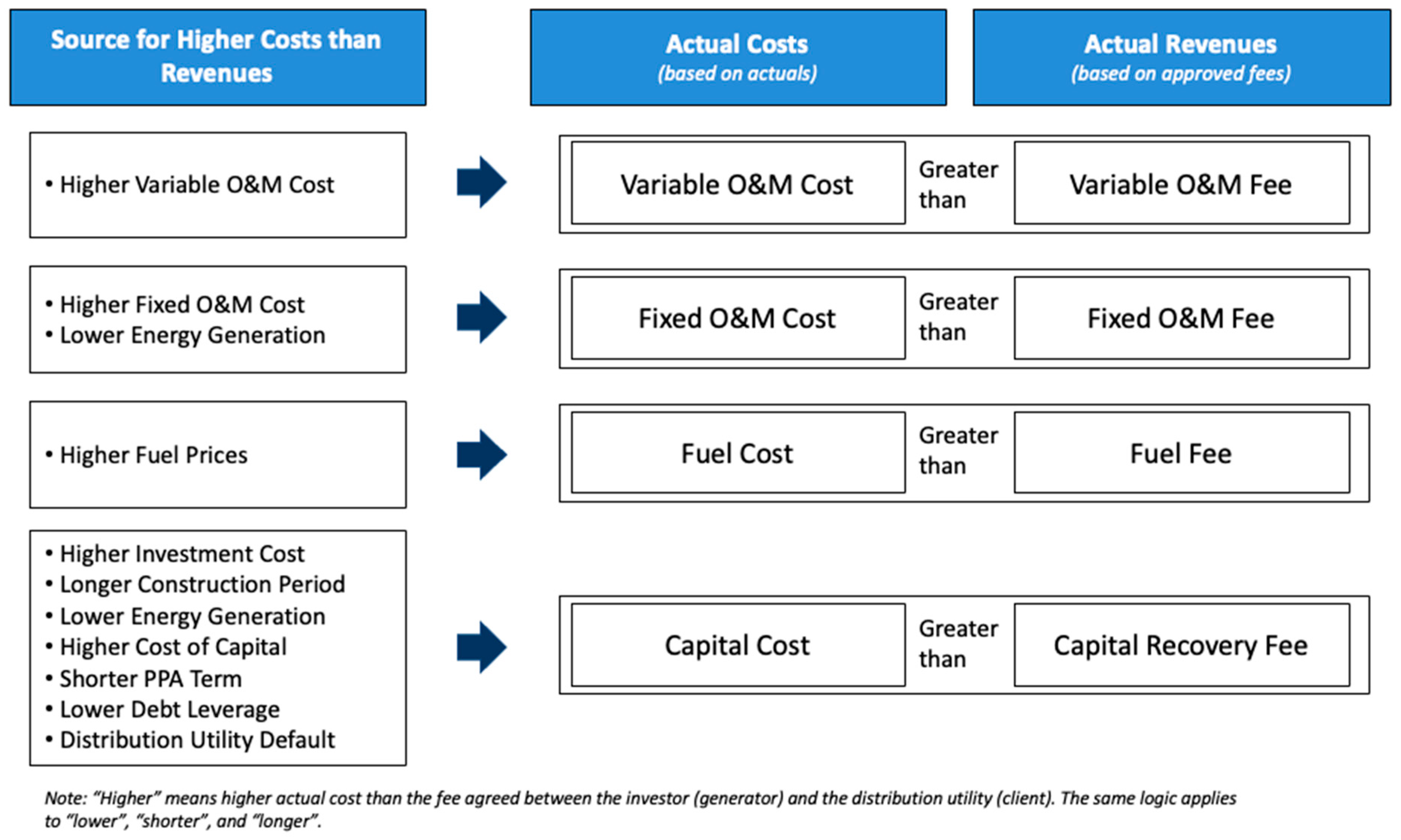

Risk PPA Mitigates | Simulation | Explanation |
---|---|---|
Parties creditworthiness | +10% cost of capital (CoC) | Cost of capital, that is cost of debt and equity, increases by one-tenth (10%) |
Parties creditworthiness | +10% CoC + lower debt % | Cost of capital increases by one-tenth, and debt/capital decreases by 20% (e.g., 70% to 50%) |
Parties creditworthiness | Paleco’s default | Paleco defaults 5 years after COD; residual value a fraction of initial investment. |
Variable O&M cost | +10% | Variable O&M cost increases by 10% |
Fixed O&M cost | +10% | Fixed O&M cost increases by 10% |
Fuel cost | +10% | PPA benchmark fuel price (Php/L or Php/kilo increases) by 10% |
Fuel cost | Average fuel cost | Historical average fuel price for the period instead of PPA benchmark price |
Capital cost | +10% | Capital costs increase by 10% |
Capital cost (investment) | +10% | Investment cost increases by 10% |
Volume | −10% | Energy Delivered is lower by 10% |
GDC | Fossil fuel and RE | RE forced to provide dependable capacity by hybridizing with firm technologies |
Deployment time | +1 year | Project construction extended by 1 year |
Contract term | −10% | Contract duration shortened by 10% |
Plant location | Next to load | RE and coal located in urban area like diesel/HFO |
Grid interconnection | Next to load | RE and coal located next to grid like diesel/HFO |
Investment Driver | Simulation | HFO | Diesel | Coal | Solar | Hydro |
---|---|---|---|---|---|---|
Base case | Base case | 12.2% | 12.2% | 12.2% | 12.2% | 12.2% |
Parties creditworthiness | +10% cost of capital (CoC) | 12.2% | 12.2% | 10.9% | 10.5% | 10.5% |
Parties creditworthiness | +10% CoC + lower debt % | 12.2% | 12.2% | 9.0% | 9.4% | 9.5% |
Parties creditworthiness | Paleco’s default (5th year) | 4.7% | 7.1% | −29% | −54% | −64% |
Variable O&M cost | +10% | 11.5% | 10.8% | 11.5% | 12.1% | 12.1% |
Fixed O&M cost | +10% | 11.6% | 10.7% | 10.6% | 11.4% | 11.7% |
Fuel cost | +10% | 8.4% | 1.3% | 7.5% | 12.2% | 12.2% |
Fuel cost | Average fuel cost | #NUM! | #NUM! | 13.9% | 12.2% | 12.2% |
Capital cost | +10% | 10.6% | 10.2% | 8.6% | 8.3% | 8.3% |
Capital cost (invst.) | +10% | 10.8% | 10.4% | 9.0% | 8.7% | 8.7% |
Volume | −10% | 10.0% | 8.7% | 7.0% | 7.5% | 7.8% |
GDC | Fossil fuel and RE | 12.2% | 12.2% | 12.2% | #NUM! | −2.7% |
Deployment time | +1 year | 10.2% | 9.9% | 7.4% | 8.9% | 8.9% |
Contract term | −10% | 11.8% | 11.3% | 11.0% | 11.1% | 11.1% |
Plant location | Next to load | 12.2% | 12.2% | 10.6% | 4.2% | −0.9% |
Grid interconnection | Next to load | 12.2% | 12.2% | 13.4% | 15.7% | 14.5% |
Appendix B

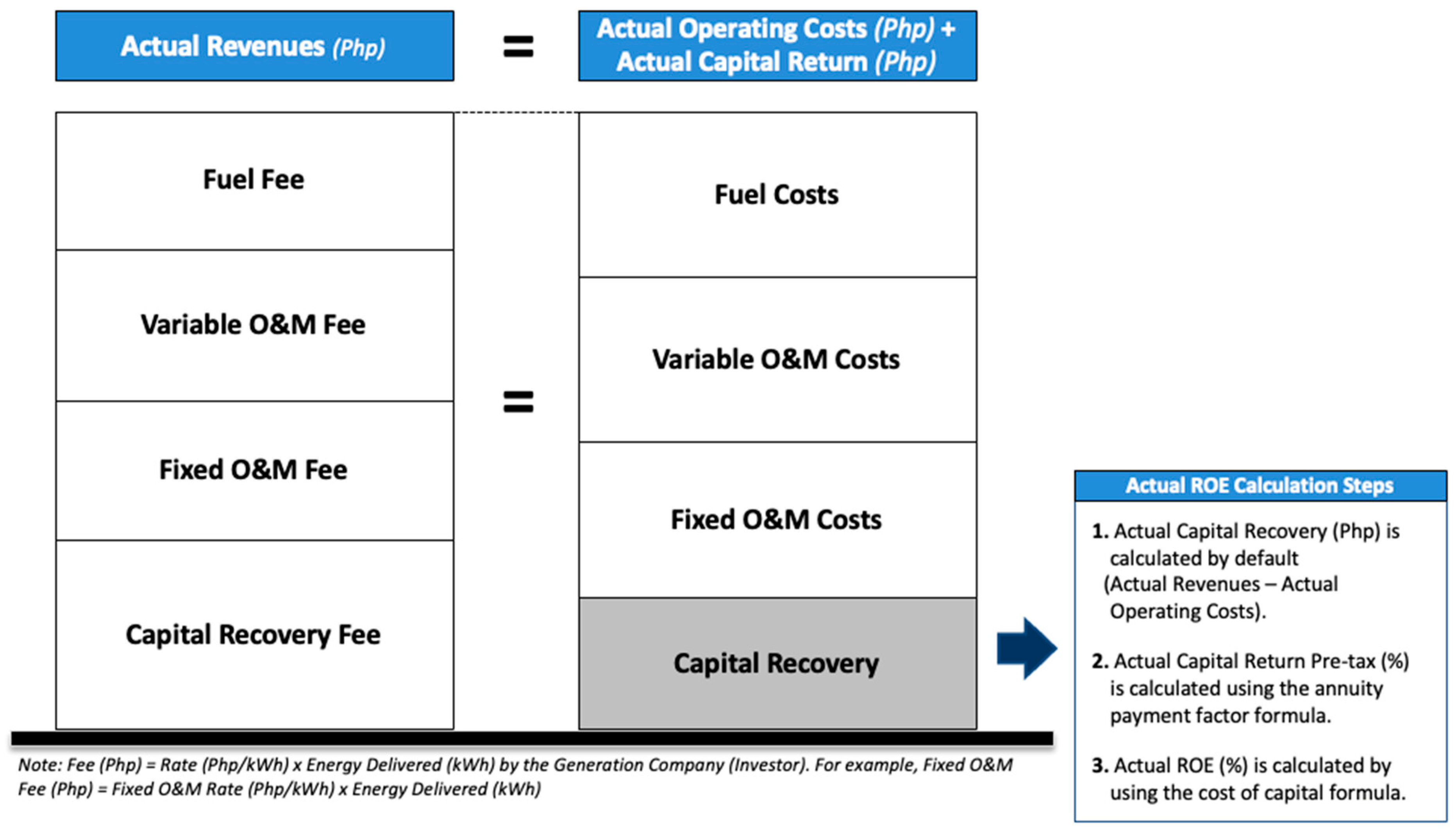

- Energy rate (Php/kWh) = TCGR (Php/kWh) = fuel rate (Php/kWh) + variable O&M rate (Php/kWh) + fixed O&M rate (Php/kWh) + capital recovery rate (Php/kWh).
- ERC defines TCGR as the rate to allow “recovery of just and reasonable costs and a reasonable return on investment” [60].
- Fuel rate (Php/kWh) = fuel cost per liter (Php/L) × fuel consumption rate (L/kWh);
- The fuel rate is subject to a maximum fuel consumption cap. The three types of fossil fuel for Paleco are heavy fuel oil (HFO), diesel, and coal. If the fuel cost is pass-through and stays within the fuel consumption cap, then the fuel rate equals the fuel cost per kWh.
- Variable operations and maintenance rate (Php/kWh): these are O&M cost directly associated with energy generation (kWh), such as materials and supplies, water, and maintenance tied to hours of operations.
- Fixed operations and maintenance rate (Php/kWh) = annual fixed O&M costs (Php)/annual energy delivered (kWh);
- These are O&M expenses incurred regardless of whether the power plant is operating or not, such as labor, general business expenses, regular maintenance, and insurance.
- Capital recovery rate (Php/kWh): annual capital recovery (Php)/annual energy delivered (kWh)
- Annual capital recovery (Php) = investment annualized value
- (for simplicity purposes, capital = investment)
- a.
- Investment annualized value = investment × annuity payment factorInvestment (excluding VAT) = cost of civil works + electromechanics + project development + installation + construction insurance + interests during construction + othersAnnuity payment factor = , where n = PPA term (years) and r = cost of capital pre-tax.It represents the value of an annuity, given a cost of capital (pre-tax) of r and n number of annual payments, equivalent to 1 peso today. For example, given a cost of capital (pre-tax) of 8% and 10 annual payments, the annuity payment factor is 0.149, i.e., the present value of 0.149 pesos paid every year for 10 years equals the value of 1 peso today.
- b.
- R = cost of capital pre-tax = weighted average cost of capital (WACC) pre-taxWACC pre-tax (%) = WACC after tax (%)/(1 − tax rate)Capital = investment;The WACC is pre-tax and not after tax since it is used to calculate the capital recovery rate (CRR) that will still be subject to income tax;Tax rate (%) = corporate income tax rate;Cost of debt = interest rate, to simplify;Cost of equity = 12.23% (ERC COE benchmark, source: 2016-082 RC). This is the cost of equity accepted by the regulator (ERC) during that the analysis period;The capital structure, a mix of equity and debt financing, depends on the project, but banks typically provide 70% of the investment in debt in low-risk projects.
- Energy delivered (kWh) = project capacity (MW) × capacity factor (%) × 24 h × 365 days
References
- Yescombe, E.R. Principles of Project Finance, 2nd ed.; Academic Press: Cambridge, MA, USA, 2013; ISBN 9780124157552. Available online: https://www.elsevier.com/books/principles-of-project-finance/yescombe/978-0-12-391058-5 (accessed on 4 March 2023).
- Batlle, C. Electricity generation and wholesale markets. In Regulation of the Power Sector; Pérez-Arriaga, I.J., Ed.; Springer: London, UK, 2013; pp. 341–395. [Google Scholar] [CrossRef]
- Kann, S. Overcoming barriers to wind project finance in Australia. Energy Policy 2009, 37, 3139–3148. [Google Scholar] [CrossRef]
- IRENA. Renewable Energy Market Analysis: Latin America; International Renewable Energy Agency: Abu Dhabi, United Arab Emirates, 2016; Available online: https://www.irena.org/publications/2016/Nov/Renewable-Energy-Market-Analysis-Latin-America (accessed on 4 March 2023).
- Hundt, S.; Jahnel, J.; Horsch, A. Power Purchase Agreements and Financing Renewables: An Interdependency. J. Struct. Financ. 2021, 27, 35–50. [Google Scholar] [CrossRef]
- Barroco, J. Designing financeable ancillary services revenue contracts in developing economies: Learnings from the Philippines. Energy Policy 2021, 152, 112218. [Google Scholar] [CrossRef]
- Barbosa, L.; Nunes, C.; Rodrigues, A.; Sardinha, A. Feed-in tariff contract schemes and regulatory uncertainty. Eur. J. Oper. Res. 2020, 287, 331–347. [Google Scholar] [CrossRef]
- Bloomberg NEF. Corporations Brush Aside Energy Crisis, Buy Record Clean Power. 2023. Available online: https://about.bnef.com/blog/corporations-brush-aside-energy-crisis-buy-record-clean-power/ (accessed on 15 July 2023).
- Department of Energy. List of Existing Power Plants (Off-Grid) as of December 2021. 2022. Available online: https://www.doe.gov.ph/sites/default/files/pdf/electric_power/05b_lvm_off-grid_summary_loepp-11302022.pdf (accessed on 15 July 2023).
- Department of Energy. List of Existing Power Plants (Grid-Connected) as of December 2021. 2022. Available online: https://www.doe.gov.ph/sites/default/files/pdf/announcements/electric_power_plants_05_lvm_summary_grid_december_2021.pdf (accessed on 15 April 2023).
- IEA; IRENA; UNSD; World Bank; WHO. Tracking SDG 7: The Energy Progress Report; World Bank: Washington, DC, USA, 2022; Available online: https://trackingsdg7.esmap.org/data/files/download-documents/sdg7-report2022-full_report.pdf (accessed on 24 July 2023).
- Department of Energy (DOE). 2016–2020 Missionary Electrification Development Plan. 2016. Available online: https://www.doe.gov.ph/sites/default/files/pdf/electric_power/medp_2016-2020.pdf?withshield=1 (accessed on 1 March 2022).
- Budi, R.F.S.; Sarjiya Hadi, S.P. Indonesia’s deregulated generation expansion planning model based on mixed strategy game theory model for determining the optimal power purchase agreement. Energy 2022, 260, 125014. [Google Scholar] [CrossRef]
- Gabrielli, P.; Hilsheimer, P.; Sansavini, G. Storage power purchase agreements to enable the deployment of energy storage in Europe. iScience 2022, 25, 104701. [Google Scholar] [CrossRef]
- Hedges, A.; Duvoort, M. How Multi-Technology PPAs Could Help Companies Reduce Risk. World Business Council for Sustainable Development. Available online: https://www.wbcsd.org/Programs/Climate-and-Energy/Energy/REscale/Resources/How-multi-technology-PPAs-could-help-companies-reduce-risk (accessed on 22 March 2023).
- Mendicino, L.; Menniti, D.; Pinnarelli, A.; Sorrentino, N. Corporate power purchase agreement: Formulation of the related levelized cost of energy and its application to a real life case study. Appl. Energy 2019, 253, 113577. [Google Scholar] [CrossRef]
- Qiu, Q.; Cui, L.; Yang, L. Maintenance policies for energy systems subject to complex failure processes and power purchasing agreement. Comput. Ind. Eng. 2018, 119, 193–203. [Google Scholar] [CrossRef]
- Shrimali, G. Managing power system flexibility in India via coal plants. Energy Policy 2021, 150, 112061. [Google Scholar] [CrossRef]
- Słotwiński, S. The Significance of the “Power Purchase Agreement” for the Development of Local Energy Markets in the Theoretical Perspective of Polish Legal Conditions. Energies 2022, 15, 6691. [Google Scholar] [CrossRef]
- Street, A.; Barroso, L.A.; Granville, S.; Pereira, M.V. Bidding strategy under uncertainty for risk-averse generator companies in a long-term forward contract auction. In Proceedings of the IEEE Power & Energy Society General Meeting, Calgary, AB, Canada, 26–30 July 2009; pp. 1–8. [Google Scholar] [CrossRef]
- Tranberg, B.; Hansen, R.T.; Catania, L. Managing volumetric risk of long-term power purchase agreements. Energy Econ. 2020, 85, 104567. [Google Scholar] [CrossRef]
- Bruck, M.; Sandborn, P.; Goudarzi, N. A Levelized Cost of Energy (LCOE) model for wind farms that include Power Purchase Agreements (PPAs). Renew. Energy 2018, 122, 131–139. [Google Scholar] [CrossRef]
- Ghiassi-Farrokhfal, Y.; Ketter, W.; Collins, J. Making green power purchase agreements more predictable and reliable for companies. Decis. Support Syst. 2021, 144, 113514. [Google Scholar] [CrossRef]
- Jain, S. Exploring structures of power purchase agreements towards supplying 24 × 7 variable renewable electricity. Energy 2022, 244, 122609. [Google Scholar] [CrossRef]
- Lei, X.; Sandborn, P.A. Maintenance scheduling based on remaining useful life predictions for wind farms managed using power purchase agreements. Renew. Energy 2018, 116, 188–198. [Google Scholar] [CrossRef]
- Mesa-Jiménez, J.J.; Tzianoumis, A.L.; Stokes, L.; Yang, Q.; Livina, V.N. Long-term wind and solar energy generation forecasts, and optimisation of Power Purchase Agreements. Energy Rep. 2023, 9, 292–302. [Google Scholar] [CrossRef]
- Rövekamp, P.; Schöpf, M.; Wagon, F.; Weibelzahl, M.; Fridgen, G. Renewable electricity business models in a post feed-in tariff era. Energy 2021, 216, 119228. [Google Scholar] [CrossRef]
- Vimpari, J. Financing Energy Transition with Real Estate Wealth. Energies 2020, 13, 4289. [Google Scholar] [CrossRef]
- Viswamohanan, A. Power Purchase Agreements as Instruments of Risk Allocation and Alleviation for Renewable Energy in Asia. In Renewable Energy Transition in Asia; Janardhanan, N., Chaturvedi, V., Eds.; Palgrave Macmillan: Singapore, 2021. [Google Scholar] [CrossRef]
- Dumitrescu, R.; Lüth, A.; Weibezahn, J.; Groh, S. Prosumer Empowerment through Community Power Purchase Agreements: A Market Design for Swarm Grids. Econ. Energy Environ. 2021, 11, 1. [Google Scholar] [CrossRef]
- Groh, S.; Dumitrescu, R.; Philipp, D. The Bangabandhu Tariff—Improving Access to Sustainable Electricity and Co-Benefits of Climate Change through Community Power Purchase Agreements. In Proceedings of International Conference on Fourth Industrial Revolution and Beyond 2021; Hossain, S., Hossain, M.S., Kaiser, M.S., Majumder, S.P., Ray, K., Eds.; Lecture Notes in Networks and Systems; Springer: Singapore, 2022; Volume 437. [Google Scholar] [CrossRef]
- Moner-Girona, M.; Szabo, S.; Bhattacharyya, S. Off-Grid Photovoltaic Technologies in the Solar Belt: Finance Mechanisms and Incentives. In Reference Module in Earth Systems and Environmental Sciences; Elsevier: Oxford, UK, 2016. [Google Scholar] [CrossRef]
- Njogu, M.; Kimathi, P.; DaSilva, I. Community-Developer Business Model Promoting Social Energy Enterprises; IEEE AFRICON: Cape Town, South Africa, 2017; pp. 1143–1148. [Google Scholar] [CrossRef]
- Ray, M.; Chakraborty, B. Impact of demand flexibility and tiered resilience on solar photovoltaic adoption in humanitarian settlements. Renew. Energy 2022, 193, 895–912. [Google Scholar] [CrossRef]
- Hollmén, S.; Levihn, F.; Martinsson, G. When markets don’t deliver: –Bilateral hedging by means of PPAs in managing intertemporal price risks in power generation investments. In Proceedings of the 18th International Conference on the European Energy Market (EEM), Ljubljana, Slovenia, 13–15 September 2022; pp. 1–6. [Google Scholar] [CrossRef]
- Horsch, A.; Hundt, S. Chapter 17: Corporate Risk Management with Power Purchase Agreements. In Transformations in Banking, Finance and Regulation Modern Finance and Risk Management; World Scientific Publishing Co Pte Ltd.: Singapore, 2022; Volume 1, pp. 379–400. [Google Scholar] [CrossRef]
- Osei, K. Negotiating Commercial Terms and Mitigating Risks in Virtual Power Purchase Agreements in the United States. House Couns. J. 2020, 13, 1–8. [Google Scholar]
- Energy Regulatory Commission (ERC). DPC 2013, ERC Case Number 2013-022 RC. In the Matter of the Application for Approval of the Supplemental Agreement to the Power Supply Agreement (PSA) between Palawan Electric Cooperative Inc. (Paleco) and DMCI Power Corporation, with Prayer for Provisional Authority or Interim Relief. Order Dated 6 June 2017. Available online: https://www.erc.gov.ph (accessed on 5 August 2022).
- Energy Regulatory Commission. In the Matter of the Application for Approval of the Power Supply Agreement between Palawan Electric Cooperative Inc. (Paleco) and Delta P., Inc. (Delta P) and New Power Provider—True Cost of Generation Rate (NPP-TCGR), with Prayer for Provisional Approval. ERC Case No. 2016-082 RC. Order Signed on 9 May 2017. Available online: https://www.erc.gov.ph (accessed on 5 August 2022).
- Baines, S.; Wrubell, S.; Kennedy, J.; Bohn, C.; Richards, C. An Examination of the regulatory and commercial challenges and opportunities arising in the context of private power purchase agreements. Agreements for Renewable Energy. Alta. L. Rev. 2019, 57, 389. [Google Scholar] [CrossRef]
- Mainali, B.; Silveira, S. Financing off-grid rural electrification: Country case Nepal. Energy 2011, 36, 2194–2201. [Google Scholar] [CrossRef]
- Aquelin Cochran; Lew, D.; Kumarb, N. Flexible Coal: Evolution from Baseload to Peaking Plant. National Renewable Energy Laboratory. 2013. Available online: https://www.nrel.gov/docs/fy14osti/60575.pdf (accessed on 4 March 2023).
- Duran, A.S.; Sahinyazan, F.G. An analysis of renewable mini-grid projects for rural electrification. Socio-Econ. Plan. Sci. 2021, 77, 100999. [Google Scholar] [CrossRef]
- Egli, F. Renewable energy investment risk: An investigation of changes over time and the underlying drivers. Energy Policy 2020, 140, 111428. [Google Scholar] [CrossRef]
- Ali, S.; Stewart, R.A.; Sahin, O. Startups versus incumbents in ‘green’ industry transformations: A comparative study of business model archetypes in the electrical power sector. Clean. Eng. Technol. 2021, 5, 100281. [Google Scholar] [CrossRef]
- Lefebvre, C.; Gazeau, T.; Payen, L.; Julien, E. Ensuring Steady Cash Flows in Off-Grid Solar Micro-Grid Projects). August 2018 (INIS-FR--19-1743). ENEA and Millennium Micro-Grid, France. Available online: https://www.enea-consulting.com/static/f77c918eceb788e5da445cb0ad83c7de/enea-ensuring-steady-cash-flows-in-off-grid-solar-microgrid-projects.pdf (accessed on 5 March 2023).
- UNDP. Derisking Renewable Energy Investment: Off-Grid Electrification. A Framework to Support Policymakers in Selecting Public Instruments to Promote Private Investment in Solar PV-Battery Mini-Grids in Developing Countries. UNDP and ETH Zürich. 2018. Available online: https://www.ndcs.undp.org/content/dam/LECB/docs/pubs-reports/UNDP-DREI-Renewables-Investment-Off-Grid--2018.pdf?download (accessed on 5 March 2023).
- USAID. Rapid Market Assessment of the Off-Grid Sector in Myanmar. USAID Burma Responsible Investment & Trade Activity. USAID. 2021. Available online: https://pdf.usaid.gov/pdf_docs/PA00XDJW.pdf (accessed on 4 March 2023).
- Jamal, T.; Urmee, T.; Shafiullah, G.M. Planning of off-grid power supply systems in remote areas using multi-criteria decision analysis. Energy 2020, 201, 117580. [Google Scholar] [CrossRef]
- IRENA. Accelerating Renewable Mini-Grid Deployment: A Study on the Philippines, International Renewable Energy Agency (IRENA). October 2017. Available online: https://www.irena.org/-/media/Files/IRENA/Agency/Publication/2017/Oct/IRENA_Philippines_Renewable_Mini-Grids_2017.pdf (accessed on 15 January 2022).
- Securities and Exchange Commissions (SEC) Philippines. 2022. Available online: https://secexpress.ph/ (accessed on 5 February 2022).
- Taghizadeh-Hesary, F.; Yoshino, N.; Rasoulinezhad, E.; Rimaud, C. Power purchase agreements with incremental tariffs in local currency: An innovative green finance tool. Glob. Financ. J. 2021, 50, 100666. [Google Scholar] [CrossRef]
- Barroco, J.; Herrera, M. Clearing barriers to project finance for renewable energy in developing countries: A Philippines case study. Energy Policy 2019, 135, 111008. [Google Scholar] [CrossRef]
- United Nations. United Nations, Department of Economic and Social Affairs, Sustainable Development. Goal 7: Ensure Access to Affordable, Reliable, Sustainable and Modern Energy for All. 2015. Available online: https://sdgs.un.org/goals/goal7 (accessed on 27 February 2022).
- Energy Regulatory Commission. In the Matter of the Application for Approval of the Power Supply Agreement (PSA) between Manila Electric Company (Meralco) and Powersource First Bulacan Solar, Inc. (PFBS), with Motion for Confidential Treatment of Information. ERC Case No. 2017-012-RC. 2017. Available online: https://www.erc.gov.ph (accessed on 5 August 2022).
- Aven, T. On the new ISO guide on risk management terminology. Reliab. Eng. Syst. Saf. 2011, 96, 719–726. [Google Scholar] [CrossRef]
- Department of Energy (DOE). 2018–2027 Distribution Development Plan. Department of Energy (DOE). 2018. Available online: https://www.doe.gov.ph/electric-power/2018-2027-distribution-development-plan-0 (accessed on 10 October 2022).
- NEA. Compliance Report on the Performance of Electric Cooperatives, 4th Quarter 2020; National Electrification Administration (NEA): Manila, Philippines, 2020.
- World Energy Council. World Energy Trilemma Index. 2022. Available online: https://www.worldenergy.org/transition-toolkit/world-energy-trilemma-index (accessed on 5 January 2023).
- Energy Regulatory Commission. Resolution No. 21, Series of 2011. A Resolution Adopting the Amended Guidelines for the Setting and Approval of Electricity Generation Rates and Subsidies for Missionary Electrification Areas. Order Signed on 22 August 2011. Available online: https://www.erc.gov.ph (accessed on 5 August 2022).
PPA Investment Driver | Definition | Ideal Design for Investors | References |
---|---|---|---|
Parties: | |||
Contract parties | PPA signatory parties; buyer and seller | Creditworthy and experienced parties | [5,33,36] |
Rate (Price): | |||
Variable O&M fee | Fee to recover O&M that varies with the energy generated | Php per kWh | [5] |
Fixed O&M fee | Fee to recover O&M that does not vary with the energy generated | Php per kW per month | [17] |
Fuel fee | Fee to recover fuel costs | Pass-through | [13,18] |
Capital recovery fee | Fee to recover capital costs (repayment and fair return) | Php per kW per month; Low requirement level | [13,16,18,40] |
Off-grid subsidy | Subsidy in excess of the subsidized generation rate | Regulator-approved and flexible to cover TCGR | [41] |
Volume: | |||
Buying commitments | Minimum energy (kWh) or power (kW) buying commitments | Minimum commitments or priority dispatch | [21,22,26] |
Product: | |||
Type of power | Baseload, mid-merit, or peak power | Flexible firm requirements | [18,42] |
GDC | Minimum capacity (kW) available at all times | Flexible firm requirements | [24,26] |
Technology requirements | Excluded technologies | Allowed technologies match developer capabilities | [43,44] |
Contract Period: | |||
Time to COD | The time between PPA effectivity and commercial operations date | Sufficient to construct the power plant | [6,22] |
Contract term | PPA duration (years) | The longer, the better; ≥10 years to recoup capital investment | [14,16,20,27,36] |
Location: | |||
Plant location | Power plant location requirements | Near load | [31,34] |
Grid interconnection | Interconnection requirements (LV, HV) | Near interconnection | [30,31,45] |
PPA | PPGI 2009 | PPGI 2010 | DPI 2009 | DPC 2012 | DPC 2013 | DPC 2017 | DPI 2017 | LPC 2016 |
---|---|---|---|---|---|---|---|---|
Technology | Diesel/HFO | Diesel/HFO | HFO | Diesel | Diesel/Coal | HFO | HFO | Hydro |
Capacity—MW | 7.2 | 10.0 | 16.0 | 5.0 | 27.0 | 9.9 | 30.3 | 17.8 |
Main Data Source | Investment Drivers and Investor’s Decisions |
---|---|
PPA ERC applications | PPA investment drivers: contract parties, contract term, variable cost operations and maintenance fee (VOM), fixed operations and maintenance fee (FOM), fuel fee, capital recovery fee (CRF), buying commitments, guaranteed dependable capacity (GDC), technology requirements, time to commercial operations date (COD), type of power, power plant location, grid interconnection location, off-grid subsidy agreement; Investment decisions: technology choice, new or existing power plant, new or old equipment, investment per MW, energy outcomes |
Investor’s audited financial statements | PPA investment drivers: time to commercial operations date (COD); Investment decisions: invest or not invest, long-term financing, technology choice, new or existing power plant, new or old equipment, investment per MW, energy outcomes |
DOE’s list of off-grid power plants | PPA investment drivers: power plant location Investment decisions: invest or not invest, technology choice, new or existing power plant. |
PPA Investment Driver | Risk PPA Mitigates | Risk Definition |
---|---|---|
Parties: | ||
Contract parties | Creditworthiness | Contract parties default on obligations |
Rate (Price): | ||
Variable O&M fee | Variable O&M cost | Variable O&M cost > Variable O&M fee |
Fixed O&M fee | Fixed O&M cost | Fixed O&M cost > Fixed O&M fee |
Fuel fee | Fuel cost | Fuel cost > fuel fee |
Capital recovery fee | Capital cost | Capital costs > capital recovery fee |
Off-grid subsidy | Off-grid subsidy | TCGR > SAGR |
Volume: | ||
Buying commitments | Volume | Actual volume < forecasted volume |
Product: | ||
Type of power | Type of Power | Mismatch between power required and offered |
GDC | GDC | Mismatch between capacity required and offered |
Technology requirements | Technology exclusions | Excluded technology |
Contract period: | ||
Time to COD | Deployment time | Time to COD < deployment time |
Contract term | Contract term | Short contract duration |
Location: | ||
Plant location | Plant location | Distant from load |
Grid interconnection | Grid interconnection | Lack or insufficient grid connection |
PPA | PPGI 2009 | PPGI 2010 | DPI 2009 | DPC 2012 | DPC 2013 | DPC 2017 | DPI 2017 | LPC 2016 |
---|---|---|---|---|---|---|---|---|
Technology | Diesel/HFO | Diesel/HFO | HFO | Diesel | Coal/Diesel | HFO | HFO | Hydro |
Capacity—MW | 7.2 | 10.0 | 16.0 | 5.0 | 27.0 | 9.9 | 30.3 | 17.8 |
PPA Investment Drivers: | ||||||||
Contract parties | PPGI/Paleco | PPGI/Paleco | DPI/Paleco | DPC/Paleco | DPC/Paleco | DPC/Paleco | DPI/Paleco | LPC/Paleco |
Variable O&M fee | /kWh | /kWh | /kWh | /kWh | /kWh | /kWh | /kWh | /kWh |
Fixed O&M fee | /kWh | /kWh | /kWh | n/a | /kWh | /kWh | /kW/mo. | /kWh |
Fuel fee | Pass-through | Pass-through | Pass-through | Pass-through | Pass-through | Pass-through | Pass-through | n/a |
Capital recovery fee | /kWh | /kWh | /kWh | /kW/mo. | /kWh | /kWh | /kW/mo. | /kWh |
Capital recovery fee (level) (1) | Low | Low | Low | Low | C: High D: Low | Medium | Medium | Very High |
Off-grid subsidy | Yes | Yes | Yes | Yes | Yes | Yes | Yes | No |
Buying commitments | None | None | None | None | None | None | None | None |
Priority dispatch | Yes | 2nd | 3rd | 4th | 4th | 4th | Merit order | Yes |
Type of power | Firm | Firm | Firm | Firm | Firm | Firm | Firm | Non-Firm |
GDC | None | None | 13.5 | 5.0 | 25.0 | 9.9 | 20.0 | None |
Time to COD (2) (months) | n/a | n/a | 2 | 2 | 13 | 6 | 12 | 30 |
Contract term (years) | 15 | 15 | 10 | 1 | 15 | 12 | 15 | 25 |
Plant location | City | Suburb | City | City | Suburb | Suburb | City | Rural |
Grid interconnection | LV | HV | LV | LV | HV | HV | LV/HV | HV |
TABLE LEGEND: | Ideal contract design for Investors | Tolerable contract design for investors | Risky/problematic design for investors |
PPA | PPGI 2009 | PPGI 2010 | DPI 2009 | DPC 2012 | DPC 2013 | DPC 2017 | DPI 2017 | LPC 2016 |
---|---|---|---|---|---|---|---|---|
Type of power | Peak, reserve | Base, peak | Base, interim, peak | N/a | All active power and reserves | Base, interim, peak | All active power and reserves | N/a |
PPA Risk | Simulation | HFO | Diesel | Coal | Solar | Hydro |
---|---|---|---|---|---|---|
Parties creditworthiness | +10% cost of capital (CoC) | 0% | 0% | −11% | −14% | −14% |
Parties creditworthiness | +10% CoC + lower debt % | 0% | 0% | −27% | −23% | −23% |
Parties creditworthiness | Paleco’s default | −61% | −42% | −338% | −545% | −626% |
Variable O&M cost | +10% | −6% | −12% | −6% | −1% | −1% |
Fixed O&M cost | +10% | −5% | −12% | −13% | −7% | −4% |
Fuel cost | +10% | −32% | −89% | −39% | 0% | 0% |
Fuel cost | Average fuel cost | #NUM! | #NUM! | 14% | 0% | 0% |
Capital cost | −10% | −13% | −16% | −30% | −32% | −32% |
Capital cost (invst.) | +10% | −12% | −14% | −27% | −29% | −29% |
Volume | −10% | −18% | −29% | −43% | −39% | −36% |
GDC | Fossil fuel and RE | 0% | 0% | 0% | #NUM! | −122% |
Deployment time | +1 year | −17% | −19% | −40% | −27% | −27% |
Contract term | −10% | −4% | −7% | −10% | −10% | −10% |
Plant location | Next to load | 0% | 0% | −13% | −66% | −107% |
Grid interconnection | Next to load | 0% | 0% | 10% | 29% | 19% |
TABLE LEGEND: | ROE changes by 15% or more |
PPA | PPGI 2009 | PPGI 2010 | DPI 2009 | DPC 2012 | DPC 2013 | DPC 2017 | DPI 2017 | LPC 2016 |
---|---|---|---|---|---|---|---|---|
Investment: yes or no | Yes | Yes | Yes | No (rental) | D: yes; C: no | Yes | Yes | No |
Technology choice | Diesel/HFO | Diesel/HFO | HFO | Diesel | Diesel/coal (1) | HFO | HFO | Hydro (1) |
New or old power plant and site | Old plant and site (rehab) | New site | Old plant and site (rehab) | Old site | New site | Old site | Old site | New site |
New or old equipment | Old | Old | Old | Old | D: old; C: new (1) | Old | Old | New (1) |
Investment (USD millions/MW) | 0.34 | 0.41 | 0.50 | n/a | D: 0.5 C: 3.5 (2) | 1.10 | 1.01 | 4.93 (2) |
Actual financing | Equity | Equity | Equity | n/a | Equity | Equity | Debt | n/a |
Investment timeframe | 5 yrs. | 6 yrs. | mos. | mos. | 1 yr./n/a | 1 yr. | 1 yr. | n/a |
PPA | PPGI 2009 | PPGI 2010 | DPI 2009 | DPC 2012 | DPC 2013 | DPC 2017 | DPI 2017 | LPC 2016 |
---|---|---|---|---|---|---|---|---|
LT debt % | 1 | −9 | 0 | n/a | −2 | 1 | 77 | n/a |
Equity % | 99 | 109 | 100 | n/a | 102 | 99 | 23 | n/a |
Planned financing (per PPA) | Equity since PIRR = 13.25% | Equity since PIRR = 14.58% | 100% equity at 14.6% | n/a but minimal investment | n/a | 70% debt at 8%, 30% equity at 11.9% | 100% equity at 12.23% | Mix of debt and equity |
PPA | PPGI 2009 | PPGI 2010 | DPI 2009 | DPC 2012 | DPC 2013 | DPC 2017 | DPI 2017 | LPC 2016 |
---|---|---|---|---|---|---|---|---|
Technology | Diesel/HFO | Diesel/HFO | HFO | Diesel | Diesel/coal | HFO | HFO | Hydro |
Capital recovery rate (CRR) | 2.12 | 2.70 | 2.86 | 2.16 | 3.30/7.34 | 4.23 | 3.94 | 13.16 |
O&M rate | 3.22 | 2.20 | 3.88 | n/a | 1.94/3.80 | 2.10 | 3.14 | 0.00 |
Fuel rate | 15.68 | 15.68 | 14.08 | n/a | 20.36/7.60 | 9.72 | 9.42 | 0.00 |
TCGR | 21.02 | 20.56 | 20.82 | n/a | 25.6/18.76 | 16.05 | 16.50 | 13.16 |
PPA | PPGI 2009 | PPGI 2010 | DPI 2009 | DPC 2012 | DPC 2013 | DPC 2017 | DPI 2017 | LPC 2016 |
---|---|---|---|---|---|---|---|---|
Technology | Diesel/HFO | Diesel/HFO | HFO | Diesel | Coal/Diesel | HFO | HFO | Hydro |
Capacity—MW | 7.2 | 10.0 | 16.0 | 5.0 | 27.0 | 9.9 | 30.3 | 17.8 |
Risks PPA Mitigates: | ||||||||
Creditworthiness—investor | ||||||||
Creditworthiness—Paleco | ||||||||
Variable O&M cost | ||||||||
Fixed O&M cost | ||||||||
Fuel cost | ||||||||
Capital cost | Coal Diesel | |||||||
Capital cost (invst.) (1) | Coal Diesel | |||||||
Off-grid subsidy | ||||||||
Volume | ||||||||
Priority dispatch | ||||||||
Type of power | ||||||||
GDC | ||||||||
Time to COD (2) (months) | ||||||||
Contract term (years) | ||||||||
Plant location | ||||||||
Grid interconnection | ||||||||
Investor’s Decisions: | ||||||||
Investment: yes (Y) or no (N) | Yes | Yes | Yes | No (Rental) | C: No D: Yes | Yes | Yes | No |
Technology choice | Diesel/HFO | Diesel/HFO | HFO | Diesel | Coal (3) Diesel | HFO | HFO | Hydro (3) |
New or old power plant | Old plant, old site | New site | Old plant, old site | Old site | New site | Old site | Old site | New site |
New or old equipment | Old | Old | Old | Old | C: new (3) D: Old | Old | Old | New (3) |
Investment (USD millions/MW) | 0.34 | 0.41 | 0.50 | n/a | C: 3.5 (4) D: 0.5 | 1.10 | 1.01 | 4.93 (4) |
Actual financing | Equity | Equity | Equity | n/a | Equity | Equity | Debt | n/a |
Investment timeframe | 5 yrs. | 6 yrs. | mos. | mos. | 1 yr. | 1 yr. | 1 yr. | n/a |
Table Legend: | Extreme Risk | High Risk | Medium Risk | Low Risk |
Disclaimer/Publisher’s Note: The statements, opinions and data contained in all publications are solely those of the individual author(s) and contributor(s) and not of MDPI and/or the editor(s). MDPI and/or the editor(s) disclaim responsibility for any injury to people or property resulting from any ideas, methods, instructions or products referred to in the content. |
© 2023 by the authors. Licensee MDPI, Basel, Switzerland. This article is an open access article distributed under the terms and conditions of the Creative Commons Attribution (CC BY) license (https://creativecommons.org/licenses/by/4.0/).
Share and Cite
Barroco, J.; Vithayasrichareon, P. Accelerating the Energy Transition through Power Purchase Agreement Design: A Philippines Off-Grid Case Study. Energies 2023, 16, 6645. https://doi.org/10.3390/en16186645
Barroco J, Vithayasrichareon P. Accelerating the Energy Transition through Power Purchase Agreement Design: A Philippines Off-Grid Case Study. Energies. 2023; 16(18):6645. https://doi.org/10.3390/en16186645
Chicago/Turabian StyleBarroco, Jose, and Peerapat Vithayasrichareon. 2023. "Accelerating the Energy Transition through Power Purchase Agreement Design: A Philippines Off-Grid Case Study" Energies 16, no. 18: 6645. https://doi.org/10.3390/en16186645
APA StyleBarroco, J., & Vithayasrichareon, P. (2023). Accelerating the Energy Transition through Power Purchase Agreement Design: A Philippines Off-Grid Case Study. Energies, 16(18), 6645. https://doi.org/10.3390/en16186645
