2. Literature Review
Construction projects worldwide are suffering from schedule delays. Accordingly, many studies have been conducted to identify the causes of delays in oil and gas industry projects. In one such research conducted in Malaysia [
1], the author identified and listed different delay causes in the oil and gas projects. In this review, 47 causes are identified and grouped into six categories: client, external, engineering, resources, project, and contractor. This research was based purely on a literature review, comparison of similar cases, benchmarking, and critical judgment.
Gomam and Pongpeng [
2] used confirmatory factor analysis to determine the delays produced by contractors, which include seven different causes: weak site supervision and management, shortage of laws and safety rules, bad communication, bad procurement system administration, supplier payment lateness, poor project planning and scheduling, and imperfect components and errors occurred in the overall construction. The delays caused by suppliers stemmed from the late delivery of material, low-efficiency equipment, unqualified and unskilled people, low-quality materials, delays in the supply of workers, and price increases.
Kasemi and Katebi [
3] categorized delay causes into four groups: owner, consultant, contractor, and other. The major causes leading to schedule delays that were associated with owners were related to change orders and changes in scope. Consultant delays often stemmed from document review, whereas the major causes of delays by contractors were insufficient experience and knowledge, and mistakes made during construction. The authors also identified the low productivity of laborers as a key cause in delaying a project. All conclusions were drawn from a literature review.
Fallahnejad [
4] identified 10 key delay causes: land expropriation, client-related materials, unrealistic project duration, contractor selection, contractor payment, change orders, permits, suppliers, imported materials, and contractor cashflow. The study was based on 24 executed pipeline projects. The author obtained a 43-item list of causes after discussions with 10 experts from different disciplines. These were then ranked using data obtained from a questionnaire survey, producing the final list of 10 causes.
One study relevant to GCC countries [
5] researched delay causes in Omani construction processing facilities of oil and gas. Ruqaishi and Bashir distributed a questionnaire and collected information from fifty-nine project managers of various oil and gas organizations in Oman. Seven delay causes were found to be the most major: delays in material delivery, conflicts with subcontractors, insufficient contractor planning, poor management of contractors’ schedules, contractors’ weak site management and supervision, ineffective communication between project stakeholders, and weak communication with vendors in the procurement and engineering phases. The primary six delay causes were considered general, whereas the last was explicit to the oil and gas industry because these construction projects are characterized by the use of advanced technology and made-to-order products. Similarly, Mohammad and Sulaiman [
6] found that both contractor- and owner-related causes were ranked high in affecting the cost and duration of oil and gas pipeline construction projects in Bahrain. Insufficient project budgeting, planning, and scheduling; late materials delivery; and scope variation were the highest-ranked causes.
Sivapornpunlerd [
7] evaluated the performance of materials suppliers using the analytical hierarchy process, finding the most important measures when evaluating the performance of suppliers of pipeline materials to be quality, delivery, service, and flexibility. Ahmadian and colleagues [
8] highlighted the importance of considering site material transportation time during project planning, as well as its effect on the overall performance of project. The research proposed a framework for estimating transportation duration according to the transport mode, size, and weight of the material.
Kpamma and Adjei-Kumi [
9] examined the process for obtaining construction permits and its impact on activities flow, conducting interviews with the different agencies responsible for permit issuance. The research indicated that a lack of integrated process steps and delays in issuance and processing were obstacles to a project’s continuous flow.
With regard to subcontractor delays, Yoke-Lian et al. [
10] reviewed subcontracting practices in construction projects and industry and found the most common types of subcontractors, problems frequently faced, and best-practice solutions. Risks to the construction project, project delays, and subcontractor safety were all identified as problems with subcontracting. Usdiken et al. [
11] studied strategies for and the limitations of construction subcontracting, investigating possible deterrents to subcontracting for construction firms.
Chin [
12] conducted a root cause analysis in an effort to first identify and then eliminate the delay causes in the preparation and approval of drawings by engineering consultants. The author found that the root cause of lengthy engineering reviews is inadequate and vague data, rather than the availability and ability of reviewers. As for the COVID-19 pandemic on the oil and gas construction industry, Abdelrassoul and Bin Abdul Rahim [
13] found that low productivity due to frequent disruption and the late delivery of material and equipment due to border restrictions were the major causes of delay. The research developed some mitigation strategies to overcome the delay including a change in mindset and leadership, and adopting new cultural principles.
Moreover, as indicated by Andersen, B [
14] the problem can be resulted from more than a single cause. The author also revealed that the problem can be categorized into three; “Symptoms”; “First-level causes”; and “Higher-level causes”. It is worth it to note that as revealed in the literature organization should also be able to manage uncertainty [
15].
A study was conducted in Saudi Arabia [
16] which identified causes of time and cost overrun. The authors identified thirty-eight causes through a literature review and grouped them into the following categories: consultant/designer-related causes, all parties-related causes, contractor-related causes, contract-related causes, external-related causes, resource-related causes, and owner-related causes. Then, forty-eight professionals were asked to assess the importance of the causes on which bases they were highly ranked. The most significant causes for time overrun were: poor project planning and scheduling, insufficient comprehension of work scope during the bidding stage, and changing of scope and design by the owner in the construction phase, and finally, design errors.
Sweis, Moarefi, Amiri, Moarefi, and Saleh [
17] performed a root cause analysis to identify, rank, analyze, and categorize the delay causes of Iranian oil and gas construction projects. The top five causes are: political situation, cash flow financial difficulties faced by all parties, planning and scheduling insufficiencies, the competence and experience of all parties, technical staff availability, material procurement, payment delay by the owner to the contractor, and finally, the long acceptance process (an example is a delay in getting permits), and a Pareto analysis showed that these causes represent 84.7% of all delays.
Basak, Perrons, and Coffey [
18] performed a systematic literature review and identified causes of schedule overruns in liquefied natural gas projects and ranked them according to their frequency. The top five risks are: contract modification; usual variation/change orders issued by the owner; delay of material delivery and procurement; change in design due to complexities, omission, or errors; poor quality of material; long lead times on imported items; slow inspection and decision-making process; and delay in progress payment to the contractor.
Aljamee, Naeem, and Bell [
19] researched the major causes of project delays in Iraqi petroleum projects. The research was conducted by distributing questionnaires to the Basra Oil Company. The questionnaire revealed project delay as the vital problem in Iraqi petroleum construction projects. The respondents were asked about the root causes of the project delay. There were twenty causes which were ranked according to their significance. The most significant root causes were accepting the lowest bidder as a contractor, the contractor’s financial condition, use of traditional paperwork, unofficial and official holidays, and poor planning of the project.
Zarei, Sharifi, and Chaghouee [
20] used semantic network analysis (SNA) to identify and rank the causes of delay in oil, gas, and petrochemical projects. This study not only identified and ranked delay causes but also analyzed their interrelationships. The causes of delays were grouped into contracting processes, initial negotiations, and control and planning process. The most significant causes of delay across the groups were wrong estimation or inaccuracy of costs in initial negotiation, and the time delay in the process of confirming suggestions or reviewing by engineering procurement (EP) in the planning and control process.
Pham and Hadikusumo [
21] conducted a research investigating the delay causes in engineering, procurement, and construction (EPC) petrochemical projects in Vietnam. The research was performed by interviewing management-level officers from three EPC projects. A cross-case analysis was utilized to identify the most frequent and unique delay causes. The research revealed that the construction phase was responsible for most of the delay caused, followed by the engineering phase. In the construction phase, the top causes for delay were poor coordination and communication by the contractor, inadequate control procedure, and poor planning and scheduling. In the engineering phase, the top causes for delays were shop drawing delay and sample material approval delay by the owner, change in specification and project scope by the owner, and lack of input data by the contractor. The authors also mentioned that land acquisition is also a significant delay cause.
Alhajri and Alshibani [
22] conducted another study in Saudi Arabia which identified significant factors for construction delays in Saudi Arabia. The authors initially identified delay factors through a literature review and interviewing local experts. Then, working professionals were asked to assess the severity of the identified factors, and the responses were then ranked using the Frequency Adjusted Importance Index (FAII). The top five delay causes were “Delay in equipment and material delivery”, “Delay in getting work permit”, “Poor site management and supervision by the contractor”, “Poor project planning and scheduling by the contractor”, and “Delay in decision making and approvals by the owner”.
Abdellatif and Alshibani [
23] studied the causes of delays in industrial and manufacturing projects in Saudi Arabia. The methodology followed a similar pattern as [
24] to identify and assess initial delay causes. The causes were analyzed in two categories—namely, the impact they cause, and their frequency of occurrence. The top impactful causes were “financing issues by contractor and manufacturer”, “late material procurement and delivery”, “delay in progress payment”, and “delay in design approval”. The top frequent causes were “delay in progress payment”, “financing issues by the contractor and manufacturers”, “delay in decision making”, “delay in material procurement”, and “delay in design approval”.
Basak, Coffey, and Perrons [
25] investigated technical risks (TRs) and non-technical risks (NTRs) which cause schedule overruns in upstream natural gas projects, and investigated interactions between TRs and NTRs. Most of the factors discussed previously fall under TRs, where NTRs relate to socio-economic aspects. Firstly, the authors conducted a literature review and interviewed experts to arrive at 52 TRs and 18 NTRs. After these questionnaires were distributed to assess the TRs and NTRs, analysis was then performed on the data received using structural equation modelling. In terms of frequency, TRs were ranked much higher than NTRs, and the top-ranked delay causes were “Changes in the scope of the work by the client”, “Unclear cost estimation and unrealistic scheduling”, “Poor organizational structure of client and involvement of multi-level decision-making bodies”, and “Increasing in the complexity of projects”, respectively. All of these are TRs. However, in terms of rank, TRs were far higher than NTRs, with the highest NTRs being “Volatile oil prices” at 12th. However, NTRs were more impactful as they can cause, by themselves, a delay or trigger and amplify the TRs.
Most of previous studies were discussing the causes of delays in the construction of oil and gas projects in different countries. This paper puts the spotlight on construction project delays in one of the largest oil and gas production countries (the Kingdom of Saudi Arabia) and identifies the challenges that are not found in other countries. It also investigates the root causes of delay in the construction of oil and gas pipelines, evaluates delay causes, ranks them accordingly, and proposes practical solutions to overcome them.
5. Second-Level Causes of Delay

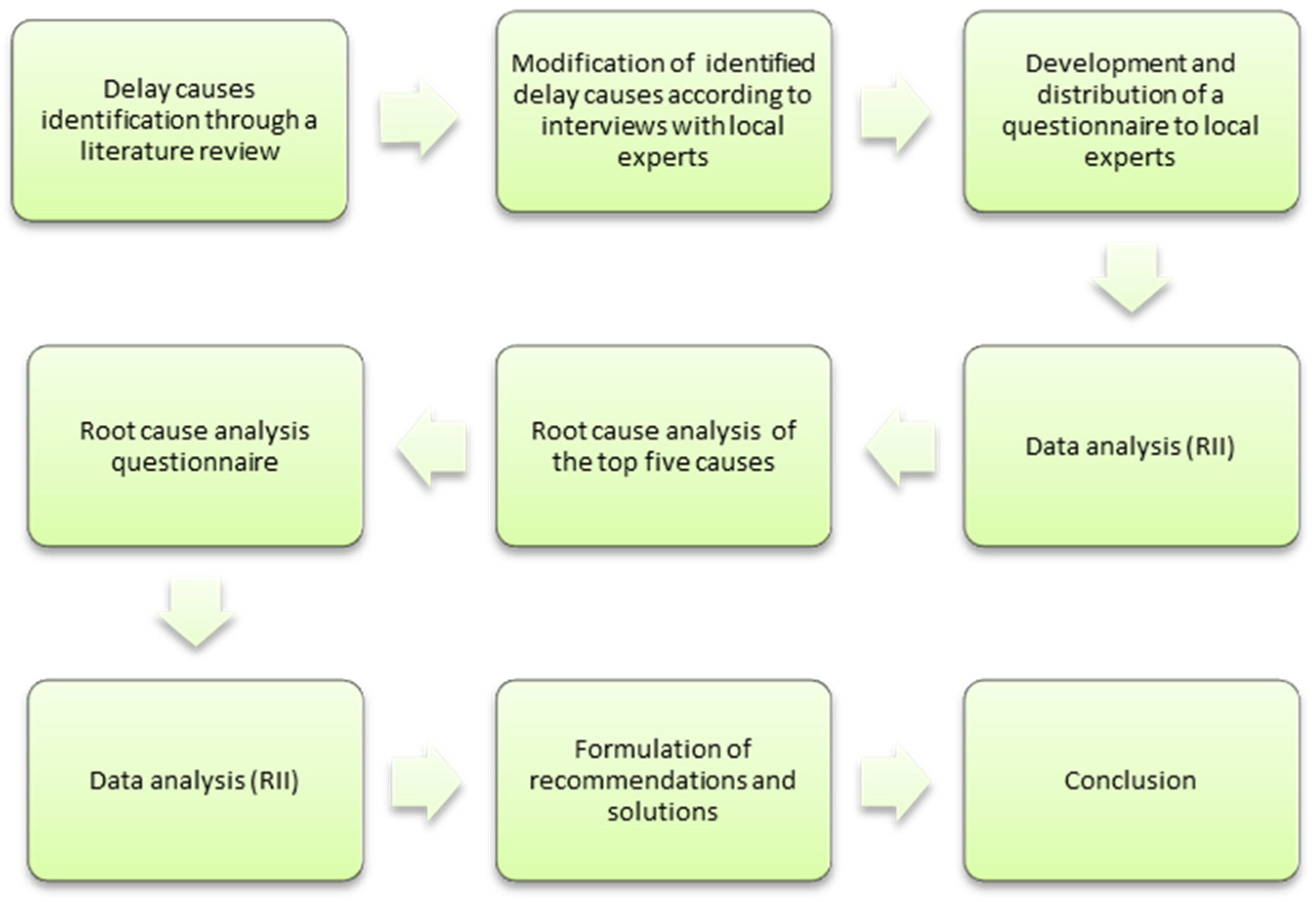

In this section, the top five causes of construction delays are identified and analyzed using the root cause analysis technique, in order to assist in formulating solutions to the problems ranked above. These are:
Client-related material;
Delays in materials and equipment delivery;
Permit approval, both local and governmental;
Delays in subcontractor work;
Delays in the preparation and approval of drawings by engineering consultants.
Root cause analysis in project management is a systematic process for determining the main causes behind problems, in order to formulate ways of reacting that encourage the prevention of reoccurrence. To perform the analysis for this study, we collected data on the sub-causes of the top five causes identified above, asking why each factor would delay a project. Data were collected from a literature review and expert interviews. The next step was the prioritization of the causes, accomplished by a questionnaire and ranking the causes using the RII technique. Below are suggestions regarding solutions to the core problem.
5.1. Sub-Factors of Delay
5.1.1. Client-Related Material
All piping material (i.e., pipes, fittings, and valves) and other related electrical and instrumentation materials required for oil and gas pipeline projects in Saudi Arabia are supplied by the client. A total of seven causes were identified, three (i.e., quality of the materials supplied, quality of the packaging and handling, and changes in the material’s price) were obtained from the literature review and another four were gathered from interviewing local experts. These causes are listed below and briefly explained.
Quality of Materials Supplied
The goods and materials supplied should comply with the international and special company standards and specifications. Defects lead to the rejection of the materials received during the construction phase of the project.
Logistics
Logistics are the procedures for planning and performing the efficient transportation and storage of goods from the materials factory to client-owned stores.
Quality of Design Requirements
This is the degree of accuracy of the designer in describing the materials specifications required for the project so the buyer can issue appropriate purchase orders.
Changes in Materials Specifications
Piping materials are considered long-lead items. Accordingly, these items are forecasted in proper inventory planning. Changes in materials’ requirements and specifications make inventory control challenging.
Preservation of Materials in Client Stores
It is necessary to implement a proper preservation program against weather erosion and corrosion causes such as rain and sandstorms.
Quality of Packaging and Handling
Materials supplied should be properly packed, well preserved, and handled carefully during transportation to prevent damage.
Changes in Materials Prices
Changes in the prices of materials impact purchasing. This also includes approval through bureaucratic processes, which impacts the time needed to approve any changes.
5.1.2. Delays in Materials and Equipment Delivery
One of the top five causes of delay as identified in the first survey was whether the construction contractor released, collected, and delivered materials on time to the construction site. Four sub-causes were identified from the literature review and expert interviews. The causes obtained from the experts included the availability of the contractor’s resources (e.g., trucks, cranes, manpower), and oversized materials and equipment transportation. The others were obtained from the literature.
Availability of Contractor Resources
Transportation and lifting resources should always be available and reliable for service. Trained and skilled operators should be available and manage to perform the job at the required time, without delay.
Delivery Accuracy
The required quantity of the correct material should be delivered accurately and without shortage. In addition, the appropriate material should be collected and delivered to the project, without error.
Inspection Document Accuracy and Delivery
Documentations for quality control and assurance should be handled correctly and distributed to the construction team without delay or mistakes.
Transportation of Oversized Materials and Equipment
In some piping construction projects, transportation of oversized cranes, pipes, valves, and other equipment require special trailers and transportation plans.
5.1.3. Permit Approval: Local and Governmental
Another delay factor in our ranking after materials-related problems was work permit issuance. Work permits for construction sites function as a control method to protect the project’s overall level of safety. In this section, I identify the causes of delays to work permit approval. Inspection time during issuance and interpersonal conflict were both identified from the literature review, while other causes were determined from the expert interviews.
Inspection Time for Permit Issuance
This is the total time needed to perform the required inspection of safety items and personnel qualifications to issue the daily work permit.
Interpersonal Conflicts
Interpersonal conflicts occur if one or more employees frustrate or interfere with the goals of other employees. In a business framework, this includes interference with the completion of work tasks and goals.
Number of Agencies Required for Permit Approval
The number of different agencies involved in acquiring work permits varies from region to region. A pipeline project could intersect with electric power lines, water supply pipelines, communication lines, and roads. As the number of agencies increases, work permit approval grows more challenging.
Issuer Responsibility and Accountability
The organizational structure of the client’s company is usually divisional. The work permit issuer has no obligation to the project with regard to on-time completion or level of performance. This type of structure can cause delays by not guaranteeing the support required by the project team.
Issuer and Receiver Knowledge of Permit Requirements
The degrees of knowledge of the issuer and receiver of the work permit requirements determine the timely fulfillment of requirements. After issuance, delays may occur if the work is stopped by a safety team because of failure to meet safety requirements.
Unexpected Weather Conditions
In Saudi Arabia, sandstorms, heat, rain, and other harsh weather conditions onsite can impact daily work permit issuance and delay project completion if not properly considered during the planning phase.
5.1.4. Delays in Subcontractor Work
Oil and gas pipeline construction projects include different technologies that require contributions from individuals with different specialties. Accordingly, subcontracting has emerged as a means of performing these project activities. However, subcontracting and control of subcontractors may cause construction delays. In this section, I describe four causes of delay related to subcontractor work, as obtained from the literature review.
Disputes between Contractors and Subcontractors
Disputes may be the result of ambiguous contract language, late payment, or quality of work.
Market Availability of Subcontractors
The scarcity of subcontractors able to perform certain tasks and use unique technology makes projects dependent on subcontractor availability.
High Degree of Subcontracting on a Project
According to Albino and Garavelli, “subcontractors can contribute more than 50% and can be as much as 90% of total project value to a construction process” [
24]. Project delivery is highly dependent on subcontractors’ work performance.
Subcontractor Coordination and Control
Subcontractor coordination and control involves specifying the communication channels employed among the subcontractors to control a project’s scope, quality, and schedule.
5.1.5. Delays in Preparation and Approval of Drawings by Engineering Consultants
Approved construction engineering drawings are required in every project. In pipeline construction projects, engineering drawings are usually produced by engineering consultant firms and then reviewed and approved by the client and project owner’s engineers. The preparation and approval processes are major causes of delay. Accordingly, I obtained sub-causes of such delays from expert interviews. These causes are listed and explained below.
Approval System for Engineering Packages
After the construction engineering drawings are completed, all documents are reviewed electronically by the client’s engineering team, facility owner, and other parties to ensure compliance with the client’s requirements. Comments from these parties must be addressed before issuing the final engineering package.
Quality and Number of Errors Encountered in the Design
The number of human errors and mistakes in the design package that require corrections and modifications affect delays. Moreover, inaccurate information in design packages such as materials specifications, quantities, and dimensions result in rework at the construction site.
Complexity of the Project
Sets of problems consist of many varied and interrelated parts. One example is designing a pipeline that moves through sensitive environments such as existing cities, highways, and plants.
Insufficient Data during the Design Stage
Unknown or incomplete data and information about the project and other technical details like oil or gas reservoir specifications and parameters may lead to delays.

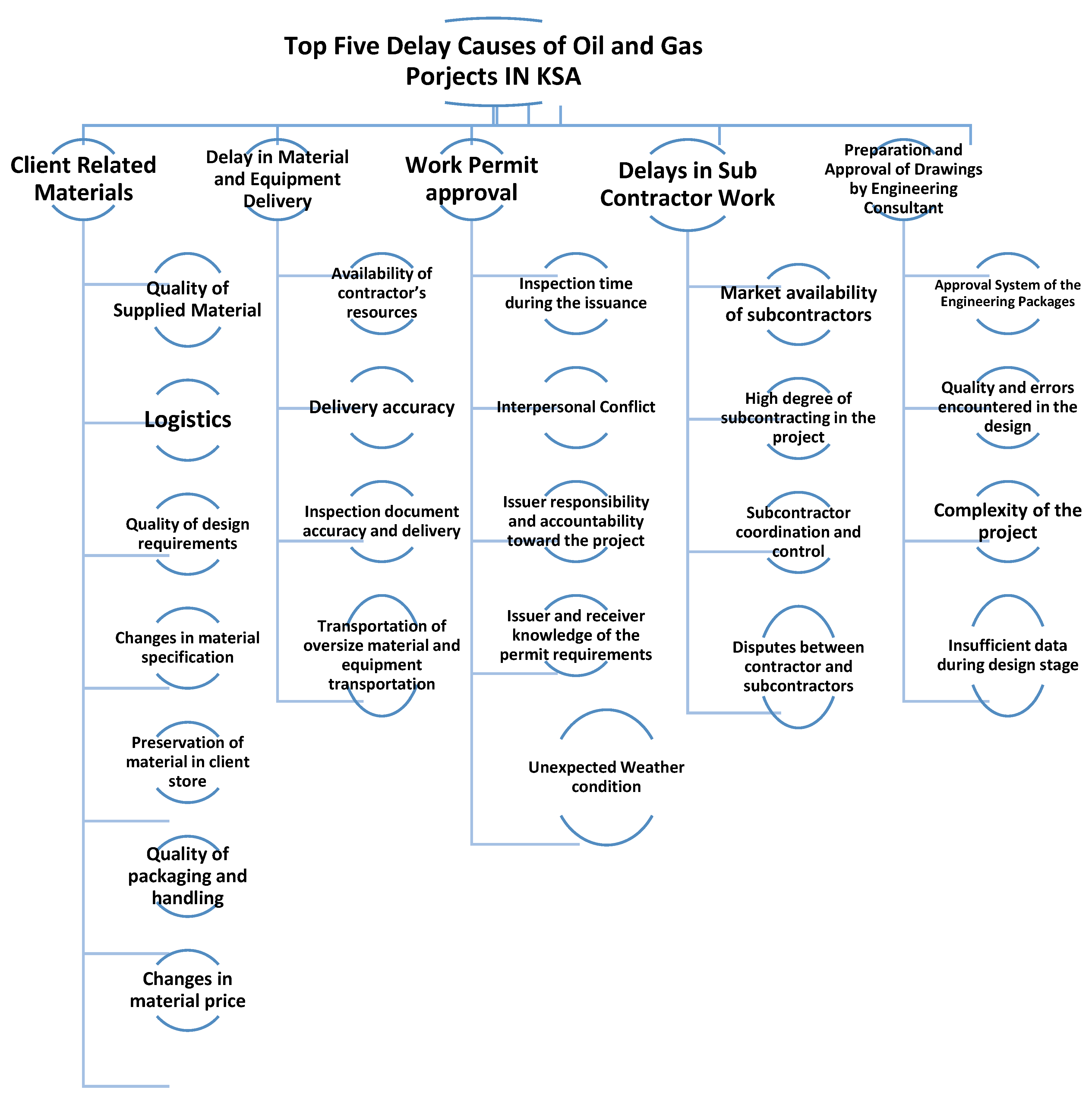

Figure 3 below shows the root of identified causes in this study.
5.2. Root Cause Survey and Data Analysis
5.2.1. Survey Policy
Data ranking the importance of root causes were collected using an online survey questionnaire. As with the first survey conducted, a root cause analysis survey was developed to identify the respondent companies’ field classifications (i.e., client, contractor, engineering consultant, and other). The survey also identified the respondents’ positions within their respective companies (i.e., project manager, project engineer, site engineer, and other). The respondents’ years of experience were also taken into consideration. Respondents were also asked to specify to what extent they agreed or disagreed with each root cause delay factor listed, with selecting ‘1’ indicating strongly disagree and ‘5’ indicating strongly agree. The RII was used to analyze and rank the data gathered, using Equations (1) and (2) for the weighted ranking that took respondents’ levels of experience and positions into consideration.
5.2.2. Respondent Statistics

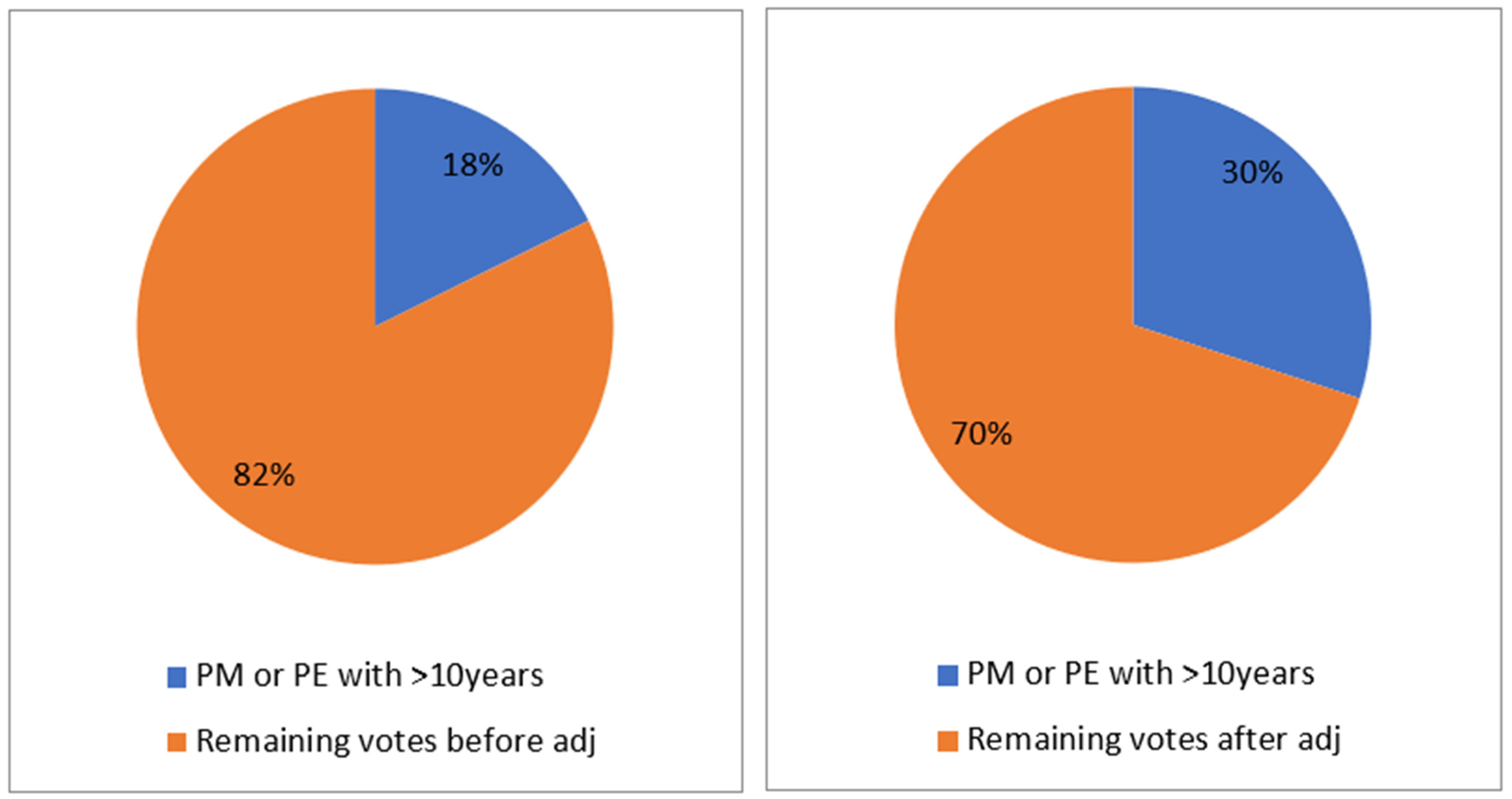

The total number of responses gathered from the questionnaire was 51. There were 19 client responses, 20 from contractors, four from engineering consultants, and eight from other disciplines. Regarding respondents’ positions in their respective companies, there were two project managers, 10 project engineers, 21 site engineers, and 18 with other positions. Respondents’ levels of experience were categorized into four groups: between 0 and 5, 6 and 10, 11 and 15, and more than 15 years, in which there were 26, 7, 6, and 12 respondents, respectively.
5.2.3. Relative Importance Index Results
Using the adjusted formula in Equation (2), the root causes of delays in oil and gas construction projects are ranked (see
Table 9).
Using the same Equation (2), the top 10 causes from clients, contractors, and engineering consultants are ranked (see
Table 10,
Table 11 and
Table 12, respectively).
5.3. Root Causes
After performing the RII to rank the root causes, it was determined that three of the top delay causes were related to delays in materials and equipment delivery. Availability of the contractor’s resources was ranked the highest, with a 70.8% RII. This factor was ranked third and fourth by clients and contractors, respectively. Materials and equipment delivery appeared in the top ten list as well, in addition to documents and delivery accuracy. Thus, it should be given the highest priority in order to improve project performance.
The second factor listed in the weighted RII ranking was manpower and vehicle shortages associated with issuing daily work permits at the construction site, with an RII value of 70.4%. Work permit issuance has become a major challenge that needs to be resolved. An RII of 69.4% indicates the number of agencies finding it difficult to acquire approval for work permits.
In reference to client-related material, the degree of accuracy in the design requirements and changes in materials specifications were ranked third and tenth on the RII ranking list, with values of 69.8% and 65.5 %, respectively. The accuracy of the design was ranked highest from the client’s point of view. Engineering consultants identifying changes in materials specification requirements was ranked highest by clients.
Regarding delays in subcontractor work, it was found that disputes between contractors and subcontractors, as well as subcontractor coordination and control, were among the top ten root causes, with values of 66.5% and 67.2%, respectively.
Finally, consultant approval of the engineering was a main delay because of the level of quality and number of errors encountered in designs. However, from the engineering consultants’ point of view, the main delay factor was changes in materials specifications by the client.
Each factor defined by this analysis could be further investigated using the “five whys” technique developed by Sakichi Toyoda and used by Toyota Motors to enhance quality. Simply put, the process involves asking the question “why” five times, though in practice the question might be asked more or less than five times until logical reasoning allows possible solutions to appear.
7. Conclusions
To conclude, a literature review was conducted to identify the reasons for delays in oil and gas pipeline construction projects. A total of 53 causes were identified from the literature. Then, two local experts were interviewed (one project engineer and one planning and scheduling engineer) in order to refine the causes obtained from the literature review and modify their causes. The experts deleted 15 and added eight causes. A final list of 47 was distributed locally in an electronic questionnaire. Thirty-four responses were received, and these were analyzed to identify the major delay causes.
The analysis was based on the RII of each delay factor. Five ranking scenarios were carried out: normal, weighted, weighted from the client’s point of view, weighted from the contractor’s point of view, and weighted from the consultant’s point of view.
Client-related material, delay in material and equipment delivery, permit approval, delay in subcontractors’ work, and delay in preparing and approval of engineering drawings were found to be the top five major delay factors in oil and gas pipeline construction projects in Saudi Arabia.
It should be noted that this study is limited to investigating the delay causes of the construction projects of oil and gas in Saudi Arabia. It is also limited to the gathered data from literature, experts, and surveys. Future works should investigate the delay causes of construction in different types of projects as well as in different countries. Further studies should shed light on the economic impact of delay causes in the construction of oil and gas projects.
