Determinants of the Effectiveness of Risk Management in the Project Portfolio in the FinTech Industry
Abstract
:1. Introduction
- Defining the dimensions and determinants of the effectiveness of risk management in the project portfolio;
- Development of a universal model for assessing the effectiveness of risk management in a project portfolio;
- Providing knowledge on the impacts of individual dimensions of organizational management and risk management on the effectiveness of the risk mitigation tools adopted, with a particular emphasis on the FinTech industry;
- Closing the research gap related to the identification of connections between project management, risk management in the project portfolio, and the strategic management of the organization;
- Focusing on the effectiveness of risk management in the project portfolio and not on management instruments or the identification of risks related to projects and portfolios;
- Embedding research in the FinTech industry, which is rich in projects and project portfolios (Győri et al. 2021);
- Obtaining results on the effectiveness of risk management in the project portfolios of international FinTech organizations;
- Pproviding a replicable tool for comparative analyses of risk management in the project portfolio.
2. Background

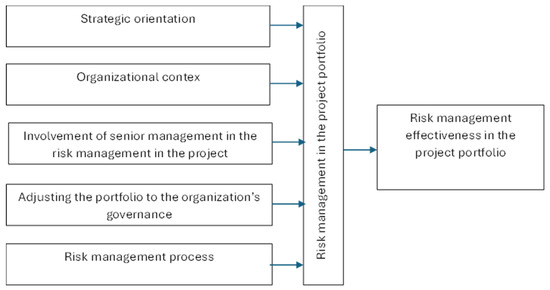

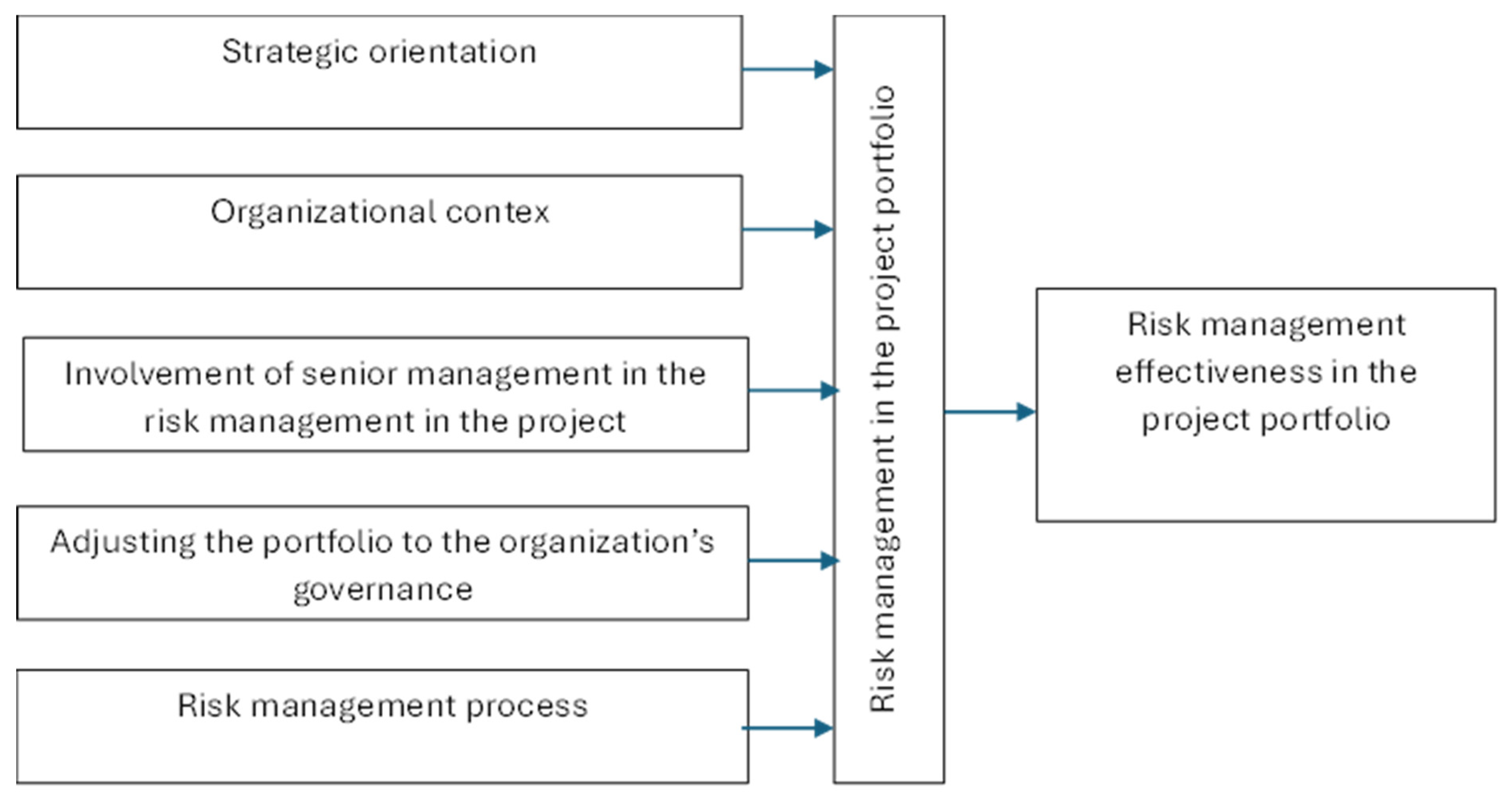

2.1. Strategic Orientation
2.2. Organizational Context
2.3. Senior Management Involvement
2.4. Adjusting the Portfolio to the Organization’s Governance
- Organizational structure for project portfolio management (Kodukula 2014);
- Defining the standards and process of project portfolio management;
- Defined roles and responsibilities in the project portfolio management process;
- Specific escalation paths (AXELOS 2011);
- A Portfolio Office within an organization, which monitors the performance of the project portfolio (Kendall and Rollins 2003).
2.5. Portfolio Risk Management Process
3. Methods and Materials
3.1. Structuring the Research Model
- Projects withheld at the initiation stage, due to the identified level of risk.
- Projects withheld at the implementation stage, due to the identified level of risk (Teller 2013).
- Identified dependencies between projects as a result of risk management at the portfolio level (De Bakker et al. 2010).
- Similar identified risks in different projects (Jonas et al. 2012).
- Decisions regarding projects in the portfolio are made based on a comprehensive picture of the risks in the portfolio (Sanchez et al. 2008).
- A portfolio balance, understood as the appropriate selection of projects in the portfolio, so that they constitute a set of initiatives with different levels of risk.
- Mitigation actions taken regarding risks identified at the portfolio level (Teller 2013).
3.2. Survey Research Process
3.3. Modeling with PLS-SEM
- A rectangle denoting observable variables;
- An ellipse, which is the marking of a latent variable;
- Arrow defining cause-and-effect relationships between dependent and independent variables. The arrow connects observable variables with latent variables and creates connections between unobservable variables. As a result of modeling, the arrows receive a specific value, understood as the strength of the relationship between the variables.
- Standardized root mean square residual (SRMR) providing a measure of model fit. A value less than 0.10 is considered a good fit (Kock 2020). The SRMR can be considered a measure of the goodness of fit for PLS-SEM, which can be used to avoid model misspecification (Henseler et al. 201);
- R2 determination coefficient, which allows for assessing the explanatory power of the model (Sagan 2015);
- For reliability analysis:
- Cronbach’s alpha coefficient, for which a level of 0.6 can be considered sufficient, >0.8 very good, and >0.9 excellent (Nunally and Bernstein 1994);
- Composite reliability (CR)—which should exceed the level of 0.7 (Hair et al. 2019);
- For convergent validity, the average variance extracted (AVE)—which should exceed the level of 0.5 (Purwanto and Sudargini 2021);
- For discriminant validity:
- Cross-loading values for individual indicators, which should have higher values in relation to the corresponding constructs in the model than all others (Ab Hamid et al. 2017);
- Fornell–Larcker criterion, according to which the square root values of AVE should be higher than the highest correlation with another construct (Kacprzak 2018);
- Heterotrait–Monotrait ratio (HTMT) criterion (Henseler et al. 2014, the value of which should not exceed 0.9. If the HTMT value is higher than this threshold, it can be concluded that there is no discriminant validity (Teo et al. 2008).
4. Results

4.1. Assessment of Model Quality and Fit

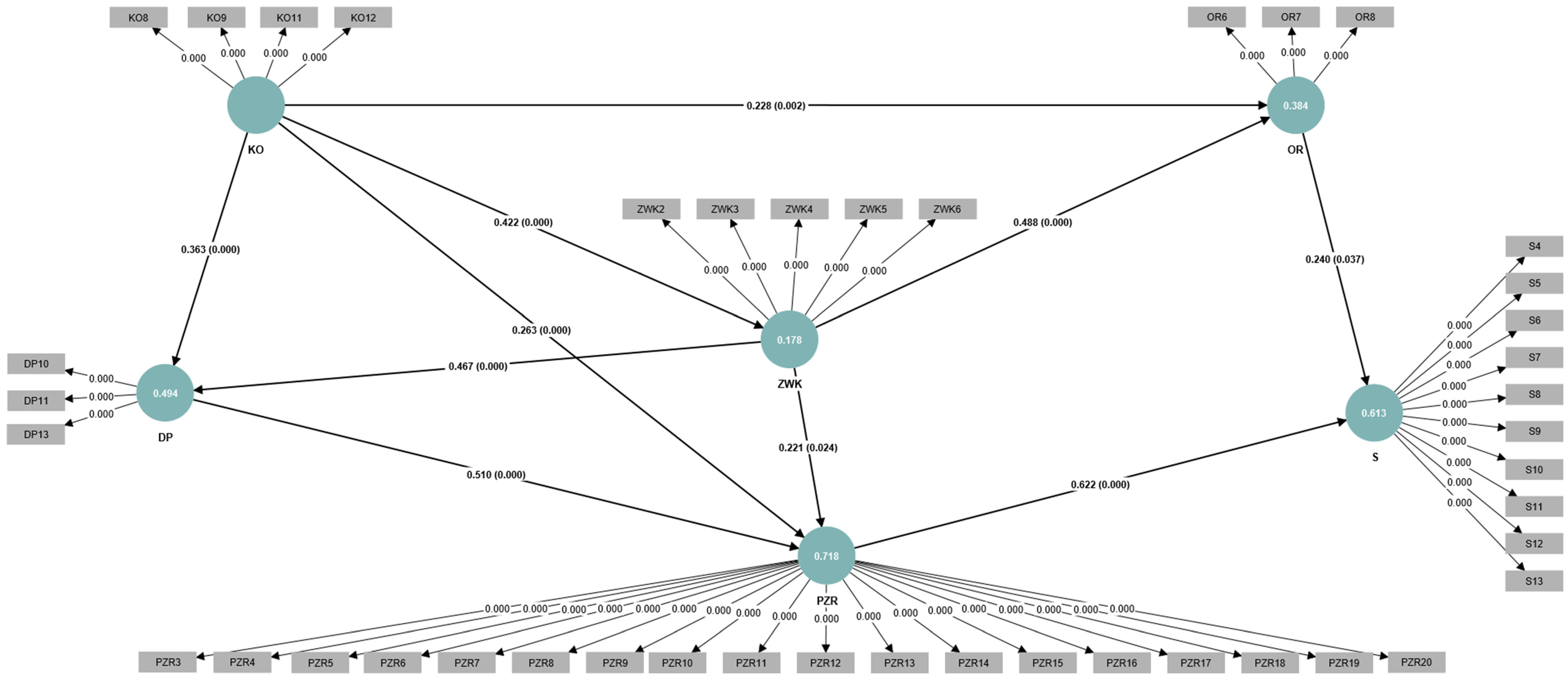

4.2. Structural Modeling Results
- Strategic orientation—3;
- Organizational context—4;
- Involvement of senior management in the risk management in the project portfolio—5;
- Adjusting the portfolio to the organization’s governance—3;
- Risk management process in the project portfolio—18;
- Risk management efficiency in the project portfolio—10.
- Selection of projects for the organization’s portfolio based on specific criteria supporting the strategy (OR6);
- Ongoing review of projects in the portfolio for alignment with the organizational strategy (OR7);
- Allocating resources in the organization to projects in the portfolio following the organization’s strategy (OR8).
- A definition of risk at the project portfolio level (PZR3);
- Clearly defined risk management steps in the project portfolio (PZR4);
- Defined roles in the project portfolio risk management process (PZR5);
- Defined responsibilities for roles in the project portfolio risk management process (PZR6);
- Defined risk management process for projects in the portfolio (PZR7);
- Defined ownership for risks identified in the portfolio (PZR8);
- Defined control process for risks identified in the portfolio (PZR9);
- Defined tolerable risk level, i.e., the level of risk the organization is willing to accept (PZR10);
- Defined level of tolerable risk, i.e., the maximum level of risk that the organization can bear in combination with factors such as reputation, capital, assets, or ability to raise additional funds (PZR11);
- Defined risk tolerance levels, i.e., risk exposure levels that can only be exceeded with the required approval (PZR12);
- Consideration of risk assessment when prioritizing projects in the portfolio (PZR13);
- Regular review of risks in the projects in the portfolio (PZR14);
- Defined dependency management process in the project portfolio management process (PZR15);
- Prepared portfolio reports for senior management (PZR16);
- Information on the level of risks in the projects included in the portfolio as part of the portfolio reports prepared for senior management (PZR17);
- Information on the level of risks across the portfolio as part of portfolio reports prepared for senior management (PZR18);
- Visualization of risks in the portfolio as an element of portfolio reports prepared for senior management, e.g., in the form of a risk matrix (PZR19);
- Linking project portfolio risk management to other risk management processes in the organization (PZR20).
- Clearly defined steps;
- Specific roles and responsibilities, including ownership of risks identified in the portfolio;
- Taking the risk into account in the process of prioritizing projects in the portfolio;
- A defined dependency management process;
- Regular portfolio risk reviews;
- How portfolio risk is communicated to senior management.
- Gathering information about risk in the organization (KO8);
- Gathering information in the organization on how the risk management process, i.e., identifying, assessing, and controlling risks, is carried out (KO9);
- Conducting market research of the organization’s environment that may affect the level of risk in the portfolio (KO11);
- Conducting benchmarking of the portfolio’s risk management processes against other organizations (KO12).
- Involvement of senior management in the reprioritization of the project portfolio (ZWK2);
- Involvement of senior management in the process of allocating resources to projects (ZWK3);
- Involvement of senior management in monitoring the progress of the project portfolio (ZWK4);
- Involvement of senior management in the portfolio risk management process (ZWK5);
- Senior management decision-making on the project portfolio based on risk analysis and assessment (ZWK6).
- Risk management as a component of portfolio project management (DP10);
- Risk management as a component of project portfolio management (DP11);
- Experience of portfolio managers in the process of portfolio risk management (DP13).
5. Discussion
- Identify and assess the coherence of implemented projects with the organization’s strategy, and therefore ensure that financial innovations are closely related to the direction of development of a given organization;
- Assess the effectiveness of the adopted risk management methods and select those assessed as the most effective;
- Strictly define risk ownership in order to identify responsibility for risk;
- Conduct periodic inspections of risk management and the effects of this process;
- Engage senior management in the risk management process, as this determines both the strategic orientation and the risk management process itself in the project portfolio.
6. Conclusions
- Extending and conducting research on a larger sample size, which raises the possibility of verifying the model using modeling based on the variance–covariance matrix (CB-SEM);
- Model verification in industries other than FinTech;
- Comparative research between two groups of organizations from different industries;
- Conducting research in FinTech start-ups that may not implement formalized risk management processes;
- Selection of other variables or modification of the proposed variables, e.g., by extending the described model;
- Application of the developed model in a FinTech enterprise;
- Verification of the methods of implementing the risk management process in project portfolios in industries other than FinTech;
- In-depth research on how to measure and understand the effectiveness of risk management in a project portfolio.
