Empirical Analysis of a Management Function’s Failures in Construction Project Delay
Abstract
1. Introduction
2. Conceptual Framework
2.1. Theoretical Background
2.2. Identifying the Factors

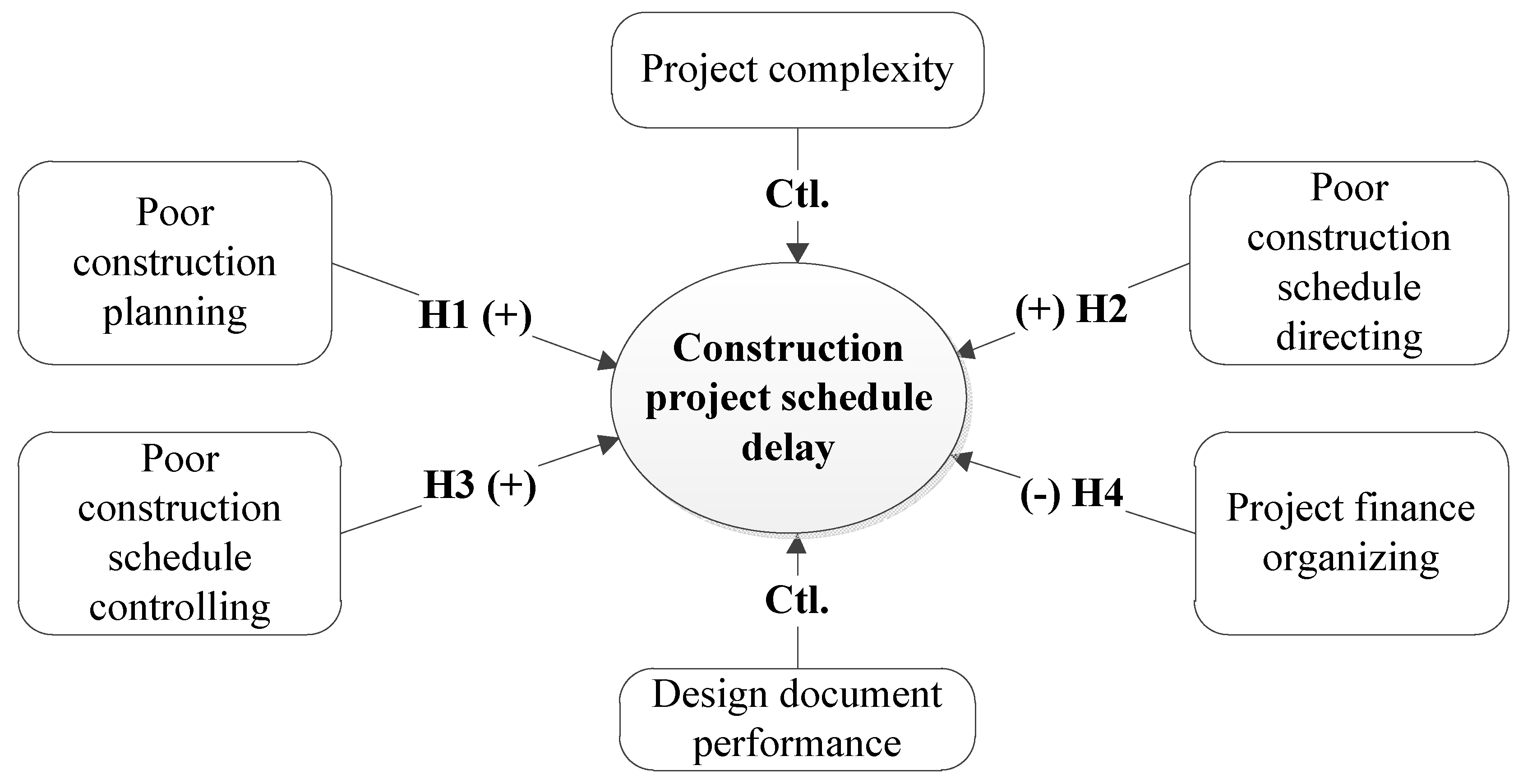

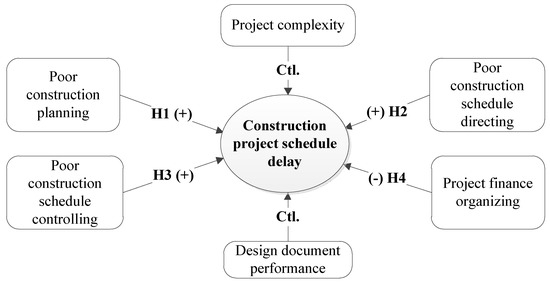

2.3. Research Hypotheses
3. Research Methods
3.1. Sampling and Data Collection
3.2. Variable Specifications
3.3. Research Model: Proposal and Measures
4. Results and Discussions
4.1. Analysis of Variance
4.2. Evaluation of the Research Model: Hypotheses Testing
5. Conclusions and Limitations
Funding
Acknowledgments
Conflicts of Interest
Appendix A. List of Measurement Items for Each Construct
References
- Ibrahim, A.; Roy, M.; Ahmed, Z.; Imtiaz, G. An investigation of the status of the Malaysian construction industry. Benchmarking An. Int. J. 2010, 17, 294–308. [Google Scholar] [CrossRef]
- Kashiwagi, D.; Kashiwagi, J.; Kashiwagi, I.; Kashiwagi, A. The source of degradation of the construction industry performance. J. Adv. Perform. Inf. Value 2012, 4, 206–222. [Google Scholar]
- Nguyen, L.H.; Watanabe, T. The status quo and perspective for improvement of public works procurement performance in Vietnam. J. Adv. Perform. Inf. Value 2014, 6, 22–39. [Google Scholar]
- Xiong, B.; Skitmore, M.; Xia, B.; Masrom, M.A.; Ye, K.; Bridge, A. Examining the influence of participant performance factors on contractor satisfaction: A structural equation model. Int. J. Proj. Manag. 2014, 32, 482–491. [Google Scholar] [CrossRef]
- O’Brien, J.J. Construction Delay: Responsibilities, Risks, and Litigation; Cahners Books International: Boston, MA, USA, 1976. [Google Scholar]
- Zack, J.G. Schedule delay analysis; is there agreement. In Proceedings of the PMI-CPM College of Performance Spring Conference, Clemson, SC, USA, 7–9 May 2003. [Google Scholar]
- Mbala, M.; Aigbavboa, C.; Aliu, J. Causes of delay in various construction projects: A literature review. In International Conference on Applied Human Factors and Ergonomics; Springer: Cham, Switzerland, 2018; pp. 489–495. [Google Scholar]
- Kumaraswamy, M.M.; Chan, D.W. Contributors to construction delays. Constr. Manag. Econ. 1998, 16, 17–29. [Google Scholar] [CrossRef]
- Toor, S.U.R.; Ogunlana, S.O. Problems causing delays in major construction projects in Thailand. Constr. Manag. Econ. 2008, 26, 395–408. [Google Scholar] [CrossRef]
- Niazai, G.A.; Gidado, K. Causes of project delay in the construction industry in Afghanistan. In Proceedings of the EPPM 2012 International Conference on Engineering, Project and Production Management, Krakow, Poland, 20–22 September 2020. [Google Scholar]
- Marzouk, M.M.; El-Rasas, T.I. Analyzing delay causes in Egyptian construction projects. J. Adv. Res. 2014, 5, 49–55. [Google Scholar] [CrossRef]
- Gebrehiwet, T.; Luo, H. Analysis of Delay Impact on Construction Project Based on RII and Correlation Coefficient: Empirical Study. Procedia Eng. 2017, 196, 366–374. [Google Scholar] [CrossRef]
- Kazaz, A.; Ulubeyli, S.; Tuncbilekli, N.A. Causes of delays in construction projects in Turkey. J. Civ. Eng. Manag. 2012, 18, 426–435. [Google Scholar] [CrossRef]
- Islam, M.S.; Trigunarsyah, B.; Hassanain, M.; Assaf, S. Causes of delay in construction projects in Bangladesh. In Proceedings of the 6th International Conference on Construction Engineering and Project Management, Busan, Korea, 11–14 October 2015; pp. 82–86. [Google Scholar]
- Kumar, D. Causes and Effects of Delays in Indian Construction Projects. Int. Res. J. Eng. Technol. 2016, 3, 1831–1837. [Google Scholar]
- Kaming, P.F.; Olomolaiye, P.O.; Holt, G.D.; Harris, F.C. Factors influencing construction time and cost overruns on high-rise projects in Indonesia. Constr. Manag. Econ. 1997, 15, 83–94. [Google Scholar] [CrossRef]
- Aibinu, A.A.; Odeyinka, H.A. Construction delays and their causative factors in Nigeria. J. Constr. Eng. Manag. 2006, 132, 667–677. [Google Scholar] [CrossRef]
- Suhas, G.A.; Jamgade, M.; Patil, U. Identifying the Cause of Delay in Construction Industry in Mumbai Region. Int. J. Mod. Trends Eng. Res. 2016, 2, 539–543. [Google Scholar]
- Alzara, M.; Kashiwagi, J.; Kashiwagi, D.; Al-Tassan, A. Using PIPS to minimize causes of delay in Saudi Arabian construction projects: University case study. Procedia Eng. 2016, 145, 932–939. [Google Scholar] [CrossRef]
- Koushki, P.; Al-Rashid, K.; Kartam, N. Delays and cost increases in the construction of private residential projects in Kuwait. Constr. Manag. Econ. 2005, 23, 285–294. [Google Scholar] [CrossRef]
- AlGheth, A.; Sayuti, M.I. Review of Delay Causes in Construction Projects. In Proceedings of the AWAM International Conference on Civil Engineering, Penang, Malaysia, 21–22 August 2019; pp. 429–437. [Google Scholar]
- Mittal, Y.K.; Paul, V.K.; Rostami, A.; Riley, M.; Sawhney, A. Delay factors in construction of healthcare infrastructure projects: A comparison amongst developing countries. Asian J. Civ. Eng. 2020, 21, 1–13. [Google Scholar] [CrossRef]
- Elawi, G.S.A.; Algahtany, M.; Kashiwagi, D. Owners’ perspective of factors contributing to project delay: Case studies of road and bridge projects in Saudi Arabia. Procedia Eng. 2016, 145, 1402–1409. [Google Scholar] [CrossRef]
- Pierce, D.R., Jr. Project Scheduling and Management for Construction; John Wiley & Sons: Hoboken, NJ, USA, 2013; Volume 89. [Google Scholar]
- Abdou, S.M.; Yong, K.; Othman, M. Project Complexity Influence on Project management performance–The Malaysian perspective. MATEC Web Conf. 2016. [Google Scholar] [CrossRef]
- Amoatey, C.T.; Ameyaw, Y.A.; Adaku, E.; Famiyeh, S. Analysing delay causes and effects in Ghanaian state housing construction projects. Int. J. Manag. Proj. Bus. 2015, 8, 198–214. [Google Scholar] [CrossRef]
- Walker, A. Project Management in Construction; John Wiley & Sons: Hoboken, NJ, USA, 2015. [Google Scholar]
- Wang, Y.-R.; Gibson, G.E. A study of preproject planning and project success using ANNs and regression models. Autom. Constr. 2010, 19, 341–346. [Google Scholar] [CrossRef]
- Dvir, D.; Lechler, T. Plans are nothing, changing plans is everything: The impact of changes on project success. Res. Policy 2004, 33, 1–15. [Google Scholar] [CrossRef]
- Serrador, P. “The Importance of the Planning Phase to Project Success.” Project Management Institute. 2012. Available online: https://www.pmi.org/learning/library/importance-planning-phase-project-success-6021 (accessed on 21 December 2019).
- Gibson, G.E., Jr.; Wang, Y.-R.; Cho, C.-S.; Pappas, M.P. What is preproject planning, anyway? J. Manag. Eng. 2006, 22, 35–42. [Google Scholar] [CrossRef]
- Morris, P. Key Issues in Project Management; Jossey-Bass: San Francisco, CA, USA, 1999. [Google Scholar]
- Blomquist, T.; Hällgren, M.; Nilsson, A.; Söderholm, A. Project-as-practice: In search of project management research that matters. Proj. Manag. J. 2010, 41, 5–16. [Google Scholar] [CrossRef]
- Shtub, A.; Bard, J.F.; Globerson, S. Project Management: Processes, Methodologies, and Economics; Pearson Prentice Hall: Upper Saddle River, NJ, USA, 2005. [Google Scholar]
- Liamputtong, P. Focus Group Methodology: Principles and Practice; SAGE Publications Ltd: Thousand Oaks, CA, USA, 2011. [Google Scholar] [CrossRef]
- Nguyen, L.H. Relationships between Critical Factors Related to Team Behaviors and Client Satisfaction in Construction Project Organizations. J. Constr. Eng. Manag. 2019, 145, 04019002. [Google Scholar] [CrossRef]
- Müller, R.; Turner, R. Leadership competency profiles of successful project managers. Int. J. Proj. Manag. 2010, 28, 437–448. [Google Scholar] [CrossRef]
- Patanakul, P. Project manager assignment and its impact on multiple project management effectiveness: An empirical study of an IT organization. Eng. Manag. J. 2011, 23, 14–23. [Google Scholar] [CrossRef]
- Pinto, J.K.; Slevin, D.P. Project success: Definitions and Measurement Techniques. Available online: https://www.pmi.org/learning/library/project-success-definitions-measurement-techniques-5460 (accessed on 21 December 2019).
- Carvalho, M.M.; Rabechini, R., Jr. Can project sustainability management impact project success? An empirical study applying a contingent approach. Int. J. Proj. Manag. 2017, 35, 1120–1132. [Google Scholar] [CrossRef]
- Yaseen, Z.M.; Ali, Z.H.; Salih, S.Q.; Al-Ansari, N. Prediction of risk delay in construction projects using a hybrid artificial intelligence model. Sustainability 2020, 12, 1514. [Google Scholar] [CrossRef]
- Falk, R.F.; Miller, N.B. A Primer for Soft Modeling; University of Akron Press: Akron, OH, USA, 1992. [Google Scholar]
- Cox, D.R.; Snell, E.J. Analysis of Binary Data; CRC press: Boca Raton, FL, USA, 1989; Volume 32. [Google Scholar]
- Stock, J.H.; Watson, M.W. Introduction to Econometrics, 3rd ed.; Pearson: London, UK, 2015. [Google Scholar]
- Tabachnick, B.G.; Fidell, L.S.; Ullman, J.B. Using Multivariate Statistics; Pearson: Boston, MA, USA, 2007; Volume 5. [Google Scholar]
- Field, A. Discovering Statistics Using IBM SPSS Statistics; Sage: Thousand Oaks, CA, USA, 2013. [Google Scholar]
- Liu, A.M.M. Culture in the Hong Kong real-estate profession: A trait approach. Habitat Int. 1999, 23, 413–425. [Google Scholar] [CrossRef]
- Ankrah, N.A.; Langford, D.A. Architects and contractors: A comparative study of organizational cultures. Constr. Manag. Econ. 2005, 23, 595–607. [Google Scholar] [CrossRef]
- Thomas, M.; Jacques, P.H.; Adams, J.R.; Kihneman-Wooten, J. Developing an effective project: Planning and team building combined. Proj. Manag. J. 2008, 39, 105–113. [Google Scholar] [CrossRef]
- Serrador, P. Project Planning and Project Success: The 25% Solution; CRC Press: Boca Raton, FL, USA, 2014. [Google Scholar]
- Pinto, J.K.; Prescott, J.E. Planning and tactical factors in the project implementation process. J. Manag. Stud. 1990, 27, 305–327. [Google Scholar] [CrossRef]
- Zwikael, O.; Globerson, S. From critical success factors to critical success processes. Int. J. Prod. Res. 2006, 44, 3433–3449. [Google Scholar] [CrossRef]
- Dvir, D.; Raz, T.; Shenhar, A.J. An empirical analysis of the relationship between project planning and project success. Int. J. Proj. Manag. 2003, 21, 89–95. [Google Scholar] [CrossRef]
- Avison, D.; Baskerville, R.; Myers, M. Controlling action research projects. Inf. Technol. People 2001, 14, 28–45. [Google Scholar] [CrossRef]
Construction Management Factors | Descriptions |
---|---|
|
|
Respondents | Statistics | Construction Planning | Construction Schedule Directing | Construction Schedule Controlling | Project Finance Organizing |
---|---|---|---|---|---|
Client | Mean significant score | 3.82 | 3.24 | 3.46 | 3.47 |
SD | 0.63 | 0.82 | 0.79 | 0.71 | |
Contractor | Mean significant score | 3.75 | 3.33 | 3.51 | 3.31 |
SD | 0.69 | 0.81 | 0.76 | 0.74 | |
Non-parametric tests | Chi-squared | 0.8776 | 1.5878 | 0.5966 | 3.1789 |
P-value | 0.7789 | 0.6779 | 0.8816 | 0.2109 |
Model Fit Statistics | Selected Model |
---|---|
Likelihood ratio χ2 | 148.26(significance < 0.0001) |
−2Log likelihood | 88.921 |
Pseudo R2 | 0.733 |
Sample | 195 |
nVar | 6 |
BIC | −824.2192 |
Post prob | 0.126 |
Dependent Variables | Models | Variables | Selected Model | |
---|---|---|---|---|
B | Exp(B) | |||
Project’ schedule delay | Model1 Model2 Model3 | Project complexity | ||
Design document performance | ||||
Intercept | 2.9782 | 19.652 | ||
Poor construction plan | 0.6368 c | 1.890 | ||
Poor construction schedule control | 0.9861 b | 0.373 | ||
Poor construction schedule directing | 4.0998 a | 60.328 | ||
Project finance organizing | −0.8918 b | 0.410 |
© 2020 by the author. Licensee MDPI, Basel, Switzerland. This article is an open access article distributed under the terms and conditions of the Creative Commons Attribution (CC BY) license (http://creativecommons.org/licenses/by/4.0/).
Share and Cite
Hai Nguyen, L. Empirical Analysis of a Management Function’s Failures in Construction Project Delay. J. Open Innov. Technol. Mark. Complex. 2020, 6, 26. https://doi.org/10.3390/joitmc6020026
Hai Nguyen L. Empirical Analysis of a Management Function’s Failures in Construction Project Delay. Journal of Open Innovation: Technology, Market, and Complexity. 2020; 6(2):26. https://doi.org/10.3390/joitmc6020026
Chicago/Turabian StyleHai Nguyen, Luong. 2020. "Empirical Analysis of a Management Function’s Failures in Construction Project Delay" Journal of Open Innovation: Technology, Market, and Complexity 6, no. 2: 26. https://doi.org/10.3390/joitmc6020026
APA StyleHai Nguyen, L. (2020). Empirical Analysis of a Management Function’s Failures in Construction Project Delay. Journal of Open Innovation: Technology, Market, and Complexity, 6(2), 26. https://doi.org/10.3390/joitmc6020026
