Towards Digital Transformation in the Construction Industry: A Selection Framework of Building Information Modeling Lifecycle Service Providers (BLSPs)
Abstract
1. Introduction

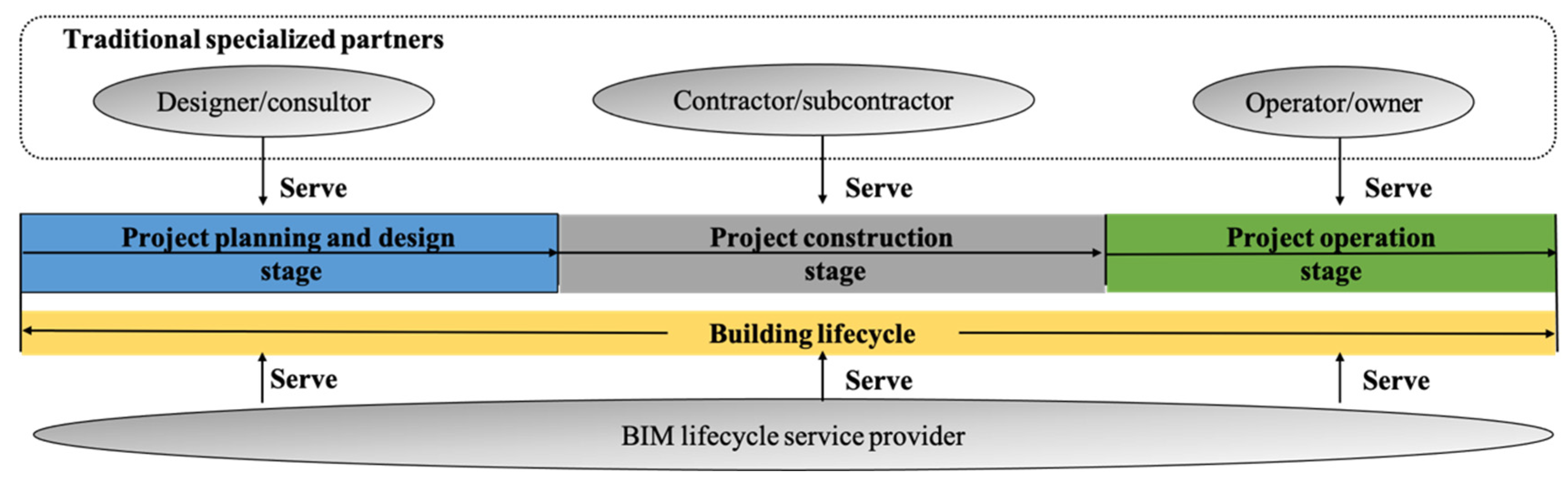

2. State of the Art
2.1. BIM Services from BLSPs
2.2. Challenges of BLSP Selection

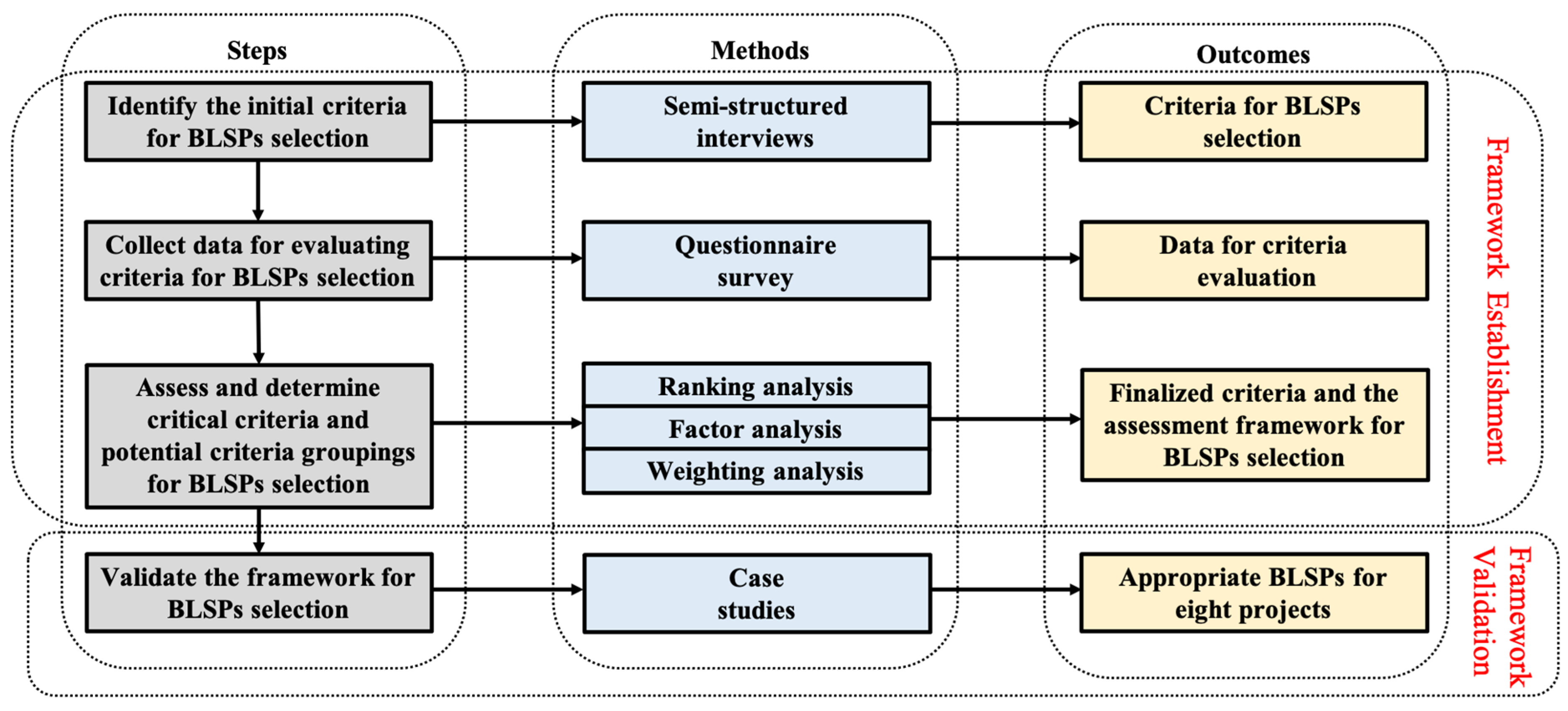

3. Research Methods
3.1. Identify the Initial Criteria for BLSP Selection
3.2. Collect Data for Evaluating Criteria for BLSP Selection
3.3. Assess and Determine Critical Criteria and Potential Criteria Groupings for BLSP Selection
- (1)
- Ranking analysis
- (2)
- Factor analysis
- (3)
- Weighting analysis
3.4. Validate the Assessment Framework for BLSP Selection
4. Results
4.1. Ranking Results
4.2. Factor Analysis Results
4.3. Weighting Results and the Selection Assessment Framework
4.4. Validation of BLSP Selection Assessment Framework
5. Discussion
5.1. The Necessity of the Five Factors for BLSP Selection
5.2. Comparison Between BLSPs and Traditional Partners Selection
6. Implications
7. Conclusions
Author Contributions
Funding
Data Availability Statement
Conflicts of Interest
Appendix A
Respondents | Positions | Working Experiences in Construction Industry (Years) | BIM Experiences (Years) | BIM Awards (Ever Won) | Number of Projects Participated in Selecting BLSPs | Types of Projects Participated in Selecting BLSPs |
---|---|---|---|---|---|---|
Owner1 | PM&BM | 25 | 8 | N&P | 50~60 | H |
Owner2 | PM&BM | 17 | 12 | P | 70~80 | H&I |
Owner3 | PM | 22 | 9 | N&P | 40~50 | H |
Owner4 | PM&BM | 22 | 12 | N&P | 50~60 | H |
Owner5 | PM | 18 | 11 | N&P | 60~70 | IS |
Owner6 | PM | 13 | 12 | P | 60~70 | H&I |
Owner7 | PM | 15 | 10 | P | 40~50 | H&I |
Owner8 | PM | 20 | 11 | P | 60~70 | H |
Contractor1 | PM&BM | 23 | 8 | P | 60~70 | H |
Contractor2 | PM&BM | 22 | 9 | N&P | 50~60 | H&I |
Contractor3 | BM | 28 | 11 | N&P | 50~60 | H&I |
Contractor4 | PM | 30 | 8 | N&P | 50~60 | H&I |
Contractor5 | PM&BM | 22 | 8 | N&P | 40~50 | H&I&IS |
Contractor6 | PM&BM | 18 | 11 | N&P | 30~40 | H&I&IS |
Contractor7 | PM | 23 | 12 | N&P | 40~50 | H&I&IS |
Contractor8 | PM&BM | 28 | 11 | N&P | 50~60 | H&I |
Contractor9 | PM&BM | 20 | 10 | N&P | 70~80 | H&I |
Contractor10 | PM&BM | 25 | 11 | N&P | 50~60 | H&I&IS |
Contractor11 | PM | 20 | 9 | P | 50~60 | H&I&IS |
Contractor12 | PM&BM | 22 | 8 | N&P | 80~90 | H&I&IS |
Contractor13 | PM&BM | 26 | 12 | N&P | 50~60 | H&I&IS |
Designer1 | PM&BM | 22 | 9 | P | 60~70 | H&I |
Designer2 | BM | 18 | 8 | N&P | 50~60 | H&I |
Designer3 | BM | 14 | 10 | N&P | 40~50 | H&I&IS |
Designer4 | BM | 14 | 11 | N&P | 30~40 | H&I&IS |
Designer5 | PM&BM | 20 | 8 | N&P | 50~60 | H&I&IS |
Designer6 | PM&BM | 22 | 12 | N&P | 50~60 | H&I |
Designer7 | PM&BM | 20 | 11 | N&P | 50~60 | H&I |
Designer8 | PM&BM | 22 | 9 | N&P | 60~70 | H&I |
Designer9 | PM&BM | 20 | 13 | N&P | 50~60 | H&I&IS |
Project Number | Project Type | Project Scale (Million Yuan) | Project Nature | Project Location | Number of Qualified BLSPs Bided | BLSP Selected |
---|---|---|---|---|---|---|
1 | School | 35 | Public | East | 5 | A2 |
2 | Real Estate | 48 | Private | Southeast | 5 | B3 |
3 | Hospital | 89 | Private | East | 7 | C2 |
4 | Semi-conductor factory | 220 | Private | Southeast | 5 | D4 |
5 | Power plant | 454 | Public | Southwest | 5 | E1 |
6 | Rail station | 115 | Public | North | 7 | F5 |
7 | Bridge | 821 | Public | Southeast | 5 | G1 |
8 | Underground tunnel | 642 | Public | East | 5 | H3 |
References
- Ribeirinho, M.J.; Mischke, J.; Strube, G.; Sjödin, E.; Blanco, J.L.; Rockhill, D.; Palter, R.; Andersson, T. The Next Normal in Construction; McKinsey & Company: Sydney, NSW, Australia, 2020. [Google Scholar]
- Barbosa, F.; Woetzel, J.; Mischke, J.; Ribeirinho, M.J.; Sridhar, M.; Bertram, N.; Brown, S. Reinventing Construction: A Route to Higher Productivity; McKinsey & Company: Sydney, NSW, Australia, 2017. [Google Scholar]
- Ernstsen, S.N.; Whyte, J.; Thuesen, C.; Maier, A. How Innovation Champions Frame the Future: Three Visions for Digital Transformation of Construction. J. Constr. Eng. Manag. 2021, 147, 05020022. [Google Scholar] [CrossRef]
- Dou, Y.; Li, T.; Li, L.; Zhang, Y.; Li, Z. Tracking the Research on Ten Emerging Digital Technologies in the AECO Industry. J. Constr. Eng. Manag. 2023, 149, 03123003. [Google Scholar] [CrossRef]
- Blanco, J.L.; Mullin, A.; Pandya, K.; Parsons, M.; Ribeirinho, M.J. Seizing Opportunity in Today’s Construction Technology Ecosystem; McKinsey & Company: Sydney, NSW, Australia, 2018. [Google Scholar]
- Kassem, M.; Ahmed, A.L. Digital Transformation through Building Information Modelling: Spanning the Macro-Micro Divide. Technol. Forecast. Soc. Chang. 2022, 184, 122006. [Google Scholar] [CrossRef]
- Oesterreich, T.D.; Teuteberg, F. Behind the Scenes: Understanding the Socio-Technical Barriers to BIM Adoption through the Theoretical Lens of Information Systems Research. Technol. Forecast. Soc. Chang. 2019, 146, 413–431. [Google Scholar] [CrossRef]
- Pan, Y.; Zhang, L. Integrating BIM and AI for Smart Construction Management: Current Status and Future Directions. Arch. Comput. Methods Eng. 2023, 30, 1081–1110. [Google Scholar] [CrossRef]
- Wang, T.; Chen, H.-M. Integration of Building Information Modeling and Project Management in Construction Project Lifecycle. Autom. Constr. 2023, 150, 104832. [Google Scholar] [CrossRef]
- Luo, L.; Chen, H.; Yang, Y.; Wu, G.; Chen, L. A Three-Stage Network DEA Approach for Performance Evaluation of BIM Application in Construction Projects. Technol. Soc. 2022, 71, 102105. [Google Scholar] [CrossRef]
- Jiang, R.; Wu, C.; Lei, X.; Shemery, A.; Hampson, K.D.; Wu, P. Government Efforts and Roadmaps for Building Information Modeling Implementation: Lessons from Singapore, the UK and the US. Eng. Constr. Archit. Manag. 2022, 29, 782–818. [Google Scholar] [CrossRef]
- Shojaei, R.S.; Burgess, G. Non-Technical Inhibitors: Exploring the Adoption of Digital Innovation in the UK Construction Industry. Technol. Forecast. Soc. Chang. 2022, 185, 122036. [Google Scholar] [CrossRef]
- Ma, X.; Xiong, F.; Olawumi, T.O.; Dong, N.; Chan, A.P.C. Conceptual Framework and Roadmap Approach for Integrating BIM into Lifecycle Project Management. J. Manag. Eng. 2018, 34, 05018011. [Google Scholar] [CrossRef]
- Chen, G.; Chen, J.; Tang, Y.; Li, Q.; Luo, X. Identifying Effective Collaborative Behaviors in Building Information Modeling–Enabled Construction Projects. J. Constr. Eng. Manag. 2022, 148, 04022026. [Google Scholar] [CrossRef]
- Papadonikolaki, E.; van Oel, C.; Kagioglou, M. Organising and Managing Boundaries: A Structurational View of Collaboration with Building Information Modelling (BIM). Int. J. Proj. Manag. 2019, 37, 378–394. [Google Scholar] [CrossRef]
- Chen, G.; Chen, J.; Tang, Y.; Ning, Y.; Li, Q. Collaboration Strategy Selection in BIM-Enabled Construction Projects: A Perspective through Typical Collaboration Profiles. Eng. Constr. Archit. Manag. 2022, 29, 2689–2713. [Google Scholar] [CrossRef]
- Liu, Y.; van Nederveen, S.; Hertogh, M. Understanding Effects of BIM on Collaborative Design and Construction: An Empirical Study in China. Int. J. Proj. Manag. 2017, 35, 686–698. [Google Scholar] [CrossRef]
- Cao, D.; Li, H.; Wang, G. Impacts of Building Information Modeling (BIM) Implementation on Design and Construction Performance: A Resource Dependence Theory Perspective. Front. Eng. Manag. 2017, 4, 20. [Google Scholar] [CrossRef]
- Chen, G.; Yan, Z.; Chen, J.; Li, Q. Building Information Modeling (BIM) Outsourcing Decisions of Contractors in the Construction Industry: Constructing and Validating a Conceptual Model. Dev. Built Environ. 2022, 12, 100090. [Google Scholar] [CrossRef]
- Fountain, J.; Langar, S. Building Information Modeling (BIM) Outsourcing among General Contractors. Autom. Constr. 2018, 95, 107–117. [Google Scholar] [CrossRef]
- Chen, G.; Chen, J.; Yuan, J.; Tang, Y.; Xiahou, X.; Li, Q. Exploring the Impact of Collaboration on BIM Use Effectiveness: A Perspective through Multiple Collaborative Behaviors. J. Manag. Eng. 2022, 38, 04022065. [Google Scholar] [CrossRef]
- Xu, J.; Lu, W. Developing a Human-Organization-Technology Fit Model for Information Technology Adoption in Organizations. Technol. Soc. 2022, 70, 102010. [Google Scholar] [CrossRef]
- Koc, K.; Ekmekcioglu, Ö.; Işık, Z. Developing a Hybrid Fuzzy Decision-Making Model for Sustainable Circular Contractor Selection. J. Constr. Eng. Manag. 2023, 149, 04023095. [Google Scholar] [CrossRef]
- Zhang, J.; Luo, H.; Xu, J. Towards Fully BIM-Enabled Building Automation and Robotics: A Perspective of Lifecycle Information Flow. Comput Ind. 2022, 135, 103570. [Google Scholar] [CrossRef]
- Shafiq, M.T.; Matthews, J.; Lockley, S.R. A Study of BIM Collaboration Requirements and Available Features in Existing Model Collaboration Systems. J. Inf. Technol. Constr. 2013, 18, 148–161. [Google Scholar]
- Volk, R.; Stengel, J.; Schultmann, F. Building Information Modeling (BIM) for Existing Buildings—Literature Review and Future Needs. Autom. Constr. 2014, 38, 109–127. [Google Scholar] [CrossRef]
- Ahn, Y.H.; Kwak, Y.H.; Suk, S.J. Contractors’ Transformation Strategies for Adopting Building Information Modeling. J. Manag. Eng. 2016, 32, 05015005. [Google Scholar] [CrossRef]
- McGraw Hill Construction. The Business Value of BIM for Construction in Major Global Markets; McGraw Hill Construction: Hamilton, NJ, USA, 2014. [Google Scholar]
- Alreshidi, E.; Mourshed, M.; Rezgui, Y. Factors for Effective BIM Governance. J. Build. Eng. 2017, 10, 89–101. [Google Scholar] [CrossRef]
- Matthews, J.; Love, P.E.D.D.; Mewburn, J.; Stobaus, C.; Ramanayaka, C. Building Information Modelling in Construction: Insights from Collaboration and Change Management Perspectives. Prod. Plan. Control 2018, 29, 202–216. [Google Scholar] [CrossRef]
- Wen, Q.-J.; Ren, Z.-J.; Lu, H.; Wu, J.-F. The Progress and Trend of BIM Research: A Bibliometrics-Based Visualization Analysis. Autom. Constr. 2021, 124, 103558. [Google Scholar] [CrossRef]
- Ma, X.; Chan, A.P.C.; Li, Y.; Zhang, B.; Xiong, F. Critical Strategies for Enhancing BIM Implementation in AEC Projects: Perspectives from Chinese Practitioners. J. Constr. Eng. Manag. 2020, 146, 05019019. [Google Scholar] [CrossRef]
- El-Sayegh, S.M.; Basamji, M.; Haj Ahmad, A.; Zarif, N. Key Contractor Selection Criteria for Green Construction Projects in the UAE. Int. J. Constr. Manag. 2021, 21, 1240–1250. [Google Scholar] [CrossRef]
- Plebankiewicz, E.; Kubek, D. Multicriteria Selection of the Building Material Supplier Using AHP and Fuzzy AHP. J. Constr. Eng. Manag. 2016, 142, 04015057. [Google Scholar] [CrossRef]
- Rodríguez, J.F.F. Sustainable Design Protocol in BIM Environments: Case Study of 3D Virtual Models of a Building in Seville (Spain) Based on BREEAM Method. Sustainability 2023, 15, 5787. [Google Scholar] [CrossRef]
- Magill, L.J.; Jafarifar, N.; Watson, A.; Omotayo, T. 4D BIM Integrated Construction Supply Chain Logistics to Optimise On-Site Production. Int. J. Constr. Manag. 2022, 22, 2325–2334. [Google Scholar] [CrossRef]
- Ensafi, M.; Harode, A.; Thabet, W. Developing Systems-Centric as-Built BIMs to Support Facility Emergency Management: A Case Study Approach. Autom. Constr. 2022, 133, 104003. [Google Scholar] [CrossRef]
- Celik, Y.; Petri, I.; Rezgui, Y. Integrating BIM and Blockchain across Construction Lifecycle and Supply Chains. Comput. Ind. 2023, 148, 103886. [Google Scholar] [CrossRef]
- Pan, Y.; Zhang, L. A BIM-Data Mining Integrated Digital Twin Framework for Advanced Project Management. Autom. Constr. 2021, 124, 103564. [Google Scholar] [CrossRef]
- Zhang, F.; Chan, A.P.C.; Darko, A.; Chen, Z.; Li, D. Integrated Applications of Building Information Modeling and Artificial Intelligence Techniques in the AEC/FM Industry. Autom. Constr. 2022, 139, 104289. [Google Scholar] [CrossRef]
- Wengraf, T. Qualitative Research Interviewing: Biographic Narrative and Semi-Structured Methods; Sage: London, UK, 2001; ISBN 9780803975019. [Google Scholar]
- Chan, D.W.M.; Olawumi, T.O.; Ho, A.M.L. Perceived Benefits of and Barriers to Building Information Modelling (BIM) Implementation in Construction: The Case of Hong Kong. J. Build. Eng. 2019, 25, 100764. [Google Scholar] [CrossRef]
- Giel, B.; Issa, R.R.A. Framework for Evaluating the BIM Competencies of Facility Owners. J. Manag. Eng. 2016, 32, 04015024. [Google Scholar] [CrossRef]
- Li, Y.; Zhu, L.; Xue, R.; Han, Y. How Policy Diffusion Influences Regional BIM Innovation: An Empirical Study in China. J. Constr. Eng. Manag. 2023, 149, 05023008. [Google Scholar] [CrossRef]
- Liu, R.; Du, J.; Issa, R.R.A.; Giel, B. BIM Cloud Score: Building Information Model and Modeling Performance Benchmarking. J. Constr. Eng. Manag. 2017, 143, 04016109. [Google Scholar] [CrossRef]
- Santos, J.R.A. Cronbach’s Alpha: A Tool for Assessing the Reliability of Scales. J. Ext. 1999, 37, 1–5. [Google Scholar]
- Jin, R.; Hancock, C.M.; Tang, L.; Wanatowski, D. BIM Investment, Returns, and Risks in China’s AEC Industries. J. Constr. Eng. Manag. 2017, 143, 04017089. [Google Scholar] [CrossRef]
- Dodge Data & Analytics (DD&A). Smart Market Report. The Business Value of BIM in China; Dodge Data & Analytics (DD&A): Hamilton Township, NJ, USA, 2015. [Google Scholar]
- Olawumi, T.O.; Chan, D.W.M.; Wong, J.K.W.; Chan, A.P.C. Barriers to the Integration of BIM and Sustainability Practices in Construction Projects: A Delphi Survey of International Experts. J. Build. Eng. 2018, 20, 60–71. [Google Scholar] [CrossRef]
- Siegel, S.; Castellan., N.J., Jr. Nonparametric Statistics for the Behavioral Sciences, 2nd ed.; Mcgraw-Hill Book Company: New York, NY, USA, 1988. [Google Scholar]
- Chan, A.P.C.; Darko, A.; Olanipekun, A.O.; Ameyaw, E.E. Critical Barriers to Green Building Technologies Adoption in Developing Countries: The Case of Ghana. J. Clean. Prod. 2018, 172, 1067–1079. [Google Scholar] [CrossRef]
- Field, A. Discovering Statistics Using SPSS Statistics; Sage: London, UK, 2017; ISBN 9781847879073. [Google Scholar]
- Erdem, D.; Ozorhon, B. Assessing Real Estate Project Success Using an Analytic Network Process. J. Manag. Eng. 2015, 31, 04014065. [Google Scholar] [CrossRef]
- Ma, P.; Zhang, S.; Hua, Y.; Zhang, J. Behavioral Perspective on BIM Postadoption in Construction Organizations. J. Manag. Eng. 2020, 36, 04019036. [Google Scholar] [CrossRef]
- Olawumi, T.O.; Chan, D.W.M. Concomitant Impediments to the Implementation of Smart Sustainable Practices in the Built Environment. Sustain. Prod. Consum. 2020, 21, 239–251. [Google Scholar] [CrossRef]
- de Melo, J.C.F.; Salerno, M.S.; Freitas, J.S.; Bagno, R.B.; Brasil, V.C. From Open Innovation Projects to Open Innovation Project Management Capabilities: A Process-Based Approach. Int. J. Proj. Manag. 2020, 38, 278–290. [Google Scholar] [CrossRef]
- Lang, M.; Wiesche, M.; Krcmar, H. Criteria for Selecting Cloud Service Providers: A Delphi Study of Quality-of-Service Attributes. Inf. Manag. 2018, 55, 746–758. [Google Scholar] [CrossRef]
- Guo, B.; Hao, S.; Zhang, Y.; Cao, G.; Gao, H.; Zhang, M. An Entropy Weight-TOPSIS Based Model for Partner Selection of Strategic Alliance of Prefabricated Construction Enterprises. Discret. Dyn. Nat. Soc. 2022, 2022, 7844524. [Google Scholar] [CrossRef]
Categories | BIM Services Included (Examples) | Service Outcome | Reference |
---|---|---|---|
BIM model creation and management | Creating the model chain: design model, the bidding and tendering model, the construction models (e.g., 4D model, 5D model, as-built model), and the operation and maintenance model Model content management: model integration, model checking, synchronization | Lifecycle-integrated BIM models | [24,25] |
BIM application | Planning and Design stage: site analysis, design review, design coordination, energy simulation, constructability analysis | Lifecycle comprehensive BIM use cases | [26,27,28] |
Construction stage: clash detection, schedule simulation, quantity take-off, site logistics, off-site fabrication, spatial coordination | |||
Operation stage: space management, facility management | |||
BIM consulting | Technical consulting: selecting data acquisition software and technologies; determining the data transfer paths and tools; establishing the data recognition and decoding ways; building up a BIM-based platform Managerial consulting: formulating the BIM Execution plan; establishing the BIM manuals; offering BIM guidelines; providing BIM trainings | Lifecycle-integrated and standardized BIM working flows | [13,17,29] |
Codes | Criteria | Criteria Description |
---|---|---|
C01 | BIM certificates of the BIM manager | BIM certificates awarded by the construction authority or regime to the BIM manager. |
C02 | Available BIM infrastructure | The adequacy of BIM hardware (e.g., the computing power, the storage volume) and software (e.g., the diversity of software) for the project BIM service. |
C03 | BIM certificates of the BIM engineer | BIM certificates awarded by the construction authority or regime to the BIM engineer. |
C04 | BIM service experience of BIM manager | The participation of BIM managers in previous BIM service projects, including the size of projects, the number of projects, similar projects experience, etc. |
C05 | Market share and reputation | The dominance and influence of the provider in the BIM service market. |
C06 | Past BIM service experience | Completed BIM service projects by the provider, including the size of projects, the number of projects, similar projects experience, etc. |
C07 | Exclusive BIM staff for the project | The number of exclusive BIM staff supporting the project BIM service. |
C08 | Integration with other project digital systems | BIM service can be easily integrated with other project digital systems (e.g., Project management systems) to promote project performance. |
C09 | Organization’s BIM staff | The number of long-term BIM staff employed by the service provider. |
C10 | BIM service plan with lifecycle cognition | BIM service plan with core lifecycle cognition considering the digital integration (e.g., model integration) across different project stages. |
C11 | Service compatibility with partners’ operating systems | BIM service has less impact on partners’ normal operating systems and can be integrated to operating systems. |
C12 | Boundary spanning competence of the BIM manager | BIM managers can work as boundary spanners among partners to facilitate BIM-based digital integration (e.g., digital model integration, and workflow integration). |
C13 | BIM efficiency and effectiveness | The whole project performance improvement from BIM service. |
C14 | BIM awards | The recognition of the excellent BIM service awarded by the construction authority or regime. |
C15 | BIM service claims | Conflicts for disabled BIM service (i.e., BIM service failures). |
C16 | BIM strategy and vision | The company-level strategic target, route, and vision around the provider’s BIM service. |
C17 | Finance stability | The soundness of the cash flow of the BIM service provider. |
C18 | BIM research and development (R&D) | The resources devoted to BIM research and development (R&D) for BIM service innovation. |
C19 | Experience in the construction market | Years that the service provider worked in the construction market. |
C20 | Past partnership and trust relationship with customers | Established partnership and trust relationships with served customers for successful BIM services |
C21 | Past innovative BIM service practices | Exploitative (e.g., BIM advanced use cases during building lifecycle) and explorative (e.g., BIM integration with other digital technologies) BIM services offered by the provider. |
C22 | Privacy and security | Data protection measures during the BIM service. |
C23 | Backup system | Data recovery measures for abnormal situations (e.g., cyber-attacks) during the BIM service. |
C24 | Complete service bidding document | BIM service bidding document satisfying the basic project and customer requirements. |
C25 | Cost | Setup cost (e.g., building up BIM models, conducting specific BIM applications) and continuous BIM cost (e.g., model maintenance). |
Frequency | Proportion | |
---|---|---|
Respondents | 178 (total) | 100% (total) |
Working role | ||
Contractor | 104 | 58.4% |
Designer | 43 | 24.2% |
Owner | 31 | 17.4% |
Company size | ||
Large | 32 | 18.0% |
Medium | 82 | 46.0% |
Small | 64 | 36.0% |
Working positions | ||
Project manager/BIM manager | 118 | 66.3% |
Chief engineer | 34 | 19.1% |
Engineer | 26 | 14.6% |
Construction experience | ||
1~5 years | 6 | 3.4% |
5–10 years | 75 | 42.1% |
10–15 years | 48 | 27.0% |
Above 15 years | 49 | 27.5% |
BIM experience | ||
1~5 years | 32 | 18.0% |
5–10 years | 128 | 71.9% |
10–15 years | 18 | 10.1% |
Number of projects participated in selecting BLSPs | ||
1~10 | 21 | 11.8% |
10~30 | 33 | 18.5% |
30~50 | 85 | 47.8% |
Above 50 | 39 | 21.9% |
Code | All Respondents (N = 178) | Designer (N = 43) | Owner (N = 31) | Contractor (N = 104) | ANOVA | ||||||||||
---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|
Mean | SD | Rank | Normalized Mean | Mean | SD | Rank | Mean | SD | Rank | Mean | SD | Rank | F | Sig | |
C14 | 4.44 | 0.744 | 1 | 1.00 a | 4.42 | 0.763 | 1 | 4.23 | 0.921 | 3 | 4.52 | 0.668 | 1 | 1.910 | 0.151 |
C13 | 4.40 | 0.820 | 2 | 0.98 a | 4.37 | 0.874 | 2 | 4.10 | 1.106 | 4 | 4.51 | 0.668 | 2 | 3.149 | 0.045 b |
C20 | 4.39 | 0.698 | 3 | 0.97 a | 4.35 | 0.573 | 4 | 4.29 | 0.864 | 2 | 4.43 | 0.693 | 3 | 0.581 | 0.560 |
C15 | 4.35 | 0.739 | 4 | 0.95 a | 4.37 | 0.618 | 3 | 4.10 | 1.044 | 5 | 4.42 | 0.664 | 4 | 2.381 | 0.095 |
C04 | 4.30 | 0.696 | 5 | 0.91 a | 4.21 | 0.773 | 6 | 4.45 | 0.723 | 1 | 4.30 | 0.652 | 5 | 1.102 | 0.335 |
C21 | 4.16 | 0.987 | 6 | 0.83 a | 4.30 | 0.887 | 5 | 3.74 | 1.237 | 18 | 4.23 | 0.916 | 6 | 3.600 | 0.029 b |
C06 | 4.14 | 0.695 | 7 | 0.81 a | 4.19 | 0.824 | 7 | 3.94 | 0.629 | 12 | 4.18 | 0.650 | 7 | 1.645 | 0.196 |
C12 | 4.11 | 0.736 | 8 | 0.79 a | 4.02 | 0.801 | 14 | 4.03 | 0.706 | 8 | 4.17 | 0.717 | 8 | 0.852 | 0.428 |
C25 | 4.08 | 0.571 | 9 | 0.78 a | 4.05 | 0.688 | 13 | 4.00 | 0.447 | 9 | 4.13 | 0.552 | 9 | 0.693 | 0.501 |
C22 | 4.08 | 0.809 | 10 | 0.78 a | 4.12 | 0.851 | 10 | 3.94 | 0.892 | 10 | 4.12 | 0.767 | 11 | 0.633 | 0.532 |
C11 | 4.06 | 0.730 | 11 | 0.76 a | 3.93 | 0.856 | 20 | 4.06 | 0.680 | 6 | 4.12 | 0.687 | 10 | 0.979 | 0.378 |
C24 | 4.04 | 0.667 | 12 | 0.75 a | 4.14 | 0.710 | 9 | 3.81 | 0.601 | 15 | 4.07 | 0.658 | 12 | 2.509 | 0.084 |
C23 | 4.00 | 0.844 | 13 | 0.72 a | 4.07 | 0.828 | 12 | 4.03 | 0.795 | 7 | 3.96 | 0.869 | 15 | 0.275 | 0.760 |
C10 | 3.99 | 0.705 | 14 | 0.72 a | 4.00 | 0.690 | 16 | 3.81 | 0.654 | 16 | 4.04 | 0.723 | 13 | 1.305 | 0.274 |
C05 | 3.96 | 0.801 | 15 | 0.70 a | 4.16 | 0.814 | 8 | 3.81 | 0.792 | 14 | 3.91 | 0.790 | 17 | 2.146 | 0.120 |
C07 | 3.94 | 0.757 | 16 | 0.69 a | 4.12 | 0.851 | 11 | 3.87 | 0.763 | 13 | 3.89 | 0.709 | 18 | 1.491 | 0.228 |
C08 | 3.94 | 0.711 | 17 | 0.69 a | 3.91 | 0.750 | 21 | 3.94 | 0.772 | 11 | 3.96 | 0.682 | 16 | 0.091 | 0.913 |
C19 | 3.94 | 0.745 | 18 | 0.68 a | 3.98 | 0.831 | 18 | 3.77 | 0.669 | 17 | 3.97 | 0.730 | 14 | 0.909 | 0.405 |
C02 | 3.83 | 0.727 | 19 | 0.61 a | 4.00 | 0.787 | 17 | 3.71 | 0.693 | 20 | 3.79 | 0.706 | 20 | 1.782 | 0.171 |
C16 | 3.81 | 0.784 | 20 | 0.61 a | 3.81 | 0.795 | 22 | 3.68 | 0.702 | 21 | 3.86 | 0.806 | 19 | 0.615 | 0.542 |
C17 | 3.79 | 0.773 | 21 | 0.59 a | 4.00 | 0.787 | 15 | 3.71 | 0.783 | 19 | 3.72 | 0.756 | 22 | 2.191 | 0.115 |
C18 | 3.77 | 0.772 | 22 | 0.58 a | 3.93 | 0.768 | 19 | 3.58 | 0.807 | 22 | 3.76 | 0.757 | 21 | 1.886 | 0.155 |
C09 | 3.63 | 0.694 | 23 | 0.49 | 3.81 | 0.732 | 23 | 3.48 | 0.626 | 23 | 3.61 | 0.689 | 23 | 2.289 | 0.104 |
C03 | 3.45 | 0.890 | 24 | 0.38 | 3.19 | 0.958 | 24 | 3.29 | 0.824 | 24 | 3.61 | 0.852 | 24 | 4.128 | 0.018 b |
C01 | 2.85 | 0.752 | 25 | 0.00 | 3.00 | 0.873 | 25 | 2.90 | 0.651 | 25 | 2.78 | 0.723 | 25 | 1.401 | 0.249 |
W = 0.153 (Sig = 0.000) | W = 0.169 (Sig = 0.000) | W = 0.203 (Sig = 0.000) |
Code | Criteria For BLSP Selection | Factor Loadings | Eigenvalue | Variance (%) | Cumulative Variance (%) | ||||
---|---|---|---|---|---|---|---|---|---|
1 | 2 | 3 | 4 | 5 | |||||
Factor 1: Project BIM service capability | 3.945 | 17.932 | 17.932 | ||||||
C04 | BIM service experience of BIM manager | 0.677 | −0.012 | −0.026 | −0.051 | 0.255 | |||
C07 | Exclusive BIM staff for the project | 0.741 | 0.159 | −0.098 | 0.074 | 0.077 | |||
C12 | Boundary spanning competence of the BIM manager | 0.749 | 0.285 | 0.036 | −0.010 | −0.101 | |||
C10 | BIM service plan with lifecycle cognition | 0.636 | 0.418 | −0.027 | 0.049 | −0.043 | |||
C11 | Service compatibility with partners’ operating systems | 0.691 | 0.143 | −0.055 | −0.166 | 0.251 | |||
C02 | Available BIM infrastructure | 0.727 | 0.167 | −0.059 | −0.030 | 0.223 | |||
C08 | Integration with other project digital systems | 0.690 | 0.324 | 0.057 | −0.091 | 0.107 | |||
Factor 2: Organization BIM service capability | 3.402 | 15.464 | 33.395 | ||||||
C17 | Finance stability | 0.104 | 0.590 | −0.089 | 0.288 | 0.365 | |||
C05 | Market share and reputation | 0.136 | 0.585 | 0.053 | −0.042 | 0.328 | |||
C19 | Experience in the construction market | 0.325 | 0.722 | 0.049 | −0.161 | 0.099 | |||
C06 | Past BIM service experience | 0.346 | 0.646 | 0.147 | −0.012 | −0.126 | |||
C16 | BIM strategy and vision | 0.174 | 0.791 | −0.028 | 0.023 | 0.035 | |||
C18 | BIM research and development (R&D) | 0.159 | 0.759 | 0.013 | −0.042 | 0.138 | |||
Factor 3: Past BIM service performance and quality | 2.867 | 13.034 | 46.429 | ||||||
C15 | BIM service claims | −0.070 | 0.078 | 0.737 | 0.198 | −0.155 | |||
C21 | Past innovative BIM service practices | −0.125 | 0.123 | 0.651 | 0.338 | −0.089 | |||
C20 | Past partnership and trust relationship with customers | 0.034 | −0.058 | 0.773 | 0.122 | 0.099 | |||
C14 | BIM awards | −0.019 | 0.024 | 0.768 | 0.036 | −0.070 | |||
C13 | BIM efficiency and effectiveness | 0.012 | −0.016 | 0.760 | −0.128 | 0.052 | |||
Factor 4: BIM service reliability | 1.765 | 8.022 | 54.451 | ||||||
C23 | Backup system | −0.120 | 0.009 | 0.187 | 0.828 | 0.050 | |||
C22 | Privacy and security | 0.011 | −0.079 | 0.145 | 0.855 | −0.045 | |||
Factor 5: BIM service document and cost | 1.582 | 7.192 | 61.643 | ||||||
C24 | Complete service bidding document | 0.165 | 0.312 | 0.035 | 0.020 | 0.756 | |||
C25 | cost | 0.340 | 0.083 | −0.147 | −0.031 | 0.680 |
Factor | Weights | Criteria | Local Weights | Global Weights |
---|---|---|---|---|
Project BIM service capability | 0.291 | C04 | 0.138 | 0.040 |
C07 | 0.150 | 0.044 | ||
C12 | 0.152 | 0.045 | ||
C10 | 0.130 | 0.038 | ||
C11 | 0.141 | 0.041 | ||
C02 | 0.148 | 0.042 | ||
C08 | 0.141 | 0.041 | ||
Organization BIM service capability | 0.251 | C17 | 0.144 | 0.036 |
C05 | 0.143 | 0.036 | ||
C19 | 0.177 | 0.044 | ||
C06 | 0.158 | 0.041 | ||
C16 | 0.193 | 0.048 | ||
C18 | 0.185 | 0.046 | ||
Past BIM service performance and quality | 0.211 | C15 | 0.201 | 0.043 |
C21 | 0.176 | 0.038 | ||
C20 | 0.209 | 0.043 | ||
C14 | 0.208 | 0.044 | ||
C13 | 0.206 | 0.043 | ||
BIM service reliability | 0.130 | C23 | 0.491 | 0.064 |
C22 | 0.509 | 0.066 | ||
BIM service document and cost | 0.117 | C24 | 0.491 | 0.061 |
C25 | 0.509 | 0.056 |
Project Number | BLSPs Candidates and Their Scores | Consistent or Inconsistent with the Practically Selected BLSPs |
---|---|---|
1 | A1 (6.385); A2 (7.446); A3 (6.059); A4 (6.678); A5 (5.719) | Consistent |
2 | B1 (6.041); B2 (6.175); B3 (7.384); B4 (6.543); B5 (6.808) | Consistent |
3 | C1 (5.266); C2 (7.123); C3 (6.285); C4 (6.709); C5 (5.646); C6 (6.458); C7 (6.191) | Consistent |
4 | D1 (5.965); D2 (6.087); D3 (5.994); D4 (7.004); D5 (5.867) | Consistent |
5 | E1 (6.886); E2 (7.373); E3 (6.795); E4 (6.023); E5 (6.273) | Inconsistent |
6 | F1 (5.63); F2 (5.923); F3 (6.603); F4 (6.063); F5 (7.43); F6 (6.025); F7 (6.032) | Consistent |
7 | G1 (7.46); G2 (6.514); G3 (6.375); G4 (6.362); G5 (6.567) | Consistent |
8 | H1 (6.289); H2 (6.127); H3 (6.687); H4 (7.111); H5 (6.336) | Inconsistent |
Disclaimer/Publisher’s Note: The statements, opinions and data contained in all publications are solely those of the individual author(s) and contributor(s) and not of MDPI and/or the editor(s). MDPI and/or the editor(s) disclaim responsibility for any injury to people or property resulting from any ideas, methods, instructions or products referred to in the content. |
© 2025 by the authors. Licensee MDPI, Basel, Switzerland. This article is an open access article distributed under the terms and conditions of the Creative Commons Attribution (CC BY) license (https://creativecommons.org/licenses/by/4.0/).
Share and Cite
Chen, G.; Feng, Q.; Jiang, C.; Zhang, S.; Li, Q. Towards Digital Transformation in the Construction Industry: A Selection Framework of Building Information Modeling Lifecycle Service Providers (BLSPs). Systems 2025, 13, 816. https://doi.org/10.3390/systems13090816
Chen G, Feng Q, Jiang C, Zhang S, Li Q. Towards Digital Transformation in the Construction Industry: A Selection Framework of Building Information Modeling Lifecycle Service Providers (BLSPs). Systems. 2025; 13(9):816. https://doi.org/10.3390/systems13090816
Chicago/Turabian StyleChen, Guangchong, Qianqin Feng, Chengcheng Jiang, Shengxi Zhang, and Qiming Li. 2025. "Towards Digital Transformation in the Construction Industry: A Selection Framework of Building Information Modeling Lifecycle Service Providers (BLSPs)" Systems 13, no. 9: 816. https://doi.org/10.3390/systems13090816
APA StyleChen, G., Feng, Q., Jiang, C., Zhang, S., & Li, Q. (2025). Towards Digital Transformation in the Construction Industry: A Selection Framework of Building Information Modeling Lifecycle Service Providers (BLSPs). Systems, 13(9), 816. https://doi.org/10.3390/systems13090816
