Next Article in Journal
Sustainable Operation Structures in the Cross-Border Enterprise Ecosystem under Tariff Fluctuations: A Systematic Evaluation
Previous Article in Journal
“Lock-In Effect” of China’s Industrialization: An Empirical Analysis of the County-Level Cities in Southern Jiangsu

Font Type:
Arial Georgia Verdana
Font Size:
Aa Aa Aa
Line Spacing:
Column Width:
Background:
Article

The Decision-Making for the Optimization of Finance Lease with Facilities’ Two-Dimensional Deterioration

1
School of Computer Science and Software, Zhaoqing University, Zhaoqing 526061, China
2
Department of International Business, Ming Chuan University, Taipei 33300, Taiwan
3
College of Management, Shu-Te University, Kaohsiung 82445, Taiwan
*
Author to whom correspondence should be addressed.
Systems 2022, 10(6), 210; https://doi.org/10.3390/systems10060210
Submission received: 26 September 2022 / Revised: 28 October 2022 / Accepted: 3 November 2022 / Published: 5 November 2022
(This article belongs to the Section Systems Engineering)

Abstract

:
In the past, most companies in developing countries usually own facilities or equipment for running their businesses. However, for some managerial and financial reasons, the situation may change. Recently, leasing facilities is becoming more popular than purchasing them. Furthermore, since the deterioration of equipment or facilities depends on both time and usage, when considering only one of the two factors, the deterioration estimation for the leased facilities could be distorted. Therefore, in such cases, a two-dimensional failure model would be appropriate for dealing with such problems. In this study, in order to determine the optimal lease decision for lessors, we use analytical models and efficient solution algorithms based on the two deterioration factors (time and usage). However, such complex mathematical models are difficult to apply in real cases, and therefore the study proposes the design of computerized system architecture and the corresponding solution algorithms to enhance the practicality of the applications. Besides, a nonhomogeneous Poisson process is employed to describe the successive failure times of the leased facility. Finally, the application and sensitivity analyses will provide managerial implications and suggestions for decision-makers under different preventive maintenance alternatives.

1. Introduction

In the last two decades, the majority of companies preferred to purchase their own equipment and facilities to run their business. It is possible, however, that the situation may change due to some managerial and financial reasons. Accordingly, there are more and more companies choosing to lease equipment and facilities instead of buying them outright. In the manufacturing industry, Pongpech and Murthy [1] gave two reasons why leasing facilities will become more popular: (1) Rapid technical advancements cause technological obsolescence, with newer and better equipment arriving on the market at a quicker rate. (2) The cost of owning facilities is getting too expensive. In addition, the financial benefit is one of the primary reasons that influence the decision of companies to lease facilities instead of buying them. As a result of leasing, companies are able to better match their cash flow with revenue by making better use of their facilities. In other words, a leasing policy is a good way to reduce companies’ tax obligations and avoid the risk of investing in new facilities. Accordingly, numerous studies began focusing on finance leases in different equipment, facilities, or machines. Nisbet and Ward [2] investigated the leasing of radiation equipment for medical facilities and hospitals and provided an indication between purchase and lease in terms of cost consideration. Optimal pricing rules for remanufacturing leased items were presented by Aras et al. [3]. Bourjade et al. [4] investigated the influence of aircraft leasing on financial performance and stability.
However, leasing facilities or equipment create new challenges for both the lessor and the lessee. The lessor may be required to offer preventive maintenance services and a free repair warranty to its lessee for the duration of the lease. When the lessor prepares the lease contract for the lessee, the costs may be considered. In general, most contracts will stipulate penalties for repeated failures, unfulfilled maintenance service and repair not conducted within an acceptable time limit, and so on ([5,6,7]). In other words, leasing facilities are frequently combined with preventive maintenance and free repair service that the lessor provides to the lessee as part of a contract. Iskandar and Husniah [8] proposed an imperfect preventive maintenance policy to reduce lease equipment’s failure rate. In this lease contract, the lessor has to pay the related costs of preventive maintenance, repair, and penalty for his customers. Zhang et al. [9] expressed their viewpoint on the leasing facilities problem. In their perspective, in order to avoid the burden of purchasing facilities in the short term, most companies might choose to lease them rather than buy them. The lessor should, however, provide equipment maintenance services to lessees in order to increase their lease intention for the purpose of expanding their market share. Thus, most lease contracts include maintenance services in order to attract lessors. Liu et al. [10] proposed a non-cooperative game model to discuss the issue of preventive maintenance service of leased equipment between lessors and lessees. They considered that a cost-sharing contract can be designed to achieve the maximum revenue as in a cooperative game between lessors and lessees. According to the above-mentioned, they reasoned that most lessees or companies would lease rather than buy to avoid the expense of acquiring facilities. Lessors should, however, continue to meet lessees’ demands for facilities maintenance in order to enhance lease intention and gain market share. As a result, it is common for most leasing contracts to include preventive maintenance services in order to attract lessees.
Typically, since the lessor wants to attract customers to accept the capital or financial lease contract, he/her might provide a warranty with preventive maintenance service to customers. Accordingly, periodic and sequential preventive maintenance policies are often applied in lease contracts in practice. A periodic preventive maintenance policy is the manufacturer providing its maintenance work with equal time intervals. Sequential preventive maintenance policy is different from the periodic preventive maintenance policy. This policy is characterized by the search for the optimal number of maintenance actions to be performed during a given period and the optimal intervals between two maintenance activities. Therefore, the policy is to fulfill the system degeneration process because a system is maintained at an unequal sequence of intervals. Park et al. [11] proposed a model for calculating the ideal duration and number of preventive maintenances based on minimum repairs after breakdowns. Yeh and Lo [12] demonstrated that the ideal interval between two consecutive preventive maintenance activities is equal to the degree of maintenance. They also proved their model with an equivalent degree of preventive maintenance is the best method to decrease the related costs. Jung and Park [13] developed a periodic preventive maintenance policy to obtain the optimal number and the optimal period for warranty service by minimizing the long-run maintenance costs. Seo and Bai [14] proposed a periodic preventive maintenance strategy for two scenarios where the maintenance time might be disregarded or not. Yeh and Chang [15] determined the best failure rate and periodic maintenance strategy in a lease duration. Hu and Zong [16] relaxed some constraints under which the lease period is proposed in Pongpech and Murthy’s [1] model, and established the best lease duration and preventive maintenance method to minimize total cost per unit time. Das and Sarmah [17] provided an overview of optimization methods for maintenance and replacement in heavy-process industries. Yeh et al. [5] evaluated the effects of various maintenance cost functions on a leased product with a Weibull lifetime distribution and periodic maintenance policy. Chang and Lo [18] evaluated the impact of lease terms on maintenance strategy for leased equipment with residual value. Bouguerra et al. [19] created a mathematical model for various maintenance alternatives when customers choose to purchase an extended warranty. They discovered a viable compromise to establish a win-win situation between producers and customers in terms of warranty costs. Chang and Lin [20] developed an ideal maintenance policy for repairable items with extended warranties. They discovered that manufacturers should give a slight discount to consumers who have purchased extended warranty contracts in order to increase earnings. Kim and Ozturkoglu [21] transformed the traditional preventive maintenance problem into an integer programming problem. Shafiee et al. [22] create a mathematical model to simultaneously calculate the ideal burn-in time, optimal number of maintenance operations, and appropriate maintenance degree. Shafiee’s model’s primary contribution is that it measures the consequences of maintenance action when the failure rate is constant. Khojandi et al. [23] investigated the optimal lifetime-reward maintenance strategies for perfect and imperfect maintenance situations. They showed the tradeoff between the virtual age of the systems and the incentive rate for decision-makers. Yuan and Lu [24] suggested an effective way to solve a reliability-based optimization issue that combines the weighted approach with sequential preventive maintenance optimization. Lu et al. [25] proposed a joint model of sequential preventive maintenance and quality improvement for deteriorating manufacturing systems. The study is more appropriate for maintaining machines in a production system. Wang and Djurdjanovic [26] also proposed a joint model for preventive maintenance scheduling with consideration of inventory and transportation management. They seek an integrated decision-making policy to trigger preventive maintenance for working parts. Zhou et al. [27] proposed a sequential preventive maintenance model with a reducing failure factor. The model was applied to urban bus systems’ maintenance works. García and Salgado [28] discussed a case study to analyze the selection of preventive maintenance strategies in multistage industrial equipment. Their study utilized some individual indicators to evaluate which preventive maintenance strategies are better. Alrifaey et al. [29] designed a hybrid reliability-centered maintenance model to optimize the preventive maintenance work for an electrical gas turbine generator. Since the preventive maintenance work involves the scheduling issue, they utilized a particle swarm optimization algorithm to obtain the optimal solution. Tsarouhas [30] applied preventive maintenance models based on an NHPP assumption to the ice cream industry. Tsarouhas used RAM (Reliability, Availability, and Maintainability) analytical methods for monitoring a firm’s machine status of manufacturing systems. Lastra et al. [31] proposed the applicability of additive manuring processes to improve the works of preventive maintenance. They considered that the spare parts would play an important role in machine maintenance. Diatte et al. [32] proposed a methodology for improving an automobile brake system, and the methodology makes the integration of the equipment’s reliability, availability, and maintainability into system engineering and dependability analyses for reducing related costs and increasing a system’s reliability.
Since the degradation of industrial equipment or facilities is affected not only by time but also by usage, just considering one of them may skew the assessment of equipment deterioration. As a result, a two-dimensional failure model would be appropriate for dealing with such issues. Baik et al. [33] addressed two-dimensional failure modeling for a system that is degrading owing to two factors: age and usage. In their study, the two-dimensional situation was applied to the concept of minimal repair, and the failures were characterized using the Bivariate Weibull model. He et al. [34] utilized a similar concept in order to assess the reliability of piezoelectric micro-actuators by taking two factors into account: the driving voltage and the temperature of the actuator. As a means of solving a two-dimensional warranty problem, Murthy et al. [35] used Beta-Stacy and Bivariate Pareto distributions. In order to estimate the expected cost under a free-replacement warranty, Kim and Rao [36] used a bivariate exponential distribution. Pal and Murthy [37] also utilized a Bivariate Exponential distribution to estimate machinery’s repair cost. It offered manufacturers with guidance on how to offer two-dimensional maintenance service to customers with appropriate duration. Shahanaghi et al. [38] designed a two-dimensional extended warranty contract for automobile manufacturers. They focused on how to improve preventive maintenance plans based on the length and usage of the warranty. Huang et al. [39] used a bivariate Weibull distribution to analyze the repair costs with periodic preventive maintenance. Huang et al. [40] designed a customized warranty with two-dimensional deterioration for different usage style customers. Their study result indicated that the customized warranty policy is beneficial by providing an effective mechanism to decrease the related costs. Park et al. [41] proposed a warranty policy with consideration of two-dimensional deterioration especially focusing on the post-warranty period. Dong et al. [42] proposed an opportunistic maintenance strategy for improving system availability and reducing warranty costs. In their model, a two-dimensional warranty was taken into consideration, and a designed reliability threshold is used to ensure the utilization is above a certain level. Wang et al. [43] proposed and applied punctual and unpunctual preventive maintenance policies with two-dimensional deterioration in automobile industries. Dong et al. [44] studied a multi-component system with two-dimensional deterioration. In order to solve their proposed model efficiently, they utilized beetle antennae search with particle swarm optimization to achieve the objectives of lower cost and higher system availability.
According to the discussions above, the study takes a two-dimensional deterioration (time and usage) into consideration to develop an analytical model and an efficient solution method for obtaining the optimal leasing decision for facilities. A nonhomogeneous Poisson process (NHPP) is used to characterize the consecutive failure times of lease facilities. Preventive maintenance schemes are also considered in the proposed model to reduce the related costs during the lease period. The study may have the advantages or contributions as follows: (1) The study can integrate the issues of the lease facility’s two-dimensional deterioration, different customers’ usage rates, preventive maintenance alternatives, financial lease strategies, etc., to construct the decision model. (2) In order to measure the different lessees’ customs and usage styles, the study utilizes different probability distributions to depict the heterogeneity of lessees. It can truly reflect the lease market of equipment or facilities because most related studies simply assumed that the lessees are homogeneous and their usage styles are almost the same but it might distort the estimation of the lease contract’s costs. (3) In order to apply the proposed models in real cases, the study provides solution algorithms and a computerized architecture design to lessors to realize the computerization of decision-making.
The rest of this paper is organized as follows: Section 2 presents the two-dimensional deterioration model with different probability distributions of customers’ usage rates and the estimation of related costs under periodic preventive maintenance. Section 3 provides the optimal preventive maintenance models with and without consideration of revenue of a financial lease contract. The proposed solution algorithms and the computerized management system design are also presented in the section. Section 4 presents the application and sensitivity analysis. Finally, Section 5 draws the concluding remarks and identifies topics for future studies.

2. Two-Dimensional Deterioration of Lease Facilities

In the past, the estimation of one-dimensional deterioration has been used in most of the studies on electronic or mechanical systems for inspection and repair works. However, in the real world, most machinery equipment’s deterioration is two-dimensional. It means that a machinery equipment’s deterioration is not only influenced by time but also influenced by usage. Accordingly, the section will propose a two-dimensional deterioration model with different probability distributions of usage rates.
The following notations in Table 1 are used in the analysis throughout this study:

2.1. Two-Dimensional Deterioration Model

Regarding the two-dimensional deterioration model, we assume that the breakdown process of the leased facility behaves according to the bivariate Weibull process. According to Lu and Bhattacharyya’s proposed bivariate Weibull model [45], the failure intensity function is given as follows:
λ ( t , u , Θ ) = ( β α β t β 1 ) ( κ ω κ u κ 1 ) ,
where the parameters α and β represent the scale and shape parameters in terms of deterioration with time. The parameters ω and κ represent the scale and shape parameters in terms of deterioration with usage. To the bivariate Weibull model, if the values of shape parameters β and κ are greater than one, the deteriorating system will increase with time and usage. By amplifying the scale parameter’s value, the system will present an exponentially increasing trend. In most aging facility cases, the model is more flexible and manageable to describe the behavior of aging systems than other models. However, when the shape parameters β are κ are equal to one, the NHPP downgrade to an HPP with a constant failure intensity α and ω . With regard to the estimation of the parameters, the lessor can make accelerated deterioration experiments to obtain the estimated values.
Without consideration of any preventive maintenance (PM) policy and any lessees’ usual practice, the estimation of the expected number of breakdowns can be obtained as the following equation:
E [ N b r | T L , Θ ] = 0 T L 0 U L λ ( t , u , Θ ) d u d t = ( T L α ) β ( U L ω ) κ .
Due to the fact that the breakdown process of a deteriorating system can be modeled as an NHPP (Non-Homogenous Poisson Process) with the intensity function λ ( t , u , Θ ) , the probability of the number of breakdowns N 0 in the interval ( T L 1 , T L 2 ) is thus given by
P r { N b r ( T L 2 , U L ) N b r ( T L 1 , U L ) = N 0 } = ( T L 1 T L 2 0 U L λ ( t , u , Θ ) d u d t ) N 0 e T L 1 T L 2 0 U L λ ( t , u , Θ ) d u d t N 0 !
The reliability of a facility R ( T L , U L ) will decline with time and usage, and therefore it can be given as
R ( T L , U L ) = P r { N b r ( T L , U L ) = 0 } = e 0 T L 0 U L λ ( t , u , Θ ) d u d t = e ( T L α ) β ( U L ω ) κ .

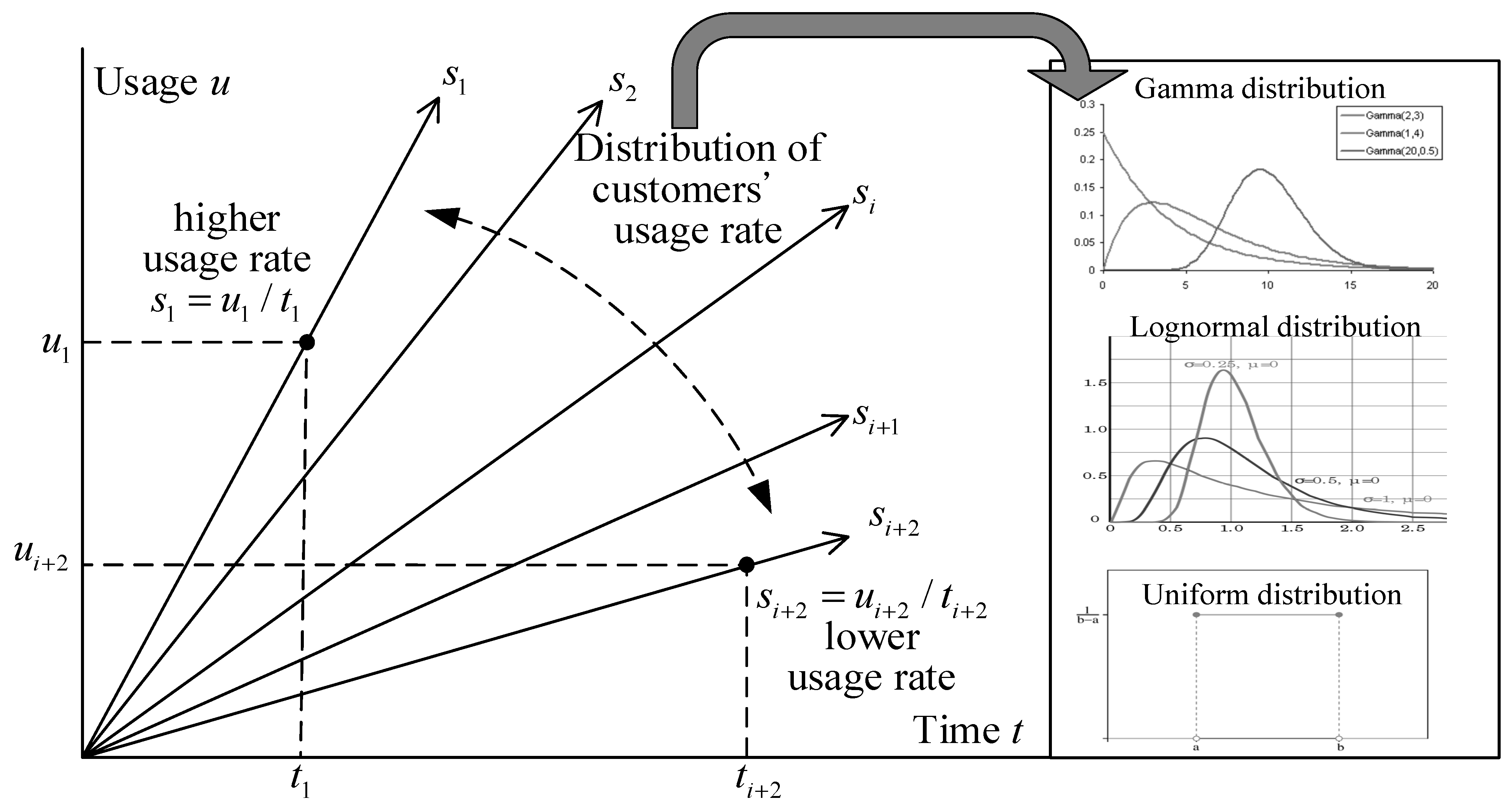

However, different customers have their custom, individual needs or usage style, and therefore the different customers’ lease facility will present different deteriorations under the same using time. In order to measure these deteriorations, a usage rate is defined as a ratio of the using time to the usage ( s = t / u ). In other words, it denotes the usage per unit time to the lease facility. Therefore, the usage rate s can be regarded as an indicator to measure the degree of customers’ usage. It is helpful to transform the two-variate model into the univariate model. Moreover, all the usage rates can be assumed to be distributed with a reasonable region. Accordingly, in this study, the probability distribution of the usage rate can be assumed to follow Gamma, Lognormal or Uniform distribution by investigating marketing and consumer surveys. Figure 1 illustrates the relation between the using time and the usage for the usage rate s .
Suppose that the usage rate is a random variable and approximately follows a Gamma distribution according to all lessees’ usage in practice, and therefore the estimation of the expected number of breakdowns can be expressed as follow:
E [ N b r | T L , Ψ G ( s ) , Θ ] = 0 T L 0 λ ( t , s , Θ ) Ψ G ( s | θ , γ ) d s d t = 0 T L 0 ( β t β 1 α β ) ( κ ( s t ) κ 1 ω κ ) ( s θ 1 e s / γ γ θ Γ ( θ ) ) d s d t = 0 T L β κ ( γ κ 1 t 2 ) ( Γ ( κ + θ 1 ) Γ ( θ ) ) ( t α ) β ( t ω ) κ d t = β κ ( γ κ 1 ( β + κ 1 ) T L ) ( Γ ( κ + θ 1 ) Γ ( θ ) ) ( T L α ) β ( T L ω ) κ ,
where Ψ G ( s | θ , γ ) is a Gamma probability density function under the parameters θ and γ , and its form can be expressed as
Ψ G ( s | θ , γ ) = ( s θ 1 e s / γ γ θ Γ ( θ ) ) . ( Γ ( θ ) = 0 y θ 1 e y d y )
If the usage rate approximately follow to a Lognormal distribution with the mean μ and the standard deviation σ from market surveys, the estimation of the expected number of breakdowns should be rewritten as follow:
E [ N b r | T L , Ψ L ( s ) , Θ ] = 0 T L 0 λ ( t , s , Θ ) Ψ L ( s | μ , σ ) d s d t = 0 T L 0 ( β t β 1 α β ) ( κ ( s t ) κ 1 ω κ ) ( 1 2 π σ s t e 1 2 ( l n [ s t ] μ σ ) 2 ) d s d t = 0 T L ( t / α ) β ( t / ω ) κ t 2 ( β κ e 1 2 ( κ 1 ) ( 2 μ + ( κ 1 ) σ 2 ) ) d t = ( T L α ) β ( T L ω ) κ e 1 2 ( κ 1 ) ( 2 μ + ( κ 1 ) σ 2 ) ( β + κ 1 ) T L ,
where Ψ L ( s | μ , σ ) is a Lognormal probability density function, and it can be expressed as
Ψ L ( s | μ , σ ) = ( 1 2 π σ s t e 1 2 ( l n [ s t ] μ σ ) 2 )
However, if the probability of the customers’ usage rate are equally distributed in a given range [ U 1 , U 2 ] , the estimation of the expected number of breakdowns can be expressed as follow:
E [ N b r | T L , Ψ U ( s | U 1 , U 2 ) , Θ ] = 0 T L U 1 U 2 λ ( t , s , Θ ) Ψ U ( s | U 1 , U 2 ) d s d t = 0 T L U 1 U 2 ( β t β 1 α β ) ( κ ( s t ) κ 1 ω κ ) ( 1 U 2 U 1 ) d s d t = β ( U 2 κ U 2 κ ) ( T L α ) β ( T L ω ) κ ( U 2 U 1 ) ( β + κ 1 ) T L ,
where Ψ U ( s | U 1 , U 2 ) is a Uniform probability density function with the upper bound U 1 and the lower bound U 2 , and its form can be expressed as
Ψ U ( s | U 1 , U 2 ) = ( 1 U 2 U 1 )
The following assumptions should be noticed before you employ the model of the study:
  • The leased facility deteriorates over time and usage, and an NHPP can describe the failure or breakdown process.
  • When a failure or breakdown appears during the leased period, a minimal repair is made. The facility would be immediately returned to its previous state following the repair.
  • Because the PM activities are imperfect, the leased facility‘s condition cannot be fully restored after PM.
  • The lessor is responsible for covering the costs of repairs and routine PM.
  • It is assumed that the usage rate of the leased facilities follows a Gamma, Lognormal or Uniform distribution.

2.2. Estimation of Related Costs under Periodic Preventive Maintenance

The reliability of leased facilities should be managed to an acceptable level when considering system safety and customer satisfaction. PM can be used to avoid potential disasters caused by catastrophic failures. It is possible to implement either a periodic or non-periodic PM policy in order to improve system reliability. As a result of this study, a schedule of periodic PM strategies has been included in the analysis. This is because it is more manageable for the manager. Moreover, it is assumed that the failure times of the leased facilities are derived from a non-homogeneous Poisson process (NHPP) with a specific intensity function and that they would undergo N 1 PM actions during the lease period T L , where the inter-PM times are designated to be x . After the timing N x , the lease contract will be terminated, and the entire system will be replaced. Based on this, the breakdown process of the system can be modeled by an NHPP with a bivariate Weibull distribution. Besides, in order to simplify the influence of repair time on the system age, the study assumes that the repair time can be negligible.
Suppose that the inter-PM time is set to x according to the maintenance engineers’ suggestion. In order to evaluate the effective age of the system, the symbols t k and t k + are used to denote the effective age before and after the kth PM action. We assume that the system can be partially recovered by a PM action and the degree of the recovery δ p m q can be measured by comparative deterioration experiments. The effective age of the system before the first PM action should be t 1 = x . However, after the first PM action, the effective age of the system will be immediately recovered as t 1 + = x δ p m q x = ( 1 δ p m q ) x . Based on this, the effective ages of the system immediately before and after the kth PM action can be derived as
t k = k x ( k 1 ) δ p m q x = ( k 1 ) ( 1 δ p m q ) x + x = ( ( k 1 ) ( 1 δ p m q ) + 1 ) x
and
t k + = t k δ p m q x = k x ( k 1 ) δ p m q x δ p m q x = k ( 1 δ p m q ) x
respectively.

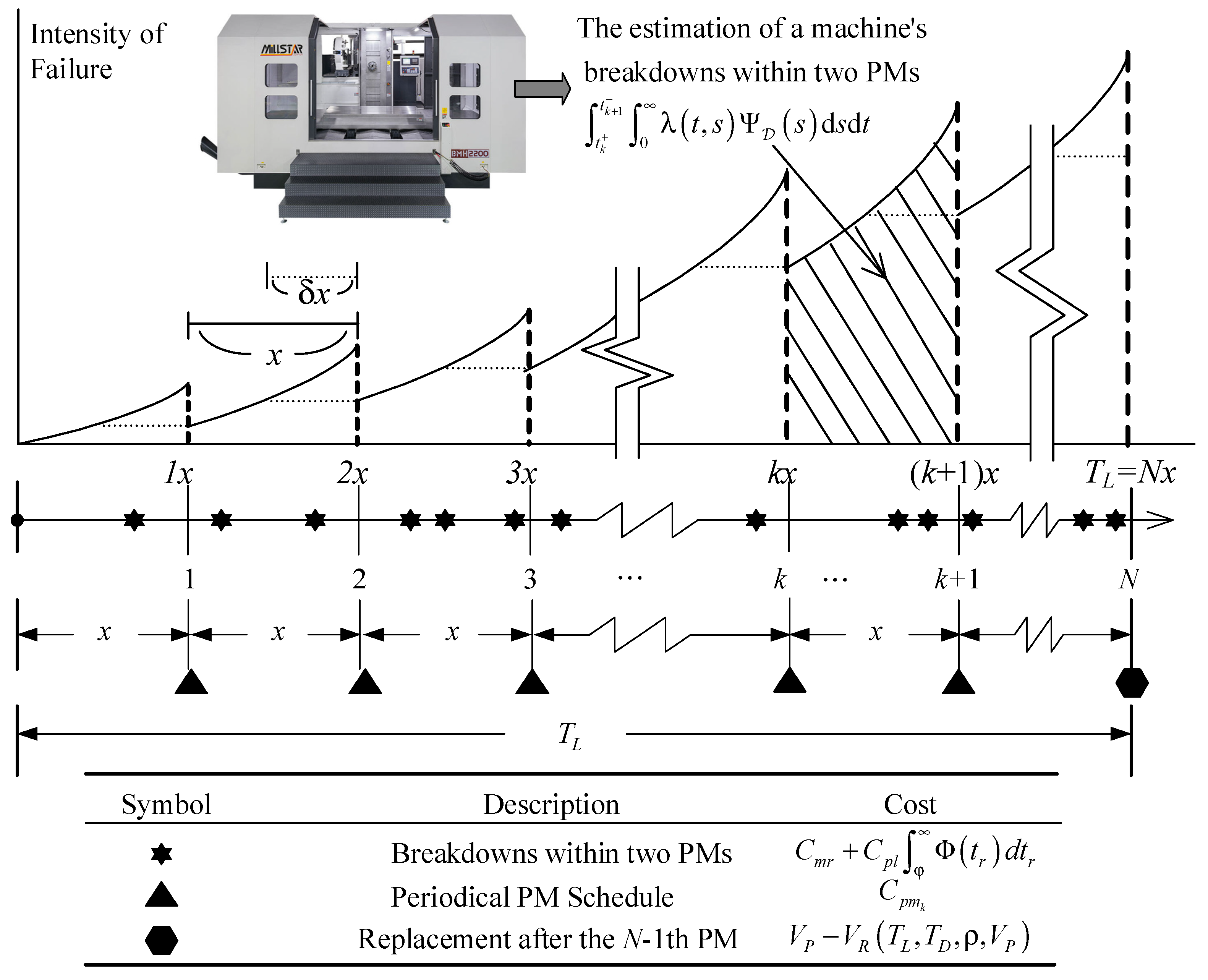

Figure 2 illustrates the timeline and breakdowns of a deteriorating system under the imperfect PM model.
During the lease period, the expected disbursement should include both the repair and preventive maintenance expenses. The concept of the repair cost consists of the two components: (1) the cost to perform a minimal repair ( C m r ); (2) the penalty cost ( C p l ) if the actual repair time exceed the tolerable waiting time φ . Based on the lessor’s responsibility, any failure or breakdown of the lease product (facility or equipment) by the lessor’s maintenance department. Furthermore, the repair time t r can be thought of as a random variable with a Gamma probability distribution. The following equation presents the probability function that the repair time t r is over the time limit φ .
Φ ( t r ) = φ η ω t r ω 1 Γ ( ω ) e η t r d t r
In order to estimate the probability of the overtime repair, it is necessary to evaluate the parameters ω and η in advance. Since the parameters ω and η are related to their expectation and variance, they can be calculated by ω = E ( t r ) 2 / σ ( t r ) 2 and η = E ( t r ) / σ ( t r ) 2 .
In order to evaluate the repair cost of the lease facility or equipment, the lessor must estimate the facility or equipment’s deterioration over the lease period. Based on the assumption that the facility or equipment’s failure process is an NHPP with a specific intensity function λ ( t , s , Θ ) , the expected number of failures for the lease period [ 0 ,   T L ] under PM interval x and age reduction δ is E [ N b r | T L , x , δ q , Ψ D ( s ) , Θ ] . In accordance with the mentioned above, the total repair cost during the leasing period can be calculated as follows:
( C m r + C p l φ Φ ( t r ) d t r ) E [ N b r | T L , x , δ , Ψ D ( s ) , Θ ] .
For preventive maintenance to be beneficial, the lessor should only perform it if the reduction of repair expense outweighs the maintenance cost. For sequential PM activities over the lease period, the maintenance costs will rise due to mechanical or electronic aging of the deteriorating system. According to Jayabalan and Chaudhuri [46], there is an approach to estimating maintenance costs per unit time during the lease period, and it can be calculated by:
C p m k = C F ( 1 + τ ( k 1 ) x )
where C F and τ respectively denote the base cost of proceeding with a PM and the increasing rate of the PM cost. As a result, the total PM cost should be given by
C p m ( C F , τ , x , T L ) = k = 1 T L / x 1 C p m k = k = 1 T L / x 1 C F ( 1 + τ ( k 1 ) x ) .
In addition, various preventive maintenance options will influence the system’s recovery, but will also raise the lessor’s PM costs. Suppose that the series of PM alternatives M P = { M P 1 ,   M P 2 ,   M P q , , M P Q } can be chosen, and the corresponding PM cost with the expected failure number can be rewritten as follows:
C p m q ( C F q , τ q , x , T L ) = k = 1 T L / x 1 C p m k q = k = 1 T L / x 1 C F q ( 1 + τ q ( k 1 ) x ) .
Accordingly, a failure of leased facility or equipment can be estimated based on the expected number during the lease period T L as follows:
E [ N b r | T L , x , δ p m q , Ψ D ( s ) , Θ ] = t 1 + t 2 ( 0 λ ( t , s , Θ ) Ψ D ( s ) d s ) d t + t 2 + t 3 ( 0 λ ( t , s , Θ ) Ψ D ( s ) d s ) d t + + t k + t k + 1 ( 0 λ ( t , s , Θ ) Ψ D ( s ) d s ) d t = k = 1 T L / x 1 t k + t k + 1 ( 0 λ ( t , s ) Ψ D ( s ) d s ) d t = k = 1 T L / x 1 k x ( k + 1 ) x ( 0 λ ( t k δ p m q x , s ) Ψ D ( s ) d s ) d t .

3. Optimal PM Decision to Facilities with and without Consideration of Financial Lease Contract Revenue

This section introduces the optimal decision of the multiple PM alternatives with and without considering a financial lease contract revenue. The proposed model can provide the best PM plan for lessors to reduce the related costs during the lease period by considering the lease revenue throughout the lease period and the residual value at the end. Furthermore, the analytical models and efficient solution algorithm will be provided for solving the issue of the leased facility with two-dimensional deterioration. Finally, in order to easily apply the models in a real scenario, a computerized system design is also proposed in this section.

3.1. Optimal PM without Consideration of Financial Lease Contract Revenue

Generally, the lessor not only provides lease facilities to customers (lessees) but also provides a free-repair warranty for increasing the customers’ satisfaction and reducing the related costs. Since a free-repair warranty would cover the costs of non-artificial damage or deterioration, the lessor must bear the expenses of repair, overtime, and preventive maintenance. Furthermore, due to the fact that the initial investment in lease facilities is the most significant expenditure for the lessor, he/her have to treat it as an amortized expenditure when calculating the average cost per unit of time, and the residual value of the lease facilities can be considered an investment deduction. However, if the lessor did not make the plan for the revenue of rent, the expected average cost per unit of time can be given by:
M i n   E C [ N | M P q ] = k = 1 T L / x 1 C p m k q + ( C m r + C p l φ Φ ( t r ) d t r ) E [ N b r | T L , x , δ p m q , Ψ D ( s ) , Θ ] + V P T L = k = 1 N 1 C p m k q + ( C m r + C p l φ Φ ( t r ) d t r ) E [ N b r | T L , x , δ p m q , Ψ D ( s ) , Θ ] + V P N x .
The convexity of the cost function E C [ N | M P q ] with respect to N can be justified if the two inequalities E C [ N + 1 | M P q ] E C [ N | M P q ] and E C [ N | M P q ] < E C [ N 1 | M P q ] both hold, and the optimal N * can therefore be obtained.
Proposition 1.
If the intensity function λ ( t , s , Θ ) is strictly increasing, and the two inequalities E C [ N + 1 | M P q ] E C [ N | M P q ] and E C [ N | M P q ] < E C [ N 1 | M P q ] are both hold, the convexity of the cost function E C [ N | M P q ] with respect to N can be assured.
Proof:
For E C [ N + 1 | M P q ] E C [ N | M P q ] , we have E C [ N + 1 | M P q ] E C [ N | M P q ] 0
k = 1 N C p m k q + ( C m r + C p l φ Φ ( t r ) d t r ) E [ N b r | ( N + 1 ) x , x , δ p m q , Ψ D ( s ) , Θ ] + V P ( N + 1 ) x k = 1 N 1 C p m k q + ( C m r + C p l φ Φ ( t r ) d t r ) E [ N b r | N x , x , δ p m q , Ψ D ( s ) , Θ ] + V P N x 0 k = 1 N C p m k q + ( C m r + C p l φ Φ ( t r ) d t r ) E [ N b r | ( N + 1 ) x , x , δ p m q , Ψ D ( s ) , Θ ] + V P ( N + 1 ) x ( N + 1 N ) { k = 1 N 1 C p m k q + ( C m r + C p l φ Φ ( t r ) d t r ) E [ N b r | N x , x , δ p m q , Ψ D ( s ) , Θ ] + V P } ( N + 1 ) x 0 ( C m r + C p l φ Φ ( t r ) d t r ) { E [ N b r | ( N + 1 ) x , x , δ p m q , Ψ D ( s ) , Θ ] ( 1 + 1 N ) E [ N b r | N x , x , δ p m q , Ψ D ( s ) , Θ ] } ( N + 1 ) x ( 1 N ) V P C p m N + ( 1 N ) k = 1 N 1 C p m k q ( N + 1 ) x ( C m r + C p l φ Φ ( t r ) d t r ) { E [ N b r | ( N + 1 ) x , x , δ p m q , Ψ D ( s ) , Θ ] ( 1 + 1 N ) E [ N b r | N x , x , δ p m q , Ψ D ( s ) , Θ ] } ( 1 N ) V P C p m N q + ( 1 N ) k = 1 N 1 C p m k q ( C m r + C p l φ Φ ( t r ) d t r ) { E [ N b r | ( N + 1 ) x , x , δ p m q , Ψ D ( s ) , Θ ] ( N + 1 ) E [ N b r | N x , x , δ p m q , Ψ D ( s ) , Θ ] } V P N C p m N q + k = 1 N 1 C p m k q N E [ N b r | ( N + 1 ) x , x , δ p m q , Ψ D ( s ) , Θ ] ( N + 1 ) E [ N b r | N x , x , δ p m q , Ψ D ( s ) , Θ ] V P N C p m N q + k = 1 N 1 C p m k q C m r + C p l φ Φ ( t r ) d t r
For E C [ N | M P q ] < E C [ N 1 | M P q ] , we have E C [ N | M P q ] ) E C [ N 1 | M P q ] < 0
k = 1 N 1 C p m k q + ( C m r + C p l φ Φ ( t r ) d t r ) E [ N b r | N x , x , δ p m q , Ψ D ( s ) , Θ ] + V P N x k = 1 N 2 C p m k q + ( C m r + C p l φ Φ ( t r ) d t r ) E [ N b r | ( N 1 ) x , x , δ p m q , Ψ D ( s ) , Θ ] + V P ( N 1 ) x < 0
( 1 1 N ) { k = 1 N 1 C p m k q + ( C m r + C p l φ Φ ( t r ) d t r ) E [ N b r | N x , x , δ p m q , Ψ D ( s ) , Θ ] + V P } ( N 1 ) x
k = 1 N 2 C p m k q + ( C m r + C p l φ Φ ( t r ) d t r ) E [ N b r | ( N 1 ) x , x , δ p m q , Ψ D ( s ) , Θ ] + V P ( N 1 ) x < 0
( 1 1 N ) k = 1 N 1 C p m k q + ( 1 1 N ) ( C m r + C p l φ Φ ( t r ) d t r ) E [ N b r | N x , x , δ p m q , Ψ D ( s ) , Θ ] + ( 1 1 N ) V P { k = 1 N 2 C p m k q + ( C m r + C p l φ Φ ( t r ) d t r ) E [ N b r | ( N 1 ) x , x , δ p m q , Ψ D ( s ) , Θ ] + V P } < 0
( C m r + C p l φ Φ ( t r ) d t r ) { ( N 1 N ) E [ N b r | N x , x , δ p m q , Ψ D ( s ) , Θ ] E [ N b r | ( N 1 ) x , x , δ p m q , Ψ D ( s ) , Θ ] } + ( N 1 N ) C p m N 1 q ( 1 N ) k = 1 N 2 C p m k q ( 1 N ) V P < 0
( C m r + C p l φ Φ ( t r ) d t r ) { ( N 1 N ) E [ N b r | N x , x , δ p m q , Ψ D ( s ) , Θ ] E [ N b r | ( N 1 ) x , x , δ p m q , Ψ D ( s ) , Θ ] } + ( N 1 N ) C p m N 1 q ( 1 N ) k = 1 N 2 C p m k q ( 1 N ) V P < 0
( N 1 ) E [ N b r | N x , x , δ p m q , Ψ D ( s ) , Θ ] N E [ N b r | ( N 1 ) x , x , δ p m q , Ψ D ( s ) , Θ ] < V P ( N 1 ) C p m N 1 q + k = 1 N 2 C p m k q ( C m r + C p l φ Φ ( t r ) d t r )
Let Δ ( N ) = N E [ N b r | ( N + 1 ) x , x , δ q , Ψ D ( s ) , Θ ] ( N + 1 ) E [ N b r | N x , x , δ q , Ψ D ( s ) , Θ ] for N Z + and Δ ( N ) = 0 for N = 0. Since Δ ( N ) is strictly increasing, it exists an N such that inequalities (20) and (21) would hold simultaneously, and such an N is the optimal number of periodic PM actions. Since the failure rate is increasing over time for deteriorating systems, i.e., λ ( t , s , Θ ) > λ ( 0 , s , Θ ) for t > 0 , we then have Δ ( N ) Δ ( N 1 ) = N { ( E [ N b r | ( N + 1 ) x , x , δ p m q , Ψ D ( s ) , Θ ] E [ N b r | N x , x , δ p m q , Ψ D ( s ) , Θ ] ) ( E [ N b r | N x , x , δ p m q , Ψ D ( s ) , Θ ] E [ N b r | ( N 1 ) x , x , δ p m q , Ψ D ( s ) , Θ ] ) } > 0 , and the convexity of the cost function E [ N b r | N x , x , δ q , Ψ D ( s ) , Θ ] with respect to N is thus assured.
Based on Proposition 1, the heuristic solution algorithm for obtaining the optimal cost can be briefly presented as follows:
  • Step 1: Initially, all the PM alternatives are given as the candidate list M P = { M P 1 ,   M P 2 , M P q , , M P Q } .
  • Step 2: Start with the first PM alternative ( q = 1 ), and the variable of the optimal expected cost E C * [ N * | M P q * ] is set to infinity.
  • Step 3: Set the PM number N = 1 and calculate the expected cost E C [ N | M P q ] .
  • Step 4: Calculate the expected cost E C [ N + 1 | M P q ] .
  • Step 5: Investigating whether the condition E C [ N + 1 | M P q ] E C [ N | M P q ] is supported or not? If it is supported, go to Step 6. Otherwise, go to Step 4 with N N + 1 .
  • Step 6: Set the optimal number as N * N , the optimal lease length as T L * N * x , and the variable of the optimal expected cost as E C * [ N * | M P q ] E C [ N | M P q ] .
  • Step 7: Investigating whether the condition E C * [ N * | M P q ] < E C * [ N * | M P q * ] is supported or not? If the answer is yes, go to Step 8. Otherwise, go to Step 9.
  • Step 8: Set the optimal PM alternative as q * q and the variable of the optimal expected cost as E C * [ N * | M P q * ] E C * [ N * | M P q ] .
  • Step 9: Investigating whether the condition q < Q has reached? If the answer is yes, go to Step 3 with q q + 1 . Otherwise, go to Step 10.
  • Step 10: Output the optimal solution (The best PM alternative q * , the optimal expected cost E C * [ N * | M P q * ] , the optimal lease length T L * ) E C [ N + 1 | M P q ] E C [ N | M P q ] .

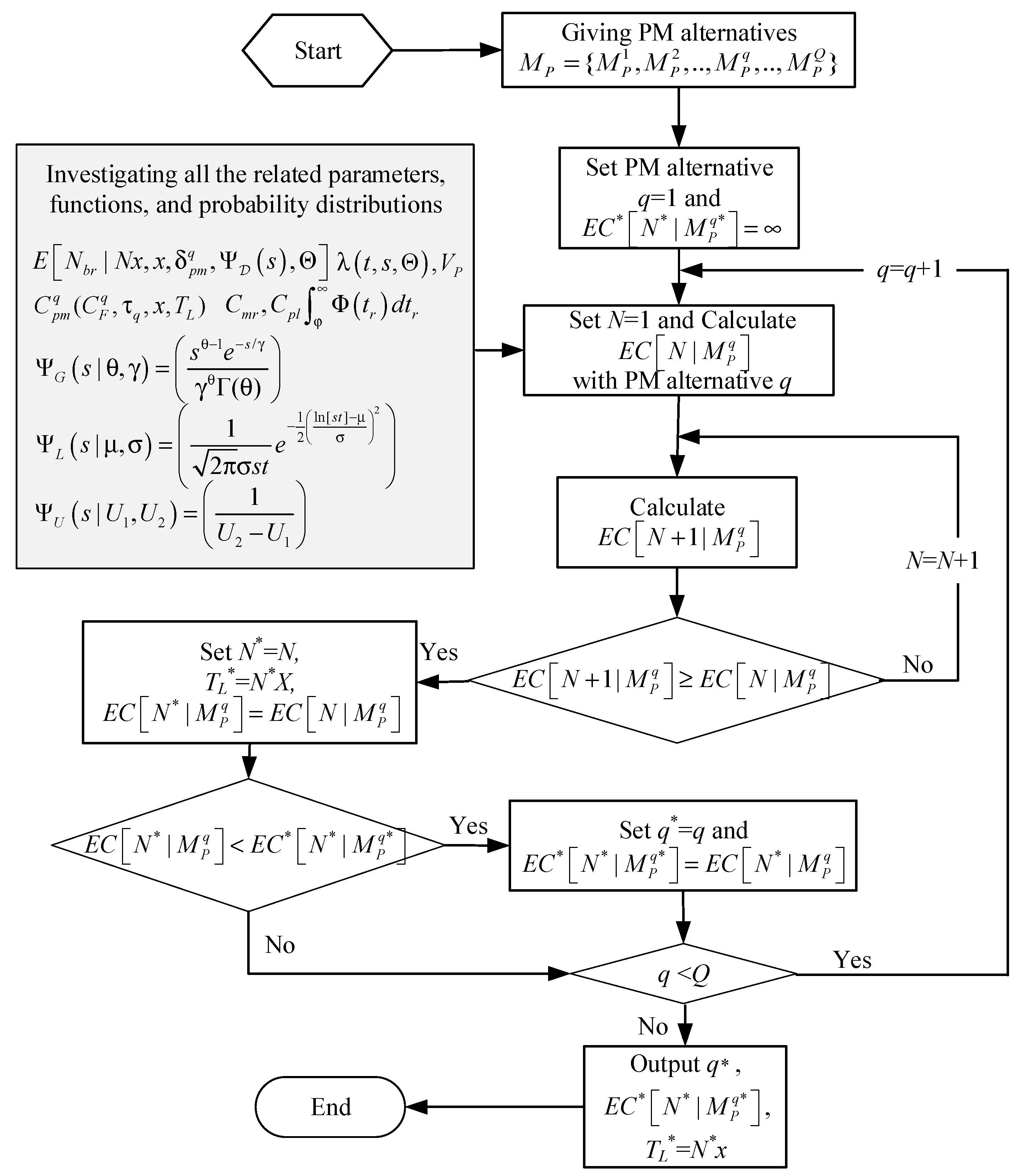

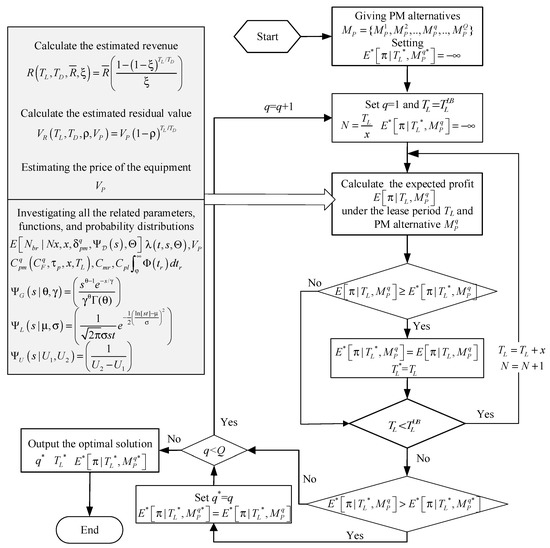

The above solution algorithm is illustrated in Figure 3.

3.2. Optimal PM with Consideration of Financial Lease Contract Revenue

As a result of some financial considerations, a company may rent some facilities instead of buying them. In order to increase customers’ satisfaction, the lessor will provide a free repair warranty on the lease contract. In order to effectively control the frequency of facility breakdowns and reduce the repair cost, the lessor has to make effective PM alternatives. In the previous section, the lessor only pursues the optimization from the cost perspective. However, there is no guarantee that low costs will lead to high profits. It depends on the lease revenue of the lease contract and the compensation of the residual value. Taking the revenue into account, the rent is R ( T L , T D , R ¯ , ξ ) with the discount rate ξ during the lease period T L . Suppose that the rent of each period T D is R ¯ . The payment of the lease facilities can be evaluated as follows:

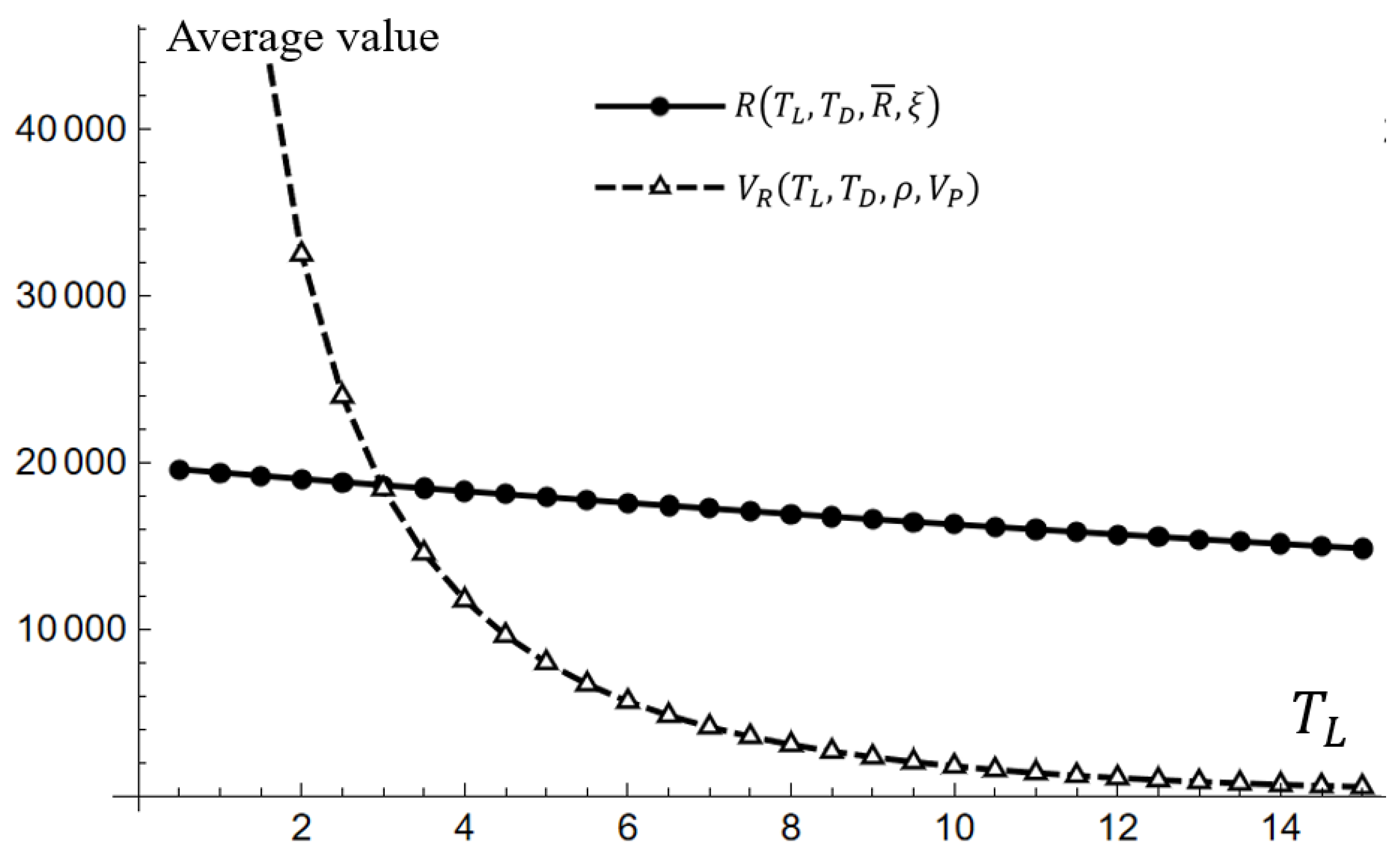

R ( T L , T D , R ¯ , ξ ) = R ¯ + R ¯ ( 1 ξ ) + R ¯ ( 1 ξ ) 2 + + R ¯ ( 1 ξ ) T L / T D 1 = R ¯ ( 1 ( 1 ξ ) T L / T D ξ ) .
In addition, the lessor may sell the old leased facility to retrieve a part of the original investment at the end of the lease period, as a result, the firm needs to estimate or evaluate the residual value of the leased facility. In other word, the residual value of a leased facility can be regarded as of a part of the revenue of the lease contract. In this study, a declining balance depreciation method is used to evaluate the residual value since the method is popular in most accounting systems. Based on the above-mentioned, the estimated residual value of the leased facility can be formulated as follow:
V R ( T L , T D , ρ , V P ) = V P ( 1 ρ ) T L / T D ,
In Equation (23), ρ is the depreciation rate of the leased facility after a time segment (year). Accordingly, the lessor’s profit can be formulated as follow:
M a x   E [ π | T L , M P q ] = ( 1 T L ) { R ( T L , T D , R ¯ , ξ ) + V R ( T L , T D , ρ , V P ) C p m q ( C F q , τ q , x , T L ) ( C m r + C p l φ Φ ( t r ) d t r ) E [ N b r | T L , x , δ q , Ψ D ( s ) , Θ ] V P } S u b j e c t   t o :     T L L B T L T L U B
T L U B and T L L B denote the upper and lower bounds of the leased facility’s lifetime, and the length of lease contract can’t exceed the leased facility’s lifetime. Accordingly, the heuristic solution algorithm for obtaining the optimal cost can be briefly presented as follows:
Step 1: Initially, all the PM alternatives are given as the candidate list M P = { M P 1 ,   M P 2 , M P q , , M P Q } and set the variable E * [ π | T L * , M P q * ] .
Step 2: Start with the first PM alternative ( q = 1 ), and set T L T L L B , N T L / x , and E * [ π | T L * , M P q ] .
Step 3: Calculate the expected profit E [ π | T L , M P q ] under the lease period T L and the PM alternative M P q .
Step 4: Investigating whether the condition E [ π | T L , M P q ] E * [ π | T L * , M P q ] is supported or not? If it is supported, go to Step 5. Otherwise, go to Step 6.
Step 5: Set E * [ π | T L * , M P q ] E [ π | T L , M P q ] and T L * T L .
Step 6: Investigating whether the condition T L < T L U B has reached or not? If yes, calculate T L T L + x and N N + 1 , and then go to Step 3. Otherwise, go to Step 7.
Step 7: Investigating whether the condition E * [ π | T L * , M P q ] > E * [ π | T L * , M P q * ] is supported or not? If it is supported, go to Step 8. Otherwise, go to Step 9.
Step 8: Set q * q and E * [ π | T L * , M P q * ] E * [ π | T L * , M P q ] .
Step 9: Investigating whether the condition q < Q has reached or not? If yes, set q q + 1 and then go to Step 2. Otherwise, go to Step 10.
Step 10: Output the optimal solution (The best PM alternative q * , the optimal lease length T L * , the optimal expected profit E * [ π | T L * , M P q * ] )

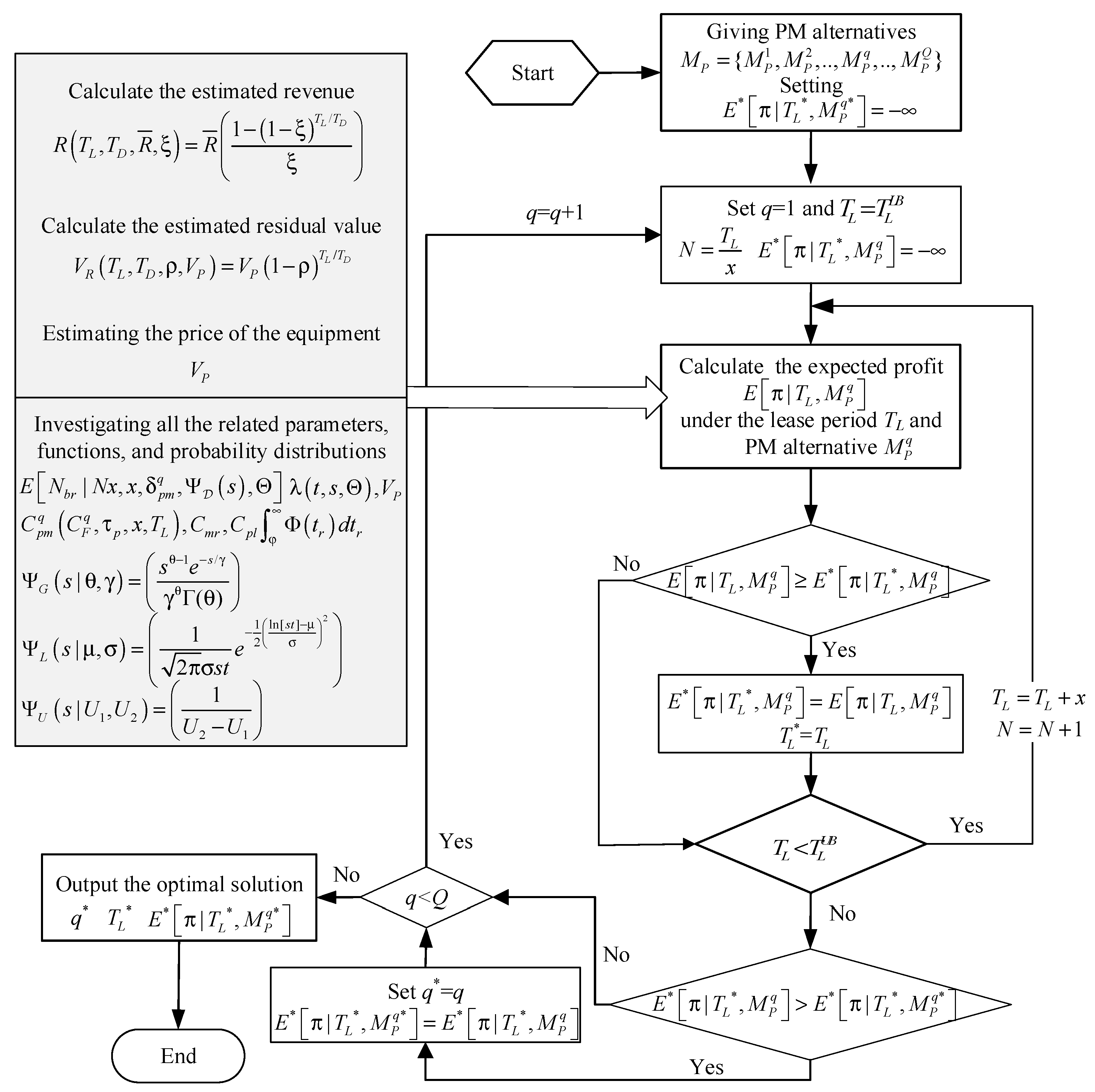

The above solution algorithm can be illustrated as Figure 4.

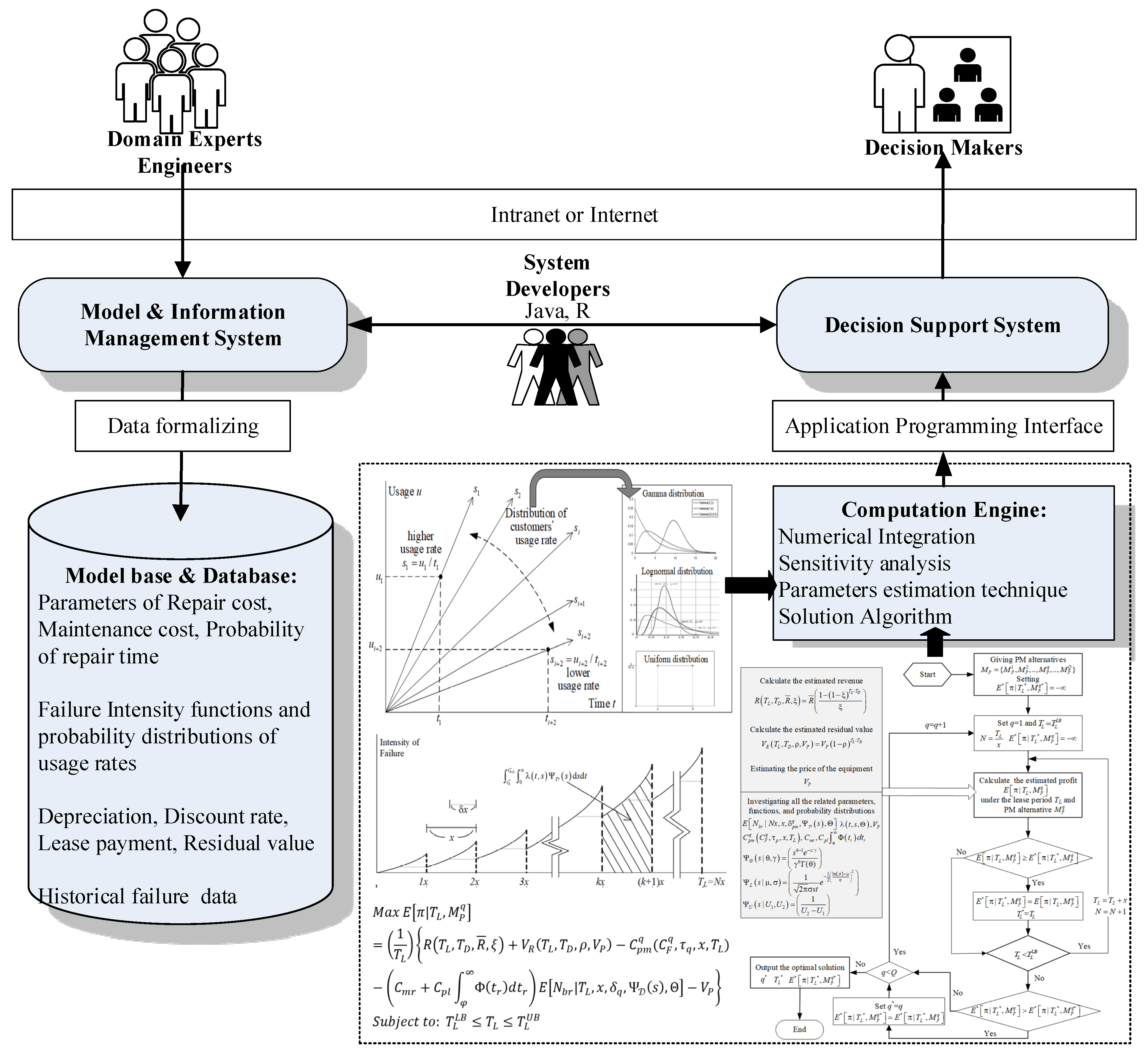

3.3. Computerized Decision Support System Design

To obtain the optimal decision in such complicated mathematical problems, a computerized application would be required. In order to enhance the manageability of the whole application, it can be designed as the two independent systems (the model and information management system and the decision support system). The model and information management system is mainly used to store the failure datasets to estimate the values of deteriorating model parameters. Furthermore, the different PM alternatives’ parameters’ values, customers’ usage patterns, the corresponding probability distributions, and all the related costs and revenues are also critical to the cost or profit analyses. In order to store and retrieve all the information more conveniently and efficiently, the system developers have to design a data formalization mechanism, and it might be different from a traditional relational database because some data present hierarchical structure. After investigating and obtaining all the required information, the firm’s domain experts and engineers can use the model and information management system to store, retrieve, maintain, and analyze them. Moreover, in order to provide useful information and suggestion to the firm’s managers, the decision support system is required in practice. In order to deal with the estimation of parameters, solution algorithm, numeric integration, graphic presentation, and sensitivity analyses, computation engines will be needed for analyzing all the candidate alternatives. Such computation engines can be developed by the R projects’ package, and the system developers/programmers can write Java codes to apply them through an application programming interface (API). The computerized implementation architecture of our system is shown in Figure 5.

4. Application and Sensitivity Analysis

4.1. Application

Assume an industrial equipment maker (lessor) proposes a capital leasing project to attract consumers in the industrial equipment market since most companies or organizations prefer to lease rather than buy for financial and tax reasons. During the lease period, the industrial equipment maker will provide a preventive maintenance and free repair service to consumers (lessee). Due to the fact that the machinery equipment’s deterioration is not only influenced by time but also influenced by usage, the domain experts and engineers will evaluate the characteristics of the machine’s degradation. After the evaluation, the domain experts and engineers consider that the machine’s deterioration will follow the bivariate Weibull process, and its model parameters can be estimated from the historical data which was produced by some accelerated deterioration experiments. Besides, the lessees are heterogeneous due to their custom and usage. We assume that the lessees usage rates s may follow a Gamma distribution with E ( s ) = 1.5 and σ ( s ) 2 = 0.7 .
Furthermore, since the repair time is not constant and it will be influenced by the degree of a machine’s breakdown, the repair time is need to be estimated first. However, the time for some repair works may exceed the tolerable limit due to serious breakdowns, and it will cause the increase in the penalty cost. The probability of the repair time over the tolerable limit can be evaluated by the reliability engineers. After the evaluation, the expected value E ( t r ) and standard deviation σ ( t r ) of performing a repair are estimated as 9 h and 5 h, respectively.
Moreover, the reliability engineers recommend six distinct PM alternatives, each of which will result in different expenditures and systems’ recovery during the lease period. Although alternative 6’s age reduction factor is greater than the other alternatives, its PM cost and increasing rate are also higher than the others. As a result, determining which PM alternative is preferable for the lessor is difficult. Because the lease length of the contract has an influence on the revenue, residual value, and associated costs, the lessor should carefully choose a PM alternative and the lease length to optimize its average profit. Based on the foregoing, Table 2 presents thorough information on the six PM alternatives, together with expert evaluations on the leasing equipment’s deterioration.

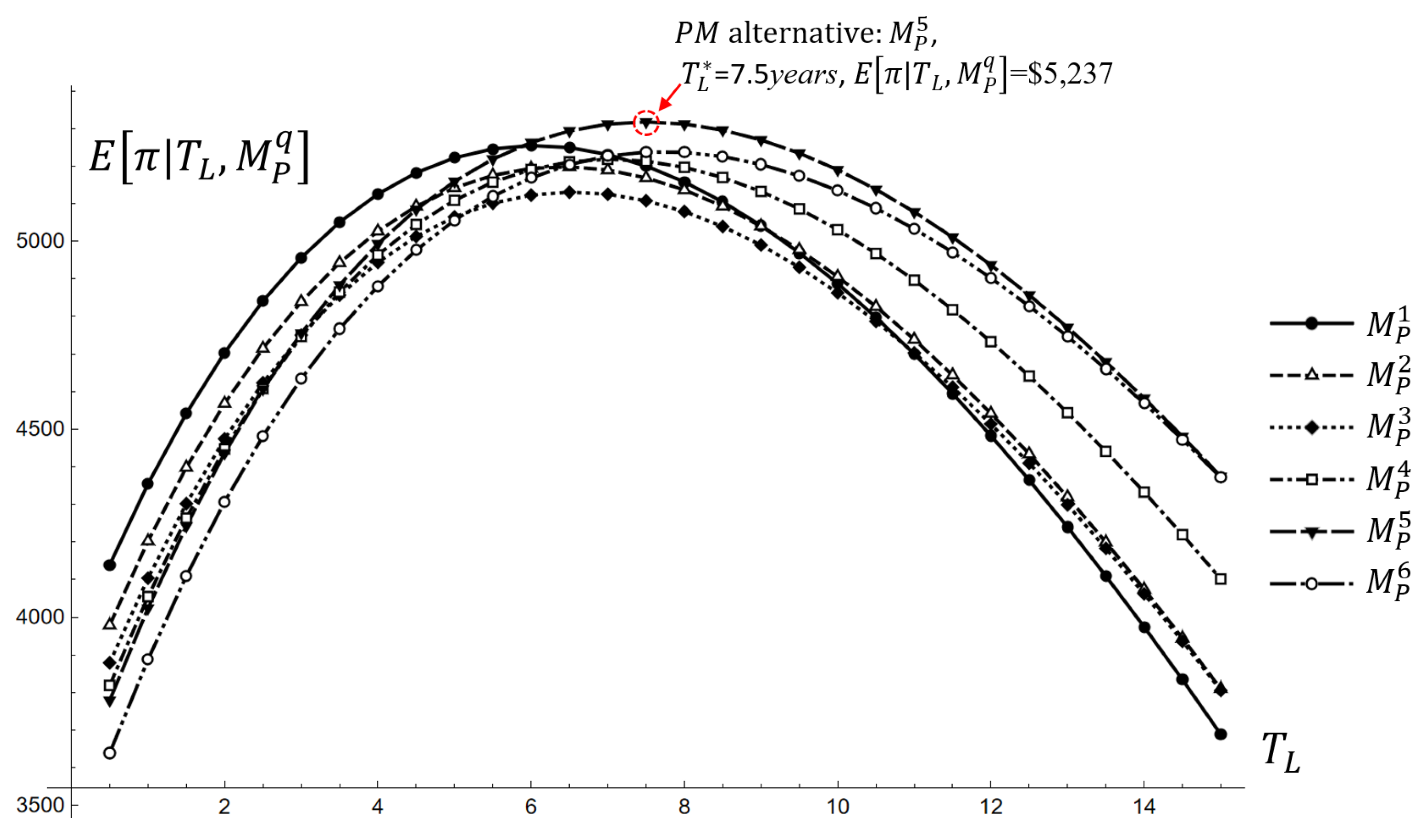

After performing the proposed heuristic algorithm presented in Figure 4, the numerical results are shown in Figure 6. According to Table 3, the ideal lease lengths for the six PM alternatives should be 6, 6.5 6.5, 7, 7.5, and 7.5 years, with average earnings of $5254, $5198, $5130, $5217, $5317, and $5237 per unit. It is obvious that PM alternative 5 is the best option for the lessor, and the optimal lease length is about 7.5 years. As a result, it can be observed that the extremely intensive PM alternative may not have a positive influence on earnings. In general, the highest intensive PM alternatives can lower failure times while saving money on repairs. However, the cost savings from repairs cannot fully remedy the increase in PM costs. According to Table 3, we can see that the profit of PM alternative 6 is lower than that of PM alternatives 1 and 4. Accordingly, it is difficult to judge which PM alternative is best by intuition. Although a lower-intensive PM alternative will result in major failures during the post-phase, the lessor can avoid this disadvantage by opting for a shorter lease period if the lessor is subject to accepting a lower-intensive PM alternative due to the lack of critical replaceable components. It can be seen that once the lease length exceeds 6 years, the average profit of PM alternative 5 is higher than that of the other alternatives. However, before the time point, PM alternative 5 is not always more advantageous than others. Accordingly, if the lessor needs to shorten the lease length for some reason, PM alternative 1 (lowest intensive PM) will be the best choice for less than six years. For example, the customers may not accept a long-term lease contract, and therefore the lessor can make an appropriate contract with different customers through negotiation. Besides, from the aspect of the expenditures, the optimal lease length may be longer than 7.5 years because the average of the accumulated depreciation ( ( V P V R ( T L , T D , ρ , V P ) ) / T L ) presents a rapidly increasing trend before 9 years in Figure 7. Accordingly, different aspects will influence the lessor to make different decisions.

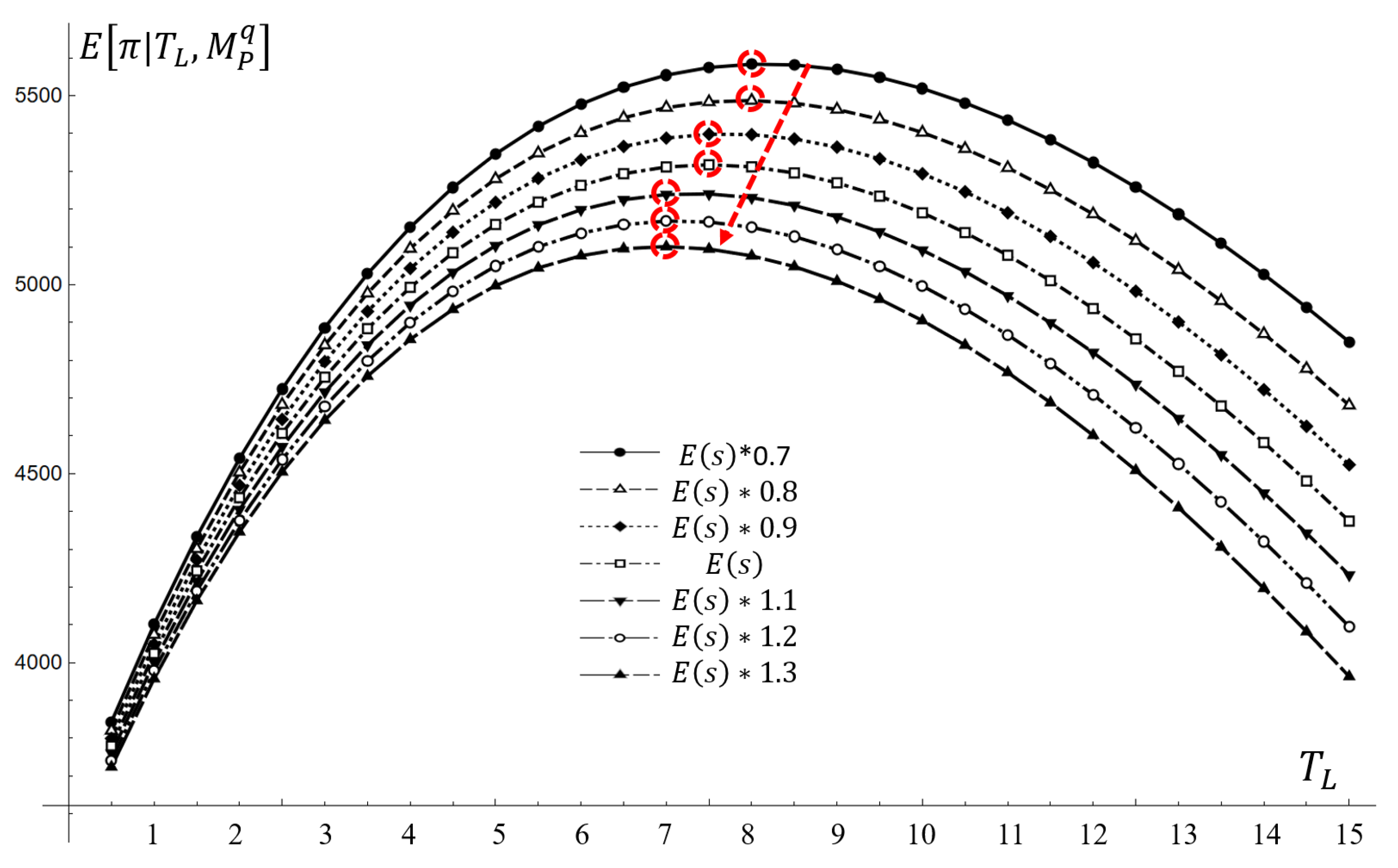

4.2. Sensitivity Analysis

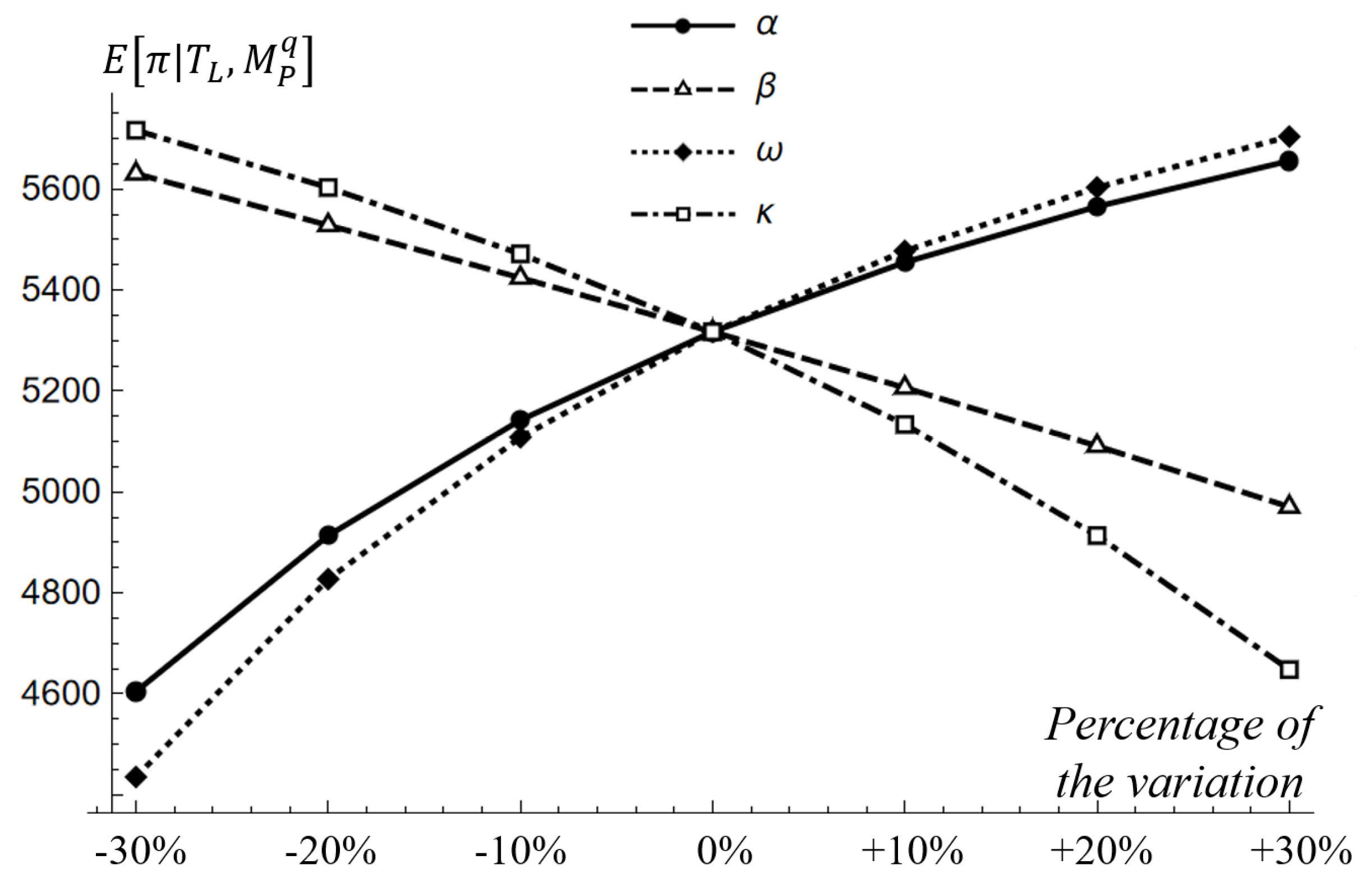

The estimation of the scale and shape parameters α , ω , β and κ may be inaccurate due to insufficient data from deterioration experiments. Therefore, the inaccurate estimation will have an influence on the prediction of the average profit and related costs, thus the lessor should be aware of any changes in the estimations. As a result, sensitivity analysis can be used to assess differences in estimated average profit. Furthermore, it is logical to assume that if we underestimate these parameters’ value, the estimated repair cost will also be inaccurate and it leads to incorrect decisions such as incorrectly extending or shortening the lease length. Figure 8 presents the impact of the scale and shape parameters α , ω , β and κ on the expected profit. According to Figure 8, if the scale parameters α and ω are estimated to be larger, the profits are also estimated to be amplified because the number of breakdowns is underestimated. On the contrary, the overestimation of the shape parameters β and κ would cause the underestimation of the estimated profit. Moreover, the impact of the parameters regarding usage ( ω , κ ) is more than that of the parameters regarding time ( α , β ). In other words, the deterioration of usage is more than that of time, and the lessor should pay attention to the improvement of the related usage components to mitigate the deterioration.

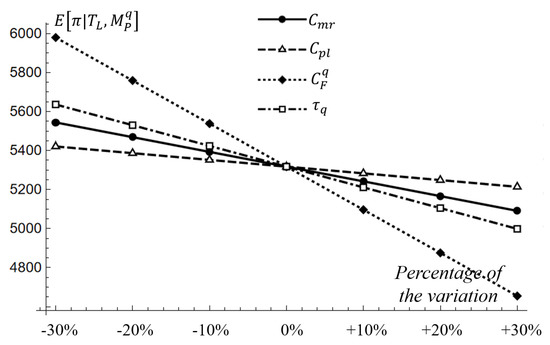

Furthermore, since the variation of the related costs and the parameters of PM might impact the expected profit and the decision-making, the lessor should be aware of any changes in the related costs. Figure 9 depicts the impact of the parameters C m r , C p l , C F q and τ q on the expected profit. According to Figure 9, the base cost of PM ( C F q ) is more sensitive than the repair cost and the penalty cost. It is because the lessor takes a high intensive PM alternative, and such high intensive PM can effectively reduce the repair and penalty cost but it also increases the lessor’s PM cost. Accordingly, the lessor must balance the two costs to make the best decision. Moreover, the lessor should also consider to shortening the lease length to respond to the increase of repair and penalty costs when the lessor adopted a low intensive PM alternative. Besides, the growing rate of PM cost may rise due to the inflation of linked prices. The impact will be increased as the lease length increases. Accordingly, as the base cost of PM rises, the optimal lease length should be shortened to reduce the burden of PM costs.
Since different customers (lessees) have their individual needs or usage style, their lease facility will present different deteriorations and different numbers of failures under the same lease length. For measuring the impact of these different customers on the facility’s deterioration, the usage rate is a useful indicator for calculating the different customers’ lease facility breakdowns. Figure 10 depicts the impact of the customers’ average usage rate on the expected profit. In this case, the usage rate is assumed to be a Gamma distribution with E ( s ) = 1.5 and σ ( s ) 2 = 0.7 . According to Figure 10, if E ( s ) is higher, the lease length should be shortened for obtaining the optimal expected profit. According to the information in Table 4, we can see −30%~+30% of E ( s ) to map to the optimal lease lengths 8, 8, 7.5, 7.5, 7, 7, 7 years to obtain the profits $5583, $5487, $5398, $5317, $5238, $5168, $5101. This sensitive result reflects that the degree of usage deterioration is higher than the degree of time deterioration in this case. However, the impact of σ ( s ) on the expected profit seems insensitive, and therefore the variation of σ ( s ) would not change the decision of the lease length in this case.

5. Conclusions

For the purpose of this study, we provide analytical models and to provide efficient solution algorithms for solving the problem of two-dimensional deterioration in leased facilities. As a result of the proposed model, a PM scheme can be designed to reduce the associated costs within the lease period. Besides, the income from leasing revenues as well as the residual value of the leased facilities at the end of the lease term is also taken into consideration throughout the entire lease period. It is contemplated that a nonhomogeneous Poisson process can be used to describe the successive failure times of the deteriorating leased facility. The limitation of the study is that the failure process of leased facilities must behave non-homogeneous Poisson process. The main advantage of the proposed method is to integrate all the related issues into a decision model with consideration of the heterogeneity of lessees and the two-dimensional deterioration. Moreover, the proposed computerized system design and efficient solution algorithms can help the proposed study to be applied in lease industries in practice. However, there is a disadvantage to relying on the proposed method. Once the historical deterioration data is insufficient, the proposed method cannot accurately estimate the related costs of leased facilities’ failures.
Based on the discussion of the mathematical and sensitivity analyses of Section 4, the main findings and managerial insights can be summarized as follows: (1) The lessor should carefully analyze all candidate PM alternatives to decide the lease length for obtaining the best solution because all the related factors compound and interact with each other. Without numerical analyses, it is difficult to judge by experts’ experience and intuition. (2) Lower intensive PM alternatives will result in major failures during the post-phase. Therefore, when the lessor is subject to accepting a lower intensive PM alternative due to the lack of critical replaceable components. He can set a shorter length of the lease contract for the customers to avoid this disadvantage. (3) In general, higher intensive PM alternatives can lower failure times to save money on repairs. However, extremely intensive PM alternatives may not have a positive influence on earnings because the cost savings from repairs cannot fully remedy the increase in PM costs. (4) In some cases, customers may not accept a long-term lease contract. Therefore the lessor can make an appropriate lease contract of a customized PM alternative with negotiation. (5) If the scale parameters of the two-Weibull distribution are estimated to be larger, the profits will be amplified. On the contrary, the overestimation of the shape parameters of the two-Weibull distribution would cause the underestimation of the estimated profit. Therefore, the inaccurate estimation of the parameters will influence on the prediction of the average profit and related costs. The lessor should pay more attention to the possible changes in these parameters. (6) The growing rate of PM cost may rise due to the inflation of linked prices. The impact will be increased as the lease length increases. Therefore, as the base cost of PM rises, the optimal lease length should be shortened to reduce the burden of PM costs. (7) In some cases, if the degree of usage deterioration is higher than the degree of time, the lessor should pay attention to improving the related usage components to mitigate the deterioration. (8) In most cases, the impact of the standard deviation of usage rate on the expected profit is insensitive, but the increase of the standard deviation of usage rate will amplify the uncertainty of the estimation of the related costs, and the lessor needs more preparation for this.
Recently, the demand for second-hand facilities has increased due to the rise of second-hand markets, customers continue to be in doubt as to their quality and durability. As a result of further research, we can refine the proposed model to address the issue of second-hand facilities in the future. For lessors, offering a warranty on their facilities could reduce this uncertainty. Accordingly, lessors of second-hand electronic equipment, furniture, automobiles, etc., would be wise to consider offering a warranty in order to increase their marketing potential on second-hand facilities. Decision-makers can also use such an analytical model to refine their marketing strategies as a result of such a model.

Author Contributions

Conceptualization, C.-C.F., J.-H.L. and C.-C.H.; Data Curation, C.-C.F., J.-H.L. and C.-C.H.; Formal Analysis, C.-C.F., J.-H.L. and C.-C.H.; Funding Acquisition, C.-C.F.; Investigation, C.-C.F.; Methodology, C.-C.F., J.-H.L. and C.-C.H.; Project Administration, C.-C.F. and J.-H.L.; Resources, C.-C.F., J.-H.L. and C.-C.H.; Supervision, C.-C.F.; Writing—Review and Editing, C.-C.F., J.-H.L. and C.-C.H. All authors have read and agreed to the published version of the manuscript.

Funding

This work was sponsored by Zhaoqing University’s Science Foundation and Guangdong Basic and Applied Basic Research Foundation, China [grant number 2020A1515010892].

Institutional Review Board Statement

Not applicable.

Informed Consent Statement

Not applicable.

Data Availability Statement

Not applicable.

Conflicts of Interest

The authors declare no conflict of interest.

References

  1. Pongpech, J.; Murthy, D.N.P. Optimal periodic preventive maintenance policy for leased equipment. Reliab. Eng. Syst. Saf. 2006, 91, 772–777. [Google Scholar] [CrossRef]
  2. Nisbet, A.; Ward, A. Radiotherapy equipment–purchase or lease? Br. J. Radiol. 2001, 74, 735–744. [Google Scholar] [CrossRef] [PubMed]
  3. Aras, N.; Güllü, R.; Yürülemz, S. Optimal inventory and pricing policies for remanufacturable leased products. Int. J. Prod. Econ. 2011, 133, 262–271. [Google Scholar] [CrossRef]
  4. Bourjade, S.; Huc, R.; Muller-Vibes, C. Leasing and profitability: Empirical evidence from the airline industry. Transp. Res. Part A 2017, 97, 30–46. [Google Scholar] [CrossRef]
  5. Yeh, R.H.; Kao, K.C.; Chang, W.L. Preventive-maintenance policy for leased products under various maintenance costs. Expert Syst. Appl. 2011, 38, 3558–3562. [Google Scholar] [CrossRef]
  6. Schutz, J.; Rezg, N. Maintenance strategy for leased equipment. Comput. Ind. Eng. 2013, 66, 593–600. [Google Scholar] [CrossRef]
  7. Ben Mabrouk, A.; Chelbi, A.; Radhoui, M. Optimal imperfect maintenance strategy for leased equipment. Int. J. Prod. Econ. 2016, 178, 57–64. [Google Scholar] [CrossRef]
  8. Iskandar, B.P.; Husniah, H. Optimal preventive maintenance for a two dimensional lease contract. Comput. Ind. Eng. 2017, 113, 693–703. [Google Scholar] [CrossRef]
  9. Zhang, Y.; Zhang, X.; Zeng, J.; Wang, J.; Xue, S. Lessees’ satisfaction and optimal condition-based maintenance policy for leased system. Reliab. Eng. Syst. Saf. 2019, 191, 106532. [Google Scholar] [CrossRef]
  10. Liu, B.; Wang, Y.; Yang, H.; Segerstedt, A.; Zhang, L. Maintenance service strategy for leased equipment: Integrating lessor-preventive maintenance and lessee-careful protection efforts. Comput. Ind. Eng. 2021, 156, 107257. [Google Scholar] [CrossRef]
  11. Park, D.H.; Jung, G.M.; Yum, J.K. Cost minimization for periodic maintenance policy of a system subject to slow degradation. Reliab. Eng. Syst. Saf. 2000, 68, 105–112. [Google Scholar] [CrossRef]
  12. Yeh, R.H.; Lo, H.C. Optimal preventive-maintenance warranty policy for repairable products. Eur. J. Oper. Res. 2001, 134, 59–69. [Google Scholar] [CrossRef]
  13. Jung, G.M.; Park, D.H. Optimal maintenance policies during the post-warranty period. Reliab. Eng. Syst. Saf. 2003, 82, 173–185. [Google Scholar] [CrossRef]
  14. Seo, J.H.; Bai, D.S. An optimal maintenance policy for a system under periodic overhaul. Math. Comput. Model. 2004, 39, 373–380. [Google Scholar] [CrossRef]
  15. Yeh, R.H.; Chang, W.L. Optimal threshold value of failure-rate for Leased products with preventive maintenance actions. Math. Comput. Model. 2007, 46, 730–737. [Google Scholar] [CrossRef]
  16. Hu, F.; Zong, Q. Optimal periodic preventive maintenance policy and lease period for leased equipment. J. Tianjin Univ. Sci. Technol. 2008, 41, 248–253. [Google Scholar]
  17. Das, A.N.; Sarmah, A.N. Preventive replacement models: An overview and their application in process industries. Eur. J. Ind. Eng. 2010, 4, 280–307. [Google Scholar] [CrossRef]
  18. Chang, W.L.; Lo, H.C. Joint determination of lease period and preventive maintenance policy for leased equipment with residual value. Comput. Ind. Eng. 2011, 61, 489–496. [Google Scholar] [CrossRef]
  19. Bouguera, S.; Chelbi, A.; Rezg, N. A decision model for adopting an extended warranty under different maintenance policies. Int. J. Prod. Econ. 2012, 135, 840–849. [Google Scholar] [CrossRef]
  20. Chang, W.L.; Lin, J.H. Optimal maintenance policy and length of extended warranty within the life cycle of products. Comput. Math. Appl. 2012, 63, 144–150. [Google Scholar] [CrossRef] [Green Version]
  21. Kim, B.S.; Ozturkoglu, Y. Scheduling a single machine with multiple preventive maintenance activities and position-based deteriorations using genetic algorithms. Int. J. Adv. Manuf. Technol. 2013, 67, 1127–1137. [Google Scholar] [CrossRef]
  22. Shafiee, M.; Finkelstein, M.; Zuo, M. Optimal burn-in and preventive maintenance warranty strategies with time-dependent maintenance costs. IIE Trans. 2013, 45, 1024–1033. [Google Scholar] [CrossRef]
  23. Khojandi, A.; Maillart, L.M.; Prokopyev, O.A. Optimal planning of life-depleting maintenance activities. IIE Trans. 2014, 46, 636–652. [Google Scholar] [CrossRef]
  24. Yuan, X.; Lu, Z. Efficient approach for reliability-based optimization based on weighted importance sampling approach. Reliab. Eng. Syst. Saf. 2014, 132, 107–114. [Google Scholar] [CrossRef]
  25. Lu, B.; Zhou, X.; Li, Y. Joint modeling of preventive maintenance and quality improvement for deteriorating single-machine manufacturing systems. Comput. Ind. Eng. 2016, 91, 188–196. [Google Scholar] [CrossRef]
  26. Wang, K.; Djurdjanovic, D. Joint Optimization of Preventive Maintenance, Spare Parts Inventory and Transportation Options for Systems of Geographically Distributed Assets. Machines 2018, 6, 55. [Google Scholar] [CrossRef] [Green Version]
  27. Zhou, Y.; Kou, G.; Xiao, H.; Peng, Y.; Alsaadi, F.E. Sequential imperfect preventive maintenance model with failure intensity reduction with an application to urban buses. Reliab. Eng. Syst. Saf. 2020, 198, 106871. [Google Scholar] [CrossRef]
  28. García, F.J.Á.; Salgado, D.R. Analysis of the Influence of Component Type and Operating Condition on the Selection of Preventive Maintenance Strategy in Multistage Industrial Machines: A Case Study. Machines 2022, 10, 385. [Google Scholar] [CrossRef]
  29. Alrifaey, M.; Sai Hong, T.; As’arry, A.; Elianddy Supeni, E.; Ang, C.K. Optimization and Selection of Maintenance Policies in an Electrical Gas Turbine Generator Based on the Hybrid Reliability-Centered Maintenance (RCM) Model. Processes 2020, 8, 670. [Google Scholar] [CrossRef]
  30. Tsarouhas, P. Reliability, Availability, and Maintainability (RAM) Study of an Ice Cream Industry. Appl. Sci. 2020, 10, 4265. [Google Scholar] [CrossRef]
  31. Lastra, R.; Pereira, A.; Díaz-Cacho, M.; Acevedo, J.; Collazo, A. Spare Parts Made by Additive Manufacturing to Improve Preventive Maintenance. Appl. Sci. 2022, 12, 10564. [Google Scholar] [CrossRef]
  32. Diatte, K.; O’Halloran, B.; Van Bossuyt, D.L. The Integration of Reliability, Availability, and Maintainability into Model-Based Systems Engineering. Systems 2022, 10, 101. [Google Scholar] [CrossRef]
  33. Baik, J.; Murthy, D.N.P.; Jack, N. Two-dimensional failure modeling with minimal repair. Nav. Res. Logist. 2004, 51, 345–362. [Google Scholar] [CrossRef]
  34. He, Z.; Loh, H.T.; Xie, M. A two-dimensional probability model for evaluating reliability of piezoelectric micro-actuators. Int. J. Fatigue 2007, 29, 245–253. [Google Scholar] [CrossRef]
  35. Murthy, D.N.P.; Iskandar, B.P.; Wilson, S.P. Two-dimensional failure-free warranty policies: Two-dimensional point process models. Oper. Res. 1995, 43, 356–366. [Google Scholar] [CrossRef]
  36. Kim, H.G.; Rao, B.M. Expected warranty cost of two-attribute free-replacement warranties based on a bivariate exponential distribution. Comput. Ind. Eng. 2000, 38, 425–434. [Google Scholar] [CrossRef]
  37. Pal, S.; Murthy, G.S.R. An application of Gumbel’s bivariate exponential distribution in estimation of warranty cost of motor cycles. Int. J. Qual. Reliab. Manag. 2003, 20, 488–502. [Google Scholar] [CrossRef]
  38. Shahanaghi, K.; Noorossana, R.; Jalali-Naini, S.G.; Heydari, M. Failure modeling and optimizing preventive maintenance strategy during two-dimensional extended warranty contracts. Eng. Fail. Anal. 2013, 28, 90–102. [Google Scholar] [CrossRef]
  39. Huang, Y.S.; Gau, W.Y.; Ho, J.W. Cost analysis of two-dimensional warranty for products with periodic preventive maintenance. Reliab. Eng. Syst. Saf. 2015, 134, 51–58. [Google Scholar] [CrossRef]
  40. Huang, Y.S.; Huang, D.D.; Ho, J.W. A customized two-dimensional extended warranty with preventive maintenance. Eur. J. Oper. Res. 2017, 257, 971–978. [Google Scholar] [CrossRef]
  41. Park, M.; Jung, K.M.; Park, D.H. Optimization of periodic preventive maintenance policy following the expiration of two-dimensional warranty. Reliab. Eng. Syst. Saf. 2018, 170, 1–9. [Google Scholar] [CrossRef]
  42. Dong, E.; Gao, T.; Cheng, Z.; Wang, R.; Bai, Y. Opportunistic Maintenance Strategy for Complex Equipment with a Genetic Algorithm Considering Failure Dependence: A Two-Dimensional Warranty Perspective. Sensors 2022, 22, 6801. [Google Scholar] [CrossRef] [PubMed]
  43. Wang, X.; Li, L.; Xie, M. An unpunctual preventive maintenance policy under two-dimensional warranty. Eur. J. Oper. Res. 2020, 282, 304–318. [Google Scholar] [CrossRef]
  44. Dong, E.; Cheng, Z.; Wang, R.; Zhao, J. Optimization of two-dimensional extended warranty scheme for failure dependence of a multi-component system with improved PSO–BAS algorithm. Processes 2022, 10, 1479. [Google Scholar] [CrossRef]
  45. Lu, J.C.; Bhattacharyya, G.K. Some new construction of bivariate Weibull models. Ann. Inst. Stat. Math. 1990, 42, 543–559. [Google Scholar] [CrossRef]
  46. Jayabalan, V.; Chaudhuri, D. Cost optimization of maintenance scheduling for a system with assured reliability. IEEE Trans. Reliab. 1992, 41, 21–25. [Google Scholar] [CrossRef]
Figure 1. The relation between the using time and the usage for the usage rate s .
Figure 1. The relation between the using time and the usage for the usage rate s .
Systems 10 00210 g001
Figure 2. Timeline and breakdowns of a deteriorating system under the imperfect PM model.
Figure 2. Timeline and breakdowns of a deteriorating system under the imperfect PM model.
Systems 10 00210 g002
Figure 3. Flow chart of the heuristic algorithm for obtaining the optimal cost with N * and q * .
Figure 3. Flow chart of the heuristic algorithm for obtaining the optimal cost with N * and q * .
Systems 10 00210 g003
Figure 4. Flow chart of the heuristic algorithm for obtaining the optimal profit with N * and q * .
Figure 4. Flow chart of the heuristic algorithm for obtaining the optimal profit with N * and q * .
Systems 10 00210 g004
Figure 5. Computerized decision support system design.
Figure 5. Computerized decision support system design.
Systems 10 00210 g005
Figure 6. Average profits per unit and year for the candidate PM alternatives.
Figure 6. Average profits per unit and year for the candidate PM alternatives.
Systems 10 00210 g006
Figure 7. Average values of the rental revenue and the machine’s residual value.
Figure 7. Average values of the rental revenue and the machine’s residual value.
Systems 10 00210 g007
Figure 8. The impact of the scale and shape parameters α , ω , β and κ on the expected profit.
Figure 8. The impact of the scale and shape parameters α , ω , β and κ on the expected profit.
Systems 10 00210 g008
Figure 9. The impact of the parameters C m r , C p l , C F q and τ q on the expected profit.
Figure 9. The impact of the parameters C m r , C p l , C F q and τ q on the expected profit.
Systems 10 00210 g009
Figure 10. The impact of the customers’ average usage rate on the expected profit.
Figure 10. The impact of the customers’ average usage rate on the expected profit.
Systems 10 00210 g010
Table 1. The notations.
Table 1. The notations.
t : the age of the leased facility.
t k : the effective age of a deteriorating system before the kth preventive maintenance.
t k + : the effective age of a deteriorating system after the kth preventive maintenance.
t r : the time required for performing a minimal repair.
α : the scale parameter of the bivariate Weibull model for the system’s age.
β : the shape parameter of the bivariate Weibull model for the system’s age.
ω : the scale parameter of the bivariate Weibull model for the system’s usage.
κ : the shape parameter of the bivariate Weibull model for the system’s usage.
λ ( t , u ) : the intensity function of age and usage of a deteriorating system.
λ ( t , s ) : the intensity function of age and usage rate of a deteriorating system.
u : the usage of the leased facility.
s : the usage per unit time, and it varies from lessees’ usual practice. (s = t/u)
T L : the length of a lease contract.
T D : the time segment for time-discounting factor.
ρ : the depreciation rate of the leased facility after a time segment.
V P : the purchase price of the leased facility.
V R ( T L , T D , ρ , V P ) : the residual value of the leased facility at time T L .
R ( T L , T D , R ¯ , ξ ) : the payment of the lease facilities.
E [ N b r | T L , Ψ D ( s ) , Θ ] : the expected number of the failures times of the leased facility. The mathematical form is given in Equation (8) D = G , L , U , Θ = { α , β , ω , κ }
x : the time span between two scheduled periodic preventive maintenances.
C m r : the expected cost of performing a minimal repair.
C p l : the penalty cost when the actual repair time exceeds the time limit φ .
φ : the pre-specified limit of time for a minimal repair work.
Φ ( t r ) : the probability density function of the time for performing minimal repair.
C p m k q : the cost of performing the kth preventive maintenance for alternative q .
C F p : the base cost for performing a preventive maintenance, and it is influenced by the degree of PM.
τ q : the periodically increasing rate of the preventive maintenance cost for alternative q .
δ p m q : the age reduction factor in effective age for alternative q due to the kth preventive maintenance, where δ p m q [ 0 , 1 ] .
Table 2. The detailed information of the candidate PM alternatives.
Table 2. The detailed information of the candidate PM alternatives.
The estimated values of the parameters of the two-dimensional deterioration α = 1.1 , β = 1.4 , ω = 1.25 , κ = 1.65
Interval of PM; Time segment x = 0.5   years ; T D = 0.5   years
The probability distribution of customers’ usage rateGamma probability distribution Ψ G ( s | θ , γ ) = ( s θ 1 e s / γ γ θ Γ ( θ ) ) with E ( s ) = 1.5 and σ ( s ) 2 = 0.7
Age reduction factors of the alternatives (1..6) δ p m q = { 0.6 , 0.65 , 0.7 , 0.75 , 0.8 , 0.85 }
The base cost for a PM action (1..6) C F q = { $ 570 , $ 650 , $ 700 , $ 730 , $ 750 , $ 820 }
Periodically increasing rates of PM cost (1..6) τ q = { 0.08 , 0.09 , 0.12 , 0.125 , 0.135 , 0.15 }
Depreciation rate ρ = 0.15
The lower and upper boundaries of the
planned lease terms
T L L B = 2   years ; T L U B = 15   years
Rental per half-year R ¯ = $ 9800
Time discount rate ξ = 0.02
The purchasing cost of an equipment V P = $ 90 , 000
Expected cost of performing
a minimal repair
C m r = $450
Penalty cost when the repair time
exceed the time limit φ
C p l = $ 250
Expected value and standard deviation of performing a minimal repair E ( t r ) = 9   h , σ ( t r ) = 5   h
Tolerable waiting time limit
for performing a minimal repair
φ = 4.5   h
Table 3. Average residual value, related costs and profit per unit and year for the PM alternatives.
Table 3. Average residual value, related costs and profit per unit and year for the PM alternatives.
T L V R ( T L ) C p m q ( C F q , τ q , x , T L ) ( C m r + C p l φ Φ ( t r ) d t r ) E [ N b r ] E [ π | T L , M P q ]
M P 1 M P 2 M P 3 M P 4 M P 5 M P 6 M P 1 M P 2 M P 3 M P 4 M P 5 M P 6 M P 1 M P 2 M P 3 M P 4 M P 5 M P 6
232,513120813881526159716521825621576532488444401470345684474444744364307
2.523,980123114171568164317031886740680620561503444484147154623460846074481
318,424125414461610168817531948860784709635561488495648394750474647554634
3.514,559127714761652173418042009980889799709620532505049434856486448844767
411,7451300150516941779185420711102995889784679576512550274943496349934880
4.5962513221534173618251905213212241101980859739620518250935013504450844976
57987134515631778187119562194134712081071934799664522251425065510951595056
5.566941368159318201916200622551470131611621010859709524651755101515752185119
656571391162218621962205723171594142312541086919754525451945123519152635169
6.548151414165119042008210823781718153113461162979798524951985130521152945204
7412214361680194620532158244018431640143812381040843523151905125521853125227
7.5354714591710198820992209250119681749153113151101889520051695108521353175237
8306614821739203021442259256320931858162413921162934515851365079519753125237
8.5266015051768207221902310262422191967171714691223979510550935039516952965225
92316152817972114223623612686234520771811154612841025504250404990513252705204
9.52023155018272156228124112747247221871904162413461070496949774931508652345174
101772157318562198232724622809259922981998170114071116488749064863503151905135
10.51556159618852240237325132870272624082093177914691162479748264787496751385088
111369161919142282241825632932285325192187185715311207470047384703489650785033
11.51207164219442324246426142993298126302281193515931253459546444612481850114971
121067166419732366250926643055310927412376201416551299448345424514473349374902
12.5944168720022408255527153116323728532471209217171345436444344409464148574827
13837171020312450260127663178336529642566217117791391424043194299454447714746
13.5743173320612492264628163239349430762661225018411438411042004183444146794660
14661175620902534269228673301362331882757232819041484397440754062433345824568
14.5588177821192576273829183362375233012852240819671530383439453936421944804472
15524180121482618278329683424388134132948248720291577368938103805410243744371
Table 4. The impact of E ( s ) and σ ( s ) 2 on expected profit.
Table 4. The impact of E ( s ) and σ ( s ) 2 on expected profit.
T L E ( s ) σ ( s ) 2
−30%−20%−10%0%+10%+20%+30%−30%−20%−10%0%+10%+20%+30%
245404503446944364405437543464432443344354436443844394441
2.547244682464446074571453745054601460346054607460846104612
348864840479747554716467846424749475147534755475747594761
3.550294977492948844840479847584877487948814884488648884890
451525096504349934945489948554986498849914993499549985000
4.552575196513950845033498349355077507950825084508750895092
553465280521851595103504949975151515451575159516251655167
5.554195348528252185158510050445210521352155218522152245227
654785402533152635198513650775253525752605263526652695272
6.555235442536652945225515950955284528752905294529753005304
755555469538853125238516851015301530453085312531553195322
7.555755484539853175240516650945306531053145317532153255328
855835487539753125230515250765300530453085312531653205323
8.555815480538652965210512750485283528752925296530053045308
955705464536452705179509350095256526152655270527452785283
9.555495438533352345140504949625220522552305234523952435248
1055195403529451905091499649055176518051855190519552005204
10.554815360524651385035493648405123512851335138514351485153
1154365309519050784970486747685062506750735078508350885093
11.553835251512850114899479146884994500050055011501650215027
1253235187505949374821470946014920492549314937494249484953
12.552585116498348574736462045094839484548514857486248684874
1351865039490147714646452644104752475847644771477747834788
13.551094957481446794550442543064660466646734679468546914697
1450274870472245824448432041964562456945764582458945954601
14.549404778462544804342421040824460446744744480448744944500
1548494681452443744232409539634353436043674374438143884395
Publisher’s Note: MDPI stays neutral with regard to jurisdictional claims in published maps and institutional affiliations.

Share and Cite

MDPI and ACS Style

Fang, C.-C.; Hsu, C.-C.; Liu, J.-H. The Decision-Making for the Optimization of Finance Lease with Facilities’ Two-Dimensional Deterioration. Systems 2022, 10, 210. https://doi.org/10.3390/systems10060210

AMA Style

Fang C-C, Hsu C-C, Liu J-H. The Decision-Making for the Optimization of Finance Lease with Facilities’ Two-Dimensional Deterioration. Systems. 2022; 10(6):210. https://doi.org/10.3390/systems10060210

Chicago/Turabian Style

Fang, Chih-Chiang, Chin-Chia Hsu, and Je-Hung Liu. 2022. "The Decision-Making for the Optimization of Finance Lease with Facilities’ Two-Dimensional Deterioration" Systems 10, no. 6: 210. https://doi.org/10.3390/systems10060210

APA Style

Fang, C. -C., Hsu, C. -C., & Liu, J. -H. (2022). The Decision-Making for the Optimization of Finance Lease with Facilities’ Two-Dimensional Deterioration. Systems, 10(6), 210. https://doi.org/10.3390/systems10060210

Note that from the first issue of 2016, this journal uses article numbers instead of page numbers. See further details here.

Article Metrics

Back to TopTop
