Construction Dispute Potentials: Mechanism versus Empiricism in Artificial Neural Networks
Abstract
:1. Introduction
2. Theoretical Background
3. Methods
3.1. Research Design, Sampling, and Data Collection
3.2. Methods for Model Construction
3.2.1. Mechanism—Bayesian Belief Networks
3.2.2. Empiricism—Multilayer Perceptron Networks
3.3. Methods for Factor Shortlisting
3.3.1. Shortlist Factors for BBN—Pearson’s Chi-Square Tests
3.3.2. Shortlist Factors for MLP—Pearson’s Correlation Coefficients
4. Data Collection and Analyses
4.1. Initial Factor List
- Client service gap refers to the services provided by the client onsite project team benchmarked against the project requirements;
- Contractor service gap refers to the services provided by the contractor onsite project team benchmarked against the project requirements;
- Project characteristics describe the inherent nature of the project tasks;
- Extrinsic uncertainties concern the hostile ambient environment where the project was delivered;
- Contractual arrangements elaborate risks embedded in the project and assign the risks to the obligated party;
- Interactive processes describe the actions between the client and contractor after legal binding takes effect.
4.2. Measurement and Categorisation of Dispute Potential
4.3. Data Collected by the Questionnaire Survey

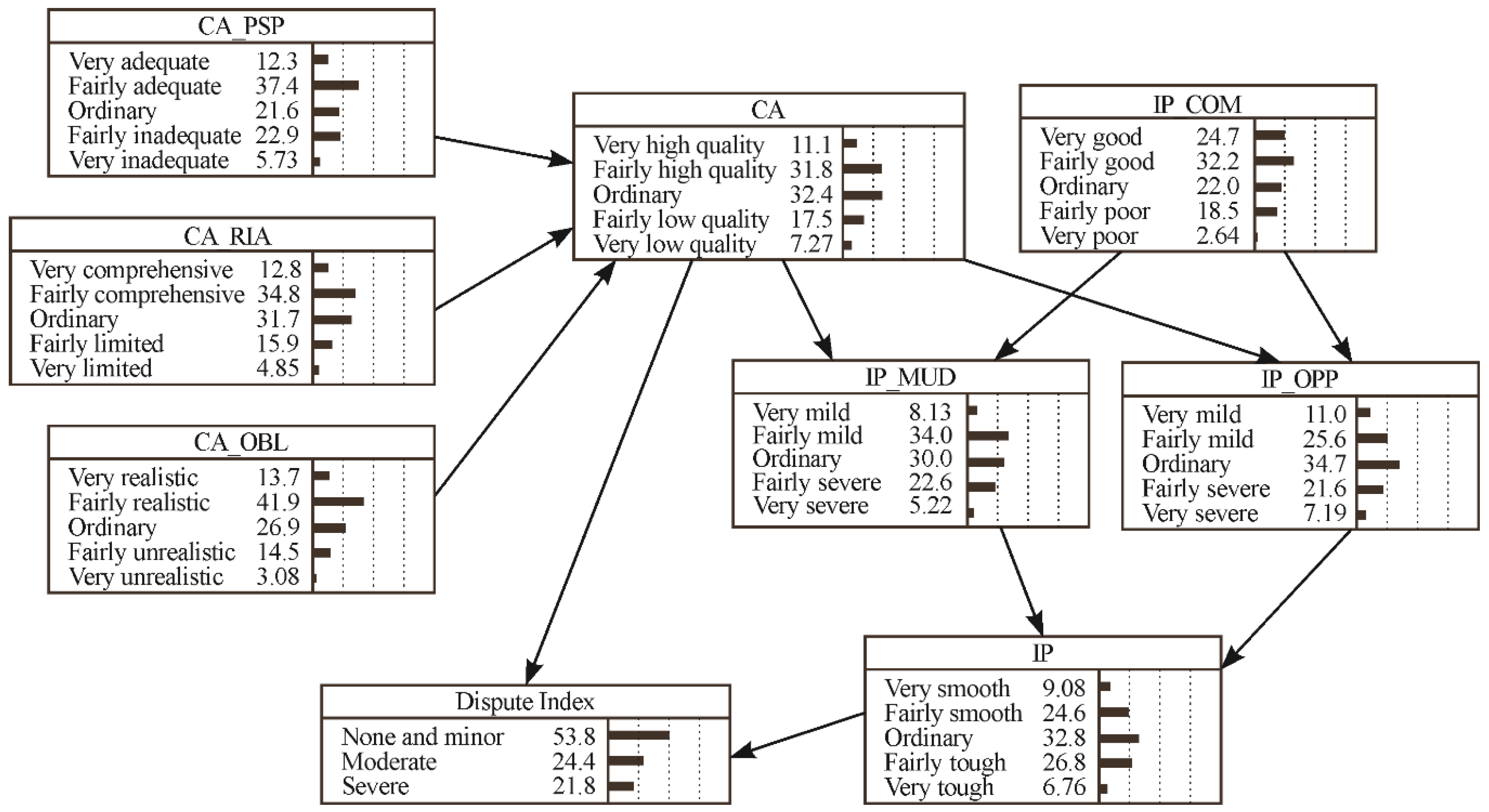

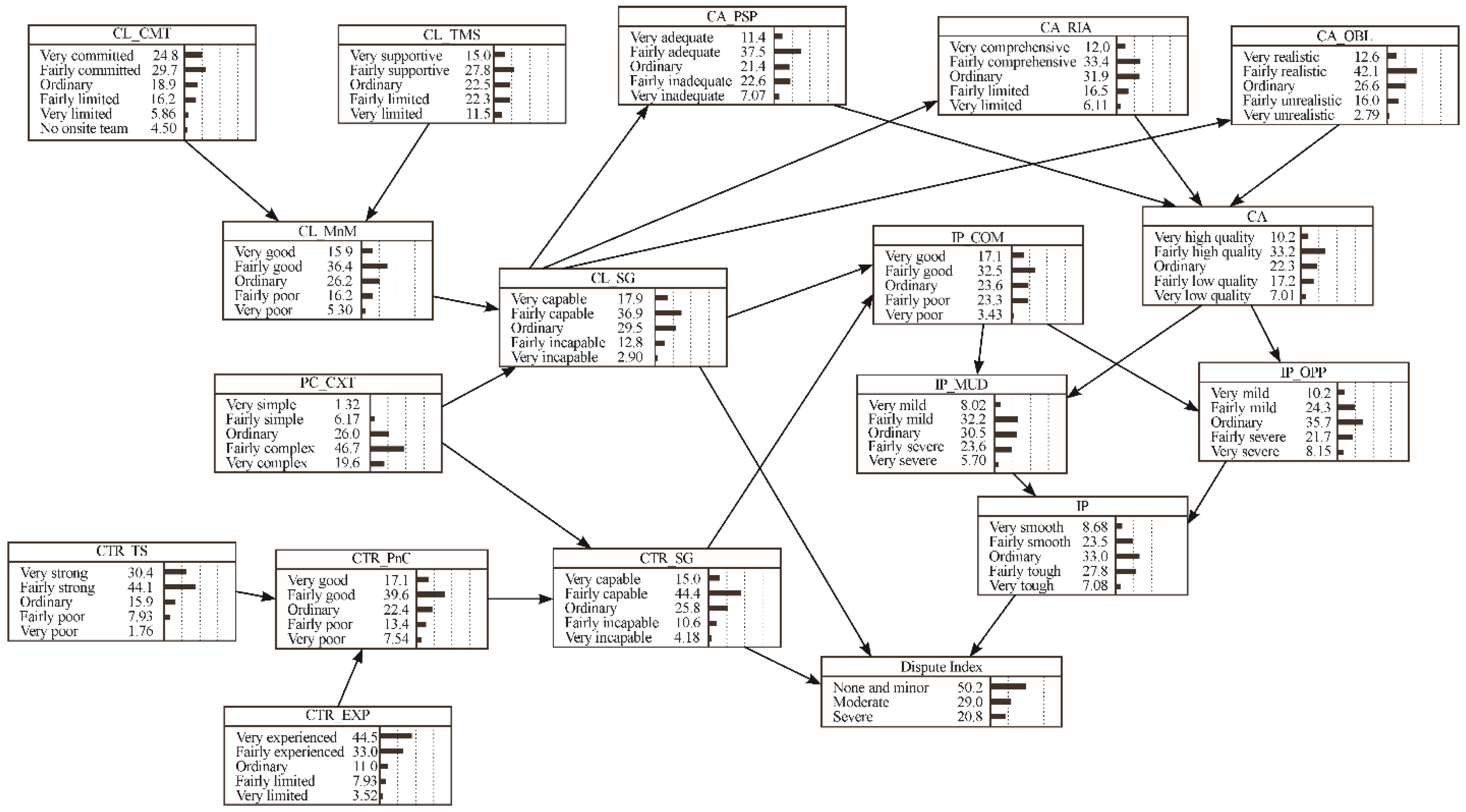

4.4. Constructing the BBN Model
- Client top management support, Client commitment → Client monitoring and management [114];
- Contractor technical strength, Contractor past experience → Contractor planning and control [114];
4.5. Constructing the MLP Model
4.6. Accuracy Tests with Independent Samples
4.7. Expert Perceptions on Models
- Which model would you prefer to use in order to be assisted?
- Why did you select this model?
- Why did you not select the other models?
- How convenient would it be for you to collect the input data for Model A and Model B?
5. Discussion
5.1. General Rules for Dispute Avoidance
5.2. Case-by-Case Assistance for Dispute Avoidance
5.3. Empiricism versus Mechanism
6. Conclusions
6.1. Theoretical and Practical Contributions
6.2. Limitations and Recommendations
Author Contributions
Funding
Informed Consent Statement
Data Availability Statement
Conflicts of Interest
References
