Article

Sequential Scheduling Method for FJSP with Multi-Objective under Mixed Work Calendars

1
School of Energy Science and Engineering, Henan Polytechnic University, Jiaozuo 454000, China
2
School of Safety Science and Engineering, Henan Polytechnic University, Jiaozuo 454000, China
*
Author to whom correspondence should be addressed.
Processes 2019, 7(12), 888; https://doi.org/10.3390/pr7120888
Submission received: 24 October 2019 / Revised: 13 November 2019 / Accepted: 25 November 2019 / Published: 1 December 2019
(This article belongs to the Collection Multi-Objective Optimization of Processes)

Abstract

:
A sequential scheduling method for multi-objective, flexible job-shop scheduling problem (FJSP) work calendars is proposed. Firstly, the sequential scheduling problem for the multi-objective FJSP under mixed work calendars was described. Secondly, two key technologies to solve such a problem were proposed: one was a time-reckoning technology based on the machine’s work calendar, the other was a sequential scheduling technology. Then, a non-dominated sorting genetic algorithm with an elite strategy (NSGA-II) was designed to solve the problem. In the algorithm, a two-segment encoding method was used to encode the chromosome. A two-segment crossover and mutation operator were used with an improved strategy of genetic operators therein to ensure feasibility of the chromosomes. Time-reckoning technology was used to calculate start and end time of each process. The sequential scheduling technology was used to implement sequential scheduling. The case study shows that the proposed method can obtain an effective Pareto set of the sequential scheduling problem for multi-objective FJSP under mixed work calendars within an acceptable time.

Graphical Abstract

1. Introduction

In recent years, researchers have shown an increased interest in the field of the flexible job-shop scheduling problem (FJSP), and there have been a large number of related research results. However, there is a phenomenon of mixed work calendars in manufacturing companies, i.e., different machines in the same company or workshop may run under different work calendars. Most of the existing research results cannot be applied when mixed work calendars are considered. Nowadays, because of the increasing pressure in manufacturing companies, more than one objective should be often considered in the process of production scheduling. Just for this reason, multi-objective optimization is more suitable for scheduling requirements. It is often possible to arrange the next batch of scheduling tasks before the completion of the previous one in the production process. This work is called sequential scheduling in this paper. Based on the above reasons, the sequential scheduling for FJSP with multi-objectives under the mixed work calendars has become a new research topic.
There are three main ways to deal with a work calendar in job-shop scheduling: not considering a work calendar, considering a work calendar after scheduling, considering a work calendar in scheduling. Most of the researches belong to the first case [1,2,3]. Although the calculative complexity is lowest, the scheduling scheme is not associated with the work calendar and is obviously out of touch with practice. A part of the research has been devoted to the second case. The work calendar is not considered in scheduling. After the scheduling scheme is obtained, the time is mapped to the calendar time through “integral translation” [4]. Although the calculative complexity is low, it is only suitable when the machines operate under the same work calendar. In the third case, the start and stop time of process is arranged according to the work calendar of each machine in scheduling. Although calculative complexity is large, it can ensure that the scheduling scheme is in accordance with practice. Just for this reason, it is suitable for occasions when the machines operate under mixed work calendars. Existing research results on job-shop scheduling with mixed work calendars are rare and there are some shortcomings. Wu Zhijun et al. [5] proposed an implementation strategy and key algorithms of a dynamic work calendar, but did not consider work shift. Huang Yuyue et al. [6] considered work shift in scheduling, but did not consider work system. Stefan et al. [7] considered work system in scheduling, but did not consider work shift. Wan Chunhui et al. [8] not only considered work system but also work shift in scheduling, but there are some shortcomings, such as low operability and large amount of calculation.
In the sequential scheduling process for FJSP with multi-objectives, the scheduling scheme selected by the previous batch of scheduling will affect the machines’ initial time status of the next batch of scheduling. In order to maximize utilization of machines and shorten production cycle when arranging the processes, it is necessary to arrange the processes by means of “extrusion insertion”. Therefore, how to update the machines’ time status according to the selected scheduling scheme, how to construct the machines’ initial time status according to the machines’ time status and the scheduling start time, and how to arrange the processes by means of “extrusion insertion” based on the machines’ work calendars are the three key issues to solve the sequential scheduling for FJSP with multi-objectives under mixed work calendars.
There are two methods to solve FJSP with multi-objectives: indirect method and direct method. The former refers to the method to solve the problem after it is transformed into single objective problem by some means, mainly including the minimax method, linear weighted sum method [9], ideal point method, main object method [10], efficacy coefficient method [11], hierarchical ordering method [12], etc. But this method cannot obtain the entire optimal solution set. The latter refers to the method to obtain the optimal solution set directly in multi-objective space, in which the optimization method based on Pareto optimization thought is most widely used, including the multi-objective genetic algorithm (MOGA) [13], niched pareto genetic algorithm (NPGA) [14], strength Pareto genetic algorithm (SPGA) [15,16], non-dominated sorting genetic algorithm (NSGA) [17], etc. Some research [18,19] has obtained the conclusion that NSGA is superior to other algorithms. With the expansion of the research scope, the shortcomings of NSGA are exposed in the multi-objective optimization algorithms. In order to better solve the multi-objective optimization problem, some scholars proposed a genetic algorithm with non-dominated sorting with elite strategy (NSGA-II). NSGA-II reduces the complexity of NSGA and has the advantages of fast running and good convergence of the solution set. It is one of the most popular multi-objective genetic algorithms at present.
Based on above analysis, a sequential scheduling method for FJSP with multi-objectives under mixed work calendars is proposed in this paper.

2. Problem Description

A batch of workpieces needs to be arranged on several machines. Assumptions: ① Each machine runs under the specified work calendar. The work calendar considered in this paper is a combination of work system and work shifts. ② Each workpiece has multiple processes, and there may be more than one feasible machine for each process. ③ The process flow of each workpiece, the adjusting and processing time of each process on the feasible machines, are determined beforehand. ④ When a machine is shut down under its work calendar, the machine stops adjusting, and the process stops processing. The unfinished work will be continued when the machine begins to work again. ⑤ Once a process is started, it should not be interrupted to perform another one. ⑥ When two adjacent batches of workpieces are scheduled, the next schedule should take the machines’ time occupation status of the selected scheduling scheme as the initial state. ⑦ The scheduling runs from the specified scheduling start time. ⑧ The scheduling start time of the next batch is not earlier than that of the previous one. Requirements: to reasonably arrange the processes so as to minimize production cycle and total cost under the above assumptions.
Obviously, the above problem belongs to a sequential scheduling problem for FJSP with multi-objectives under mixed work calendars. Because different machines may operate under different work calendars, the problem is a highly complex NP-hard problem. It can be solved by an intelligent search algorithm. In view of the advantages of a genetic algorithm, taking Excel as the designed platform, this paper designs a non-dominated sorting genetic algorithm with elite strategy (NSGA-II) to solve it.

3. Definition of Types, Variables and Arrays

A set of types, variables, and arrays are defined. The types are proc, job, chr, mach, as shown in Figure 1. The variables are shown in Table 1. The arrays are shown in Table 2. chr.R is an array of tpnum × 12. Columns 1 to 12 are used to store task No., workpiece No., process No., machine No., adjustment time, processing time, adjusting start time, adjusting end time, processing start time, processing end time, adjusting cost and processing cost. MA is used to store parameters of each machine. JB is used to store parameters of each workpiece. MMB is used to store the machines’ time status before scheduling.

4. Key Technologies

4.1. Time Reckoning Technology Based on the Machine’s Work Calendar

4.1.1. Design and Configuration of Work Calendar

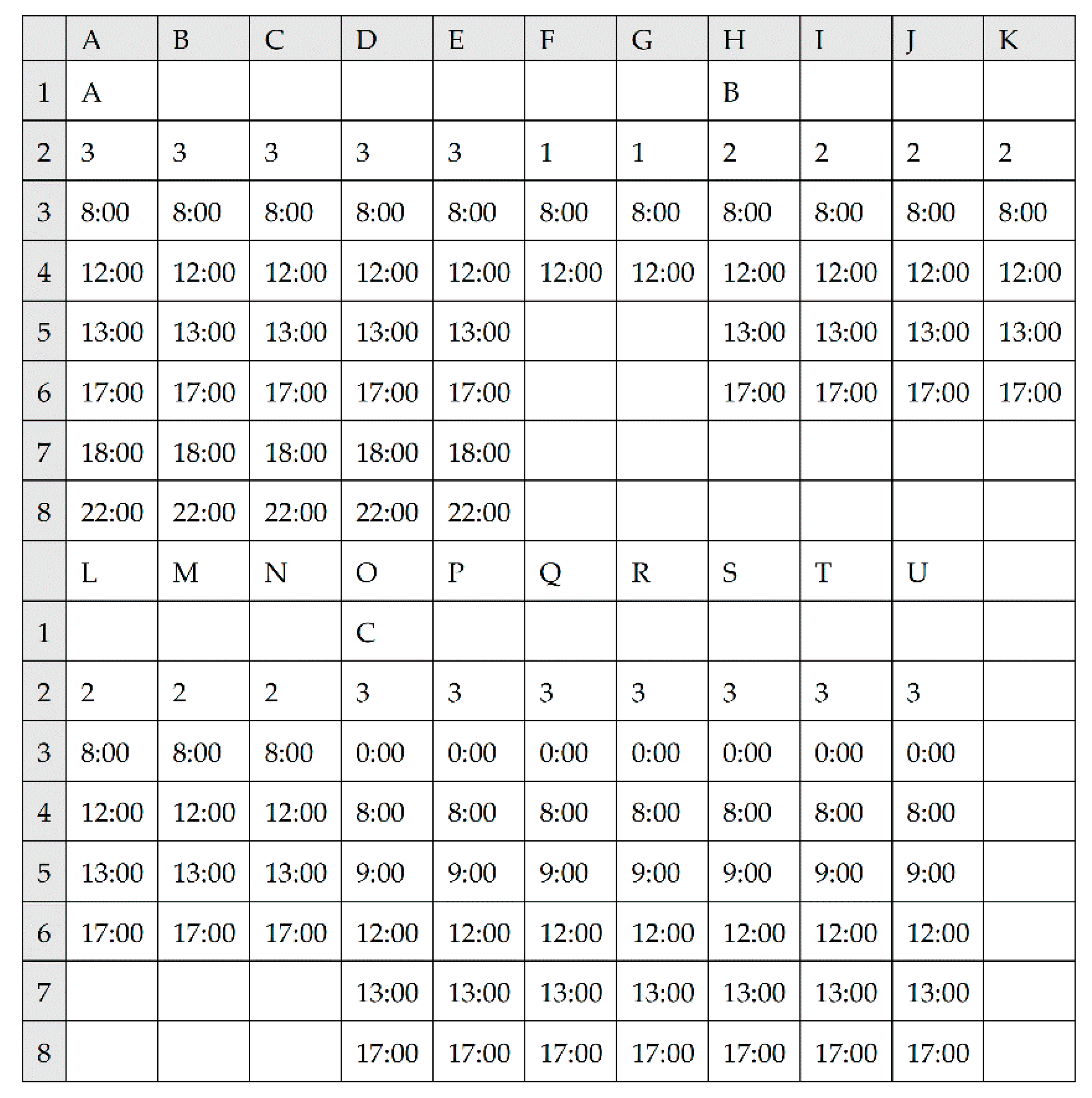

A worksheet “work system” is designed for setting up work systems. In Figure 2, from left to right, every two columns correspond to a work system. The cells of the odd column in the first row are names of work systems. The cells of the odd column in the other rows are days off on the non-weekend. The cells of even columns are work days on the weekend. The dispatcher can also add other work systems to the right as needed.
A worksheet “work shifts” is designed for setting up work shifts. In Figure 3, columns A to G are setting content of work shift A. Cell A1 is the name of work shift A. Columns A2 to G2 are number of work periods per day from Monday to Sunday. The other rows in each column are used to set up work periods of each day. Taking column A as an example, columns A3 to A8 indicate that the three work periods on Monday are 8:00 to 12:00, 13:00 to 17:00 and 18:00 to 22:00. The dispatcher can also add other work shifts to the right, such as B, C… as needed.
A worksheet “machines” is designed for configuring the work calendar for each machine. In Figure 4, work system Z and work shift A are assigned to machine “300T”, and work system Y and work shift B are assigned to machine “200T”.

4.1.2. Design of Time-Reckoning Function Based on Work Calendar

Based on the design and configuration of the work calendar, six functions were designed to realize time reckoning, namely Isworkday, Nextworkday, Getsd, Forwardwd, Backwd and Getat.
Isworkday: This function has two parameters: md (date) and wds (string). It is used to judge whether the date md is work day or not according to the machine’s work system wds. If so, return 1, otherwise, return 0. Figure 5 is flow of this function.
Nextworkday: This function has three parameters: md (date), t (integer) and wds (string). It is used to get the work day after t days from date md according to work system wds. t > 0 indicates forward reckoning, and t < 0 indicates backward reckoning. Figure 6 is the flow of this function.
Getsd: This function has three parameters: md (date), t (double), and mn (integer). It is used to get the position of time t on the date md according to work shift of machine mn. Its return value is an array A. A contains 2 elements. A (2) is the flag element. A (2) = 0 indicates that time t belongs to the A (1)th non-work period on the date md of machine mn. A (2) = 1 indicates that time t belongs to the A (1)th work period on the date md of machine mn. In Figure 7, 0:00~24:00 is split into 5 time periods, including 2 work periods 8:00~12:00 (No. 1),13:00~17:00 (No. 2), and 3 non-work periods 0:00~8:00 (No. 0), 12:00~13:00 (No. 1), 17:00~24:00 (No. 2). Figure 8 is flow of this function. The for loop I is used to judge whether time t belongs to the ith work period of the date md. If so, let A (1) = i, A (2) = 1, and return A. The for loop II and if statement III are used to judge whether time t belongs to the ith non-work period of the date md. If so, let A (1) = i, A (2) = 0, and return A. It is necessary to be pointed that if condition of if statement III is not met, it means that time t does not belong to any of the work periods and non-work periods of 1~wtn, so it can only belong to the 0th non-work period. In this case, the function will return array A, in which A (1) = 0, A (2) = 0.
Forwardwd: This function has three parameters: mdt (date), t (double), and mn (integer). It is used to get the work time after t hours from work time mdt according to work calendar of machine mn by forward reckoning. Figure 9 is a schematic diagram of reckoning process. Figure 10 is flow of this function. In Figure 9, the work period is simply referred to as wp.
Backwd: This function has three parameters: mdt (date), t (double) and mn (integer). It is used to get the work time before t hours from work time mdt according to work calendar of machine mn by backward reckoning. The function Backwd is similar to the function Forwardwd in calculation principle and flow, no more repeat here.
Getat: This function has two parameters: mdt (date) and mn (integer). It is used to get the earliest work time from time mdt according to work calendar of machine mn by forward reckoning. Figure 11 is a schematic diagram of the reckoning process, and Figure 12 is the flow of this function. In Figure 11, the work period is simply referred to as wp.

4.2. Sequential Scheduling Technology

As mentioned in the introduction, how to construct the machines’ initial time status according to the machines’ time status and the scheduling start time, and how to arrange the processes by means of “extrusion insertion” based on the machines’ work calendars, are the key issues to solve the sequential scheduling for FJSP with multi-objectives under mixed calendars. The technical steps to solve these key issues in this paper are as follows.
Step 1: Construct machines’ initial time status before scheduling and assign them to array MMB according to worksheet “machines’ time status” and the given scheduling start time.

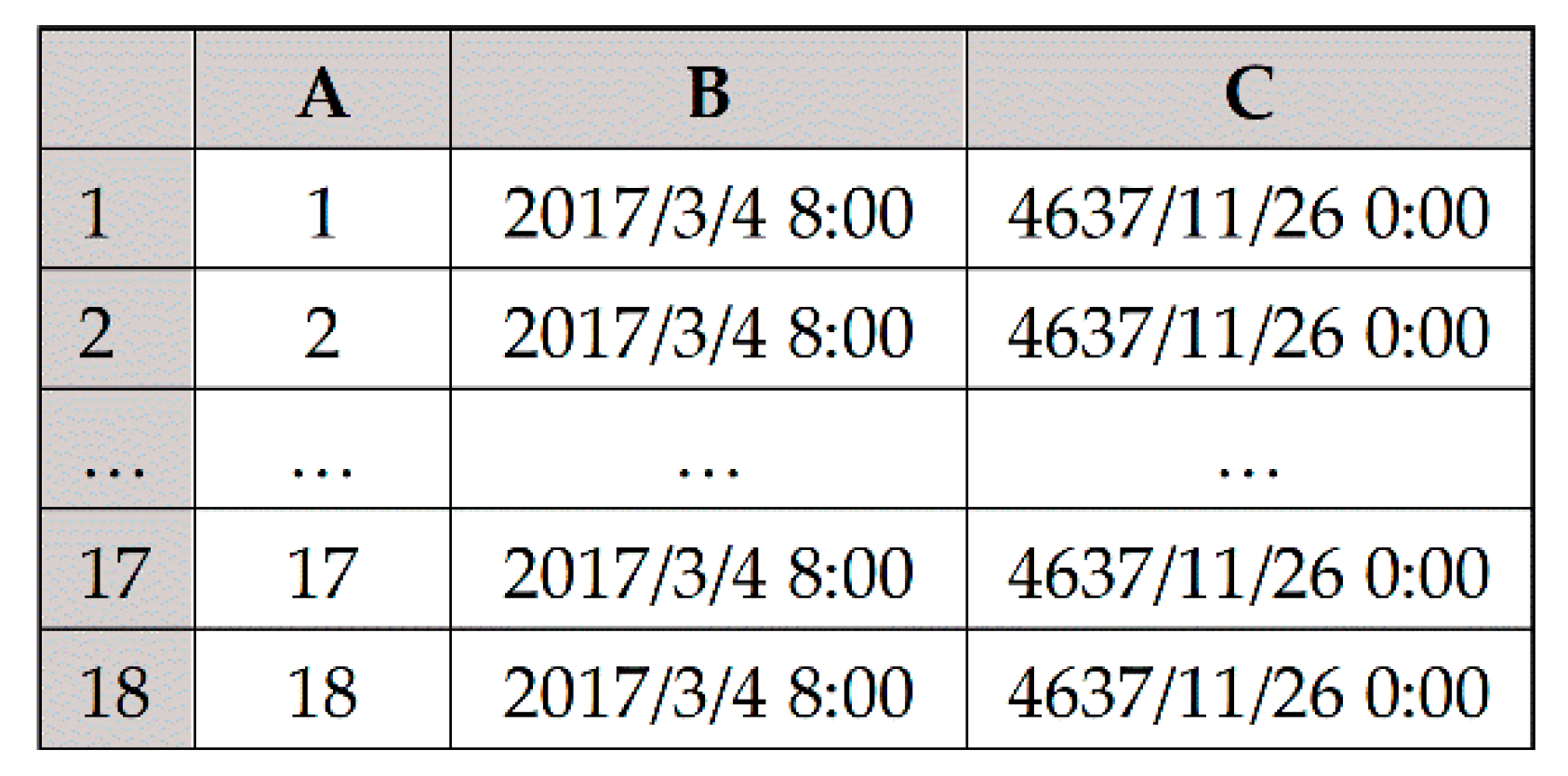

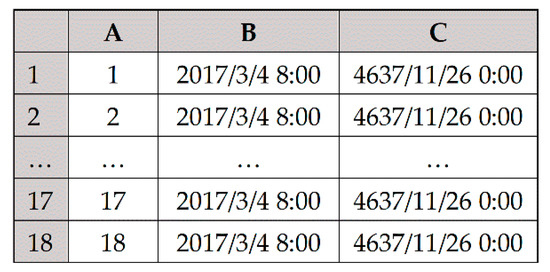

Construct a worksheet “machines’ time status” as shown in Figure 13. Each row is used to store time status information of a machine. Column A is machine No. Columns B and C are start and end time of the first idle period of each machine. Columns C to G are adjusting start time, adjusting end time, details of a process, processing start time, and processing end time of the first process. Columns G and H are start and end time of the second idle period of each machine. Columns H to L are adjusting start time, adjusting end time, details of the second process, processing start time, and processing end time of the second process; and so on.
Schematic diagram of constructing the machines’ time status before scheduling is shown in Figure 14. Take machine i as an example. If the given scheduling start time is in the kth idle period of machine i (a), let the start time of the first idle period of machine i be equal to the given scheduling start time, and the end time of the first idle period of machine i be equal to the end time of the kth idle period. The subsequent idle periods are taken back in turn. If the given scheduling start time is between the start and end time of a certain process (b), let the start time of the first idle period of machine i be equal to the end time of the process, and let the end time of the first idle period of machine i be equal to the end time of the first idle period after the process. The subsequent idle periods are taken back in turn.
Step 2: Assign MMB to the individual’s attribute MMA.
Step 3: Arrange the processes by means of “extrusion insertion” when the individual is decoded.
The detailed steps are as follows (Figure 15). Firstly, find the first feasible idle period k according to time status of machine i. Then, insert process a into the idle period k. Finally, update time status of machine i. The method of finding the first feasible idle period is as follows. Determine whether each idle period is enough for process a from left to right. If enough, find the first feasible idle period k, otherwise continue to search backward. The steps of judging whether the idle period k is enough is as follows. Reckon processing end time of process a according to the earliest adjustable time, adjusting time, processing time of process a and work calendar of the machine. Judge whether the end time of process a is not more than the end time of idle period k. If so, idle period k is a feasible idle period. The steps of updating the time status of machine i is as follows. Firstly, increase length of ch.MMA (R (i, 4)). TS by 5. Then, move data from the second datum of kth idle period back 5 positions so as to obtain 5 empty positions. Finally, fill adjusting start time, adjusting end time, process details, processing start time, and processing end time of the current process in the 5 empty positions.
Step 4: Output scheduling matrix R and the machines’ time status array MMA of each Pareto solution to worksheet “pareto solution set” at the end of the evolution. Worksheet “pareto solution set” is shown in Figure 16.
If a scheduling scheme has two optimization objectives, the columns in worksheet “pareto solution set” are described as follows. Columns A to ADE are data of the Pareto solution. Among them, columns A to D are sequence No., objective 1, objective 2, Pareto frontier value. Columns E to ADD are data of scheduling matrix R of the Pareto solution, namely process details, workpiece No., process No., machine No., machine code, adjusting time, processing time, adjusting start time, adjusting end time, processing start time, processing end time, adjusting cost, processing cost. Column ADE is data number of time status of machine 1. The next 32 cells after column ADE are data of time status of machine 1; and so on.
Step 5: Extract scheduling matrix into worksheet “Pareto Solution”, and machines’ time status into worksheet “machines’ time status” from the row double clicked when the dispatcher selects a Pareto solution by double click.

5. Non-Dominated Sorting Genetic Algorithm with an Elite Strategy (NSGA-II) Design

5.1. Algorithm Flow

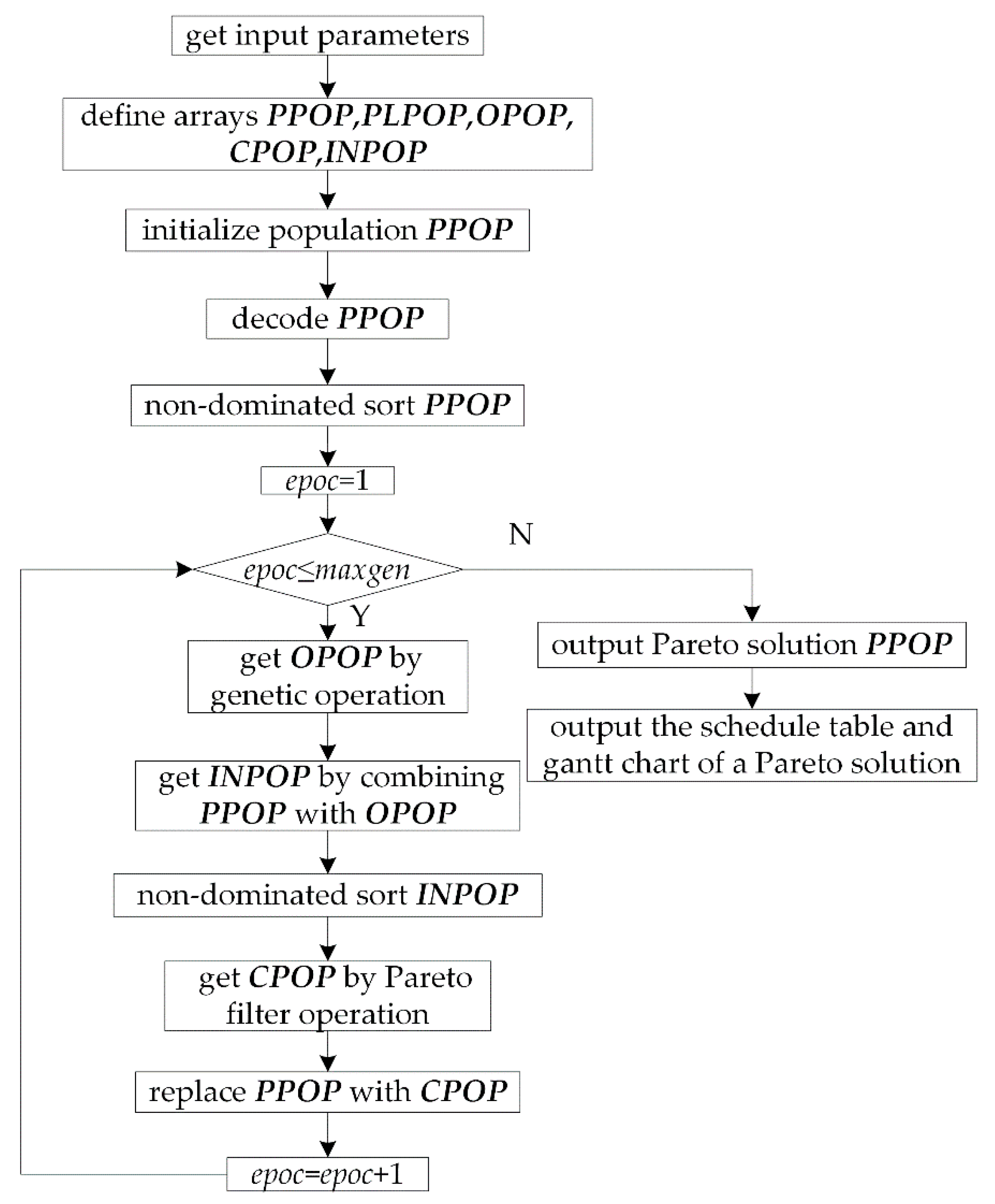

Take popsize as an even number, the designed algorithm flow is shown in Figure 17.

5.2. Obtaining Input Parameters

Firstly, design worksheet “workpiece”, “scheduling workpiece”, “process flow” and “other parameters” for the dispatcher to set up input parameters. Then, obtain input parameters by the following steps in the algorithm. Read parameters from worksheet “other parameters” and assign them to variables whose type are input parameters in Table 1. Read data from the second row to last row of worksheet “machine” and assign them to array MA. Assign value to array MMB by step (1) in Section 4.2. Assign value to JB by loop: take workpiece i as an example. Firstly, read name, type and number of processes of workpiece i from worksheet “workpiece” and assign them to JB (i).name, JB (i).type and JB (i).pnum. Then, redefine each dimension of JB (i).PR by Redim JB (i).PR (JB (i).pnum). Finally, read parameters of processes of workpiece i from worksheet “process flow” and assign them to JB (i).PR (i)~JB (i).PR (JB (i).pnum) by for loop.

5.3. Encoding Method

Encode processes and their processing machines separately by means of “segmentation” as shown in Formula (1). PPOP (i).R is an array of tpnum × 12, in which the second and fourth column are used for encoding, and the other columns are used for auxiliary or decoding. Each gene value of column 2 is a natural number between 1 and jnum. This represents the workpiece No. The number of occurrences of each natural number is equal to the number of processes of the workpiece. Each gene value of column 4 is the No. of feasible machines for each process.
PPOP ( i ) . R = ( 1 2 1 3 2 1 1 4 3 1 2 3 4 2 2 2 t p n u m 5 3 4 )

5.4. Population Initialization

Randomly generate popsize individuals and store them in population PPOP by flow shown in Figure 18. In Figure 18, the flow to assign feasible machine No. to column 4 of R is shown in Figure 19. As can be seen from Figure 18 and Figure 19, the randomly generated individuals are feasible individuals.

5.5. Select Operation

Select “excellent” individuals from parent population PPOP by “league mechanism” and form a pairing pool PLPOP made up of popsize/2 individuals by for loop. Suppose league size is ts. Randomly select ts individuals from parent population PPOP and select an “excellent” individual from them by each individual’s frontier value rank and congestion degree cd into pairing pool PLPOP in each loop. Finally, return PLPOP.

5.6. Genetic Operation

Generate offspring population OPOP made up of popsize individuals by selection, crossover, and mutation operation from parent population PPOP through a genetic operation. The flow is shown in Figure 20.

5.7. Crossover Operation

• Crossover operation of processes
Based on an improved strategy of a genetic operator, adopt a kind of crossover method is based on process No. in crossover operation of processes to ensure feasibility of the offspring individuals [20]. Because there is a sequence between processes of the same workpiece, adopt the following measure to ensure this sequence not to be destroyed. Fix the row (workpiece No., process No., and machine No.) of a certain workpiece No. of a parent, and replace the remaining rows of this parent with the other parent’s rows except that of this workpiece No. from top to bottom. Take Formula (2) as an example. Fix workpiece 1 in P1.R, fix workpiece 3 in P2.R, the result of crossover operation between P1.R and P2.R is shown in Formula (3).
P 1 . R = ( 1 3 1 4 2 1 1 1 3 2 1 3 4 3 2 2 5 1 2 4 6 2 2 3 7 4 1 2 8 4 2 4 )                  P 2 . R = ( 1 2 1 5 2 3 1 2 3 1 1 3 4 1 2 1 5 4 1 4 6 2 2 2 7 4 2 5 8 3 2 3 )
P 1 . R = ( 1 2 1 5 2 1 1 1 3 3 1 2 4 4 1 4 5 1 2 4 6 2 2 2 7 4 2 5 8 3 2 3 )                  P 2 . R = ( 1 1 1 1 2 3 1 2 3 2 1 3 4 1 2 4 5 2 2 3 6 4 1 2 7 4 2 4 8 3 2 3 )
• Crossover operation of processing machines
Adopt a kind of two-point crossover method in crossover operation of processing machines. Randomly generate two different integers mp1 and mp2 between 1 and tpnum. If mp1 > mp2, swamp them to make mp1 < mp2. Take parent P1′ as an example. Let k change from mp1 to mp2. For each k, find row No. h in P2′. R where the workpiece No. is equal to P1′. R (k, 2) and the process No. is equal to P1′.R (k, 3). Let P1′. R (k, 4) = P2′. R (h, 4). Deal with parent P2′ by similar method. After crossover operation of processing machines, re-decode P1′, P2′ and assign them to OC (1) and OC (2). For example, if mp1 = 3, mp2 = 5, the result of crossover operation from P1′ and P2′ in Formula (3) is shown in Formula (4).
O C ( 1 ) . R = ( 1 2 1 5 2 1 1 1 3 3 1 2 4 4 1 2 5 1 2 4 6 2 2 2 7 4 2 5 8 3 2 3 )                  O C ( 2 ) . R = ( 1 1 1 1 2 3 1 2 3 2 1 5 4 1 2 4 5 2 2 2 6 4 1 2 7 4 2 4 8 3 2 3 )
Obviously, the above crossover operation can ensure feasibility of the offspring individuals.

5.8. Mutation Operation

• Mutation operation of processes
Based on an improvement strategy of genetic operator, adopt a kind of sliding mutation method in mutation operation of processes to ensure feasibility of the offspring individuals. Take parent P as an example. Randomly generate an integer mp b9etween 1 and tpnum as the mutation point. Find the nearest index id where P′R(id,2) = P′R(mp,2) from mp upwards and assign it to s1. If id is null, let s1 = 0. Find the nearest index id where P′R (id,2) = P′R (mp,2) from mp downwards and assign it to s2. If id is null, let s2 = tpnum + 1. Let k1 = s1 + 1. Let k2 = s2 − 1. Randomly generate an integer between k1 and k2, and assign it to k. Then slip workpiece No., process No. and machine No. of the mpth row to the kth row. Take Formula (5) as an example. If mp = 3, k1 = 2, k2 = 8, k = 6, the result of mutation operation is shown in Formula (6).
P . R = ( 1 3 1 1 2 1 1 1 3 3 2 3 4 2 1 4 5 1 2 3 6 2 2 5 7 1 3 2 8 2 3 3 )
P . R = ( 1 3 1 1 2 1 1 1 3 2 1 4 4 1 2 4 5 2 2 5 6 3 2 3 7 1 3 2 8 2 3 3 )
• Mutation operation of processing machines
Adopt a kind of single-point mutation method in mutation operation of processing machines. Randomly generate an integer mp between 1 and tpnum as the mutation point. Let k = Ubound (JB (P′.R (mp, 2). PR (P′.R (mp, 3).MN). Randomly generate an integer between 1 and k as index of the new processing machine No. and assign it to id. Then, let P′.R (mp,4) =JB (P′.R(mp,2)).PR (P′.R (mp,3)).MN (id).
Re-decode individual P′ and assign it to ch after mutation operation.

5.9. Decoding Operation

The flow of decoding operation is shown in Figure 21.
There are three steps in the decoding operation. Firstly, assign MMB to ch.MMA and ch.R to R. Then, let i change from 1 to tpnum, arrange processes in sequence and determine columns 5~12 of R. Finally, let ch.R = R. The following three points need to be explained.
Method of getting machines’ adjusting time st and processing time ct is as follows. Obtain index of machine No. R (i, 4) in JB (R (i, 2). PR (R (i, 3). MN and assign it to id. Let st = JB (R (i, 2). PR (R (i, 3)). st (id). Let ct = JB (R (i, 2)). PR (R (i, 3)). ct (id).

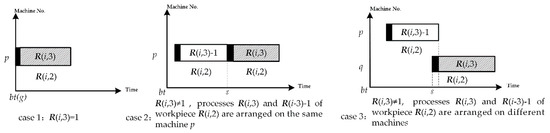

The method of getting the earliest adjustable start time g of process R (i, 3) of workpiece R (i, 2) is as follows. There are three cases, as shown in Figure 22. Case 1: When R (i, 3) = 1, let g = bt. Case 2: When R (i, 3) ≠ 1, process R (i, 3) and R (i, 3) − 1 of workpiece R (i, 2) are arranged on the same machine p. In this case, process R (i, 3) of workpiece R (i, 2) cannot be adjusted until process R (i, 3) − 1 is completed. So, we can assign the processing end time of process R (i, 3) − 1 of workpiece R (i, 2) to g. Assume that row No. of process R (i, 3) − 1 of workpiece R (i, 2) in R is h, let g = R (h, 10). Case 3: When R (i, 3) ≠ 1, process R (i, 3) and R (i, 3) − 1 of workpiece R (i, 2) are arranged on different machines. In this case, process R (i, 3) can start its adjusting st hours earlier than processing end time of process R (i, 3) − 1 of workpiece R (i, 2). Thus process R (i, 3) can be processed immediately once process R (i, 3) − 1 is finished. Assume that row No. of process R (i, 3) − 1 of workpiece R (i, 2) in R is h, the method to get g is as follows. Firstly, get work time t according to work calendar of machine R (i, 4) through the forward reckoning function Getat, namely let t = Getat (R (h, 10), R (i, 4)). Then, let g = Backwd (t, st, R (i,4)).

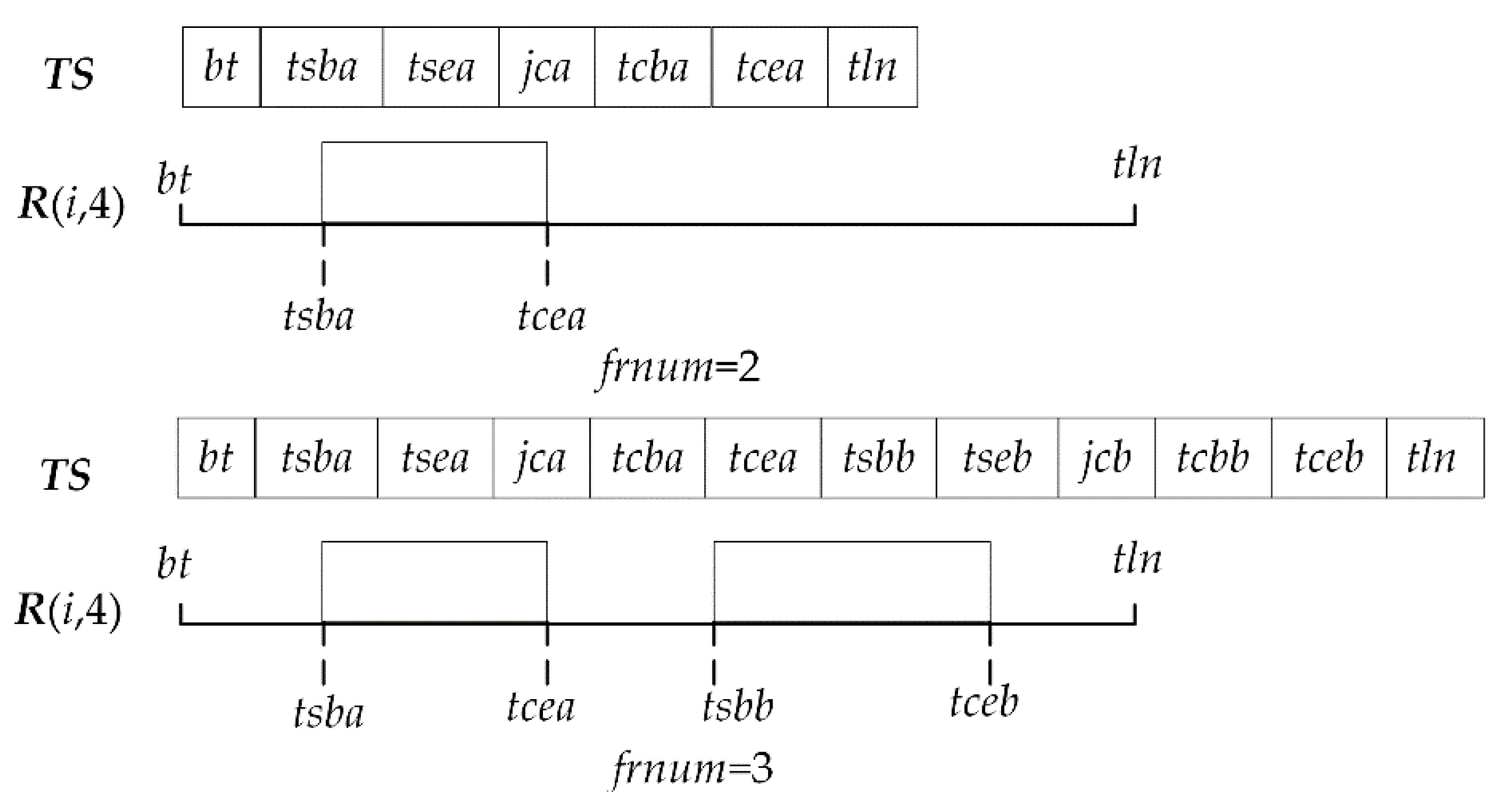

The method of updating ch.MMA (R (i, 4)).TS is as follows. In Figure 23, if machine R (i, 4) has been arranged one process a in the initial state, initial length of ch.MMA (R(i,4)).TS is 7. Namely there are only 7 elements in ch.MMA (R (i, 4)).TS which are scheduling start time bt, tsba (adjusting start time of process a), tsea (adjusting end time of process a), and jca (details of process a), tcba (processing start time of process a), tcea (processing end time of process a), large time number tln. There are two idle periods (Here frnum = 2), namely bt~tsba, tcea~tln. After process b is arranged on machine R (i, 4) (Assume that process b is arranged after processing end time of process a), five elements are inserted between tcea and tln, namely tsbb (adjusting start time of process b), tsbe (adjusting end time of process b), jcb (details of process b), tcbb (processing start time of process b) and tceb (processing end time of process b). Length of ch.MMA (R (i, 4).TS is added to 12. bt~tln is split further into 3 idle periods (Here frnum = 3), namely bt~tsba, tcea~tsbb, tceb~tln. By above method, with continuous arrangement of each process, the length of ch.MMA (R (i, 4)).TS is dynamically changed and its elements is dynamically updated. Assume that the insertion period is the kth idle period of machine R (i, 4), then update ch.MMA (R (i, 4)).TS as follows. Firstly, increase length of ch.MMA (R (i, 4)).TS by 5. Then, move data from the second datum of the kth idle period back 5 positions so as to obtain 5 empty positions. Finally, fill the adjusting start time, adjusting end time, process details, processing start time, and processing end time of the current process in the 5 empty positions.

5.10. Calculating Objectives

• Production cycle (ch.O (1))
Production cycle is the time span between processing start time and adjusting end time of the scheduled workpieces. Find the minimum value in column 7 of ch.R and assign it to s1. Find the maximum value in column 10 of ch.R and assign it to s2. Let ch.O (1) = s2 − s1.
• Total cost (ch.O(2))
Total cost is the sum of production cost c1, earlier completion cost c2, and delayed completion cost c3.
Production cost (c1): Production cost is the sum of adjusting cost and processing cost for all processes of scheduled workpieces. Because column 11 and column 12 of ch.R are the adjusting cost and processing cost of each process, sum column 11 and column 12, and assign it to c1.
Earlier completion cost (c2): The earlier completion cost of a workpiece is cost produced when the last process of it is finished earlier than its delivery time. It mainly represents storage cost. Sum earlier completion cost of each workpiece to obtain the total earlier completion cost of the scheduled workpieces. Assign it to c2. The earlier completion cost of workpiece i is equal to the product of earlier completion time and earlier completion fee rate. The method to get earlier completion time of workpiece i is as follows: Obtain the difference between delivery time of workpiece i and processing end time of the last process of workpiece i in column 10 of ch.R. Let earlier completion time of workpiece i be equal to the maximum value of the difference and 0.
Delayed completion cost (c3): The delayed completion cost of a workpiece is cost produced when the last process of it is finished later than its delivery time. It mainly represents penalty fine, crush cost and so on. Sum delayed completion cost of each workpiece to get total delayed completion cost of the scheduled workpieces. Assign it to c3. The delayed completion cost of workpiece i is equal to the product of delayed completion time and delayed completion rate. The method to get delayed completion time of workpiece i is as follows: Obtain the difference between processing end time of the last process of workpiece i in column 10 of ch.R and delivery time of workpiece i. Let delayed completion time of workpiece i be equal to the maximum value of the difference and 0.
After getting c1, c2, and c3, sum them to ch.O (2).

6. Case Study

The information of the workpieces to be produced in a job shop is shown in Table 3. The process flow is shown in Table 4. There are 18 machines. The information of the machines is shown in Table 5. There are 3 work systems for the machines which are work system X, Y and Z. Their settings are shown in Figure 24. There are 3 work shifts for the machines which are work shift A, B and C. Their settings are shown in Figure 25.
• No. 1 schedule
Start time of No. 1 schedule is 2017/3/4 8:00:00. It aims to arrange processing tasks of three workpieces on 18 machines. The information of the scheduled workpieces is shown in Table 6. Initial time status of the machines is shown in Figure 26. Other parameters are shown in Table 7.
Let the algorithm run independently 20 times. The calculation time of each evolutionary calculation is about 40 s. Each evolutionary calculation can obtain almost the same and uniform Pareto solution set. This shows that convergence effect is good. The Pareto solution set obtained by one of the evolutionary calculations is shown in Figure 27. The dispatcher can select one of the Pareto solutions to arrange production. The schedule table of a Pareto solution (production cycle is 12.28 days, total cost is 105,226.84 yuan) is shown in Table 8. A Gantt chart of the scheduled workpieces and a Gantt chart of the machines are shown in Figure 28 and Figure 29.

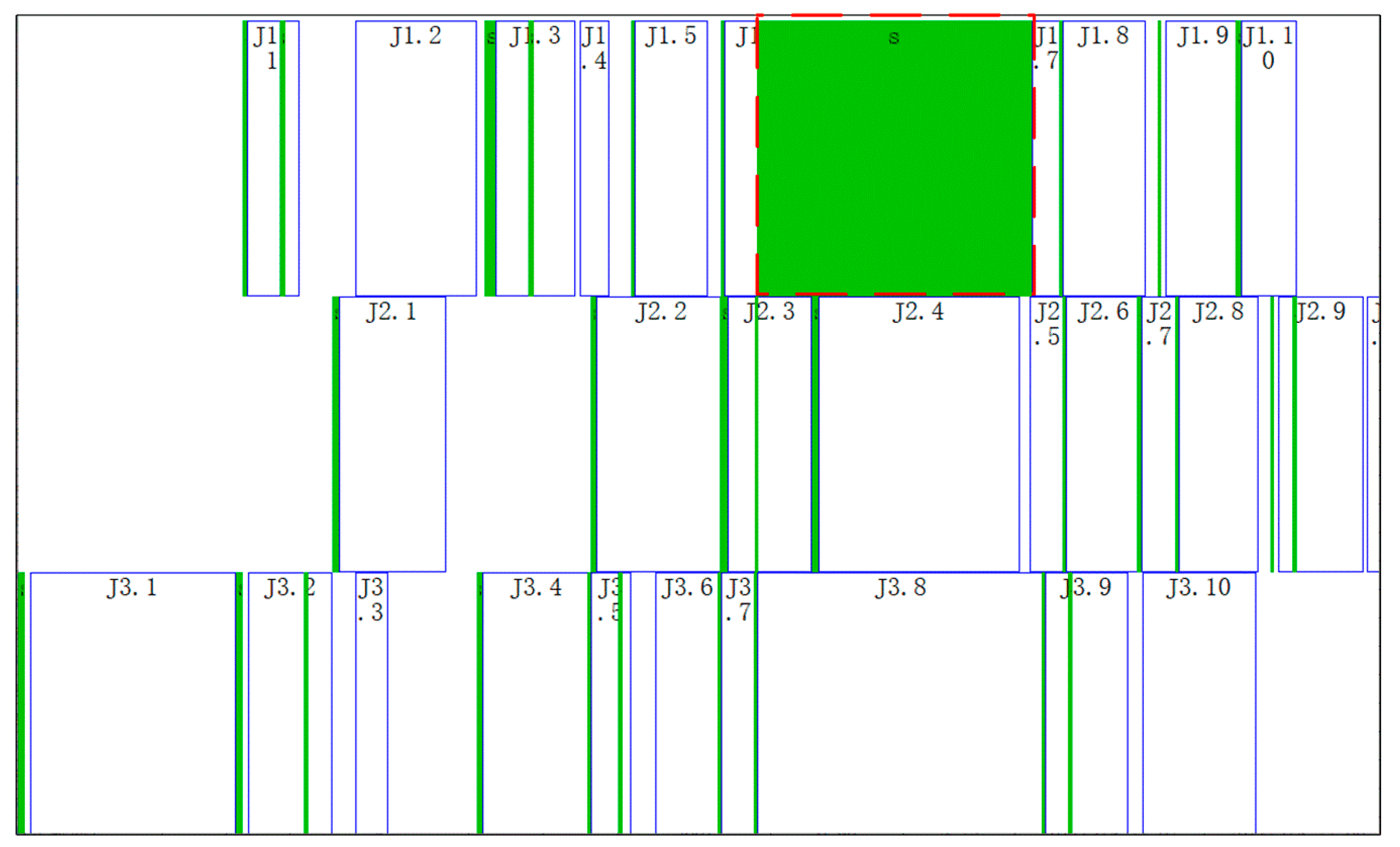

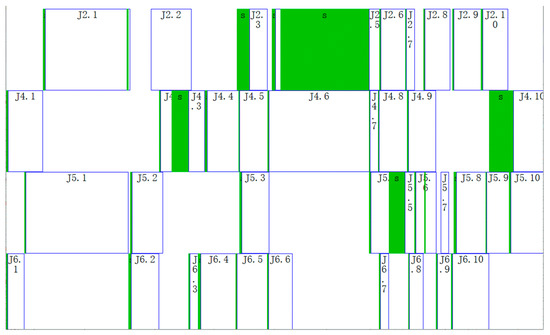

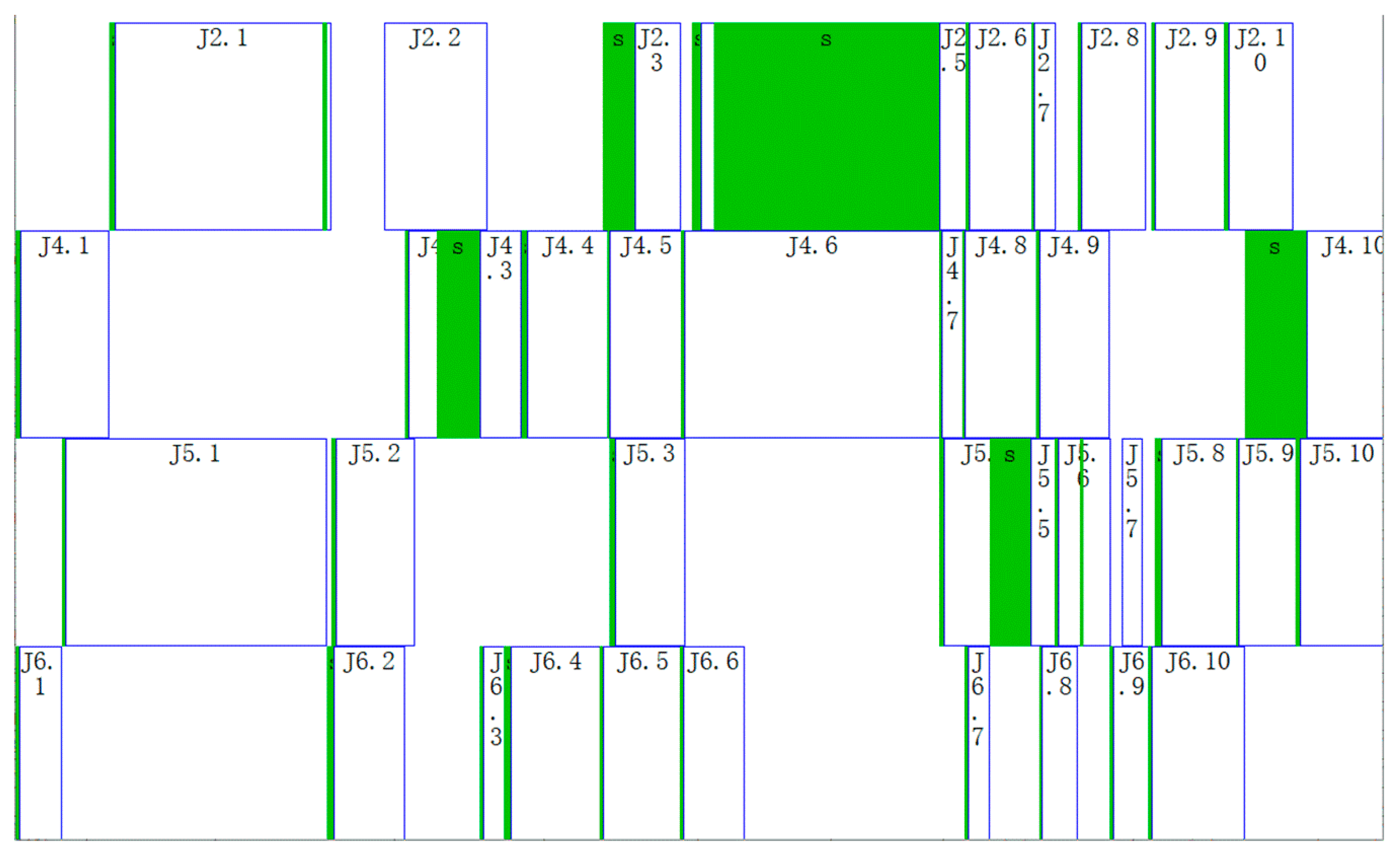

In Figure 28 and Figure 29, the boxes with s identifier indicate adjusting start-end periods of processes, and the boxes with M or J identifier indicate processing start-end periods of processes. For example, the dotted box in Figure 28 indicates adjusting the start-end period of the 7th process of workpiece 1. The righthand box close to it indicates processing the start-end period of the 7th process of workpiece 1 (In row 19 of Table 8). As can be seen from row 19 of Table 8, this process is arranged on machine 10 and the adjusting start time, adjusting end time, processing start time and processing end time of this process is respectively 2017/3/10 21:45, 2017/3/13 8:23, 2017/3/13 8:23 and 2017/3/13 15:00. According to work calendar of machine 10 (M5515), we can know that calendar time between 2017/3/10 21:45 and 2017/3/13 8:23 is 58.64 h, but work time is only 0.64 h; Calendar time between 2017/3/13 8:23 and 2017/3/13 15:00 is 6.625 h, but work times are 5.625 h. 0.64 h and 5.625 h consistent with adjusting time st and processing time ct in Table 8. This shows that the result of time reckoning according to the machines’ work calendars in the algorithm is correct.
In Table 8 the sequence of processes on machine 4 (T42) is J3.1, J3.2, J2.1, J2.3, J1.3 and J2.4 can be seen to be in ascending order by No. However, it can be seen from Figure 29 that the sequence of processes on machine 4 from left to right is J3.1, J3.2, J2.1, J1.3, J2.3 and J2.4. The above two sequences are not consistent. The reason for this phenomenon is that “extrusion insertion” method is adopted in decoding operation. This method can reduce idle time of the machines as much as possible and shorten production cycle.
• No.2 schedule
The information of scheduled workpieces of No.2 schedule is shown in Table 9. The start time of No.2 schedule is 2017/3/10 8:00:00. Another condition is the same as No.1 schedule. The Pareto solution set is shown in Figure 30. Calculation time is about 40 s. The dispatcher can select one of the Pareto solutions to arrange production. The Gantt chart of the scheduled workpieces and Gantt chart of the machines of the Pareto solution (Production cycle is 16.64 days and total cost is 131,805.00 yuan) are shown in Figure 31 and Figure 32. After the No.1 and No. 2 schedules, the Gantt chart of the machines is shown in Figure 33.

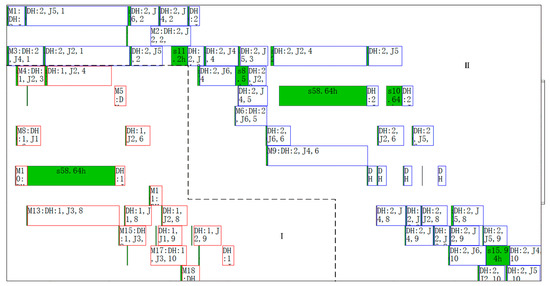

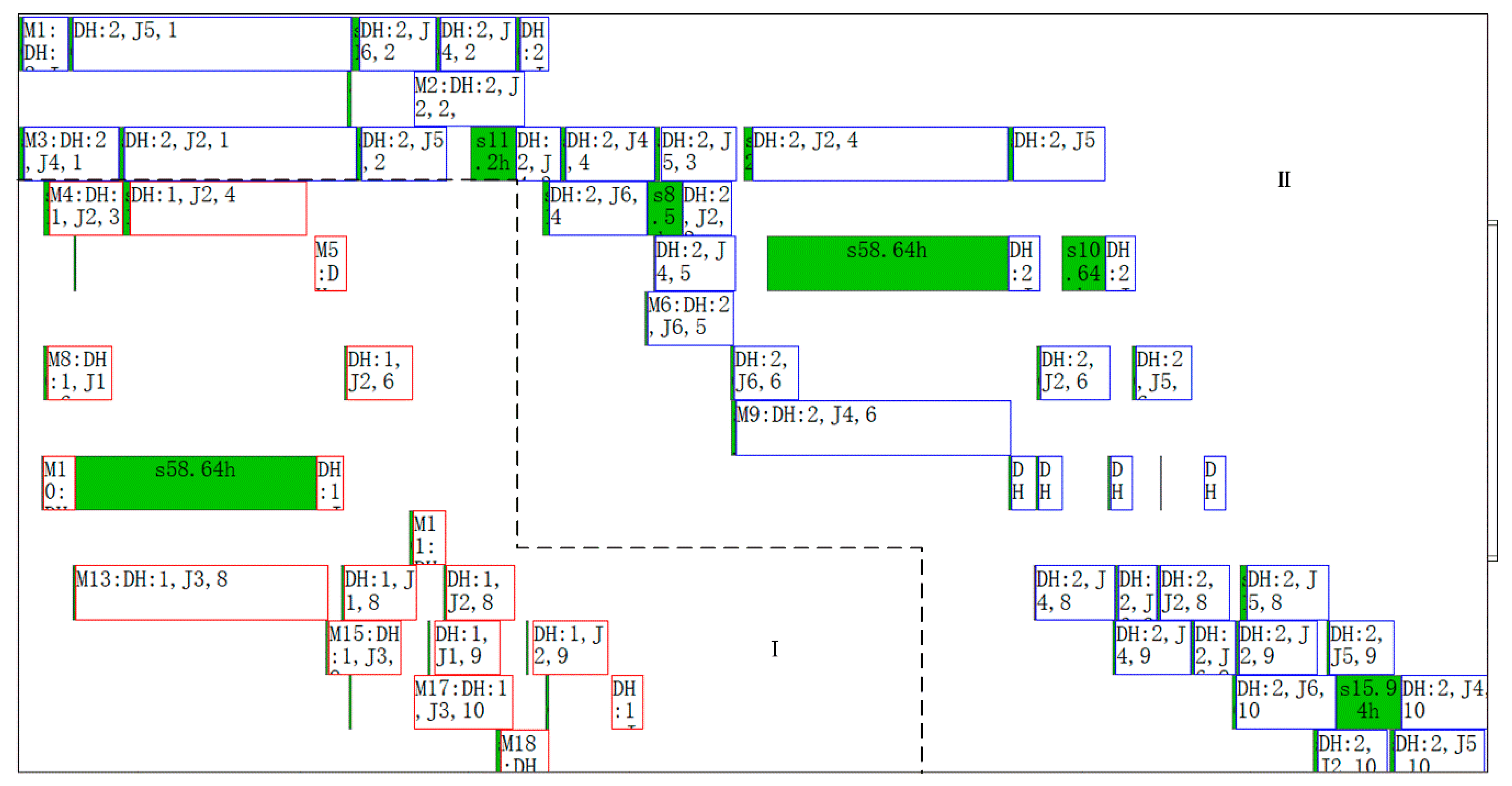

The dotted box I is a part of the Gantt chart of the No.1 schedule. The dotted box II is the Gantt chart of the No.2 schedule. It can be seen from Figure 33 that this is a typical sequential scheduling process based on the machines’ work calendars.

7. Discussion

Because NSGA-II has a fast non-dominated sorting algorithm, elite strategy, congestion degree and congestion degree comparison operator, it retains the best of all individuals in the offspring, which improves the precision of the optimization result, the operation speed and robustness of the algorithm.
However, the case study shows that the speed of operation needs to be further increased, and the calculation time is further reduced for actual production. The algorithm considers the mixed work calendars phenomenon in actual production, so that it is consistent with reality. Meanwhile, the algorithm results are more practical, and the method can also shorten the production cycle. The scheduling scheme proposed in this paper is not the best, but it is most suitable for the actual production process.
The next step is to continue to optimize the algorithm, further reduce the computation time and algorithm complexity, and obtain a better Pareto solution set.

8. Conclusions

In order to solve the sequential scheduling problem for FJSP with multi-objectives under mixed work calendars, an optimization method based on NSGA-II is proposed. The research conclusions are as follows.
  • The algorithm can ensure feasibility of the scheduling scheme by accurately calculating adjusting start and end time, processing start and end time of each process through time reckoning functions in the process of arranging processes.
  • The algorithm can increase the utilization rate of the machines in the sequential scheduling by the following two technologies. One is taking the time status of the machines of the previous schedule as the initial status of the machines of the next schedule. The other is adopting the “extrusion insertion” method to arrange each process.
  • The proposed method can help to obtain an effective Pareto solution set of the sequential scheduling problem for FJSP with multi-objectives under mixed work calendars for the dispatcher to make decisions in acceptable time.

Author Contributions

Q.Z. designed and performed the experiments; L.S. provided analysis software; H.S. and M.W. analyzed the data; M.W. organized the data and wrote the paper.

Funding

This research was funded by the Research Fund for universities of Henan Province (grant number: 19A410001), and the Research Fund for Doctoral Program of Henan Polytechnic University (grant number: B2011-088).

Conflicts of Interest

The authors declare no conflict of interest.

References

  1. Gao, L.; Pan, Q.K. A shuffled multi-swarm micro-migrating birds optimizer for a multi-resource-constrained flexible job shop scheduling problem. Inf. Sci. 2016, 372, 655–676. [Google Scholar] [CrossRef]
  2. Amirghasemi, M.; Zamani, R. An effective asexual genetic algorithm for solving the job shop scheduling problem. Comput. Ind. Eng. 2015, 83, 123–138. [Google Scholar] [CrossRef]
  3. Kundakci, N.; Kulak, O. Hybrid genetic algorithms for minimizing makespan in dynamic job shop scheduling problem. Comput. Ind. Eng. 2016, 96, 31–51. [Google Scholar] [CrossRef]
  4. Xiong, W.; Li, Z.B.; Hao, J.B. Research on methods to solve key problems of dynamic job shop scheduling. Modul. Mach. Tool Autom. Manuf. Tech. 2008, 7, 105–108, 112. [Google Scholar]
  5. Wu, Z.J.; Ning, R.X.; Wan, C.H. Research and Implementation of Dynamic Workday System in Job Shop Scheduling. Manuf. Autom. 2006, 4, 46–48, 75. [Google Scholar]
  6. Huang, Y.Y.; Li, K.Q.; Zheng, X.F. Job Shop Equal-Scale Batch Scheduling Algorithm Considering Shift Constraints. Sci. Technol. Eng. 2013, 1, 1–7, 16. [Google Scholar]
  7. Stefan, K.; Julia, R.; Jürgen, Z. Models and solution procedures for the resource-constrained project scheduling problem with general temporal constraints and calendars. Eur. J. Oper. Res. 2016, 251, 387–403. [Google Scholar]
  8. Wan, C.H.; Yan, Y.; Wu, Z.J.; Wang, G.X. Research on Dynamic Workday System for Dynamic Scheduling of Workshop Production. Modul. Mach. Tool Autom. Manuf. Tech. 2006, 3, 102–104. [Google Scholar]
  9. Wu, X.L.; Sun, S.D.; Yu, J.J.; Zhang, H.F. Research on Multi-Objective Flexible Job Shop Scheduling Optimization. Comput. Integr. Manuf. Syst. 2006, 5, 731–736. [Google Scholar]
  10. He, G.X. The application of multi-objective programming in the problem of transshipment of railway partial load freight. China Railw. Sci. 2007, 4, 111–116. [Google Scholar] [CrossRef]
  11. Zhou, G.G. Efficiency coefficient method for solving multi-objective optimization problems. J. Shanghai Inst. Meenanical Eng. 1987, 3, 103–108. [Google Scholar]
  12. Song, L.F.; Wei, G.; Wang, Q.S. Segmentation of Video Objects by Multi-Objective Optimization of Contour Positioning. J. Electron. Inf. Technol. 2002, 11, 1551–1558. [Google Scholar]
  13. Wang, B.G.; Rao, Y.Q.; Shao, X.Y.; Xu, C. A MOGA-based Algorithm for Sequencing a Mixed-model Fabrication/Assembly System. China Mech. Eng. 2009, 20, 1434–1438. [Google Scholar]
  14. Liu, A.J.; Yang, Y.; Xing, Q.S.; Lu, H.; Zhang, Y.D. Research on Niche Genetic Annealing Algorithm with Elite Strategy and Its Applications. China Mech. Eng. 2012, 23, 556–563. [Google Scholar]
  15. Zitzler, E.; Thiele, L. Multi-objective evolutionary algorithms: A comparative case study and the strength pareto approach. IEEE Trans. Evolut. Comput. 1993, 3, 257–271. [Google Scholar] [CrossRef]
  16. Zitzler, E.; Laumanns, M.; Thiele, L. SPEA2: Improving the strength pareto evolutionary algorithm for multi-objective optimization. In Proceedings of the Evolutionary Methods for Design, Optimization and Control with Applications to Industrial Problems (EUROGEN’2001), Athens, Greece, 19–21 September 2001; pp. 95–100. [Google Scholar]
  17. Ju, L.Y.; Yang, J.J.; Zhang, J.B.; Guo, L.L.; Li, S.B. Improved NSGA for Multi-Objective Flexible Job-Shop Scheduling Problem. Comput. Eng. Appl. 2019, 55, 260–265, 270. [Google Scholar]
  18. Qiu, Z.P.; Zhang, Y.X. Application of Improved Genetic Algorithm in Aircraft Overall Parameter Optimization. J. Beijing Univ. Aeronaut. Astronaut. 2008, 10, 1182–1185. [Google Scholar]
  19. Bekkar, A.; Guemri, O.; Bekrar, A.; Aissani, N.; Beldjilali, B.; Trentesaux, D. An Iterative Greedy Insertion Technique for Flexible Job Shop Scheduling Problem. IFAC-Pap. Online 2016, 12, 1956–1961. [Google Scholar] [CrossRef]
  20. Chen, H.P.; Gu, F.; Lu, B.Y.; Gu, C.S. Application of Self-Adaptive Multi-Objective Genetic Algorithm in Flexible Job Shop Scheduling. J. Syst. Simul. 2006, 18, 2271–2274, 2288. [Google Scholar]

Figure 1. Custom type.
Figure 1. Custom type.
Processes 07 00888 g001

Figure 2. Worksheet “work systems”.
Figure 2. Worksheet “work systems”.
Processes 07 00888 g002

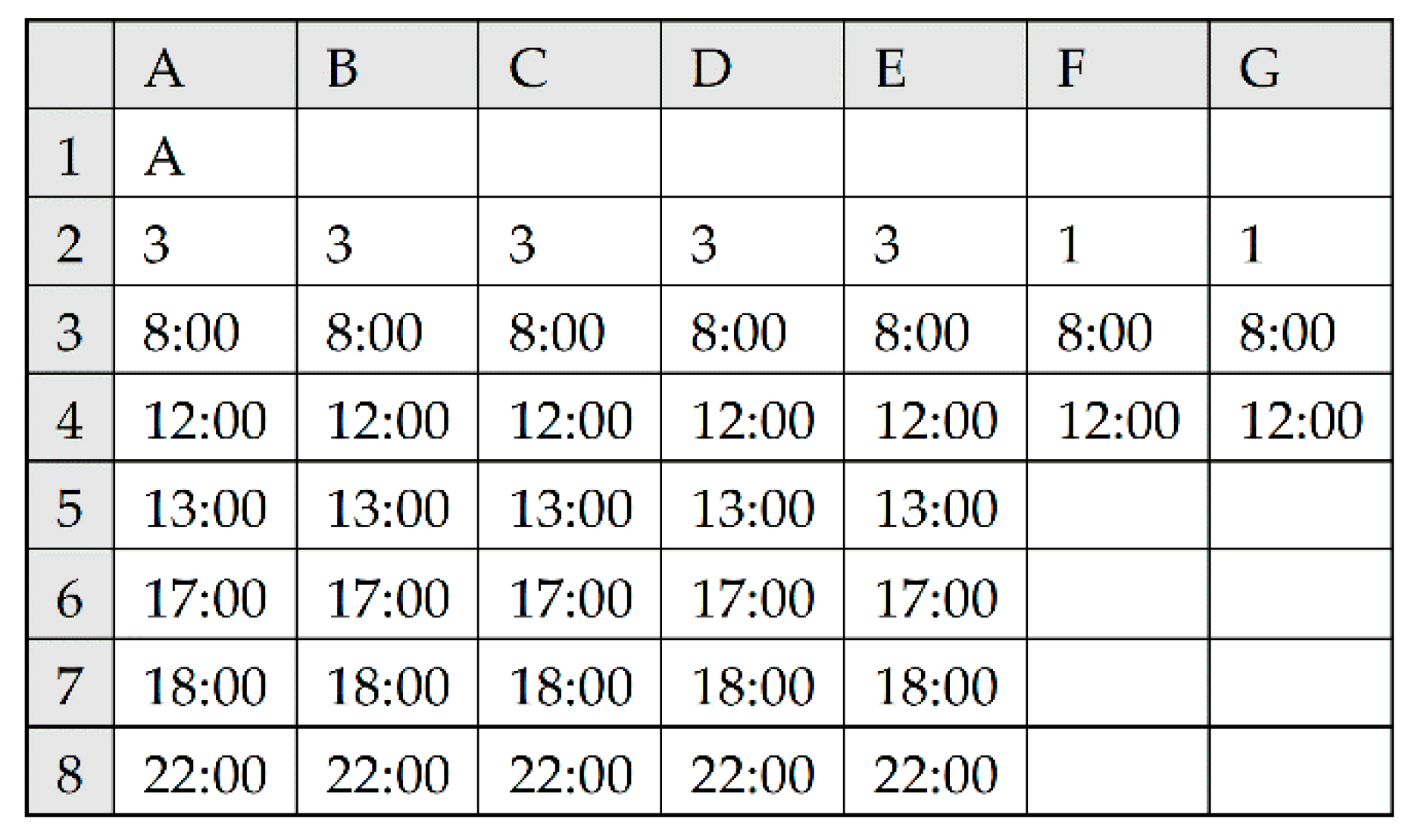

Figure 3. Worksheet “work shifts”.
Figure 3. Worksheet “work shifts”.
Processes 07 00888 g003

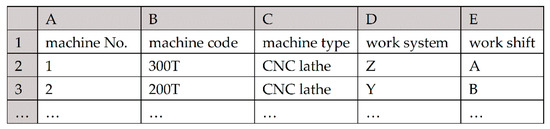

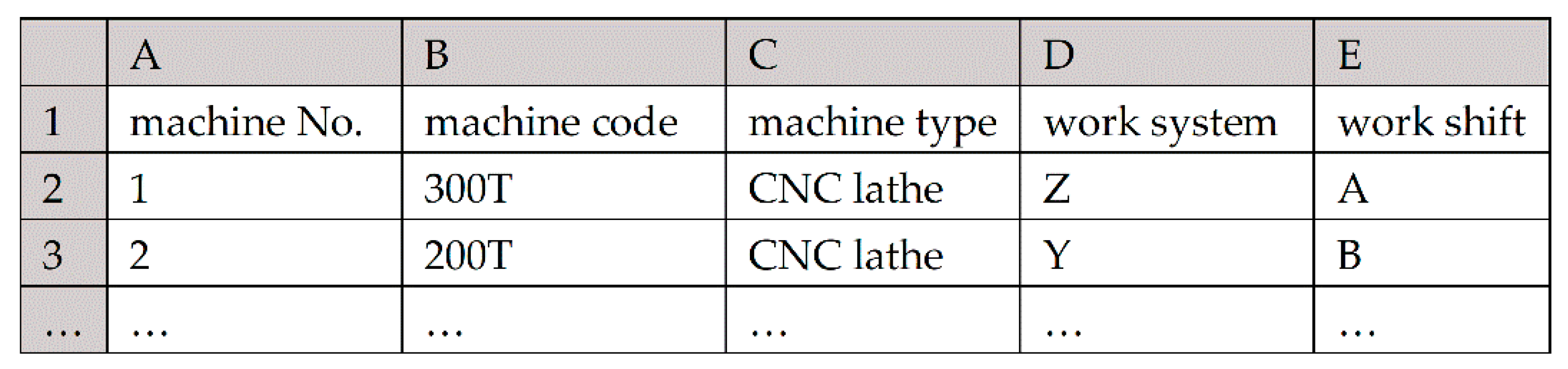

Figure 4. Worksheet “machines”.
Figure 4. Worksheet “machines”.
Processes 07 00888 g004

Figure 5. Flow of function Isworkday.
Figure 5. Flow of function Isworkday.
Processes 07 00888 g005

Figure 6. Flow of function Nextworkday.
Figure 6. Flow of function Nextworkday.
Processes 07 00888 g006

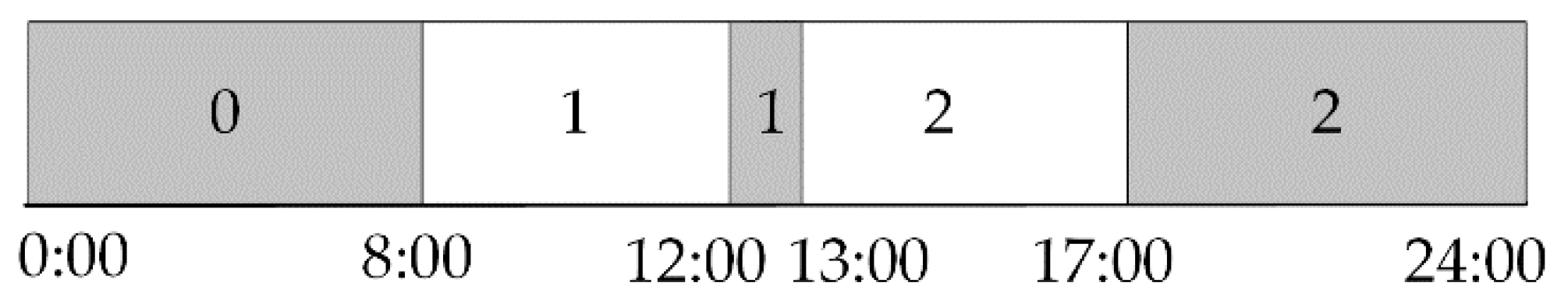

Figure 7. Work and non-work periods on one day of a machine.
Figure 7. Work and non-work periods on one day of a machine.
Processes 07 00888 g007

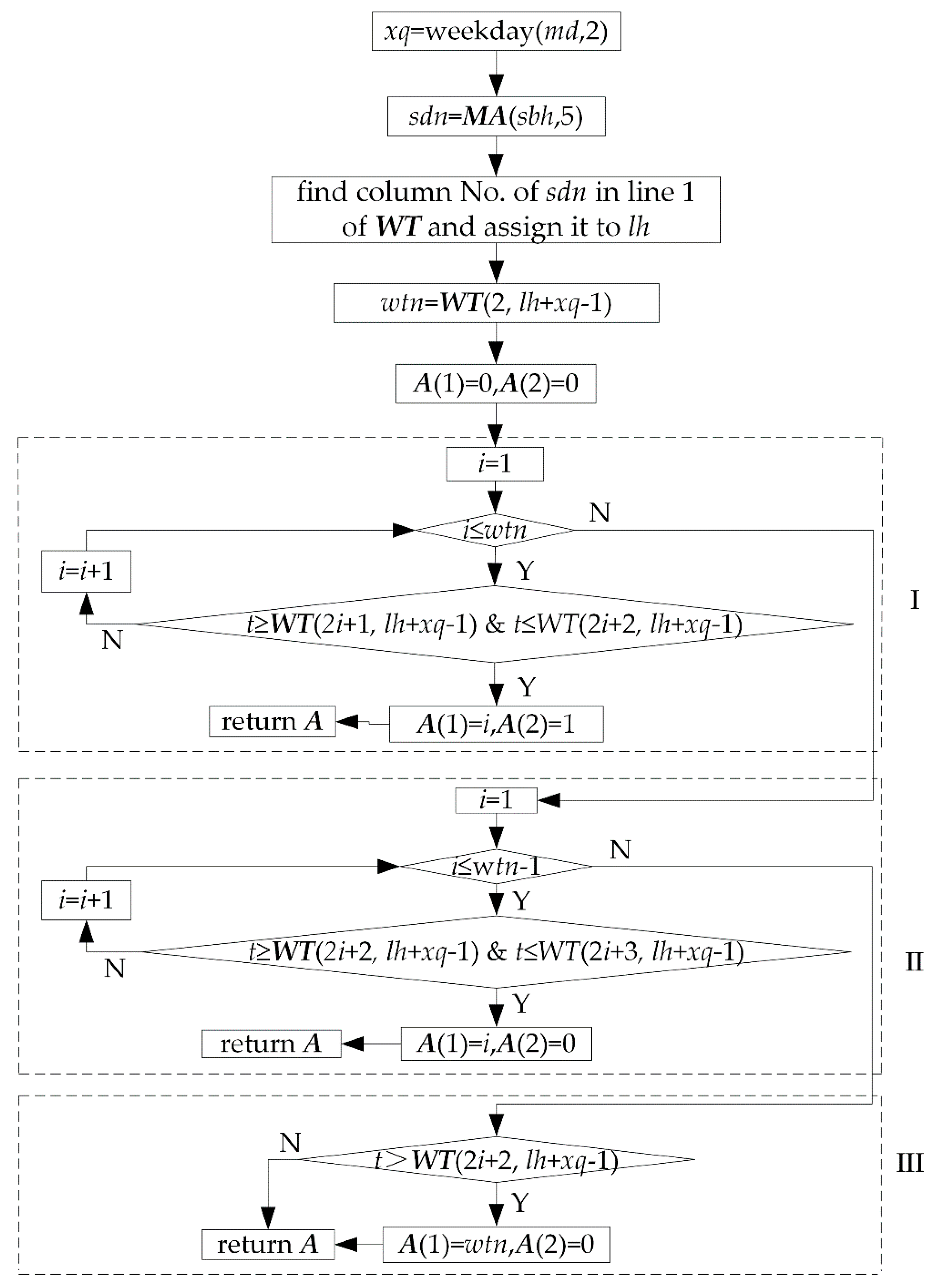

Figure 8. Flow of function Getsd.
Figure 8. Flow of function Getsd.
Processes 07 00888 g008

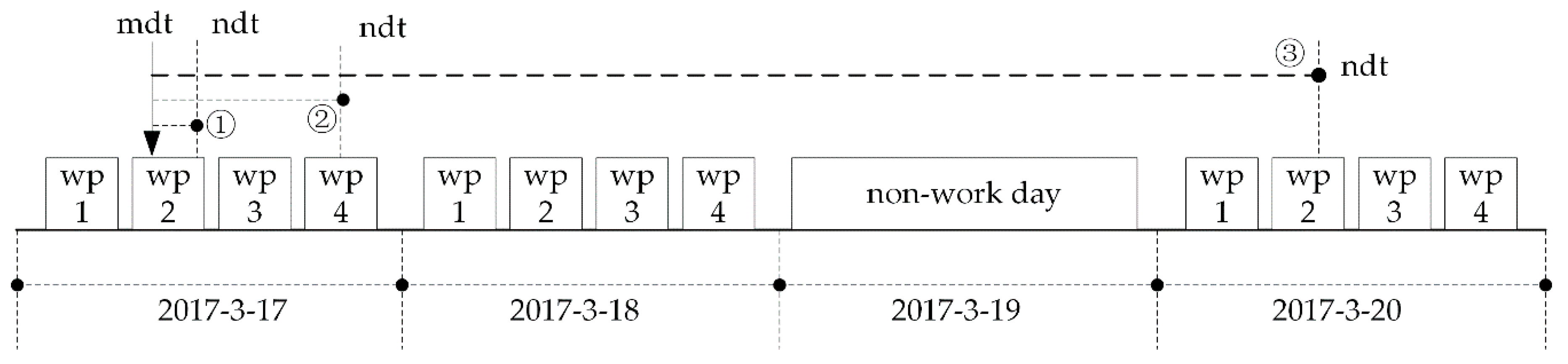

Figure 9. Schematic diagram of forward reckoning.
Figure 9. Schematic diagram of forward reckoning.
Processes 07 00888 g009

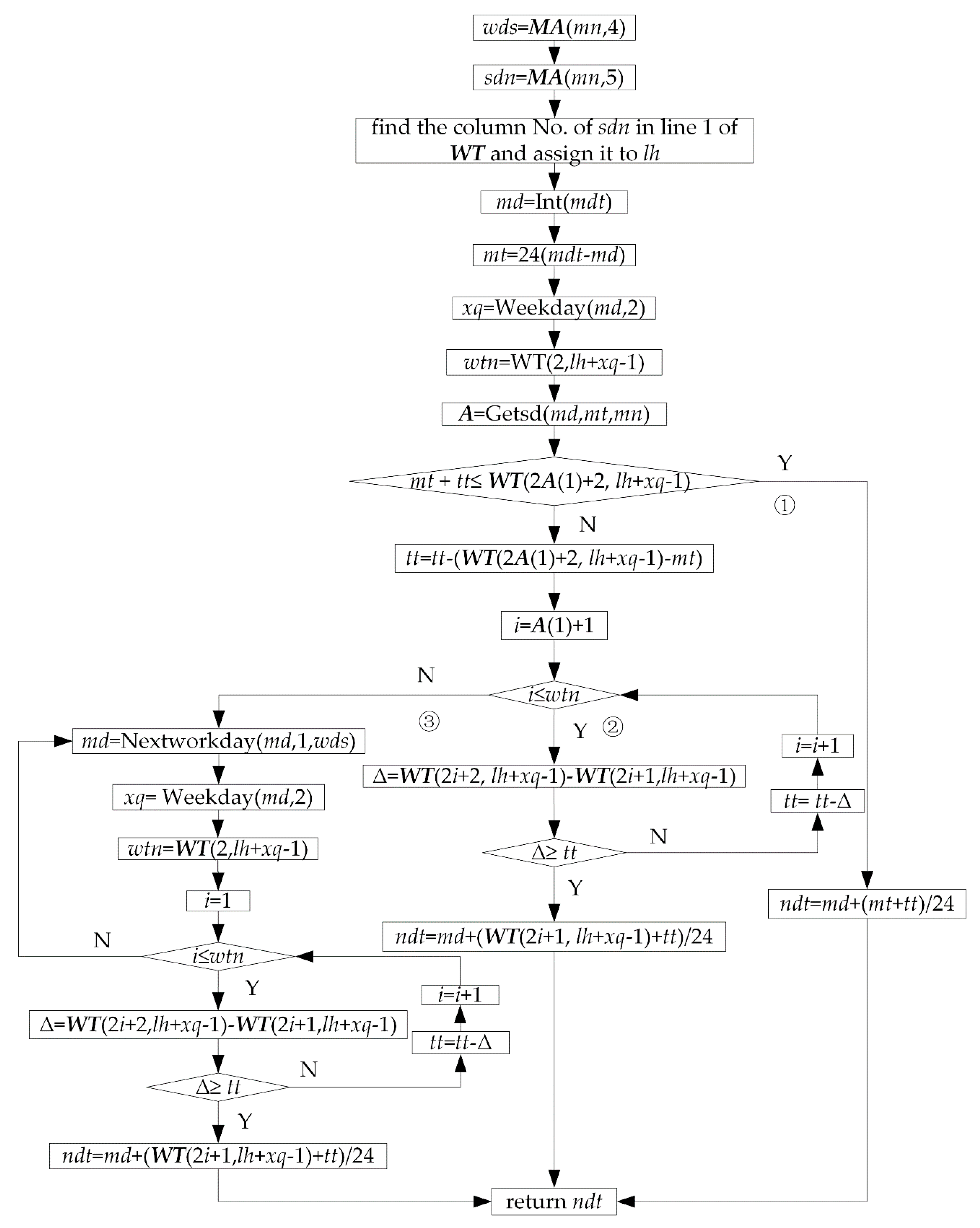

Figure 10. Flow of function forward.
Figure 10. Flow of function forward.
Processes 07 00888 g010

Figure 11. Getting the earliest work time.
Figure 11. Getting the earliest work time.
Processes 07 00888 g011

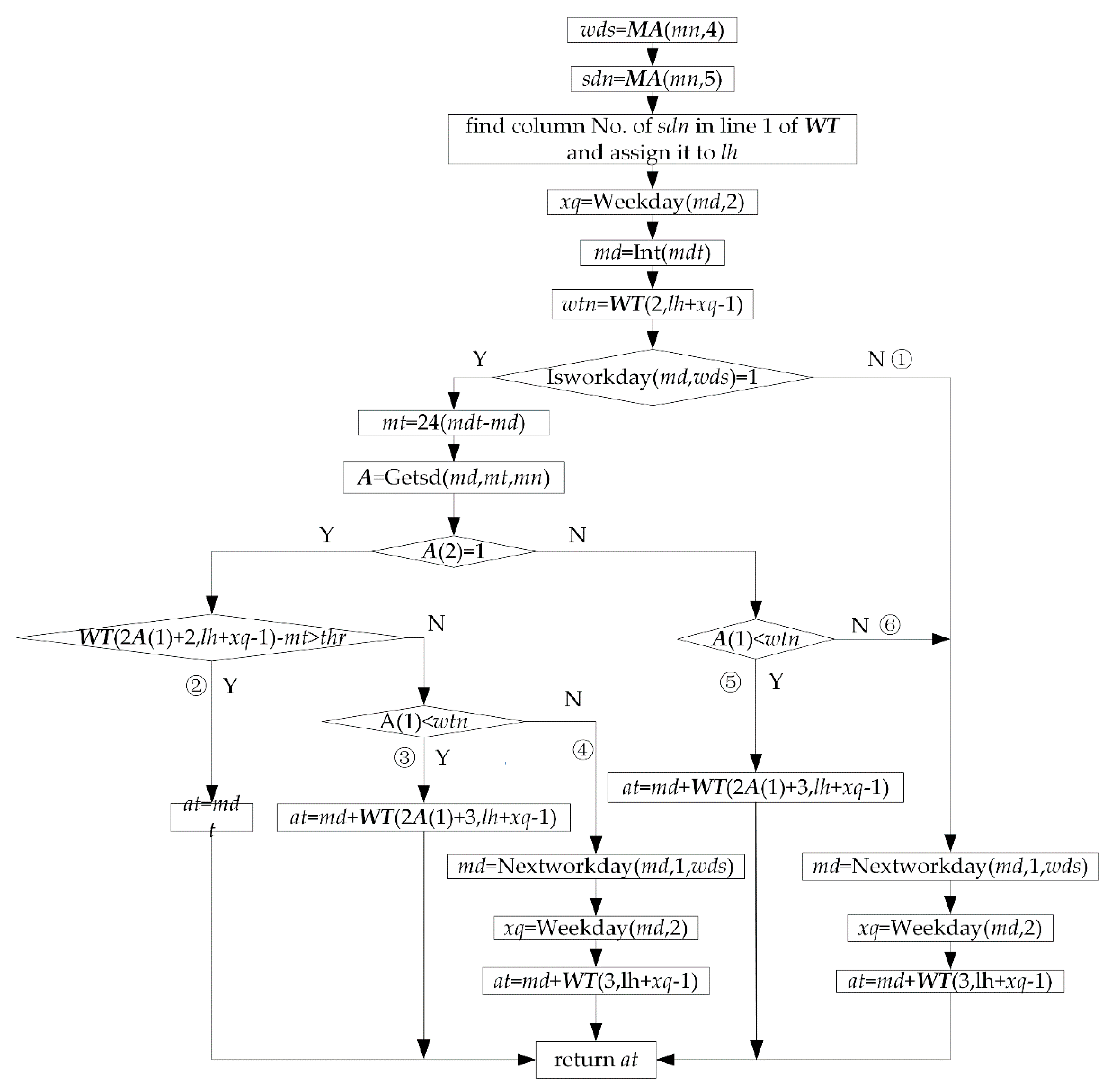

Figure 12. Flow of function Getat.
Figure 12. Flow of function Getat.
Processes 07 00888 g012

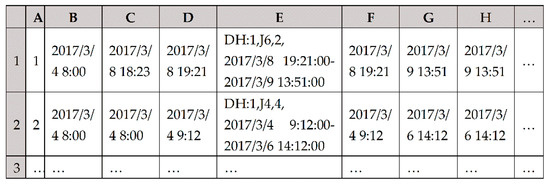

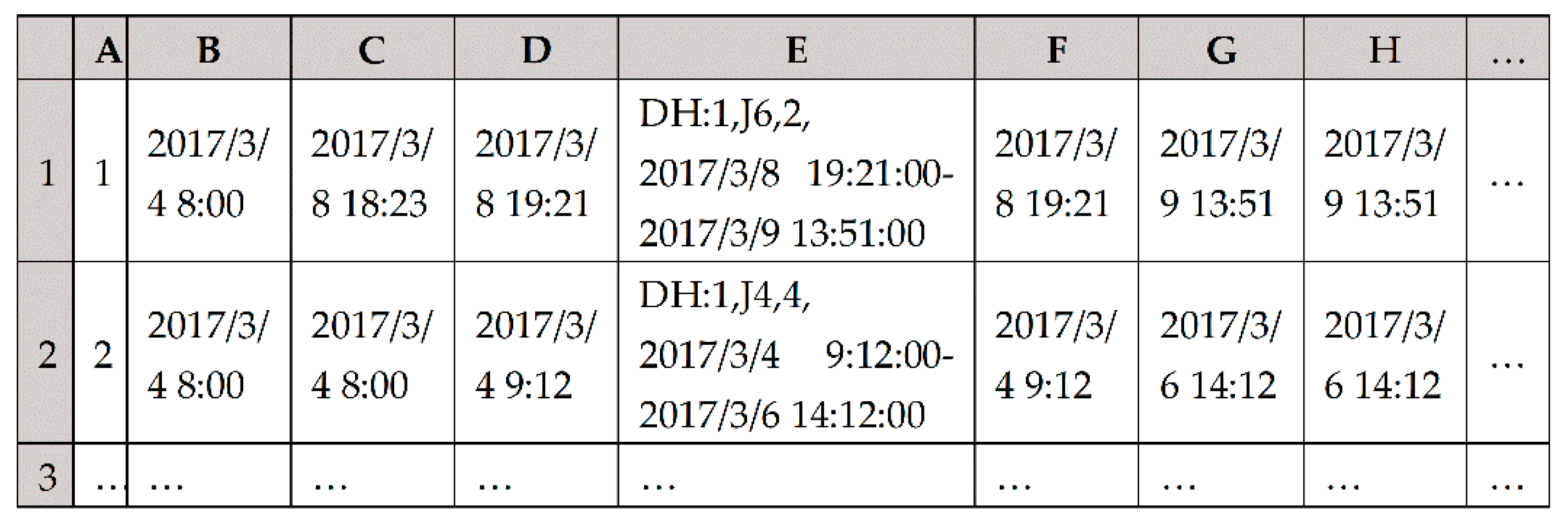

Figure 13. Worksheet “machines’ time status”.
Figure 13. Worksheet “machines’ time status”.
Processes 07 00888 g013

Figure 14. Constructing machines’ time status before scheduling.
Figure 14. Constructing machines’ time status before scheduling.
Processes 07 00888 g014

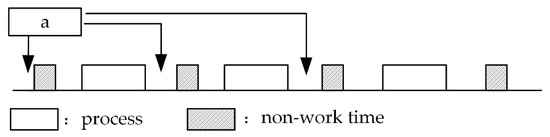

Figure 15. Process arrangement by means of extrusion insertion.
Figure 15. Process arrangement by means of extrusion insertion.
Processes 07 00888 g015

Figure 16. Worksheet “Pareto solution set”.
Figure 16. Worksheet “Pareto solution set”.
Processes 07 00888 g016
Figure 17. Algorithm flowchart.
Figure 17. Algorithm flowchart.
Processes 07 00888 g017

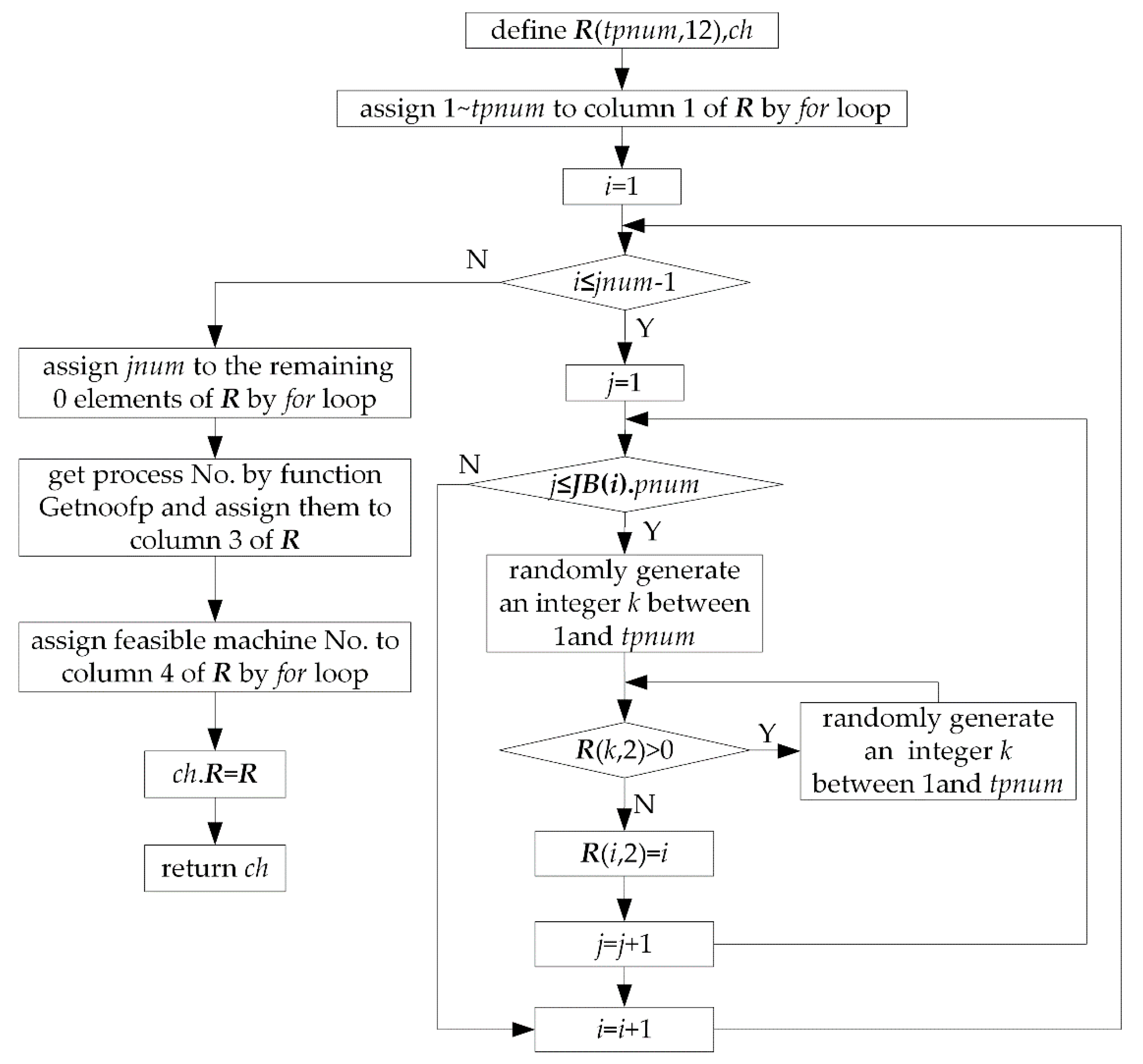

Figure 18. Flow of population initialization.
Figure 18. Flow of population initialization.
Processes 07 00888 g018

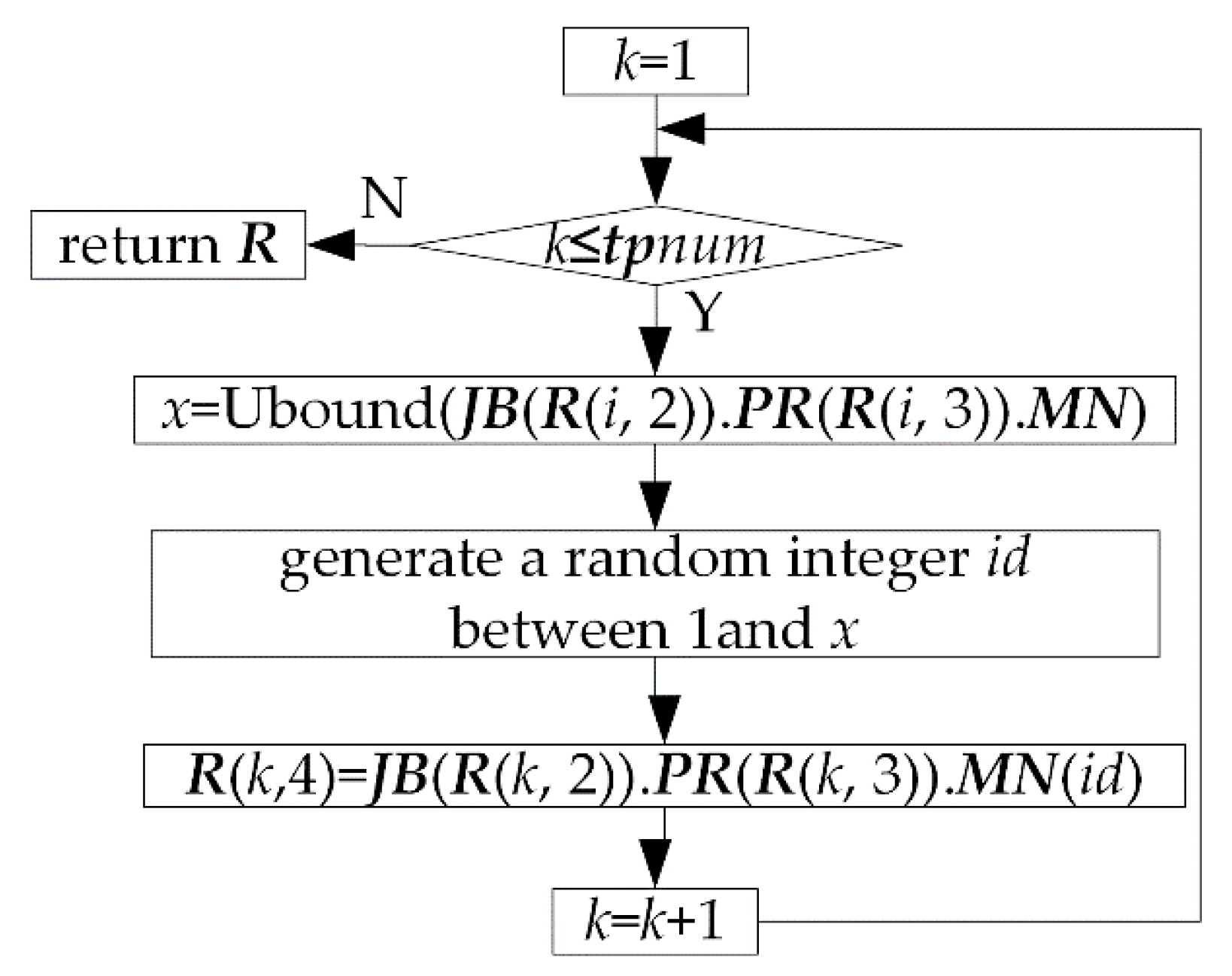

Figure 19. Assigning machine No. to column 4 of R.
Figure 19. Assigning machine No. to column 4 of R.
Processes 07 00888 g019

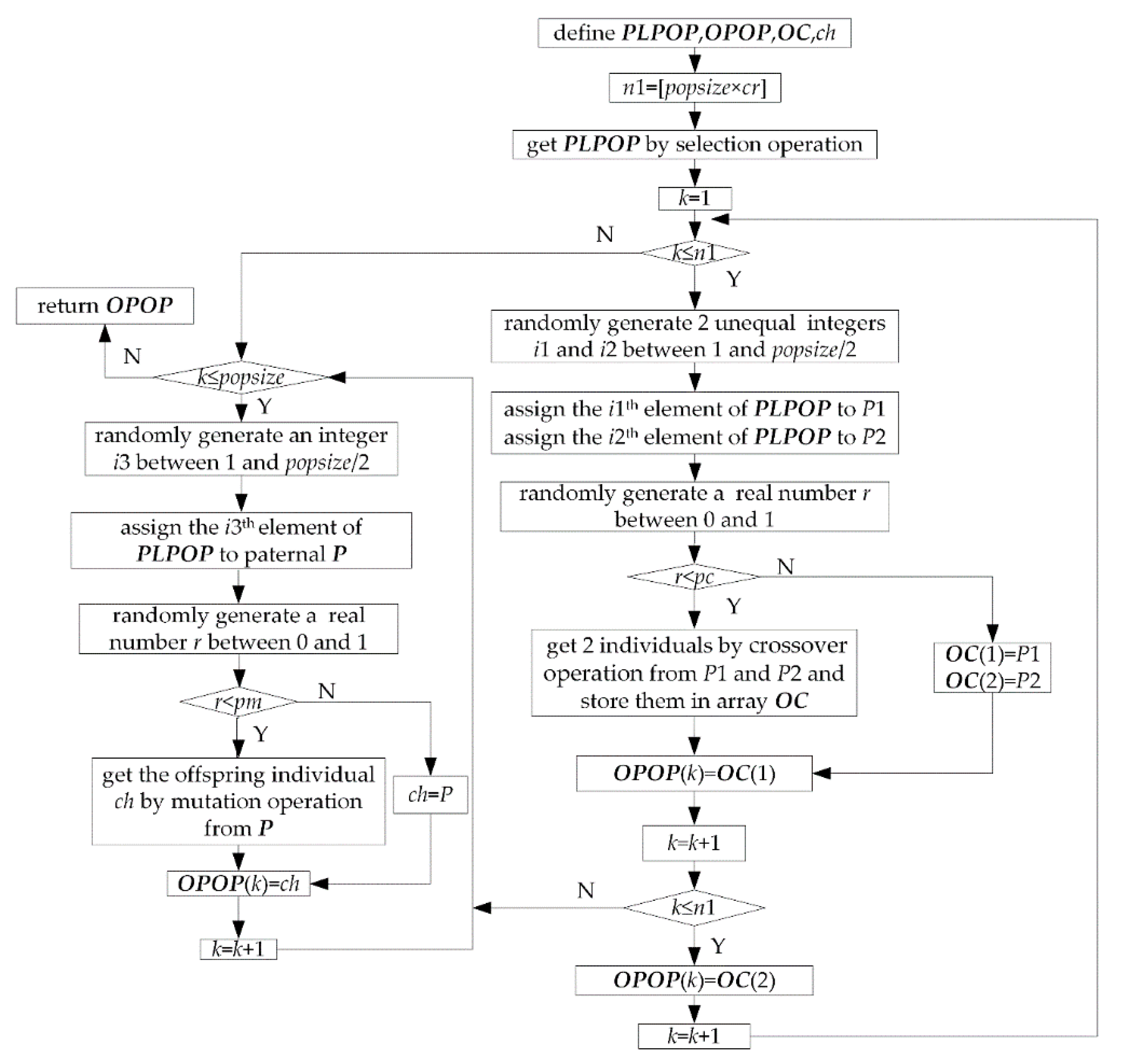

Figure 20. Flow of genetic operation.
Figure 20. Flow of genetic operation.
Processes 07 00888 g020

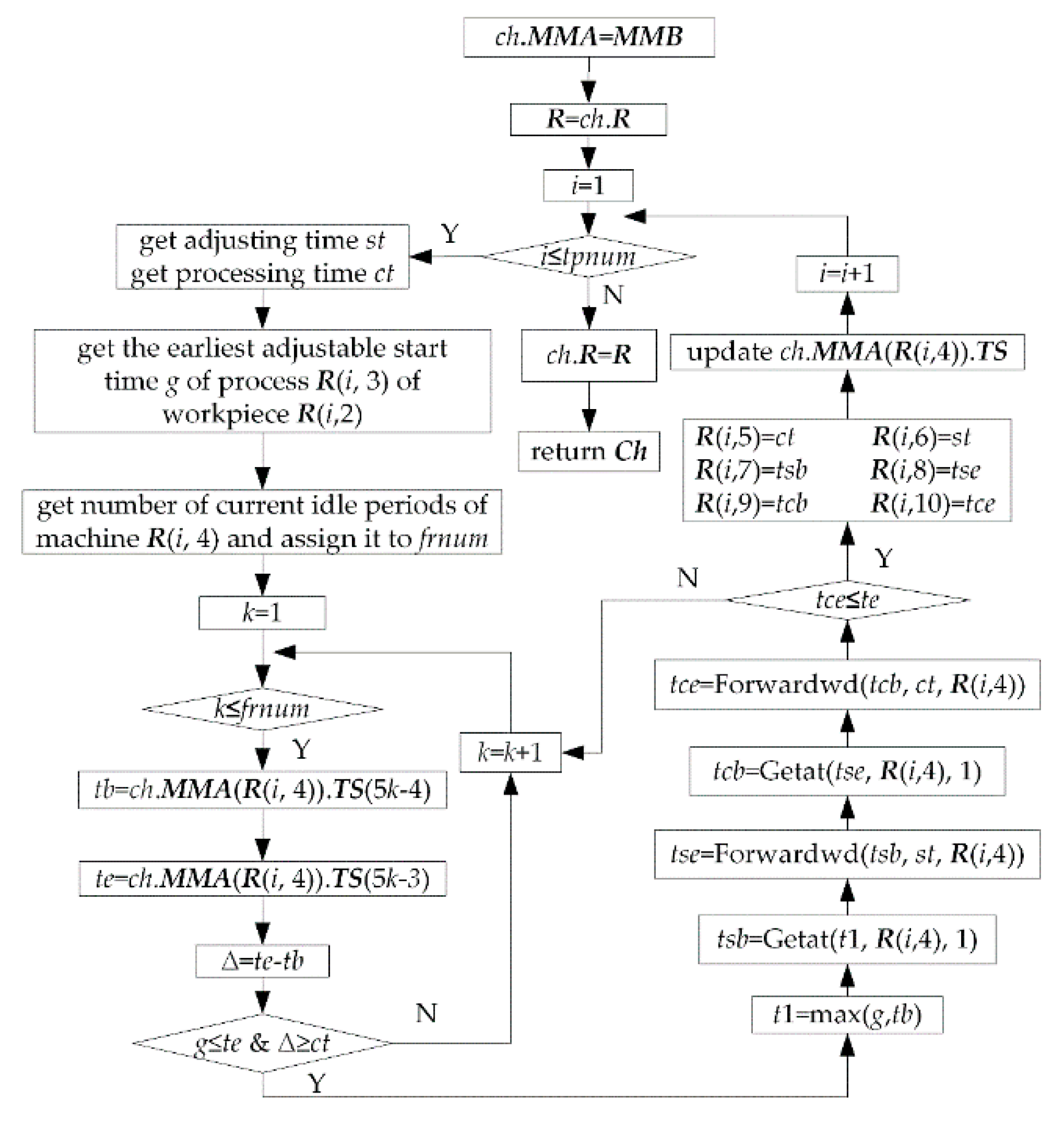

Figure 21. Decoding operation.
Figure 21. Decoding operation.
Processes 07 00888 g021

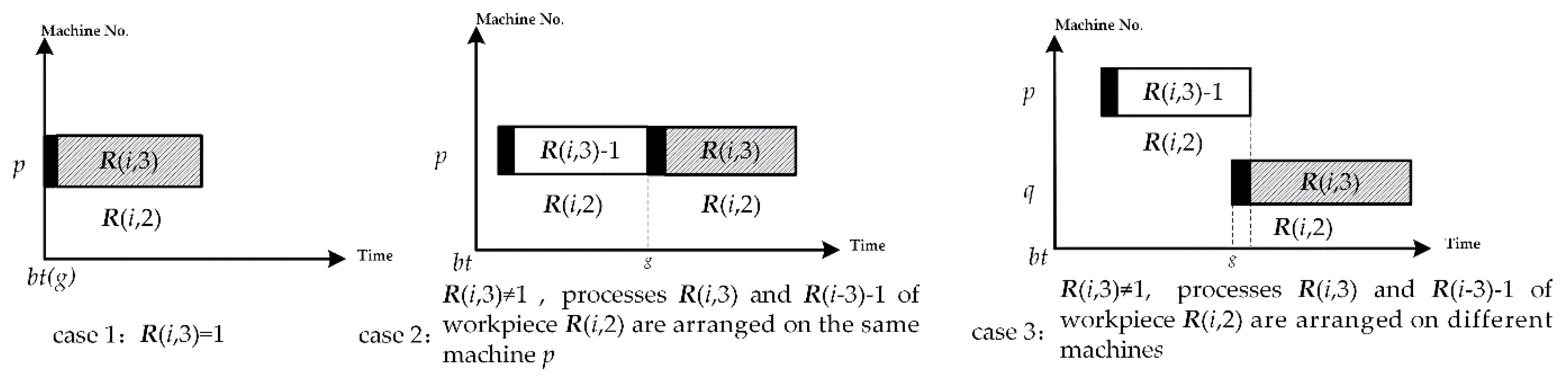

Figure 22. Obtaining the earliest adjustable start time g for process R (i, 3) of workpiece R (i, 2).
Figure 22. Obtaining the earliest adjustable start time g for process R (i, 3) of workpiece R (i, 2).
Processes 07 00888 g022
Figure 23. Updating ch.MMA (R (i, 4)).TS.
Figure 23. Updating ch.MMA (R (i, 4)).TS.
Processes 07 00888 g023

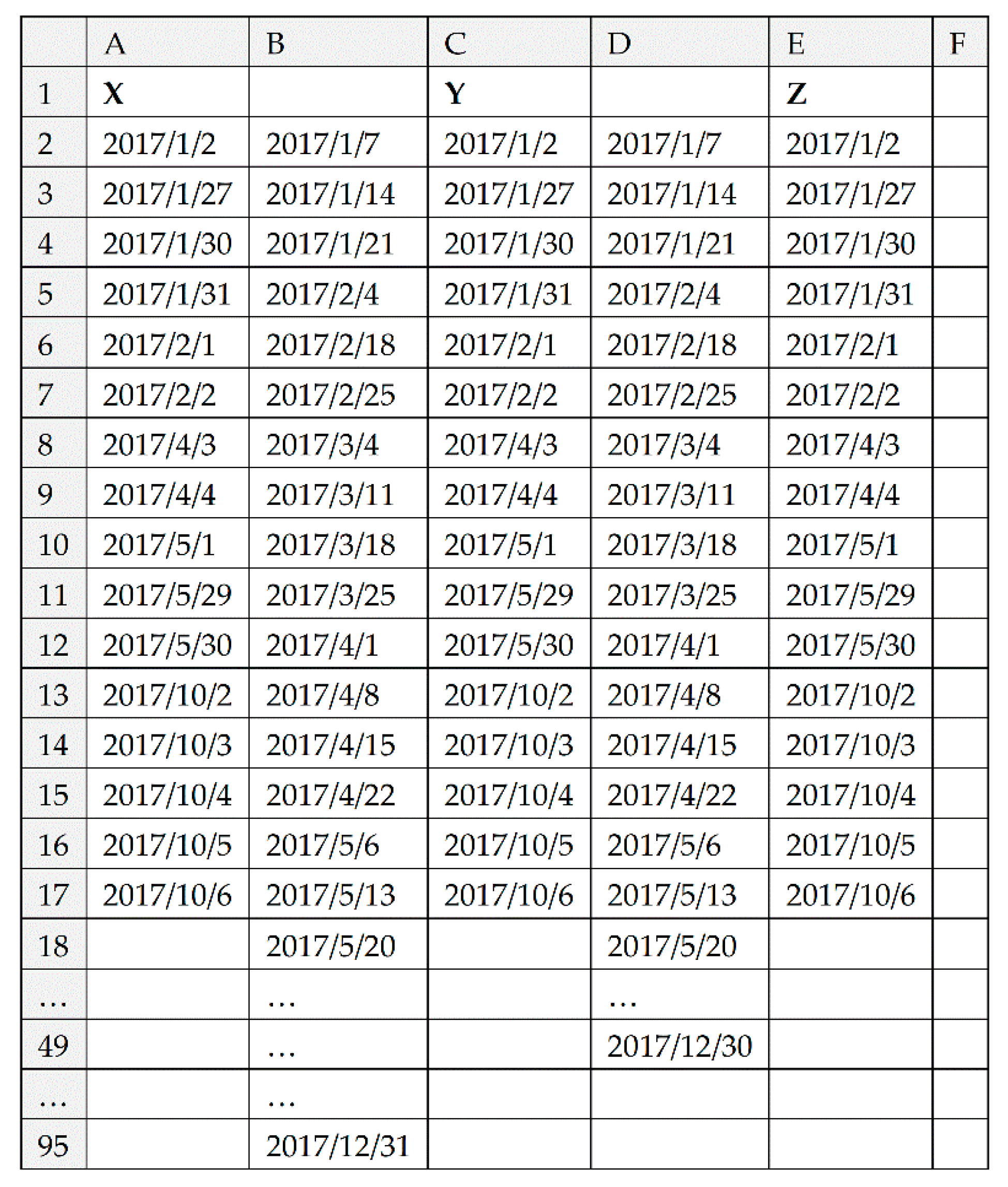

Figure 24. Settings of worksheet “work system”.
Figure 24. Settings of worksheet “work system”.
Processes 07 00888 g024
Figure 25. Settings of worksheet “work shifts”.
Figure 25. Settings of worksheet “work shifts”.
Processes 07 00888 g025
Figure 26. Setting of worksheet “initial time status of the machines”.
Figure 26. Setting of worksheet “initial time status of the machines”.
Processes 07 00888 g026

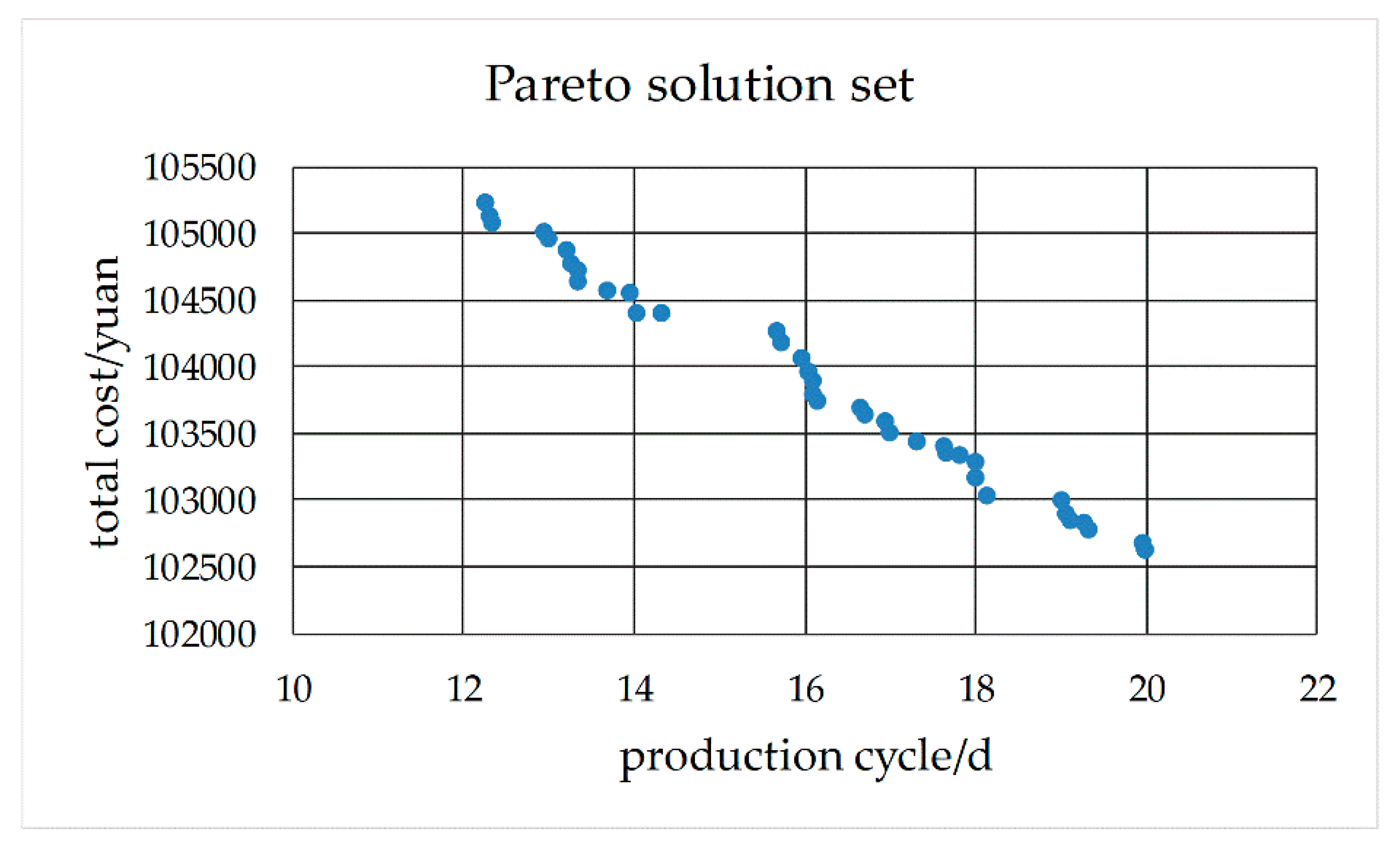

Figure 27. Pareto solution set of No. 1 schedule.
Figure 27. Pareto solution set of No. 1 schedule.
Processes 07 00888 g027
Figure 28. Gantt chart of the scheduled workpieces of No. 1 schedule.
Figure 28. Gantt chart of the scheduled workpieces of No. 1 schedule.
Processes 07 00888 g028

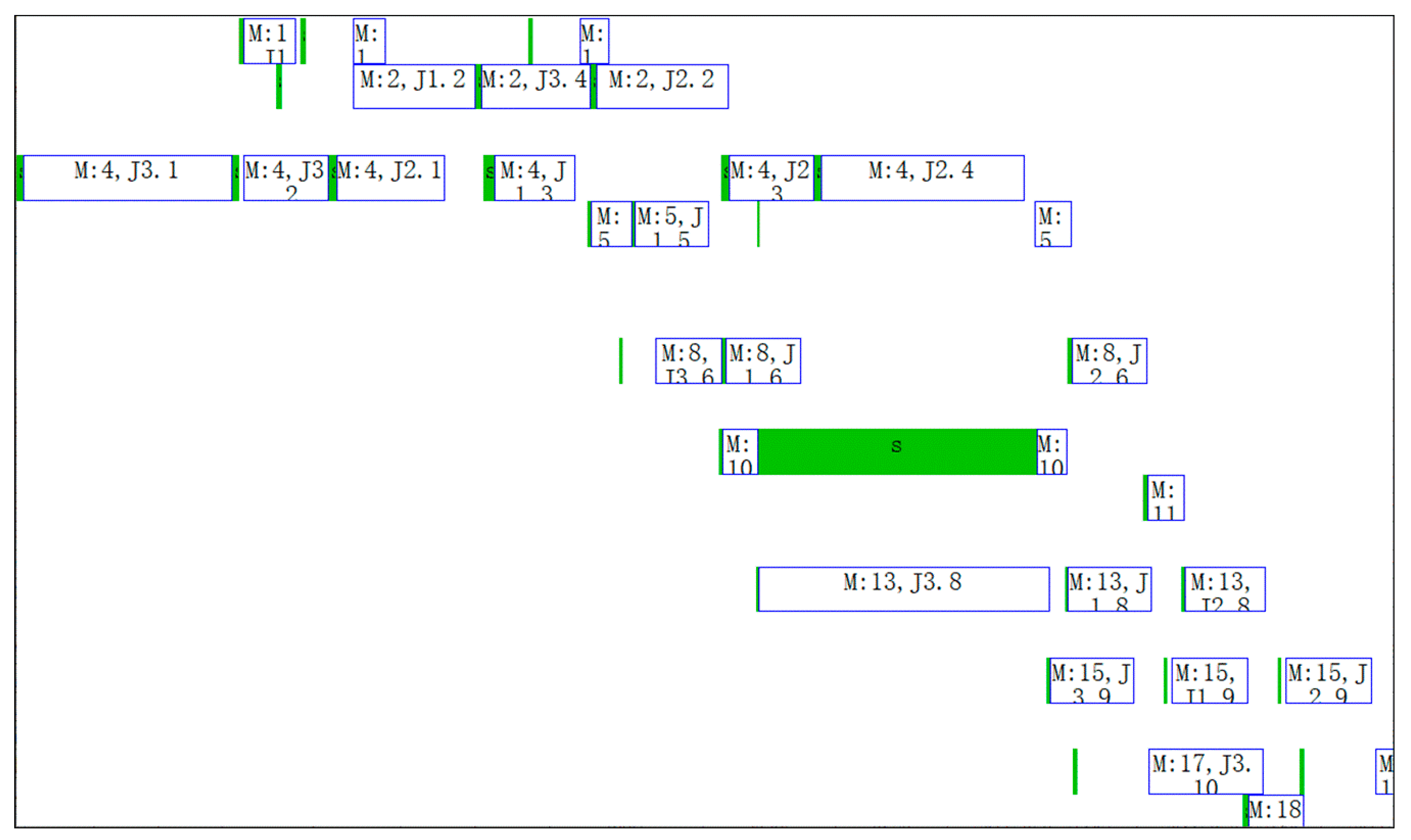

Figure 29. Gantt chart of the machines of No.1 schedule.
Figure 29. Gantt chart of the machines of No.1 schedule.
Processes 07 00888 g029

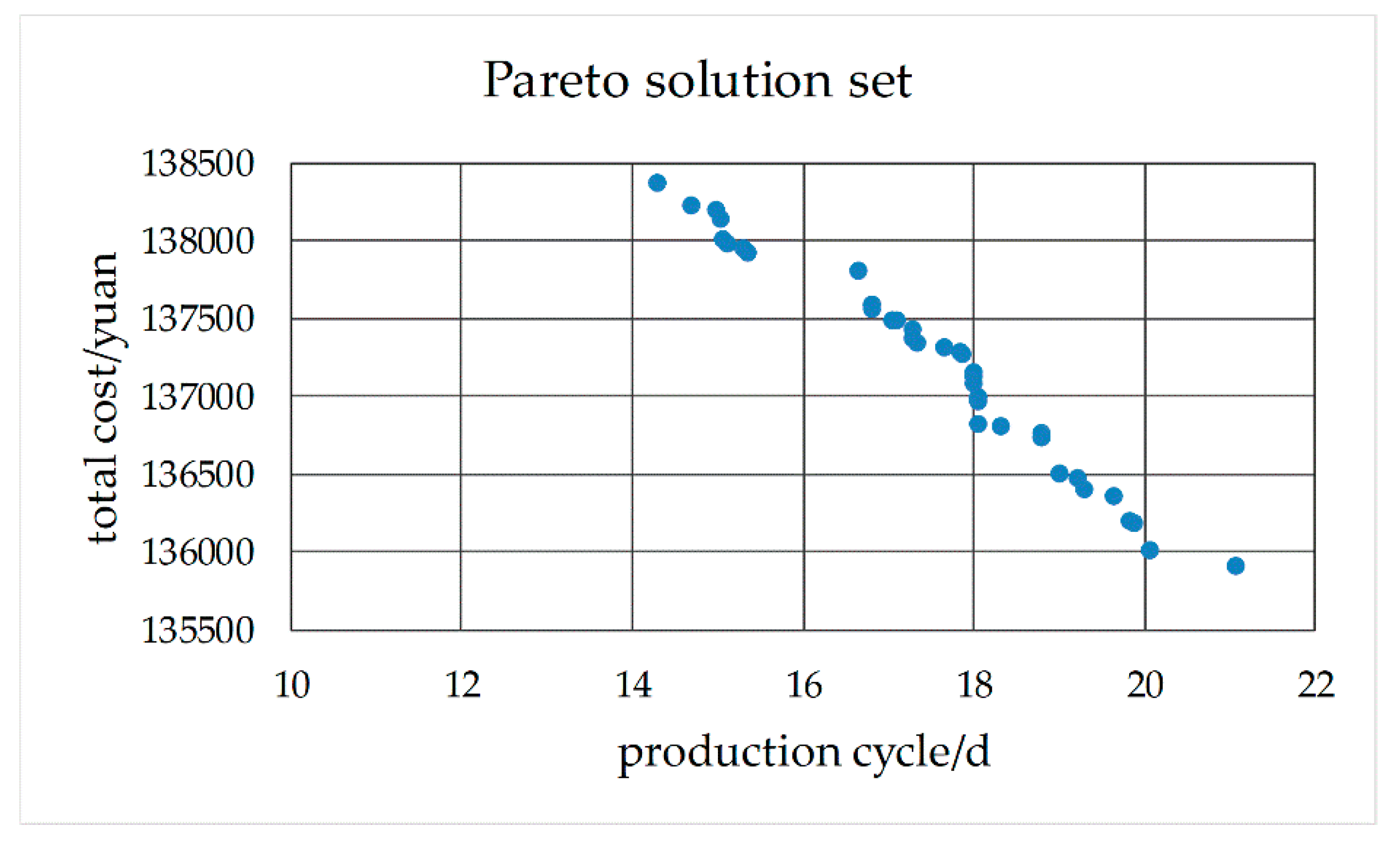

Figure 30. Pareto solution set of No. 2 schedule.
Figure 30. Pareto solution set of No. 2 schedule.
Processes 07 00888 g030
Figure 31. Gantt chart of the scheduled workpieces of No.2 schedule.
Figure 31. Gantt chart of the scheduled workpieces of No.2 schedule.
Processes 07 00888 g031
Figure 32. Gantt chart of the machines of No.2 schedule.
Figure 32. Gantt chart of the machines of No.2 schedule.
Processes 07 00888 g032

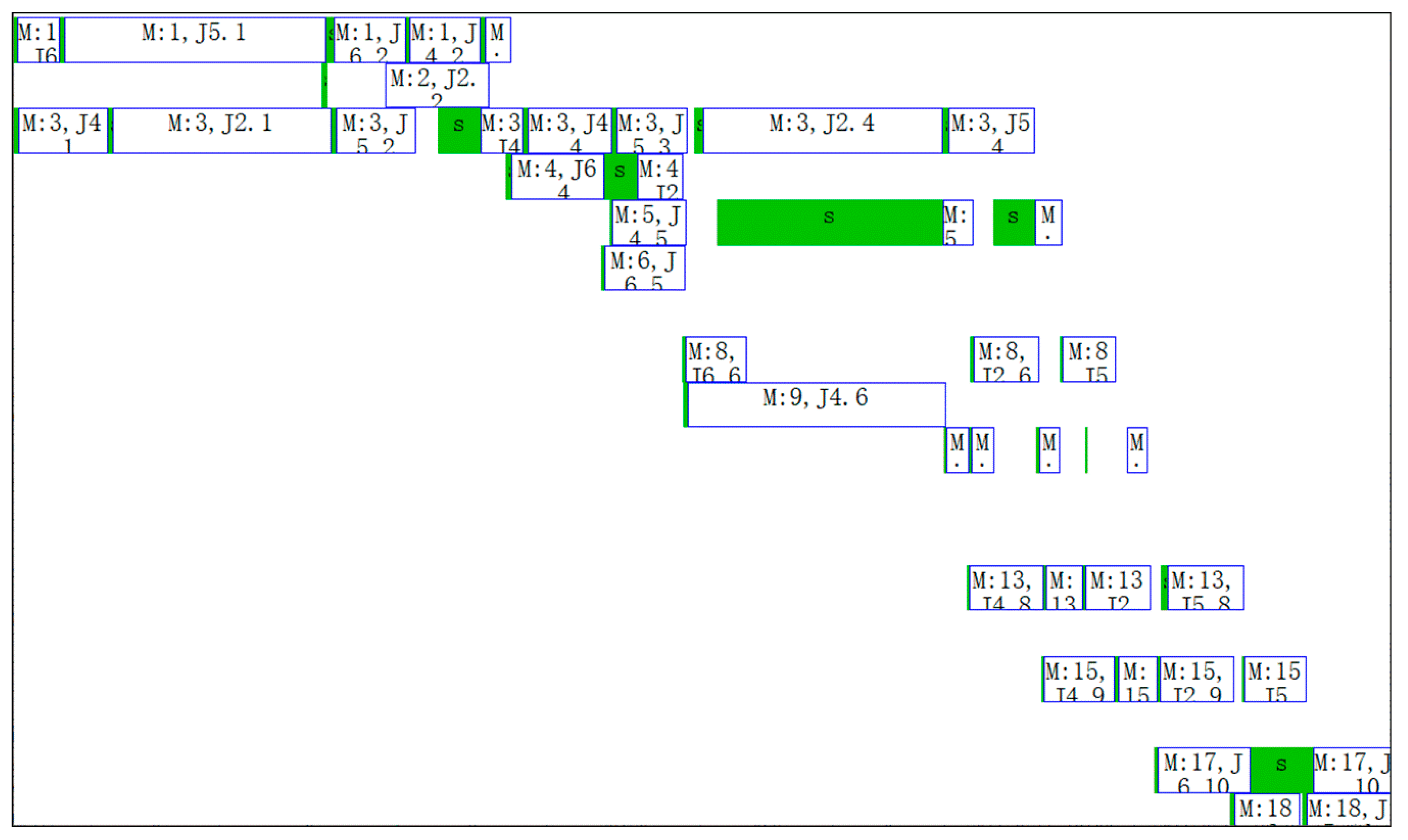

Figure 33. Gantt chart of the machines after No.1 and No.2 schedule.
Figure 33. Gantt chart of the machines after No.1 and No.2 schedule.
Processes 07 00888 g033
Table 1. Variables.
Table 1. Variables.
NameMeaningElement TypeCategory 1Category 2
jnumnumber of scheduled workpiecesintegerglobalinput parameter
tpnumnumber of scheduled processesintegerglobalinput parameter
mnumnumber of scheduled machinesintegerglobalinput parameter
btscheduling start timedateglobalinput parameter
tlnlarge time doubleglobalinput parameter
popsizepopulation sizeintegerglobalinput parameter
pccrossover ratedoubleglobalinput parameter
pmmutation ratedoubleglobalinput parameter
crcrossover ratiodoubleglobalinput parameter
mrmutation ratiodoubleglobalinput parameter
mbsnumber of objectivesintegerglobalinput parameter
maxgenmaximum evolution algebraintegerglobalinput parameter
nwsnumber of work systemsintegerglobalinput parameter
nwtnumber of work shiftsintegerglobalinput parameter
thrpositive real number close to 0doublelocalmiddle parameter
epoccurrent evolutionary algebraIntegerlocalmiddle parameter
P1, P2two parent individuals before crossover operationchrlocalmiddle parameter
chindividualchrlocalmiddle parameter
rrandom real number between 0 and 1doublelocalmiddle parameter
stadjusting time, hdoublelocalmiddle parameter
ctprocessing time, hdoublelocalmiddle parameter
gthe earliest adjustable time of a processdatelocalmiddle parameter
frnumnumber of idle periods of a machineintegerlocalmiddle parameter
tbstart time of the kth idle period of a machinedatelocalmiddle parameter
teend time of the kth idle periods of a machinedatelocalmiddle parameter
tsbadjusting start time of a processdatelocalmiddle parameter
tseadjusting end time of a processdatelocalmiddle parameter
tcbprocessing start time of a processdatelocalmiddle parameter
tceprocessing end time of a processdatelocalmiddle parameter
jcdetails of a processstringlocalmiddle parameter
Table 2. Arrays.
Table 2. Arrays.
NameMeaningTypeSizeType 1Type 2
MAmachinevariantmnum × 5globalinput parameter
JBworkpiecejobjnum × 1globalinput parameter
MMBmachines’ time status before schedulingmachmnum × 1globalinput parameter
WSwork systemsvariant500 × 2nwsglobalinput parameter
WTwork shiftsvariant8 × 7nwtglobalinput parameter
PPOPparent populationchrPopsize × 1localmiddle parameter
PLPOPpairing poolchrpopsize/2 × 1localmiddle parameter
OPOPpopulation after crossover and mutation operationchrpopsize/2 × 1localmiddle parameter
INPOPcombined populationchrpopsize × 1localmiddle parameter
CPOPoffspring populationchrpopsize × 1localmiddle parameter
OCtwo offspring individuals after crossover operation chr2 × 1localmiddle parameter
Table 3. The information of the workpieces.
Table 3. The information of the workpieces.
Workpiece No.Workpiece NameType
1L2027X5
2G46-100FL5
3ZU30100B2M3
4L90GFM2
5L35MCX5
6HP6100Y2
716V32GM6
8G-45BN7
9RT-flexY1
10DK28X8
Table 4. Process flow.
Table 4. Process flow.
Workpiece NameProcess No.Process NameFeasible Machine No.Processing Time (h)Adjusting Time (h)Processing Cost Per Hour (yuan/h)Adjusting Cost Per Hour (yuan/h)
L20271machining shape1, 2, 3, 49, 12, 11.25, 150.96, 1.2, 1.2, 1.5390, 300, 337, 259336, 240, 297, 212
L20272vehicle end face2, 410, 131.2, 1.5250, 216200, 177
L20273vehicle circle2, 48, 101.2, 1.5280, 242240, 212
L20274cone surface1, 2, 3, 45.25, 7, 6.75, 90.96, 1.2, 1.2, 15390, 300, 337, 259322, 230, 285, 203
L20275drilling and hinge pin holes5, 6, 75.63, 7.5, 100.64, 0.8, 1507, 390, 300470, 336, 240
L20276milling 208, 99, 120.8, 1390, 300350, 250
L20277grinding middle hole10, 11, 125.63, 7.5, 100.64, 0.8, 1406, 312, 240353, 252, 180
L20278grinding chamfer13, 146.75, 90.66, 0.83390, 300336, 240
L20279grinding cylindrical 15, 169, 120.66, 0.83351, 270336, 240
L202710grinding end face17, 187.5, 100.94, 1.17312, 240252, 180
G46-100F1machining shape1, 2, 3, 49.75, 13, 10.5, 140.96, 1.2, 1.2, 1.5390, 300, 314, 241336, 240, 279, 199
G46-100F2vehicle end face2, 411, 131.2, 1.5250, 241200, 199
G46-100F3vehicle circle2, 412, 101.2, 1.5280, 241240, 199
G46-100F4cone surface1, 2, 3, 47.5, 10, 8.25, 111, 1.2, 1.2, 1.5390, 300, 314, 241322, 230, 279, 199
G46-100F5drilling and hinge pin holes5, 6, 76.75, 9, 120.64, 0.8, 1507, 390, 300470, 336, 240
G46-100F6milling 20 8, 99, 120.8, 1390, 300350, 250
G46-100F7grinding middle hole10, 11, 124.5, 6, 80.64, 0.8, 1406, 312, 240353, 252, 180
G46-100F8grinding chamfer13, 146, 80.66, 0.83390, 300336, 240
G46-100F9grinding cylindrical 15, 1611.25, 150.66, 0.83351, 270336, 240
G46-100F10grinding end face17, 186.75, 90.94, 1.17312, 240252, 180
ZU30100B21machining shape2, 412, 121.2, 1.5300, 241240, 199
ZU30100B22vehicle end fac1, 2, 47.5, 10, 100.96, 1.2, 1.5325, 250, 241280, 200, 199
ZU30100B23vehicle circle1, 2, 46, 8, 130.96, 1.2, 1.5364, 280, 241336, 240, 199
ZU30100B24cone surface2, 47, 151.2, 1.5300, 241230, 199
ZU30100B25drilling and hinge pin holes5, 6, 76.75, 9, 120.64, 0.8, 1507, 390, 300470, 336, 240
ZU30100B26milling 20 8, 912, 160.8, 1390, 300350, 250
ZU30100B27grinding middle hole10, 11, 126.75, 9, 120.64, 0.8, 1406, 312, 240353, 252, 180
ZU30100B28grinding chamfer13, 147.5, 100.66, 0.83390, 300336, 240
ZU30100B29grinding cylindrical 15, 169.75, 130.66, 0.83351, 270336, 240
ZU30100B210grinding end face17, 188.25, 110.94, 1.17312, 240252, 180
L90GF1machining shape1, 2, 3, 49, 12, 11.25, 150.96, 1.2, 1.2, 1.5390, 300, 314, 241336, 240, 279, 199
L90GF2vehicle end face1, 2, 3, 47.5, 10, 9.75, 130.96, 1.2, 1.2, 1.5325, 250, 314, 241280, 200, 279, 199
L90GF3vehicle circle3, 49, 121.2, 1.5314, 241279, 199
L90GF4cone surface1, 2, 3, 49, 12, 9.75, 130.96, 1.2, 1.2, 1.5390, 300, 314, 241322, 230, 279, 199
L90GF5drilling and hinge pin holes5, 6, 78.44, 11.25, 150.64, 0.8, 1507, 390, 300470, 336, 240
L90GF6milling 20 8, 99, 120.8, 1390, 300350, 250
L90GF7grinding middle hole10, 11, 125.06, 6.75, 90.64, 0.8, 1406, 312, 240353, 252, 180
L90GF8grinding chamfer13, 148.25, 110.66, 0.83390, 300336, 240
L90GF9grinding cylindrical 15, 1610.5, 140.66, 0.83351, 270336, 240
L90GF10grinding end face17, 189, 120.94, 1.17312, 240252, 180
L35MC1machining shape1, 2, 3, 49, 12, 11.25, 150.96, 1.2, 1.2, 1.5390, 300, 314, 241336, 240, 279, 199
L35MC2vehicle end face3, 49.75, 131.2, 1.5314, 241279, 199
L35MC3vehicle circle3, 47.5, 101.2, 1.5314, 241279, 199
L35MC4cone surface1, 2, 3, 49, 12, 10.5, 140.96, 1.2, 1.2, 1.5390, 300, 314, 241322, 230, 279, 199
L35MC5drilling and hinge pin holes5, 6, 76.19, 8.25, 110.64, 0.8, 1507, 390, 300470, 336, 240
L35MC6milling 20 8, 96.75, 90.8, 1390, 300350, 250
L35MC7grinding middle hole10, 11, 124.5, 6, 80.64, 0.8, 1406, 312, 240353, 252, 180
L35MC8grinding chamfer13, 149, 120.66, 0.83390, 300336, 240
L35MC9grinding cylindrical 15, 169, 120.66, 0.83351, 270336, 240
L35MC10grinding end face17, 189.75, 130.94, 1.17312, 240252, 180
HP61001machining shape1, 2, 3, 49, 12, 11.25, 150.96, 12, 1.2, 1.5390, 300, 314, 241336, 240, 279, 199
HP61002vehicle end face1, 27.5, 100.96, 1.2325, 250280, 200
HP61003vehicle circle1, 26, 80.96, 1.2364, 280336, 240
HP61004cone surface1, 2, 3, 411.25, 15, 11.25, 150.96, 1.2, 1.2, 1.5390, 300, 314, 241322, 230, 279, 199
HP61005drilling and hinge pin holes5, 6, 76.75, 9, 120.64, 0.8, 1507, 390, 300470, 336, 240
HP61006milling 20 8, 99, 120.8, 1390, 300350, 250
HP61007grinding middle hole10, 11, 124.78, 6.38, 8.50.64, 0.8, 1406, 312, 240353, 252, 180
HP61008grinding chamfer13, 147.5, 100.66, 0.83390, 300336, 240
HP61009grinding cylindrical 15, 168.25, 110.66, 0.83351, 270336, 240
HP610010grinding end face17, 188.25, 110.94, 1.17312, 240252, 180
16V32G1machining shape1, 29, 120.96, 1.2390, 300336, 240
16V32G2vehicle end face1, 27.5, 100.96, 1.2325, 250280, 200
16V32G3vehicle circle2, 3, 412, 7.5, 101.2, 1.2, 1.5280, 314, 241240, 279, 199
16V32G4cone surface2, 3, 412, 11.25, 151.2, 1.2, 1.5300, 314, 241230, 279, 199
16V32G5drilling and hinge pin holes5, 6, 78.44, 11.25, 150.64, 0.8,1507, 390, 300470, 336, 240
16V32G6milling 20 8, 97.5, 100.8, 1390, 300350, 250
16V32G7grinding middle hole10, 11, 126.08, 8.1, 90.74, 0.92, 1374, 288, 240290, 207, 180
16V32G8grinding chamfer13, 149, 120.66, 0.83390, 300336, 240
16V32G9grinding cylindrical 15, 1610.5, 140.66, 0.83351, 270336, 240
16V32G10grinding end face17, 188.25, 110.94, 1.17312, 240252, 180
G-45B1machining shape2, 48, 101.2, 1.5300, 241240, 199
G-45B2vehicle end face1, 2, 3, 47.5, 10, 9.75, 130.96, 1.2, 1.2, 1.5325, 250, 314, 241280, 200, 279, 199
G-45B3vehicle circle2, 48, 101.2, 1.5280, 241240, 199
G-45B4cone surface1, 2, 3, 48.25, 11, 11.25, 150.96, 1.2, 1.2, 1.5390, 300, 314, 241322, 230, 279, 199
G-45B5drilling and hinge pin holes5, 6, 77.31, 9.75, 130.64, 0.8, 1338, 260, 200314, 224, 160
G-45B6milling 20 8, 98.25, 110.8, 1390, 300350, 250
G-45B7grinding middle hole10, 11, 127.43, 9.9, 110.74, 0.92, 1374, 288, 240290, 207, 180
G-45B8grinding chamfer13, 149, 120.66, 0.83390, 300336, 240
G-45B9grinding cylindrical 15, 167.5, 100.66, 0.83351, 270336, 240
G-45B10grinding end face17, 187.5, 100.94, 1.17312, 240252, 180
Table 5. The information of the machines.
Table 5. The information of the machines.
Machine No.Machine CodeMachine TypeWork SystemWork Shift
1300TNC lathe XA
2200TNC latheYB
3T52NC latheZA
4T42NC latheYC
5Z6018bench drillXA
6Z5018bench drillXA
7Z4018bench drillYB
8X8126milling machineZC
9X5126milling machineYB
10M5515horizontal grinding machine toolXA
11M4515horizontal grinding machine toolXC
12M3515horizontal grinding machine toolYB
13J5001semi-automatic cylindrical grinderZA
14J4001semi-automatic cylindrical grinderYB
153U5cylindrical grinderXC
162U5cylindrical grinderXA
17120CNCinternal grinderYB
18111CNCinternal grinderZC
Table 6. The information of the scheduled workpieces of No. 1 schedule.
Table 6. The information of the scheduled workpieces of No. 1 schedule.
Workpiece No.Workpiece NameTypeTotal Process NumberDelivery TimeEarlier Completion Rate (yuan /d)Delayed Completion Rate (yuan/d)
1L2027X5102017/4/161001000
2G46-100FL5102017/4/151501200
3ZU30100B2M3102017/5/1380800
Table 7. Other parameters.
Table 7. Other parameters.
ParameterValueParameterValue
jnum7cr0.7
tpnum42mr0.3
mnum10maxgen200
bt2017/3/4 8:00:00mbs2
tln4637/11/26 0:00:00nws3
popsize40nwt3
pc0.5thr0.001
pm0.1
Table 8. Schedule table of a Pareto solution.
Table 8. Schedule table of a Pareto solution.
No.Workpiece No.Process No.Machine No.Adjusting Time (h)Processing Time (h)Adjusting Start TimeAdjusting End TimeProcessing Start TimeProcessing End TimeAdjusting Cost (yuan)Processing Cost (yuan)
13141.5122017/3/4 9:002017/3/4 10:302017/3/4 10:302017/3/6 6:30299.012895.69
23241.5102017/3/6 6:302017/3/6 8:002017/3/6 9:002017/3/7 3:00299.012413.07
31110.9692017/3/6 8:002017/3/6 8:572017/3/6 8:572017/3/6 19:57322.563510.00
41221.2102017/3/6 15:482017/3/6 17:002017/3/7 8:002017/3/8 10:00240.002500.00
53310.9662017/3/6 21:022017/3/6 22:002017/3/7 8:002017/3/7 15:00322.562184.00
63421.272017/3/8 10:002017/3/8 11:122017/3/8 11:122017/3/9 10:12276.002100.00
72141.5142017/3/7 3:002017/3/7 4:302017/3/7 4:302017/3/8 3:30299.013378.30
82221.2112017/3/9 10:122017/3/9 11:242017/3/9 11:242017/3/10 15:24240.002750.00
93550.646.752017/3/9 9:332017/3/9 10:122017/3/9 10:122017/3/9 18:57301.063422.25
102341.5102017/3/10 13:542017/3/10 15:242017/3/10 15:242017/3/11 9:24299.012413.07
113680.8122017/3/9 16:122017/3/9 17:002017/3/10 0:002017/3/10 14:00280.004680.00
121341.5102017/3/8 11:302017/3/8 14:002017/3/8 14:002017/3/9 7:00318.102421.72
132441.5112017/3/11 9:242017/3/11 10:542017/3/11 10:542017/3/13 5:54299.012654.38
1437100.646.752017/3/10 13:212017/3/10 14:002017/3/10 14:002017/3/10 21:45225.792737.80
152550.646.752017/3/10 21:212017/3/10 22:002017/3/13 8:002017/3/13 15:45301.063422.25
161410.965.252017/3/8 21:022017/3/8 22:002017/3/9 8:002017/3/9 14:15309.122047.50
171550.645.6252017/3/9 18:572017/3/9 19:352017/3/9 19:352017/3/10 11:12301.062851.88
181680.892017/3/10 14:002017/3/10 14:482017/3/10 14:482017/3/11 6:48280.003510.00
1917100.645.6252017/3/10 21:452017/3/13 8:232017/3/13 8:232017/3/13 15:00225.792281.50
2018130.6646.752017/3/13 14:212017/3/13 15:002017/3/13 15:002017/3/14 8:45223.102632.50
2119150.66492017/3/14 11:202017/3/14 12:002017/3/14 13:002017/3/15 5:00223.103159.00
2238130.6647.52017/3/10 21:052017/3/10 21:452017/3/10 21:452017/3/13 11:15223.102925.00
2339150.6649.752017/3/13 10:352017/3/13 11:152017/3/13 11:152017/3/14 5:00223.103422.25
242680.892017/3/13 14:572017/3/13 15:452017/3/13 15:452017/3/14 7:45280.003510.00
2527110.862017/3/14 6:572017/3/14 7:452017/3/14 7:452017/3/14 15:45201.601872.00
26310170.9368.252017/3/13 16:032017/3/13 17:002017/3/14 8:002017/3/15 8:15235.872574.00
2728130.66462017/3/14 15:052017/3/14 15:452017/3/14 15:452017/3/15 8:45223.102340.00
2829150.66411.252017/3/15 11:202017/3/15 12:002017/3/15 13:002017/3/16 7:15223.103948.75
29110181.17102017/3/15 3:492017/3/15 5:002017/3/15 5:002017/3/15 17:00210.602400.00
30210170.9366.752017/3/15 16:032017/3/15 17:002017/3/16 8:002017/3/16 15:45235.872106.00
Table 9. The information of the scheduling workpieces of No.2 schedule.
Table 9. The information of the scheduling workpieces of No.2 schedule.
Workpiece No.Workpiece NameTypeTotal Process NumberDelivery DateEarlier Completion Rate (yuan /d)Delayed Completion Rate (yuan/d)
2G46-100FL5102017/4/151501200
4L90GFM2102017/4/201201500
5L35MCX5102017/4/1370600
6HP6100Y2102017/4/1650500

Share and Cite

MDPI and ACS Style

Zeng, Q.; Wang, M.; Shen, L.; Song, H. Sequential Scheduling Method for FJSP with Multi-Objective under Mixed Work Calendars. Processes 2019, 7, 888. https://doi.org/10.3390/pr7120888

AMA Style

Zeng Q, Wang M, Shen L, Song H. Sequential Scheduling Method for FJSP with Multi-Objective under Mixed Work Calendars. Processes. 2019; 7(12):888. https://doi.org/10.3390/pr7120888

Chicago/Turabian Style

Zeng, Qiang, Menghua Wang, Ling Shen, and Hongna Song. 2019. "Sequential Scheduling Method for FJSP with Multi-Objective under Mixed Work Calendars" Processes 7, no. 12: 888. https://doi.org/10.3390/pr7120888

Note that from the first issue of 2016, this journal uses article numbers instead of page numbers. See further details here.

Article Metrics

Back to TopTop
