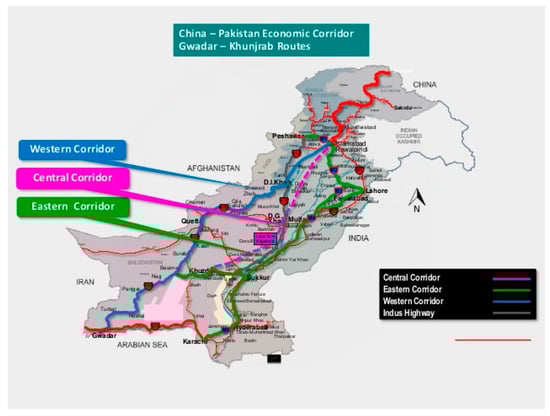

A Comprehensive Study of Project Risks in Road Transportation Networks under CPEC
Abstract
:1. Introduction
2. Literature Review
3. The Framework of the Present Study

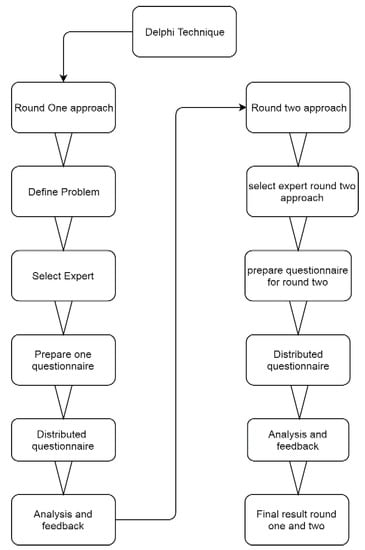

3.1. Delphi Approach
3.2. Survey Development Strategy
3.3. Study Population
3.4. Data Examination
4. Result and Discussion
4.1. Delphi Round-One Approach
4.1.1. First-Round Investigation of Delphi Studies
4.1.2. Macro Risk
4.1.3. Meso Risk
4.1.4. Minor Risk
4.2. Delphi Round-Two Approach
4.2.1. Macro Risk
4.2.2. Meso Risk
4.2.3. Minor Risk
5. Comparative Analysis Cycle One and Cycle Two
6. Recommendations
- (1)
- The successful implementation of the road transportation network project and foresightedness concerning security side by adding additional security forces for CPEC project on each route;
- (2)
- Proper planning is needed to assist communication between stakeholders and CPEC officials. The conflict of interest between stakeholders and CPEC officials is a bad sign for road transportation network project.
- (3)
- Provide small contracts/tender to individuals near road network to achieve motivation and prosperity. Consequently, disseminated chances among the concerned area would be reduced.
- (4)
- Prevent the destruction of historical and holy sites. If decimating is necessary, then sacred sites should be shifted to new locations in the nearest neighborhood;
- (5)
- In the commercial hub area, the government should provide the necessary facilities and security for labor and business personnel;
- (6)
- Politician’s illicit demand is unsafe for the CPEC road plan. Therefore, proper decision-making is necessary to prevent illicit demand during construction;
- (7)
- Job opportunities should be given to people in affected areas to add to the stability of the project.
7. Conclusions
Author Contributions
Funding
Conflicts of Interest
References
- Akintoye, Akintola S., and Malcolm J. MacLeod. 1997. Risk analysis and management in construction. International Journal of Project Management 15: 31–38. [Google Scholar] [CrossRef]
- Ali, Liaqat, Jianing Mi, Mussawar Shah, Syed Jamal Shah, Salim Khan, Rizwan Ullah, and Kausar Bibi. 2018. Local residents’ attitude toward road and transport infrastructure (a case of China Pakistan economic corridor). Journal of Chinese Economic and Foreign Trade Studies 11: 104–20. [Google Scholar] [CrossRef]
- Beyazit, Eda. 2015. Are wider economic impacts of transport infrastructures always beneficial? Impacts of the Istanbul metro on the generation of Spatio-economic inequalities. Journal of Transport Geography 45: 12–23. [Google Scholar] [CrossRef]
- British Standards Institute. 2010. Project Management—Part 1: Principles and Guidelines for the Management of Projects. British Standards BS 6079-1. London: British Standards Institute. [Google Scholar]
- De Brito, J., and F. A. Branco. 2006. Bridge Management Policy Using Cost Analysis. Journal of Civil Engineering 244: 92–98. [Google Scholar] [CrossRef]
- El-Rashidy, Rawia Ahmed, and Susan M. Grant-Muller. 2014. An assessment method for highway network vulnerability. Journal of Transport Geography 34: 34–43. [Google Scholar] [CrossRef] [Green Version]
- Fiondella, Lance, Jun Liu, Sherif Tolba, Sanguthevar Rajasekaran, Reda Ammar, Ashraf-ur Rahman, Nicholas Lownes, and John Ivan. 2012. Game theoretic vulnerability analysis for the optimal defense of high-speed rail. Paper presented at 2012 IEEE Conference on Technologies for Homeland Security (HST), Waltham, MA, USA, November 13–15; pp. 305–11. [Google Scholar]
- Hallowell, Matthew R., and John A. Gambatese. 2009. Qualitative Research: Application of the Delphi Method to CEM Research. Journal of Construction Engineering and Management 136: 99–107. [Google Scholar] [CrossRef]
- Hastak, Markarand, and Aury Shaked. 2000. ICRAM-1 Model for international construction risk management. Journal of Management in Engineering 16: 59–69. [Google Scholar] [CrossRef]
- Iyer, K. Chaphalkar, and Mohammed Sagheer. 2010. Hierarchical Structuring of PPP Risks Using Interpretative Structural Modeling. Journal of Construction Engineering and Management 136: 150–59. [Google Scholar] [CrossRef]
- Jayasudha, K., B. Vidivelli, and ER Gokul Surjith. 2014. Risk Assessment and Management in Construction Projects. International Journal of Scientific & Engineering Research 5: 387–96. [Google Scholar]
- Judd, Robert C. 1972. Forecasting to consensus gathering: Delphi grows up to college needs. College & University Business 53: 35–38, 43. [Google Scholar]
- Laurenz, J. Laurenz, and Chris Verhoef. 2010. The Rise and Fall of the Chaos Report Figures. IEEE Software 27: 30–36. [Google Scholar]
- Lee, Kang-Wook, Hwa-Uk Hong, Heedae Park, and Seung-Heon Han. 2009. Developing a Program Performance Management Framework for Mixed-use Development in Urban Regeneration Projects. Korean Journal of Construction Engineering and Management 12: 141–52. [Google Scholar] [CrossRef]
- Li, Bing, and Robert L. K. Tiong. 1999. Risk management model for international construction joint ventures. Journal of Construction Engineering and Management 125: 377–84. [Google Scholar]
- Ling, Florence Yean Ying, and Linda Hoi. 2006. Risks faced by Singapore firms when taking construction projects in India. International Journal of Project Management 24: 261–70. [Google Scholar] [CrossRef]
- Mcguire, Robin K. 1999. Analyzing of Risk Factors in Construction. Journal of Civil Engineering 116: 76–S5. [Google Scholar]
- Mitchell, Vincent-Wayne, and Peter J. McGoldrick. 1994. The role of geodemographics in segmenting and targeting consumer markets: A Delphi study. European Journal of Marketing 28: 54–72. [Google Scholar] [CrossRef]
- Mulholland, B., and J. Christian. 1999. Risk Assessment in Construction Schedules. Journal of Construction Engineering and Management 125: 8–15. [Google Scholar] [CrossRef]
- Neumann, Christof, and Christof Sistenich. 2011. Results of a comparative application of QRA methodology for road tunnels in Germany. Paper presented at the 6th International Conference on Traffic and Safety in Road Tunnels, Hamburg, Germany, May 10–12. [Google Scholar]
- Ouyang, Min, Lijing Zhao, Liu Hong, and Zhezhe Pan. 2014. Comparisons of complex network-based models and real train flow model to analyze Chinese railway vulnerability. Reliability Engineering & System Safety 123: 38–46. [Google Scholar]
- Park, Kyu-young. 2009. A Development of Risk Identification Checklist for Stakeholders in the Construction Phase of the Urban Regeneration-Projects. Korean Journal of Construction Engineering and Management 10: 67–75. [Google Scholar]
- Project Management Institute. 2000. A Guide to the Project Management Body of Knowledge (PM Book Guide), 6th ed. Newtown Square: Project Management Institute, ISBN 978-1-62825-184-5. [Google Scholar]
- Rodney, Elodie, Yann Ledoux, Yves Ducq, and Denys Breysse. 2014. Integrating risks in project management. Paper presented at the 16th International Dependency and structure modeling Conference, Paris, France, July 2–4. [Google Scholar]
- Sourani, Amr, and M. Sohail. 2015. The Delphi Method: Review and Use in Construction Management Research. International Journal of Construction Education and Research 11: 54–76. [Google Scholar] [CrossRef]
- Tang, Yun, and Shuping Huang. 2019. Assessing the seismic vulnerability of urban road networks by a Bayesian network approach. Transportation Research Part D: Transport and Environment. [Google Scholar] [CrossRef]
- Uher, E Thomas, and A. Ray Toakely. 1999. Risk management in the conceptual phase of a project. International Journal of Project Management 17: 161–69. [Google Scholar] [CrossRef]
- Weidman, Justin E., Kevin R. Miller, Jay P. Christofferson, and Jay S. Newitt. 2011. Best practices for dealing with price volatility in commercial construction. International Journal of Construction Education and Research 7: 276–93. [Google Scholar] [CrossRef]
- Zhang, W. Y., and S. P. Lin. 2012. The Factor Analyses of Risk Decision Traps for Overseas Projects. Journal of Optimization in Infrastructure Management 24: 8–13. (In Chinese). [Google Scholar]
- Zia-ur-rehman, and Tariq Aziz. 2017. The implications and Geo-Strategic Dimension of China—Pakistan Economic Corridor and its consequences and benefits overall. European Academic Research IV. [Google Scholar]
No. | Risk Level | Description | Impacts on Project | |
---|---|---|---|---|
1 | Minor risk | Has no consequences on project performance. | 1–25 | Favorable |
2 | Meso risk | May have incited a pinch impact of project execution but not severely. | 26–50 | Medium level |
3 | Marco risk | High impact on project performance. (Mandate level) | 51–100 | Unfavorable |
No. | Detail of Survey | Response Rate |
---|---|---|
1 | Total of 36 Expert | 86% |
2 | Round one | 88% |
3 | Round two | 83% |
Group | 1st Index | 2nd Index | Mean | Median | S.D | Low | Mid | High |
---|---|---|---|---|---|---|---|---|
Macro Risk | Stakeholder Risks | Attitude of Stakeholder and Clashes | 2.4 | 3.0 | 0.73 | 13.3 | 33.3 | 53.3 |
Turn Over Stakeholder | 2.46 | 3.0 | 0.82 | 20 | 20 | 60 | ||
Political Risks | Politician Interest | 2.26 | 3.0 | 0.88 | 26.7 | 20 | 53.3 | |
Government Behavior | 2.00 | 2.0 | 0.79 | 26.7 | 40 | 33.3 | ||
Safety Risk | Terrorism Risk | 2.33 | 3.0 | 0.89 | 26.6 | 13.3 | 60.0 | |
Security Risk | 2.33 | 3.0 | 0.81 | 20 | 26.7 | 53.3 | ||
Technical Risk | Training Inadequate | 1.73 | 2.0 | 0.79 | 46.7 | 33.3 | 20.3 | |
Product Maintenance | 2.13 | 2.0 | 0.74 | 20 | 46.7 | 33.3 | ||
Information Security | 1.73 | 2.0 | 0.70 | 40 | 46.7 | 13.3 |
Group | 1st Index | 2nd Index | Mean | Median | S.D | Low | Mid | High |
---|---|---|---|---|---|---|---|---|
Meso Risk | Cost Risk | Estimates Inaccurate | 2.13 | 2.0 | 0.83 | 26.7 | 33.3 | 40 |
Exchange Inconsistency | 2.26 | 2.0 | 0.79 | 20 | 33.3 | 46.7 | ||
Communication Risk | Team Communication | 1.93 | 2.0 | 0.79 | 33.3 | 40 | 26.7 | |
Overhead Communicate | 2.00 | 2.0 | 0.84 | 33.3 | 33.3 | 33.3 | ||
internal Communication | 2.00 | 2.0 | 0.79 | 26.7 | 40 | 33.3 | ||
Environment Risk | Weather Condition | 1.93 | 2.0 | 0.88 | 40 | 26 | 33.3 | |
Land Condition | 2.06 | 2.0 | 0.79 | 26.7 | 40 | 33.3 | ||
Pollution Affects | 1.80 | 2.0 | 0.77 | 40 | 40 | 20 | ||
Economic stresses | Pay Injury Land Acquisition | 2.40 | 3.0 | 0.73 | 13.3 | 33.3 | 53.3 | |
Poverty & Jobless Situation | 2.53 | 3.0 | 0.63 | 6.7 | 33.3 | 60 | ||
Schedule Risks | Time Affects | 1.80 | 2.0 | 0.77 | 40 | 40 | 20 | |
Delivery Process | 1.73 | 2.0 | 0.79 | 46.7 | 33.3 | 20 |
Group | 1st Index | 2nd Index | Mean | Median | S.D | Low | Mod | High |
---|---|---|---|---|---|---|---|---|
Minor Risk | Culture and Religious Risk | Effect of Local Culture | 2.46 | 3.0 | 0.73 | 13.3 | 33.3 | 53.3 |
Effect of Historical Places | 2.57 | 3.0 | 0.63 | 6.7 | 33.3 | 60 | ||
Effect of Religious | 2.38 | 3.0 | 0.81 | 20 | 26.7 | 53.3 | ||
Public Risk | Ruthless Working Conditions | 2.21 | 2.0 | 0.86 | 26.7 | 26.7 | 46.7 | |
Community Wellbeing Issue | 2.13 | 2.0 | 0.83 | 26.7 | 33.3 | 40 | ||
Public Protection | 2.25 | 2.0 | 0.77 | 20 | 40 | 40 | ||
Law Risks | National Viewpoint | 2.00 | 2.0 | 0.84 | 33.3 | 33.3 | 33.3 | |
Local Rules | 1.86 | 2.0 | 0.83 | 40.0 | 33.3 | 26.7 |
Group | 1st Index | 2nd Index | Mean | Median | S.D | Low | Mid | High |
---|---|---|---|---|---|---|---|---|
Macro Risk | Stakeholder Risks | Attitude of Stakeholder and Clashes | 2.46 | 3.00 | 0.833 | 20 | 13.3 | 66.7 |
Turn Over Stakeholder | 2.40 | 3.00 | 0.736 | 13.3 | 33.3 | 53.3 | ||
Political Risks | Politician Interest | 2.60 | 3.00 | 0.63 | 6.7 | 26.7 | 66.7 | |
Government Behavior | 2.13 | 2.00 | 0.74 | 20 | 46.7 | 33.3 | ||
Safety Risk | Terrorism Risk | 2.53 | 3.00 | 0.74 | 13.3 | 20 | 66.7 | |
Security Risk | 2.53 | 3.00 | 0.63 | 6.7 | 33.3 | 60 | ||
Technical Risk | Training Inadequate | 2.20 | 2.00 | 0.77 | 20 | 40 | 40 | |
Product Maintenance | 2.00 | 2.00 | 0.84 | 33.3 | 33.3 | 33.3 | ||
Information Security | 1.86 | 2.00 | 0.83 | 40 | 33.3 | 26.7 |
Group | 1st Index | 2nd Index | Mean | Median | S.D | Low | Mid | High |
---|---|---|---|---|---|---|---|---|
Meso Risk | Cost Risk | Estimates Inaccurate | 1.80 | 2.00 | 0.77 | 40 | 40 | 20 |
Exchange Inconsistency | 2.00 | 2.00 | 0.75 | 26.7 | 46.7 | 26.7 | ||
Communication Risk | Team Communication | 1.80 | 2.00 | 0.77 | 40 | 40 | 20 | |
Overhead Communicate | 1.73 | 2.00 | 0.79 | 46.7 | 33.3 | 20 | ||
Internal Communication | 1.93 | 2.00 | 0.79 | 33.3 | 40 | 26.7 | ||
Environment Risk | Weather Conditions | 2.00 | 2.00 | 0.84 | 33.3 | 33.3 | 33.3 | |
Land Conditions | 1.93 | 2.00 | 0.79 | 33.3 | 40 | 26.7 | ||
Populations Affects | 2.06 | 2.0 | 0.88 | 33.3 | 26.7 | 40 | ||
Economic stresses | Pay Injury Land Acquisition | 2.40 | 3.0 | 0.82 | 20 | 20 | 60 | |
Poor and Jobless Affected | 2.46 | 3.0 | 0.83 | 20 | 13.3 | 66.7 | ||
Schedule Risks | Time Effects | 2.40 | 3.0 | 0.73 | 13 | 33.3 | 53.3 | |
Delivery Process | 1.93 | 2.0 | 0.88 | 40 | 26.7 | 33.3 |
Group | 1st Index | 2nd Index | Mean | Median | S.D | Low | Mod | High |
---|---|---|---|---|---|---|---|---|
Minor Risk | Culture and Religious | Local Culture Affect | 2.13 | 2.0 | 0.91 | 33.3 | 20 | 46.7 |
Historical Places Affect | 2.26 | 3.0 | 0.88 | 26.7 | 20 | 53.7 | ||
Religious Affect | 2.46 | 3.0 | 0.74 | 13.3 | 26.7 | 60 | ||
Public Risk | Ruthless Working Conditions | 2.3 | 40 | 0.72 | 13.3 | 40. | 46.7 | |
Community Wellbeing Issue | 1.93 | 2.0 | 0.88 | 40 | 40 | 46.7 | ||
Public Protection | 1.80 | 2.0 | 0.77 | 40 | 40 | 20 | ||
Law Risks | National Viewpoint | 1.80 | 2.0 | 0.86 | 46.7 | 26.7 | 26.7 | |
Local Rules | 1.80 | 2.0 | 0.77 | 40 | 40 | 20 |
